Total Duration: |
113 |
days |
Total Working Days: |
54 |
Total Manpower: |
619 |
|
|
Planning Progress = 79.5% |
Acual Progress = 41.6% |
SPI: 0.52 |
Behind Schedule |
Progress as on: 28-January-2024
WBS |
Work Description |
Total Quantity |
Total Done |
Schedule Start
| Schedule Finish |
Actual Start |
Actual Finish |
Lead-Lag(day) |
Not Yet |
02.1 |
L-16-Material Removal |
0 |
100% |
23-11-23 |
02-12-23 |
23-11-23 |
30-11-23 |
2 |
|
02.2.1 |
L-15-Wooden Floor Dismantling |
140m2 |
100% |
23-12-23 |
27-12-23 |
24-12-23 |
26-12-23 |
1 |
|
02.2.2 |
L-15-CC with Neat Cement Finish |
156m2 |
100% |
24-01-24 |
27-01-24 |
24-01-24 |
28-01-24 |
-1 |
|
02.3 |
L-15-16-Prodema Fixing |
0 |
1% |
28-12-23 |
26-01-24 |
28-12-23 |
28-12-23 |
29 |
Completed |
03.1.1 |
L14-Old Kitchen Wall-Shelf dismantl |
1sum |
100% |
09-10-23 |
12-10-23 |
09-10-23 |
15-10-23 |
-3 |
|
03.1.2 |
L14-Old Kitchen Wall Debris shiftin |
1sum |
100% |
13-10-23 |
16-10-23 |
13-10-23 |
19-10-23 |
-3 |
|
03.1.3 |
L-14-Kitchen Floor dismantling |
16m3 |
100% |
17-10-23 |
19-10-23 |
17-10-23 |
25-10-23 |
-6 |
|
03.1.4 |
L-14-Old Kitchen Floor debris shift |
1sum |
100% |
20-10-23 |
22-10-23 |
19-10-23 |
28-10-23 |
-6 |
|
03.1.5 |
L-14-East-South Brickwall dismantli |
20m2 |
100% |
17-10-23 |
17-10-23 |
17-10-23 |
17-10-23 |
0 |
|
03.1.6 |
L-14-Wall Debris shifting |
1sum |
100% |
18-10-23 |
18-10-23 |
17-10-23 |
17-10-23 |
1 |
|
03.10 |
L-14-Brickwork-South-East |
0 |
30% |
28-12-23 |
31-12-23 |
28-12-23 |
28-12-23 |
3 |
Completed |
03.2 |
L-14-Stair Case-South-Door Cutting |
1nos |
100% |
14-10-23 |
16-10-23 |
14-10-23 |
17-10-23 |
-1 |
|
03.3.1 |
L-14-AC Installation |
1sum |
60% |
31-10-23 |
10-01-24 |
08-11-23 |
17-01-24 |
-7 |
Completed |
03.3.2 |
L-14-Toilet Plumbing and Tiles |
1sum |
0% |
23-12-23 |
02-01-24 |
|
30-11--1 |
0 |
Started |
03.3.3 |
L-14-Counter |
0 |
0% |
23-12-23 |
06-01-24 |
|
30-11--1 |
0 |
Started |
03.3.4 |
L-14-Neat Cement Finish |
0 |
100% |
11-11-23 |
17-11-23 |
22-11-23 |
20-12-23 |
-33 |
|
03.3.5 |
L-14-Wall Painting |
0 |
0% |
23-12-23 |
27-12-23 |
|
30-11--1 |
0 |
Started |
03.3.6.1 |
L-14-Ceiling-Design |
0 |
100% |
31-10-23 |
08-11-23 |
20-12-23 |
20-12-23 |
-42 |
|
03.3.6.2 |
L-14-Ceiling-Installation |
0 |
37% |
17-11-23 |
15-01-24 |
20-12-23 |
17-01-24 |
-2 |
Completed |
03.3.7 |
L-14-Internal Electrif-Floor+Ceilin |
0 |
24% |
04-11-23 |
02-01-24 |
26-11-23 |
10-01-24 |
-8 |
Completed |
03.3.8.1 |
L-14-Furniture Design |
0 |
0% |
23-12-23 |
28-12-23 |
|
30-11--1 |
0 |
Started |
03.3.8.2 |
L-14-Furniture making, Installation |
0 |
0% |
29-12-23 |
12-01-24 |
|
30-11--1 |
0 |
Started |
03.3.9 |
L-14-Fire Sprinklers Pipe installat |
0 |
95% |
13-12-23 |
11-01-24 |
13-12-23 |
24-12-23 |
18 |
Completed |
03.4 |
L-14-Marble in Floor |
464m2 |
19% |
17-12-23 |
06-01-24 |
20-12-23 |
17-01-24 |
-11 |
Completed |
03.5.1 |
L-14-Outside Partition+Door-Mockup |
0 |
100% |
20-12-23 |
23-12-23 |
24-12-23 |
24-12-23 |
-1 |
|
03.5.2 |
L-14-Outside Partition+Door-make,in |
0 |
20% |
23-12-23 |
01-01-24 |
30-12-23 |
01-01-24 |
0 |
Completed |
03.6.1 |
L-14-Outside-Rail-Mockup |
0 |
100% |
23-12-23 |
27-12-23 |
24-12-23 |
24-12-23 |
3 |
|
03.6.2 |
L-14-Outside-Rail-make,install |
0 |
0% |
24-12-23 |
07-01-24 |
|
30-11--1 |
0 |
Started |
03.7.1 |
L-14-Front Lobby-Mockup |
0 |
0% |
23-12-23 |
27-12-23 |
|
30-11--1 |
0 |
Started |
03.7.2 |
L-14-Front Lobby-make,install |
0 |
0% |
01-01-24 |
15-01-24 |
|
30-11--1 |
0 |
Started |
03.8.1 |
L-14-Kitchen-Equipment-Selection |
0 |
0% |
23-12-23 |
25-12-23 |
|
30-11--1 |
0 |
Started |
03.8.2 |
L-14-Kitchen-Equipment-Installation |
0 |
0% |
26-12-23 |
09-01-24 |
|
30-11--1 |
0 |
Started |
03.9.1 |
L-14-Bar Light-Selection |
0 |
0% |
23-12-23 |
25-12-23 |
|
30-11--1 |
0 |
Started |
03.9.2 |
L-14-Bar Light-Insatallation |
0 |
0% |
26-12-23 |
02-01-24 |
|
30-11--1 |
0 |
Started |
06.09.1 |
L-11-Steam n Suana-Ar.Design |
0 |
100% |
25-11-23 |
27-11-23 |
27-11-23 |
27-11-23 |
0 |
|
06.09.2.1 |
L-11-Steam n Suana-Brick-work |
0 |
100% |
28-11-23 |
07-12-23 |
28-11-23 |
07-12-23 |
0 |
|
06.09.2.2 |
L-11-Steam n Suana-Tile/Marble Sele |
0 |
100% |
05-12-23 |
06-12-23 |
09-12-23 |
09-12-23 |
-3 |
|
06.09.2.3 |
L-11-Steam-Tile/Marble-work |
0 |
95% |
11-12-23 |
16-12-23 |
13-12-23 |
22-01-24 |
-37 |
Completed |
06.09.2.4 |
L-11-Steam-RCC Seating |
0 |
100% |
08-12-23 |
09-12-23 |
09-12-23 |
09-12-23 |
0 |
|
06.09.2.5 |
L-11-Steam n Suana-Plastering |
0 |
100% |
09-12-23 |
13-12-23 |
09-12-23 |
13-12-23 |
0 |
|
06.09.2.6 |
L-11-Steam-Suana-Design Plaster |
|
60% |
16-01-24 |
22-01-24 |
22-01-24 |
22-01-24 |
0 |
Completed |
06.09.4 |
L-11-Steam Machine Installation |
0 |
10% |
17-12-23 |
05-01-24 |
30-12-23 |
30-12-23 |
6 |
Completed |
06.09.6 |
L-11-Steam n Suana-MEP Works |
0 |
85% |
12-12-23 |
18-12-23 |
09-12-23 |
24-01-24 |
-37 |
Completed |
06.09.7 |
L-11-Steam-Suana-False Ceiling |
0 |
15% |
28-12-23 |
31-12-23 |
28-12-23 |
22-01-24 |
-22 |
Completed |
06.09.8 |
L-11-Suana-Wooden Floor-Wall |
0 |
95% |
30-12-23 |
05-01-24 |
30-12-23 |
06-01-24 |
-1 |
Completed |
06.10 |
L-11-Louge Outside Glass Frame |
0 |
50% |
24-12-23 |
30-12-23 |
26-12-23 |
28-12-23 |
2 |
Completed |

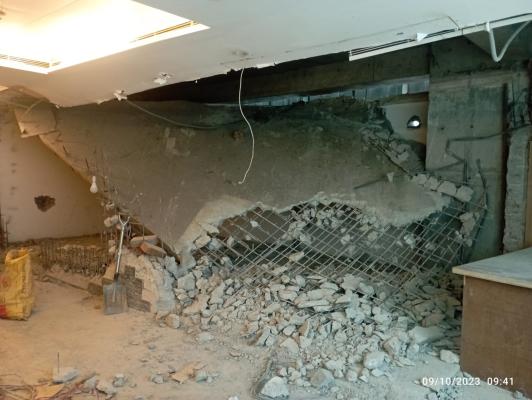

12.1.1 |

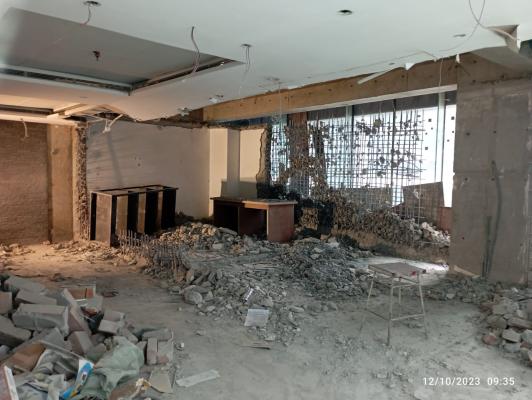

L-4-North-East-Vault Dismantling |
1sum |
100% |

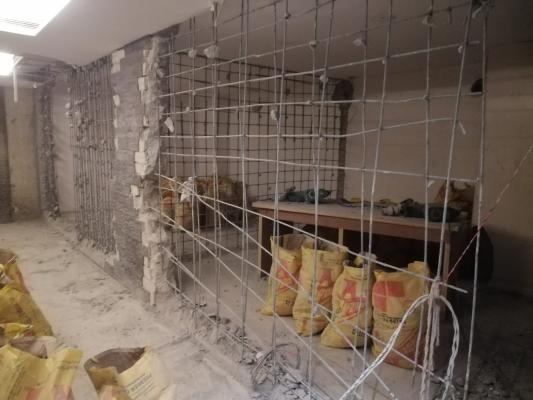

05-10-23 |
12-10-23 |
07-10-23 |
14-10-23 |
-2 |
|
12.1.2 |
L-4-North-East-Vault debris shiftin |
1sum |
100% |
13-10-23 |
14-10-23 |
10-10-23 |
15-10-23 |
-1 |
|
Site Photographs |
|
L-4-North Vault dismanling on 7-10-23 |
|
L-4-North Vault dismantling on 7-10-23 |
|
|
|
L-4-North-East Vault dismantling on 8-10-23 |
|
L-4-North-East Vault dismantling on 8-10-23 |
|
|
|

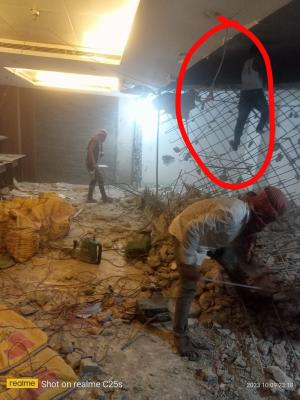

L-4-North Vault dismanling on 9-10-23 |
|
L-14-Old Kitchen wall dismantling on 9-10-23 |
|
Proper Safety (PPE) must maintain |
|
Safety Induction to Labour on 10-10-23 |
|
L-14-Fin glass broken during dismantling on 10-10-23 |
|
Dismantle carefully avoiding any damage |
|

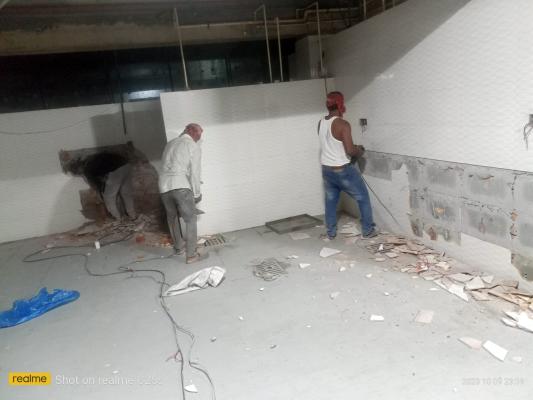

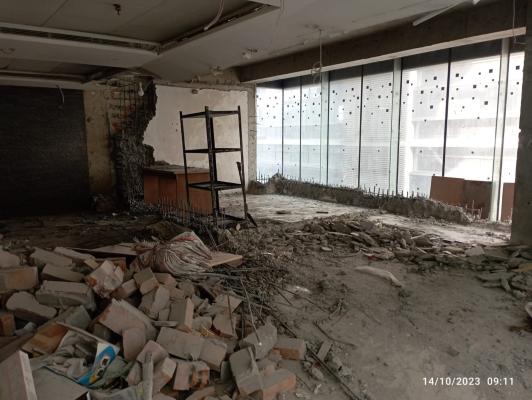

L-14-Old Kitchen wall dismantling on 11-10-23 |
|
L-4-North Vault dismanling on 11-10-23 |
|
|
|

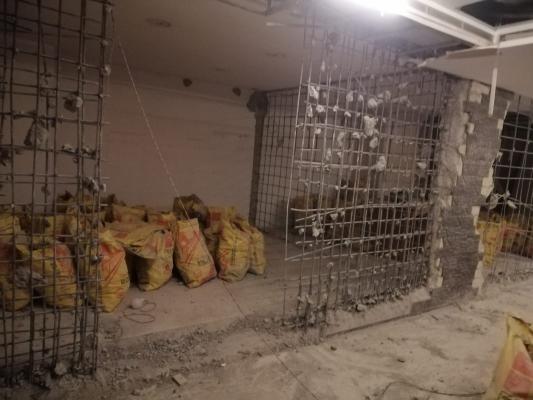

L-4-North Vault dismanling on 13-10-23 |
|
L-14-Old Kitchen wall dismantling on 13-10-23 |
|
|
|

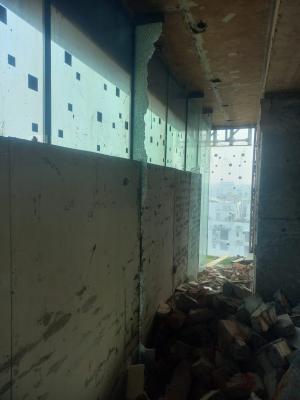

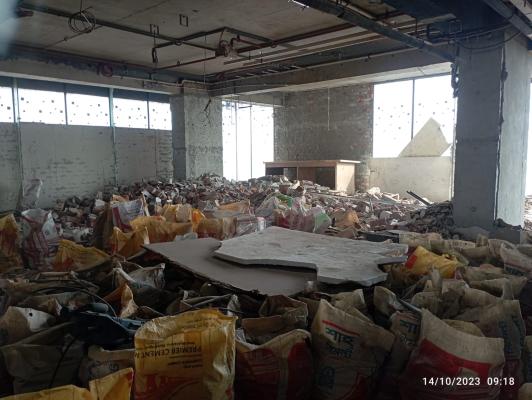

L-4-North-East Vault demolition complete on 14-10-23 |
|

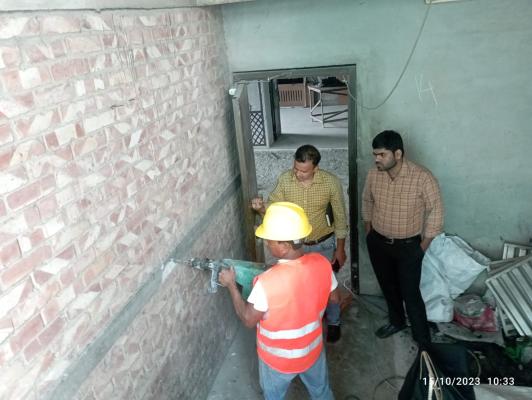

L-14-Stair Case-S-Door Cutting Start on 14-10-23 |
|
|
|

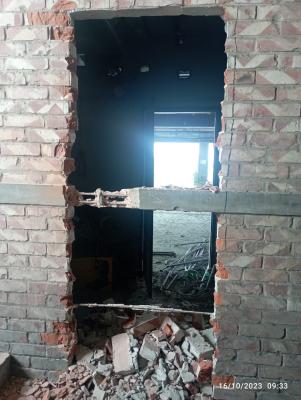

L14-Starcase-South-Door Cutting on 15-10-23 |
|

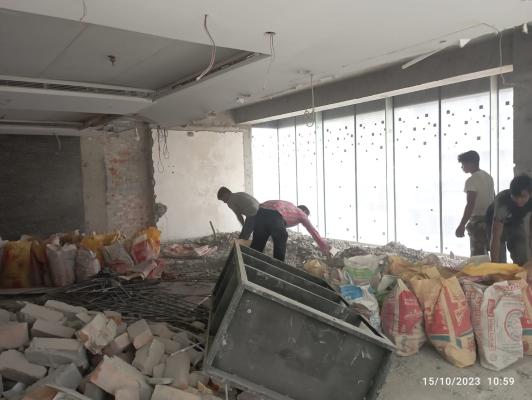

L14-Old Kitchen Wall-shelf demolition co on 15-10-23 |
|
|
|

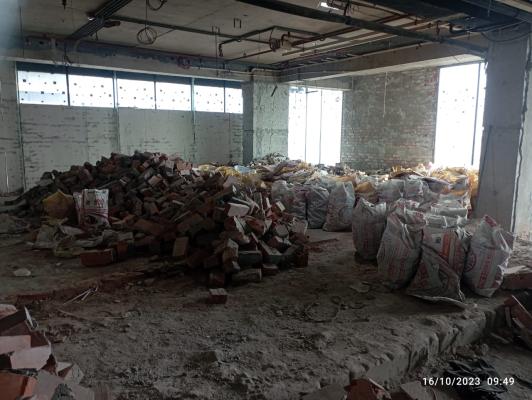

L-14-Kitchen Area on 16-10-23 |
|

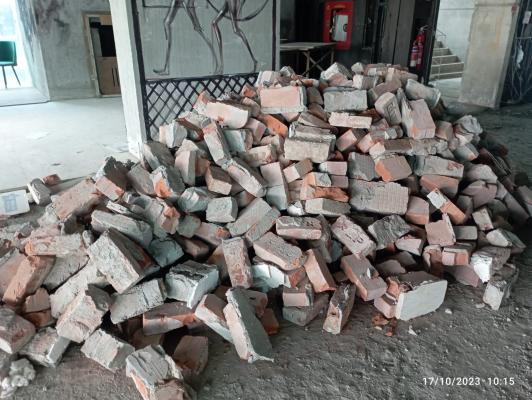

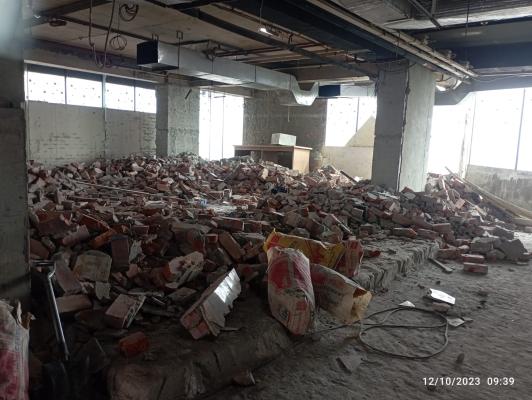

L-14-Dismatled Brick on 16-10-23 |
|
Dismantled brick to be used in another work |
|
L-14-Litchen Floor dismantling on 17-10-23 |
|
L-14-East-South Wall dismantling on 17-10-23 |
|
Proper PPE must be maintained |
|

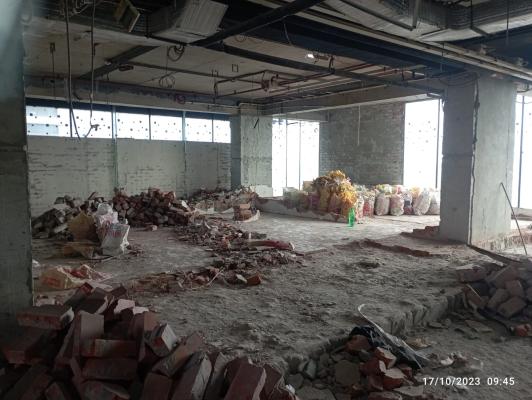

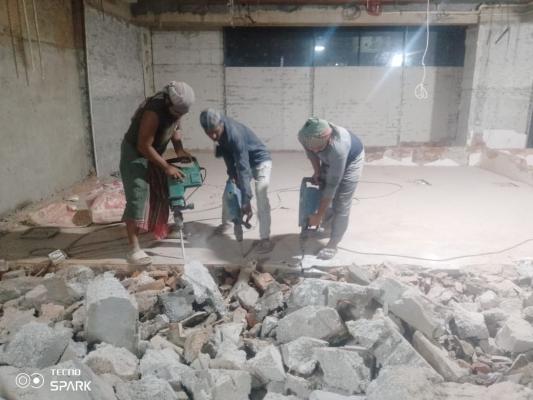

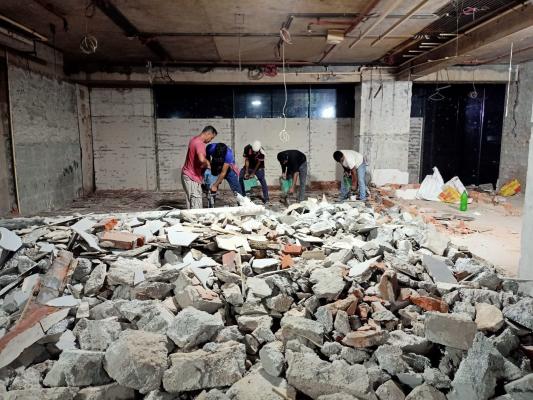

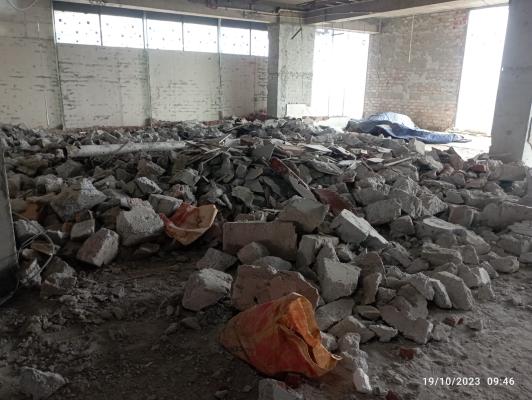

L-14-Kitchen Floor dismantling on 18-10-23 |
|
L-14-Kithen Floor Area on 18-10-23 |
|
Proper PPE must be maintained |
|
L-14-Kitcjen-Floor Dismantling on 19-10-23 |
|
L-14-Kitchen Floor Debris shifting on 19-10-23 |
|
Proper Safety (PPE) must maintain |
|

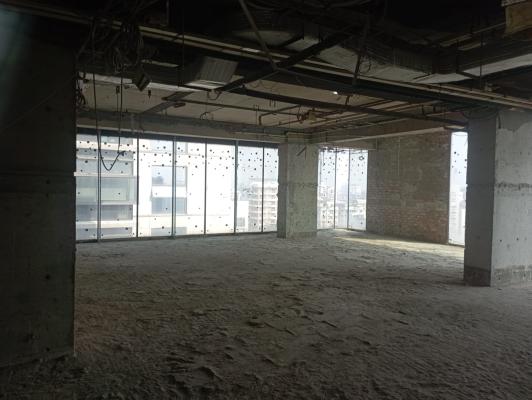

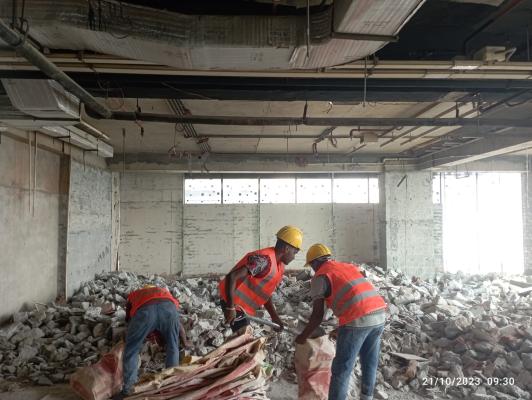

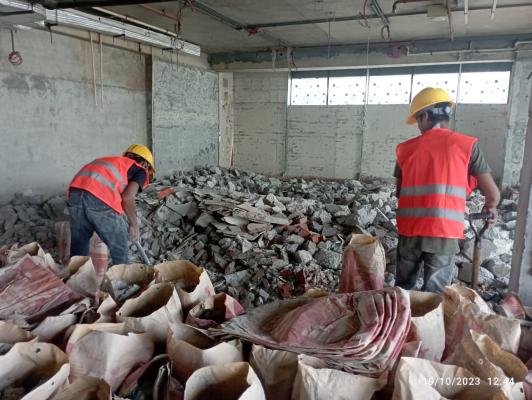

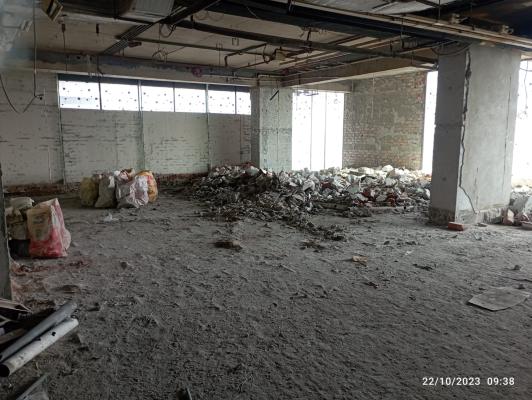

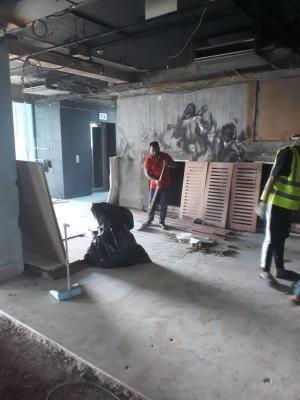

L-14-Kitchen Floor Debris Removing on 23-10-23 |
|
L-14-Kitchen Area on 23-10-23 |
|
|
|

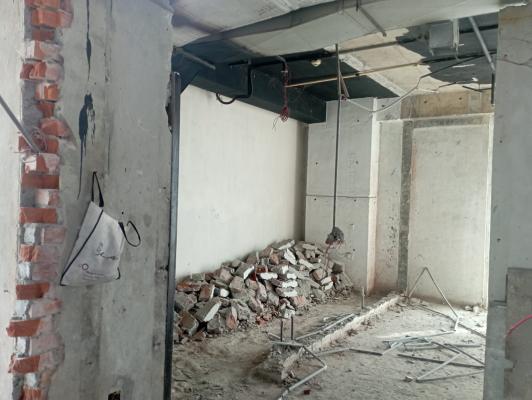

L-14-Kitchen Area on 24-10-23 |
|
L-14-Kitchen Area on 24-10-23 |
|
|
|

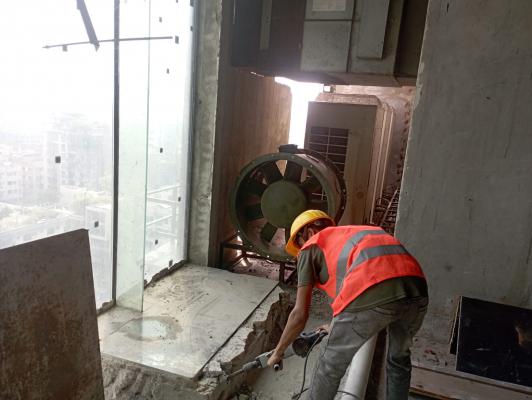

L-14-Old Kitchen Floor Dismantling on 25-10-23 |
|
L-14-Old Kitchen Area on 25-10-23 |
|
|
|

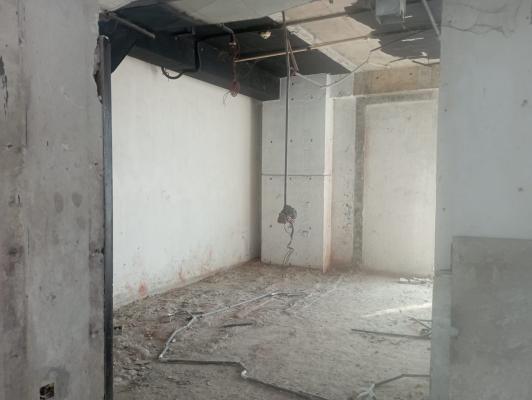

L-14-Old Kitchen Area on 26-10-23 |
|

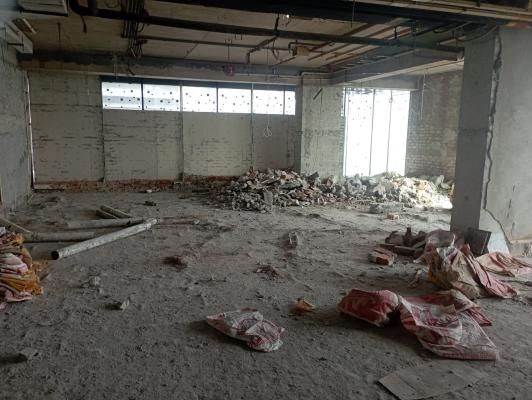

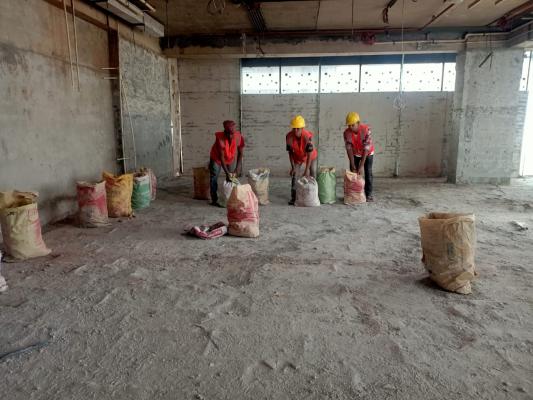

L-14-Old Kitchen Area Debris removing on 26-10-23 |
|
|
|

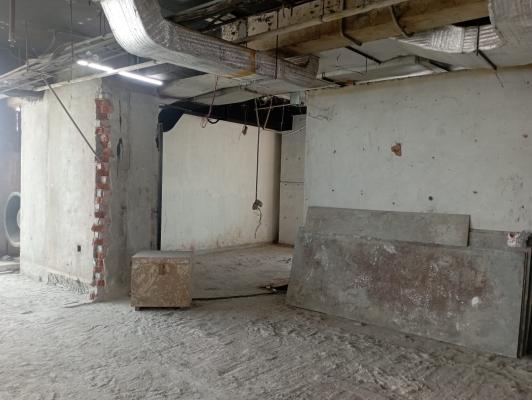

L-14-Old Kitchen Area on 28-10-23 |
|
L-14-Old Kitchen Area on 28-10-23 |
|
|
|

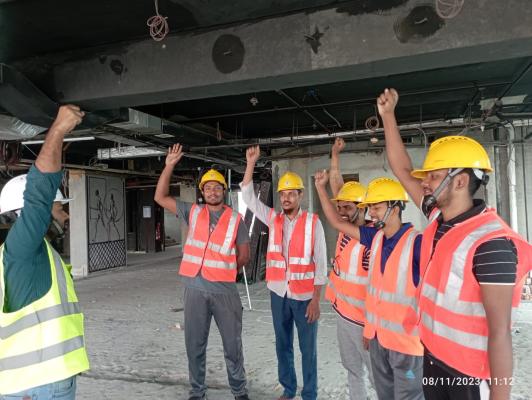

Safety Induction on 8-11-23 |
|

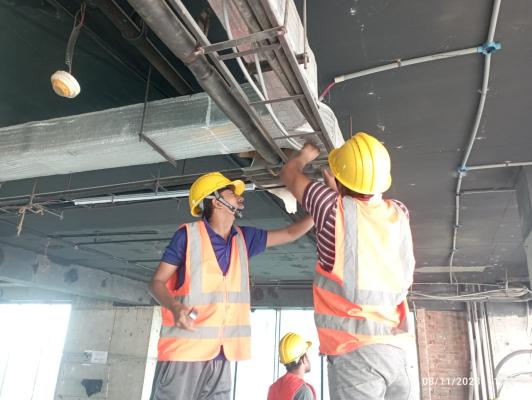

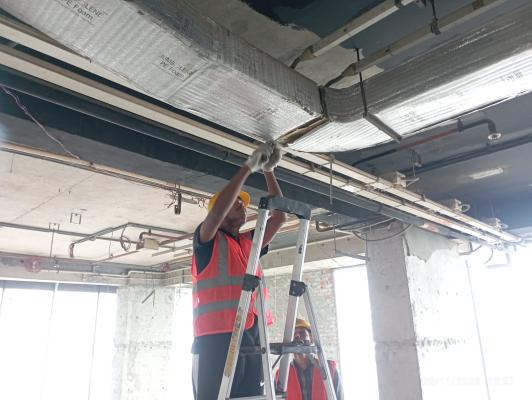

L-14-Old AC Duct Removing on 8-11-23 |
|
|
|

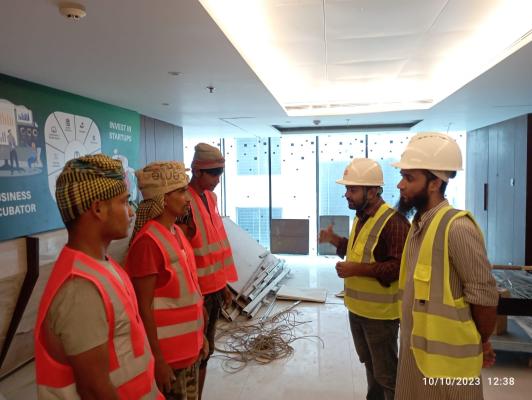

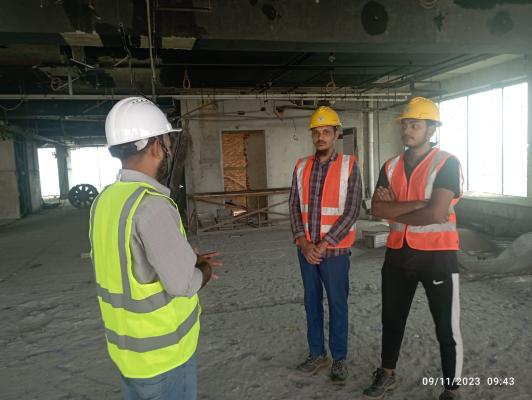

Tool-box Meeting on 9-11-23 |
|
L-14-Old AC duct removing on 9-11-23 |
|
|
|

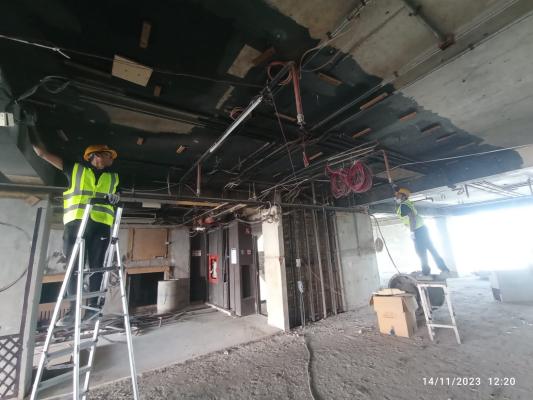

L-14-AC installation on 14-11-23 |
|
L-14-AC installation on 14-11-23 |
|
|
|
L-14-AC Installation on 15-11-23 |
|
L-14-AC Installation on 15-11-23 |
|
|
|

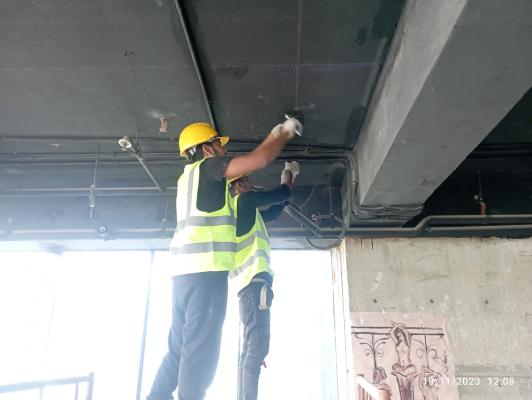

L-14-AC Installation on 19-11-23 |
|
L-14-AC Installation on 19-11-23 |
|
|
|
L-14-AC Installation on 22-11-23 |
|

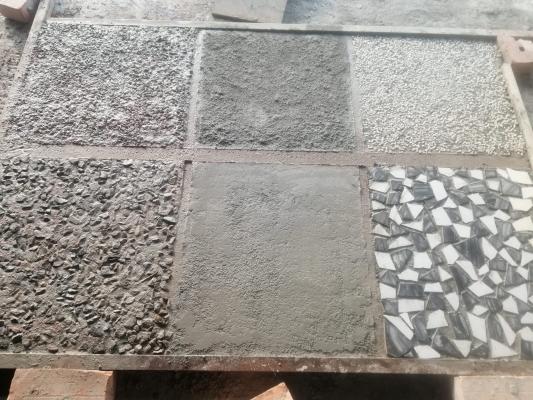

L-14-NCF Mock-up on 22-11-23 |
|
|
|

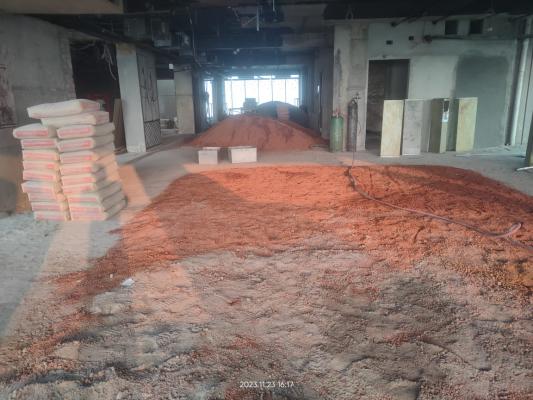

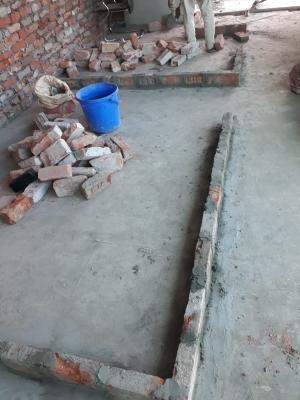

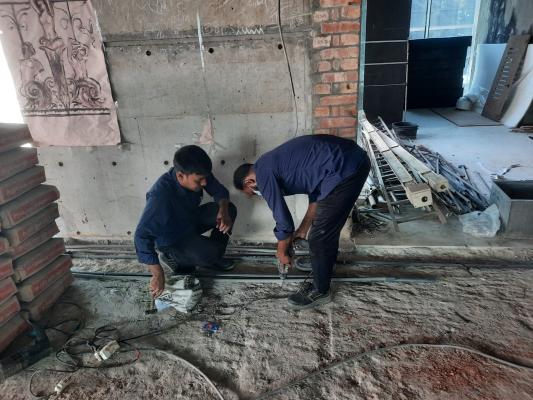

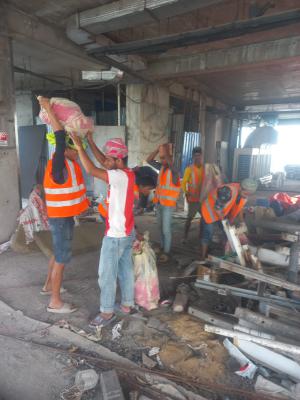

L-16-Materials Removal on 23-11-23 |
|
L-14-NCF Material procured on 23-11-23 |
|
|
|

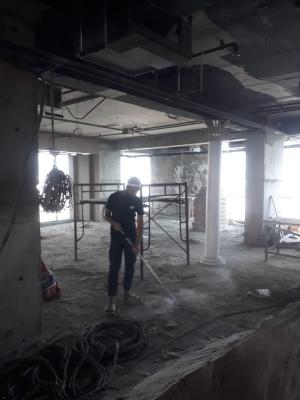

L-16-Materials Removal on 25-11-23 |
|

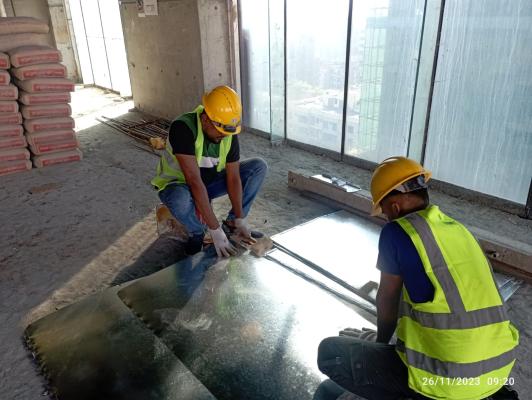

L-16-Materials Removal on 25-11-23 |
|
|
|
L-14-AC Duct fabrication on 26-11-23 |
|
L-14-Electrical Pipe Laying on 26-11-23 |
|
|
|

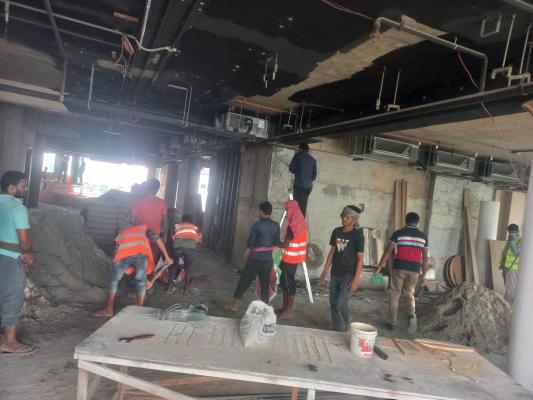

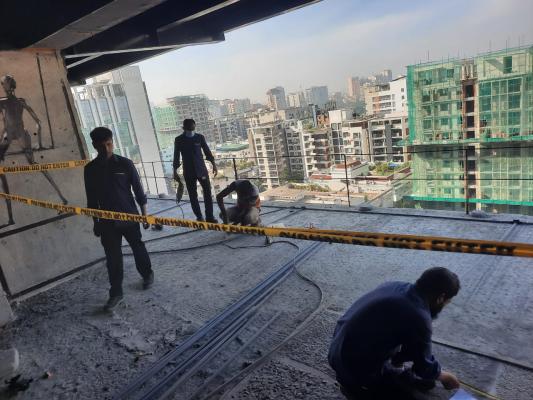

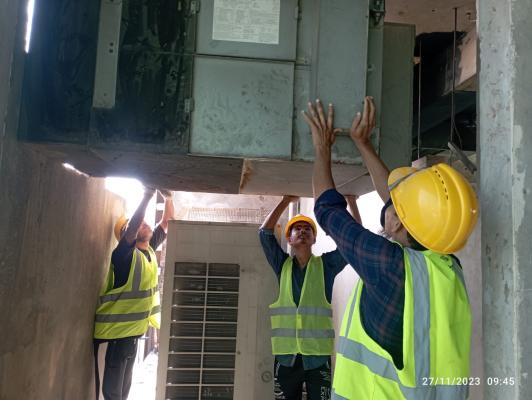

L-14-AC Installation on 27-11-23 |
|
L-14-Electrical Pipe Laying on 27-11-23 |
|
|
|
L-14-Electrical Pile laying on 28-11-23 |
|

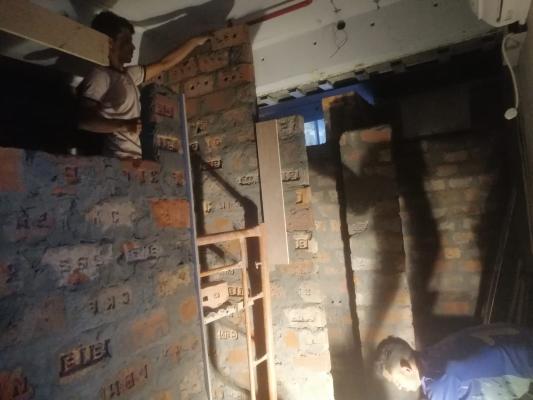

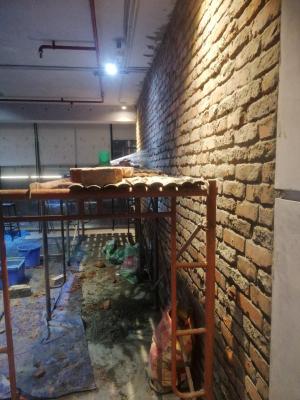

L-11-Steam n Suana-Brickwork on 28-11-23 |
|
|
|

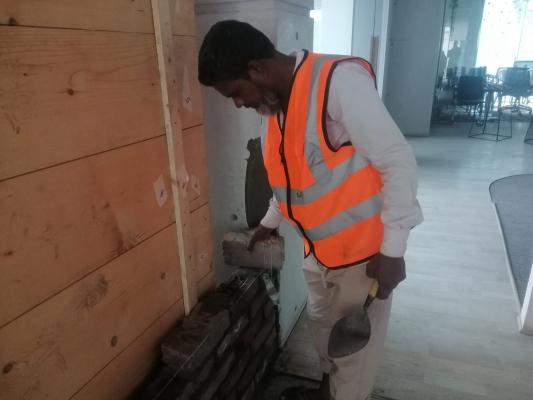

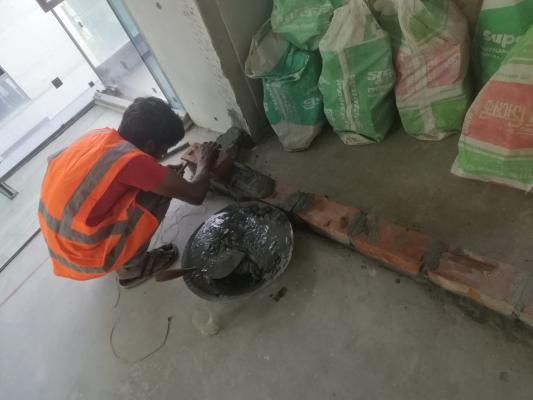

L-16-Materials Removal on 29-11-23 |
|
L-11-Steam n Suana-Brickwork on 29-11-23 |
|
|
|

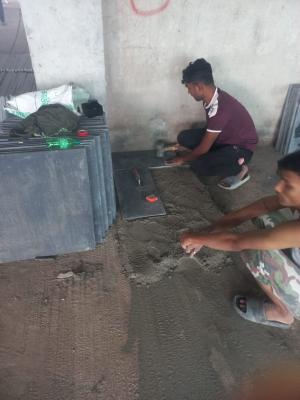

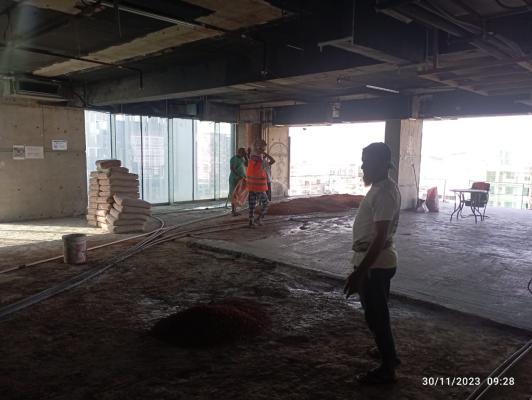

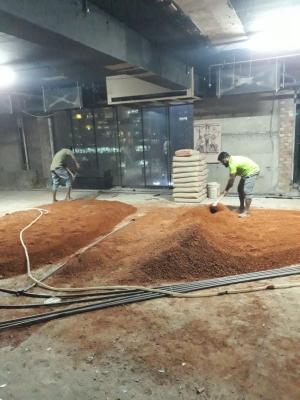

L-14-NCF Work start at night on 30-11-23 |
|
L-14-Floor NCF Work on 30-11-23 |
|
|
|

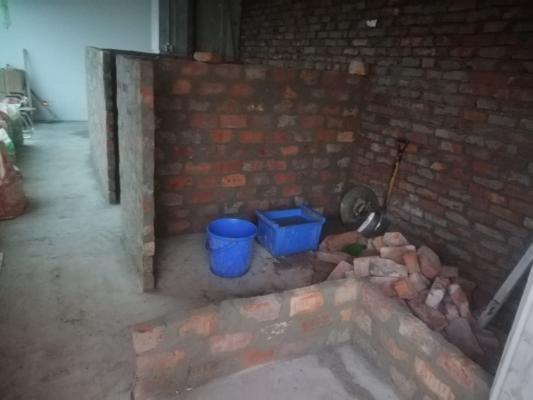

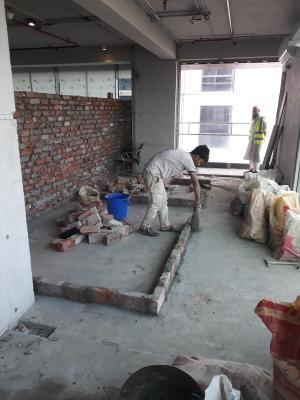

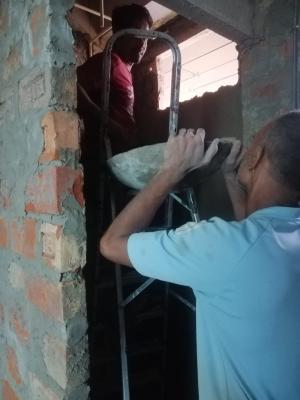

L-11-Steam-Suana-Brick-work on 2-12-23 |
|
L-11-Steam-Suana-Brick-work on 2-12-23 |
|
|
|
L-11-Steam-Suana-Brick-work on 3-12-23 |
|
L-11-Steam-Suana-Brick-work on 3-12-23 |
|
|
|
L-11-Steam-Suana-Brick-work on 4-12-23 |
|
L-11-Steam-Suana-Brick-work on 4-12-23 |
|
|
|

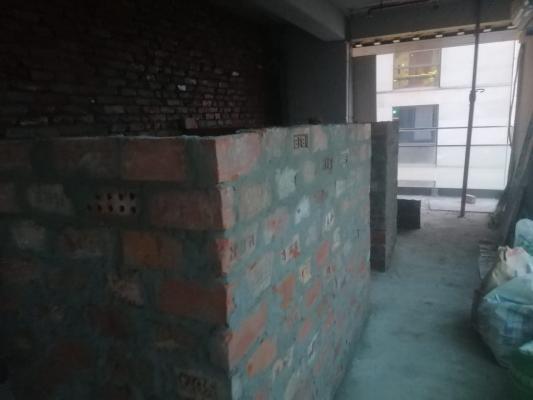

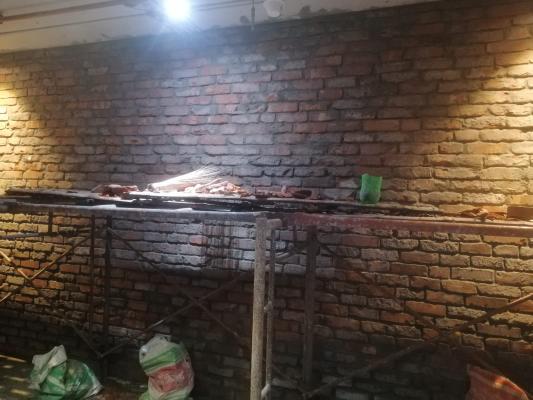

L-11-Steam-Suana-Brickwork on 7-12-23 |
|
L-11-Steam-Suana-Brickwork on 7-12-23 |
Three days progress |
|
|

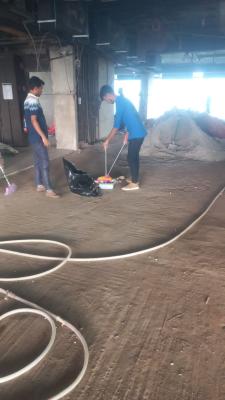

L-11-Steam-Suana-MEP Works on 9-12-23 |
|
L-11-Steam-Seating RCC work on 9-12-23 |
Two days work |
|
|

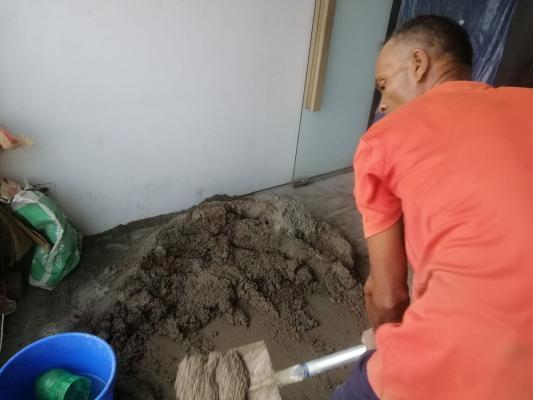

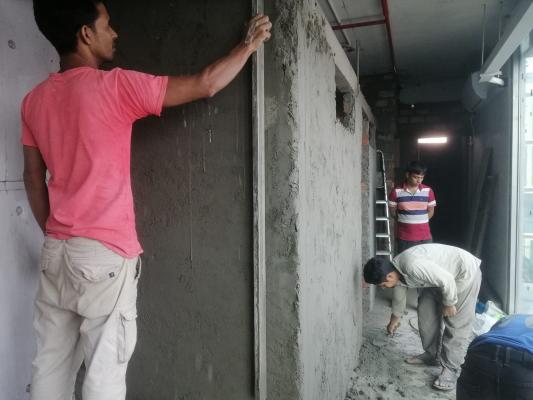

L-11-Steam-Suana-Plumbing work on 10-12-23 |
|
L-11-Steam-Suana-Plastering on 10-12-23 |
|
|
|
L-11-Steam-Suana-Plumbing work on 11-12-23 |
|
L-11-Steam n Suana-Plastering on 11-12-23 |
|
|
|

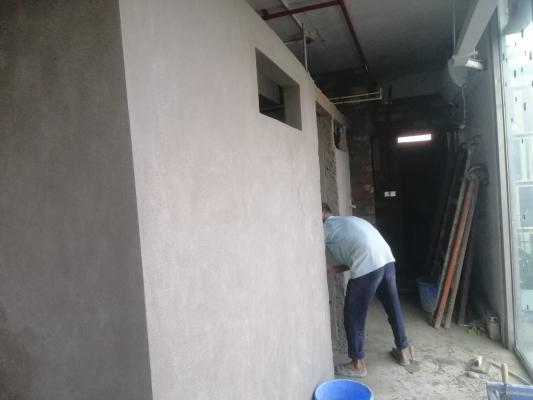

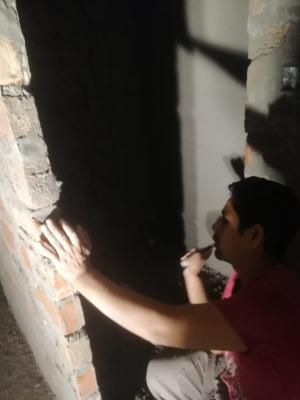

L-11-Steam-Suana-Plastering on 12-12-23 |
|
L-11-Steam-Suana-Plastering on 12-12-23 |
|
|
|
L-11-Steam-Marble moulding on 13-12-23 |
|
L-11-Steam-Wall tile fixing on 13-12-23 |
|
|
|

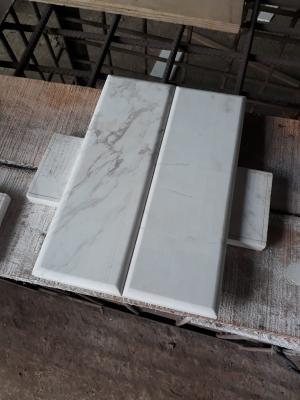

L-11-Steam-Tile Work on 17-12-23 |
|
L-11-Steam-Tile/Marble Work on 17-12-23 |
Three days work |
|
|
L-11-Steam-Suana-Marble fixing on 20-12-23 |
|
L-11-Electrical wiring on 20-12-23 |
Three days work |
|
|

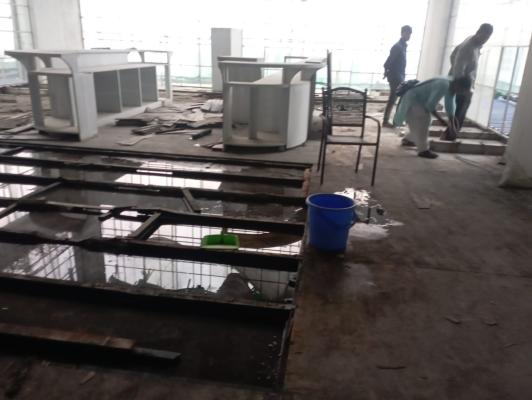

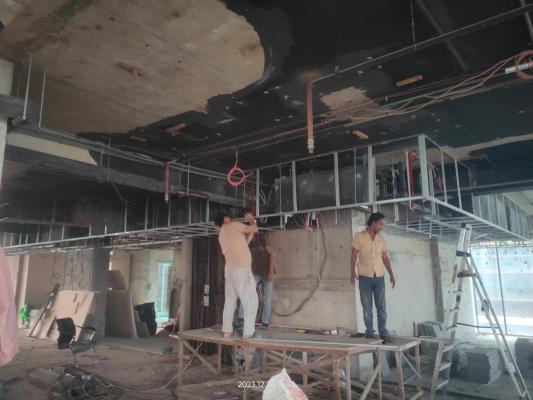

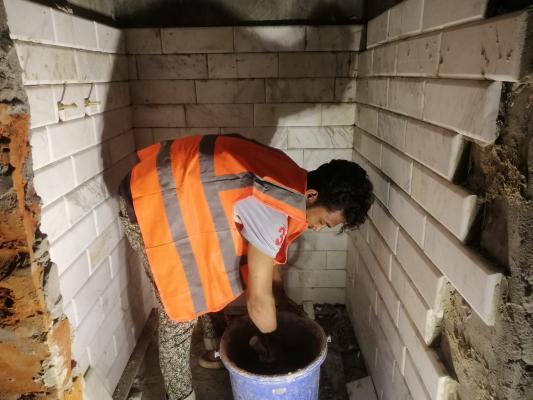

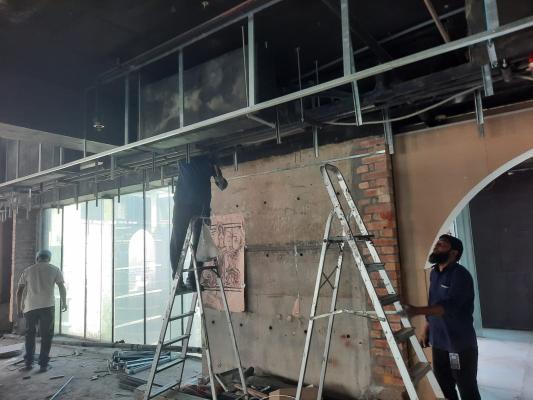

L-14-False Ceiling work on 24-12-23 |
|
L-15-Wooden Floor dismantling on 24-12-23 |
Three days work |
|
|

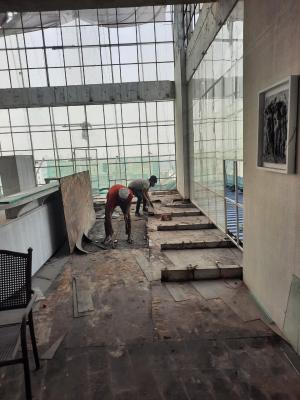

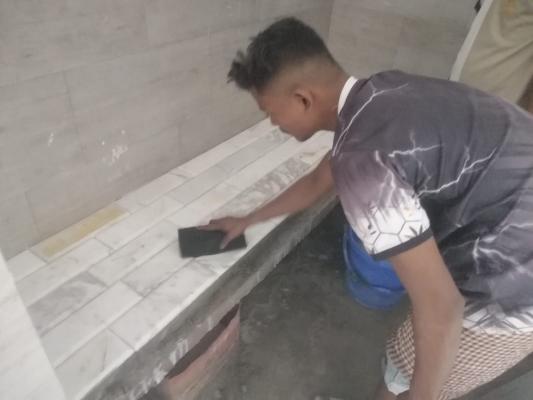

L-11-Steam-Suana-Marble Polishing on 26-12-23 |
|
L-15-Wooden Floor dismantling on 26-12-23 |
Two days work |
|
|

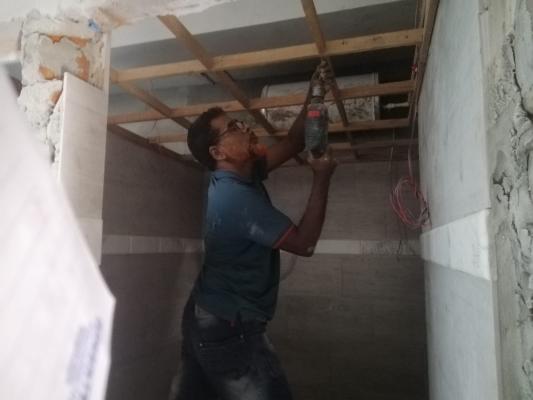

L-11-Steam-Suana-False Ceiling on 28-12-23 |
|

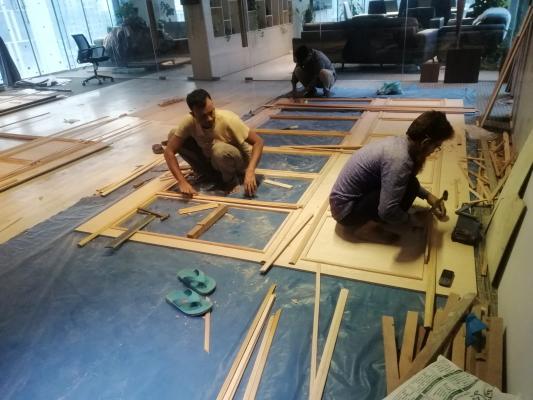

L-11-Lounge Outside Glass Frame on 28-12-23 |
Two days work |
|
|

L-11-Steam machine installation on 30-12-23 |
|

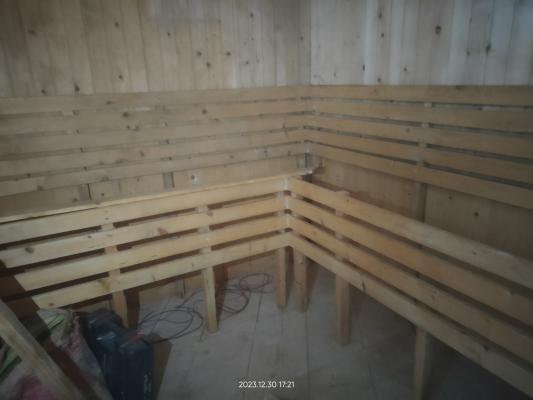

L-11-Suana Wooden wall on 30-12-23 |
|
|
|
L-11-Steam-Suana-Wooden Wall-Lighting on 1-01-24 |
|
L-14-Floor Marble Mock-up on 1-01-24 |
Two days work |
|
|
L-11-Suana-Wooden Wall Work on 6-01-24 |
|
L-14-AC Duct installation on 6-01-24 |
Five days work |
|
|
L-14-AC Duct fabrication on 8-01-24 |
|
L-14-False Ceiling Work on 8-01-24 |
|
|
|
L-11-Steam-Suana-Marble rectification on 10-01-24 |
|
L-14-Electrical work on 10-01-24 |
Two days work |
|
|
L-14-AC Ducting on 17-01-24 |
|

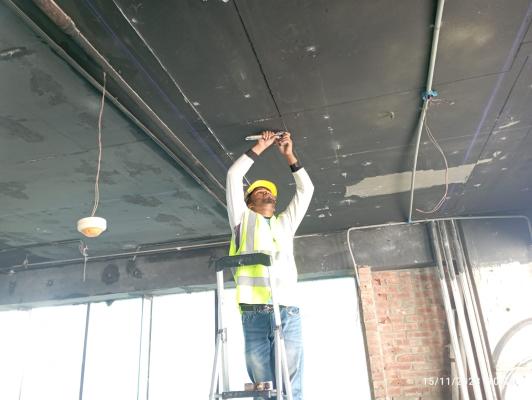

L-14-False Ceiling Work on 17-01-24 |
Seven days progress |
|
|

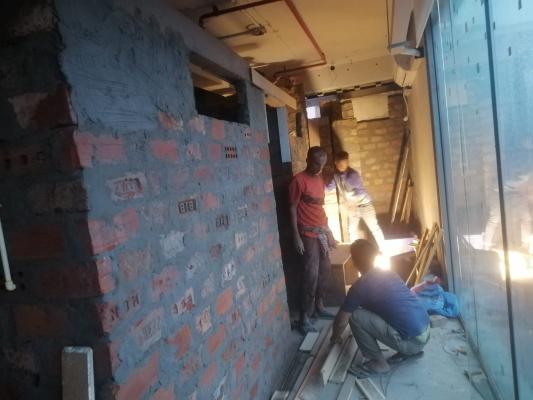

L-11-Outside Design Plaster on 22-01-24 |
|
L-14-False Ceiling and Interior on 22-01-24 |
Five days progress |
|
|
L-15-CC with NCF on 24-01-24 |
|
L-11-Light fitting on 24-01-24 |
Two days progress |
|
|
L-14-Floor CC with NCF on 26-01-24 |
|
L-14-Floor CC with NCF on 26-01-24 |
Three days progress |
|
|

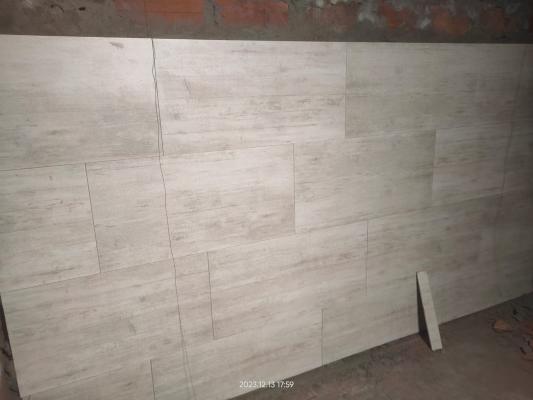

L-15-Toilet Floor CC with NCF on 28-01-24 |
|
L-15-Floor CC with NCF on 28-01-24 |
|
|
