MONTHLY PROGRESS REPORT

From 1-January-2024 to 28-January-2024
Project Code: 63Name:Cityscape Lifestyle
Client: Cityscape Lifestyle Contractor:Cityscape International Ltd.
Progress as on: 28-January-2024
WBSWork Description
Total QuantityUpto 31-12-23This MonthTotal Done Schedule StartSchedule FinishActual Finish
02.2.2 L-15-CC with Neat Cement Finish 156m2 0% 100% 100% 24-01-24 27-01-24 28-01-24
03.3.1 L-14-AC Installation 1sum 57% 3% 60% 31-10-23 10-01-24 17-01-24
03.3.6.2 L-14-Ceiling-Installation 0 34% 3% 37% 17-11-23 15-01-24 17-01-24
03.3.7 L-14-Internal Electrif-Floor+Ceilin 0 23% 1% 24% 04-11-23 02-01-24 10-01-24
03.4 L-14-Marble in Floor 464m2 13% 6% 19% 17-12-23 06-01-24 17-01-24
03.5.2 L-14-Outside Partition+Door-make,in 0 10% 10% 20% 23-12-23 01-01-24 01-01-24
06.09.2.3 L-11-Steam-Tile/Marble-work 0 90% 5% 95% 11-12-23 16-12-23 22-01-24
06.09.2.6 L-11-Steam-Suana-Design Plaster 0% 60% 60% 16-01-24 22-01-24 22-01-24
06.09.6 L-11-Steam n Suana-MEP Works 0 45% 40% 85% 12-12-23 18-12-23 24-01-24
06.09.7 L-11-Steam-Suana-False Ceiling 0 10% 5% 15% 28-12-23 31-12-23 22-01-24
06.09.8 L-11-Suana-Wooden Floor-Wall 0 20% 75% 95% 30-12-23 05-01-24 06-01-24

MANPOWER HISTOGRAM

DAILY PROGRESS

Site Photographs

L-11-Steam-Suana-Wooden Wall-Lighting on 1-01-24L-14-Floor Marble Mock-upon 1-01-24
Two days work

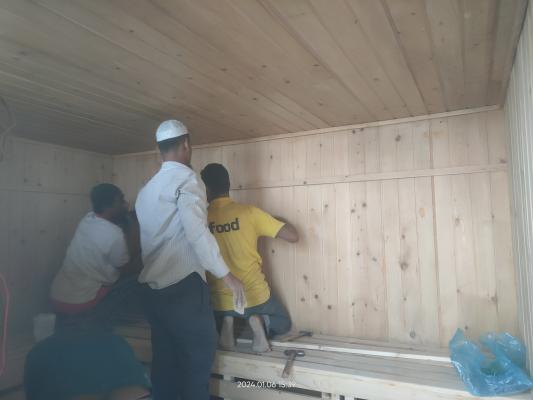

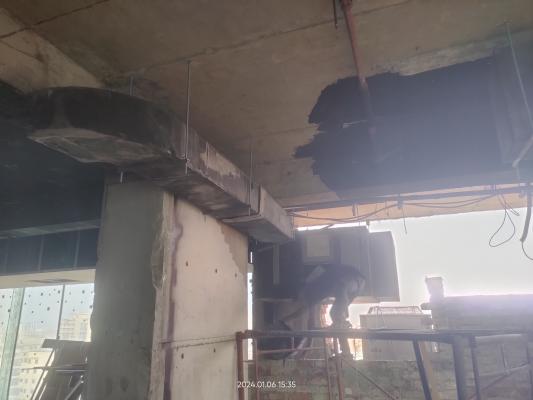

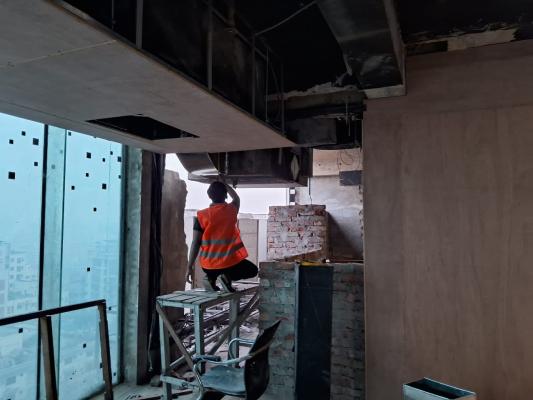

L-11-Suana-Wooden Wall Work on 6-01-24L-14-AC Duct installationon 6-01-24
Five days work

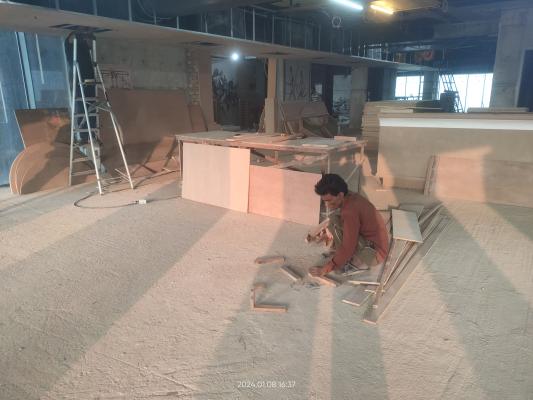

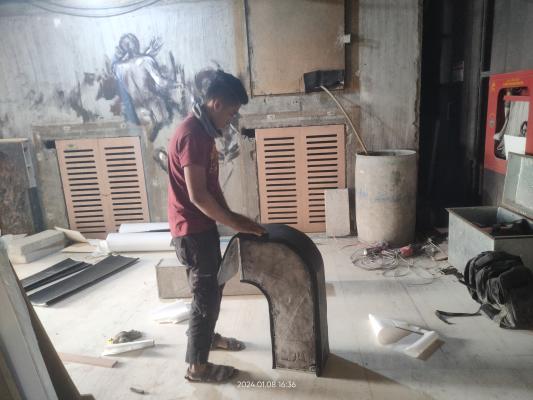

L-14-AC Duct fabrication on 8-01-24L-14-False Ceiling Workon 8-01-24

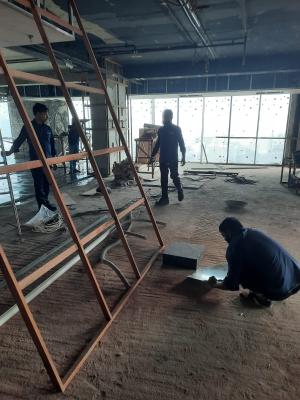

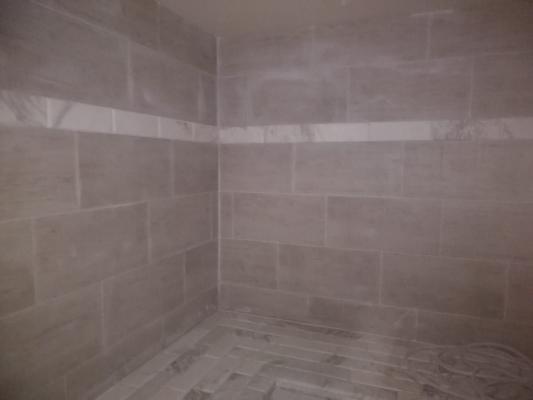

L-11-Steam-Suana-Marble rectification on 10-01-24L-14-Electrical workon 10-01-24
Two days work

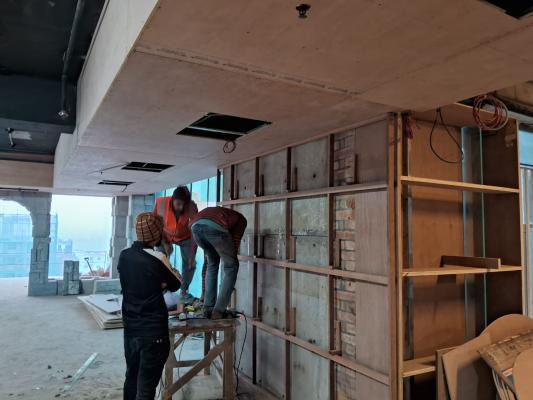

L-14-AC Ducting on 17-01-24L-14-False Ceiling Workon 17-01-24
Seven days progress

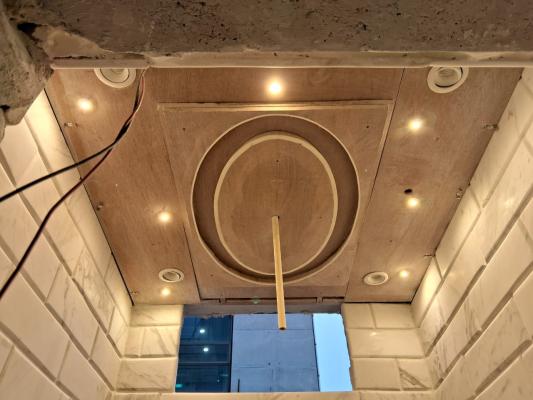

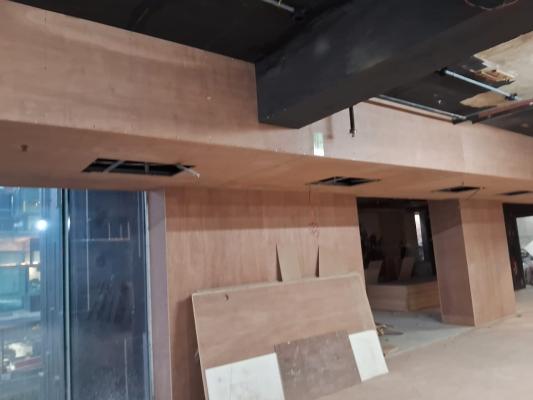

L-11-Outside Design Plaster on 22-01-24L-14-False Ceiling and Interioron 22-01-24
Five days progress

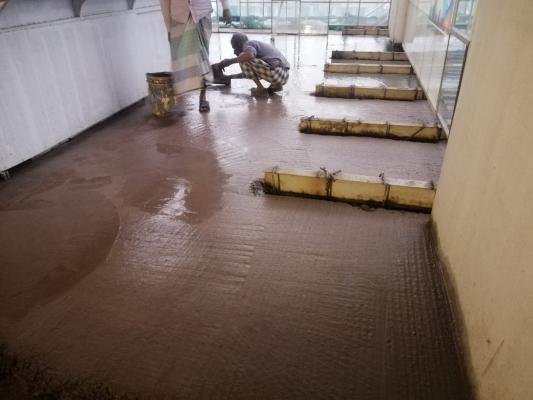

L-15-CC with NCF on 24-01-24L-11-Light fittingon 24-01-24
Two days progress

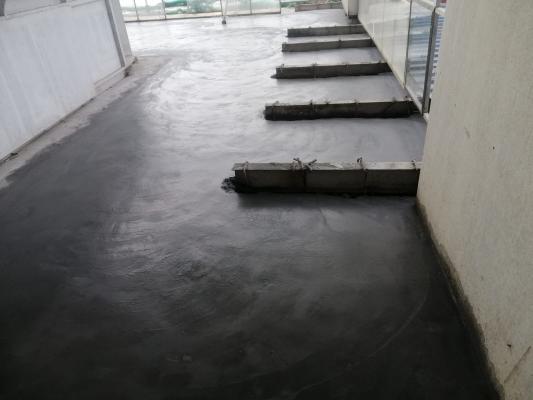

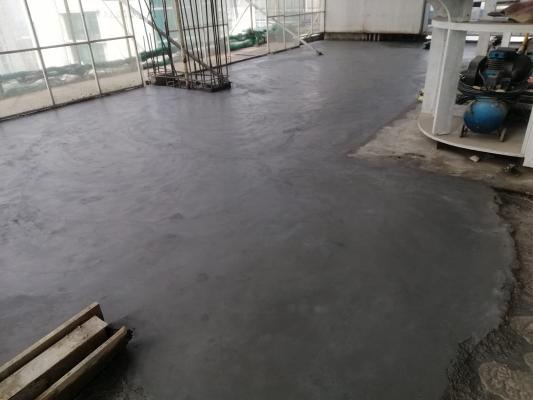

L-14-Floor CC with NCF on 26-01-24L-14-Floor CC with NCFon 26-01-24
Three days progress

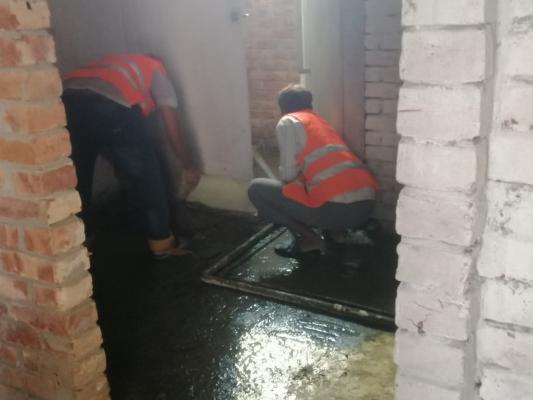

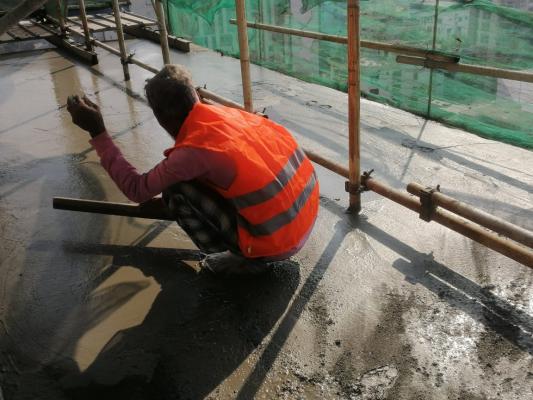

L-15-Toilet Floor CC with NCF on 28-01-24L-15-Floor CC with NCF on 28-01-24
