TOTAL PROGRES REPORT

From 22-December-2022 to 9-April-2023
Project Code: 59 Name: Cityscape Tower-Retrofitting
Client: Cityscape Contractor: Cityscape International Ltd.
Progress as on: 9-April-2023
Total Duration: 108 days Total Working Days: 33 Total Manpower: 130
Planning Progress = 79% Acual Progress = 78.3% SPI: 0.99 Behind Schedule
WBS Work Description
Total Quantity Total Done Schedule Start Schedule Finish Actual Start Actual Finish Lead-Lag(day) Not Yet
01.1 Retrofit-Basement-3-Column-Lift 1sum 100% 26-12-22 15-01-23 22-12-22 09-04-23 -84
01.2 Retrofit-Basement-2-Column 1sum 100% 16-01-23 05-02-23 26-01-23 09-04-23 -63
01.3 Retrofit-Basement-1-Column 1sum 97% 06-02-23 25-02-23 06-03-23 09-04-23 -43 Completed
01.4 Retrofit-upto GF-Column 1sum 0% 26-02-23 15-03-23 0 Started
02 L-17 Slab extension work on west si 1sum 100% 22-12-22 27-12-22 22-12-22 28-12-22 -1

DAILY MANPOWER

CUMMULATIVE ACTUAL WORK PROGRESS

CUMMULATIVE PLAN WORK PROGRESS

CUMMULATIVE WORK PROGRESS

SCHEDULE AHEAD-BEHIND

Site Photographs

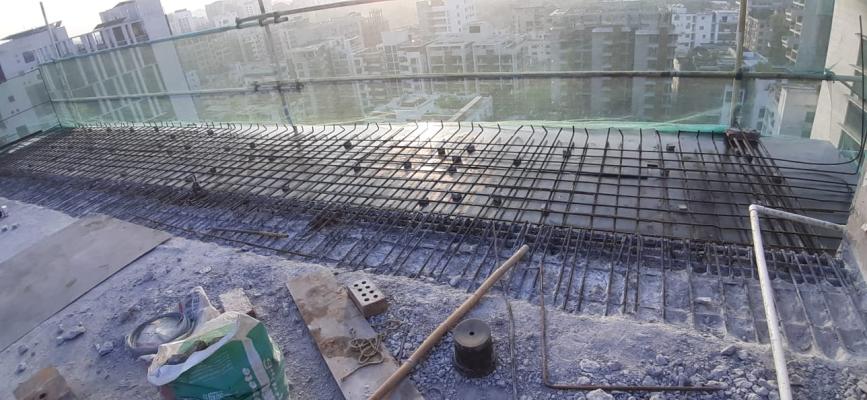

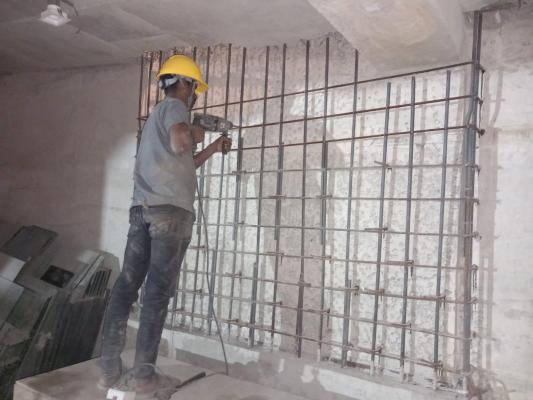

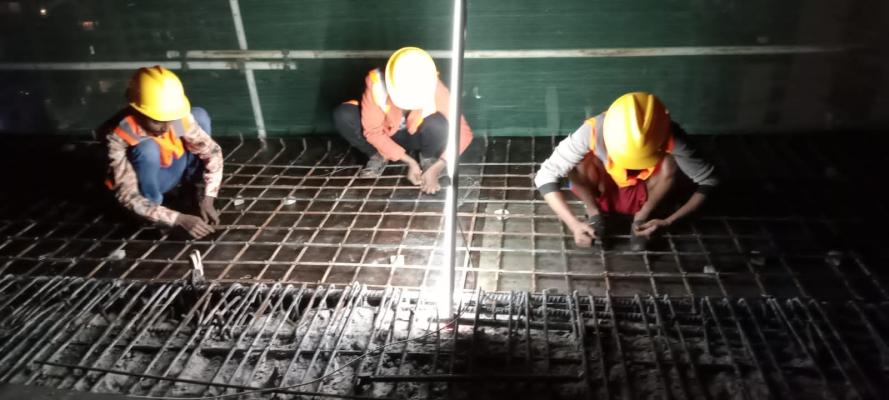

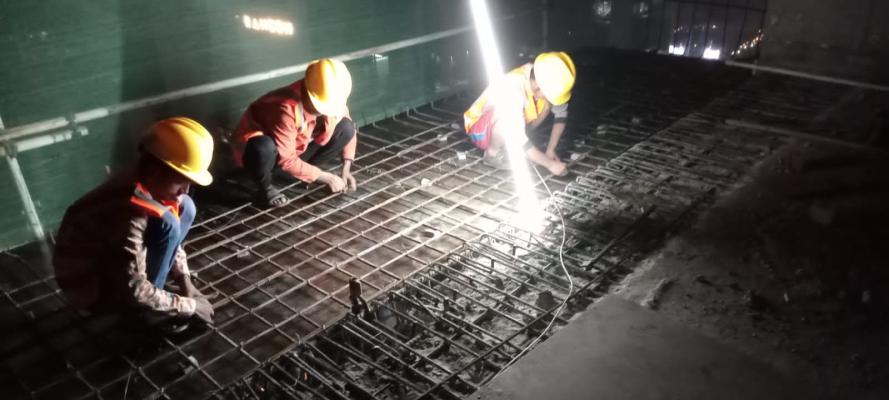

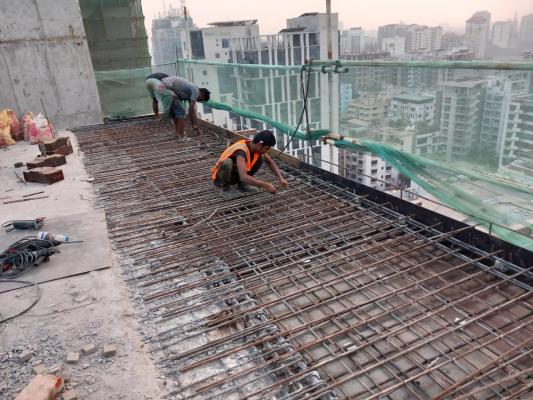

L-17 Slab Extension Re-bar Work on 22-12-22

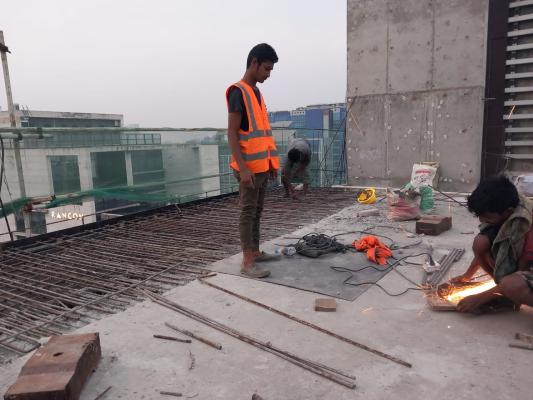

L-17 Slab Extension Re-bar Work on 22-12-22

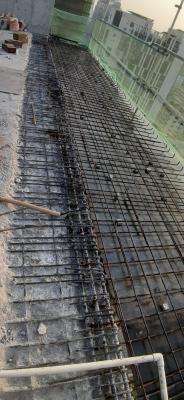

on 23-12-22
on 23-12-22
on 26-12-22
on 26-12-22

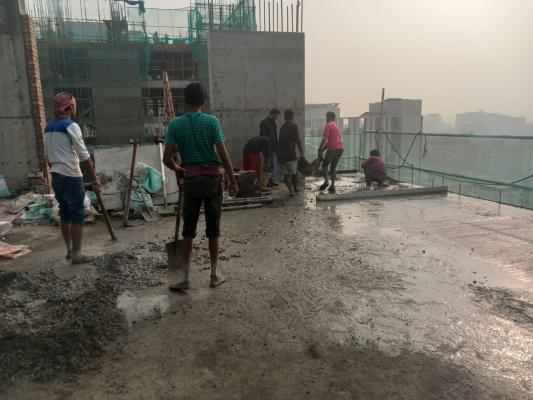

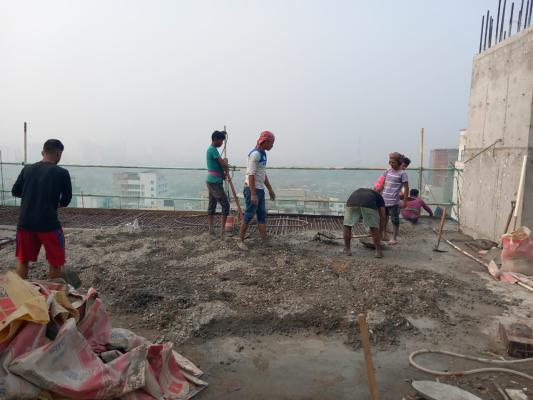

Level-17-Slab Extn Concreting on 28-12-22
Level-17-Slab Extn Concreting on 28-12-22

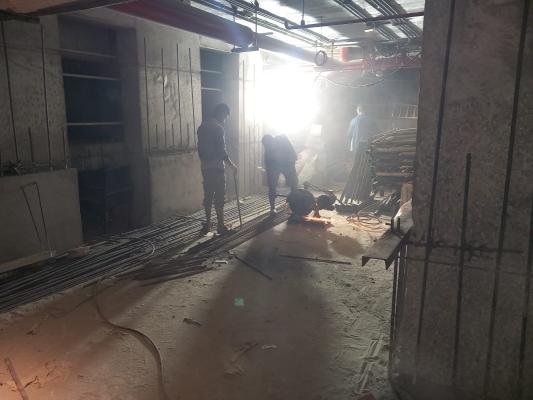

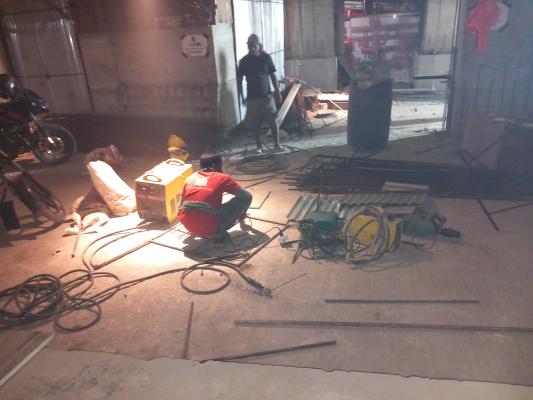

on 31-12-22
on 31-12-22
BUET Professor visiting on 2-01-23
on 2-01-23

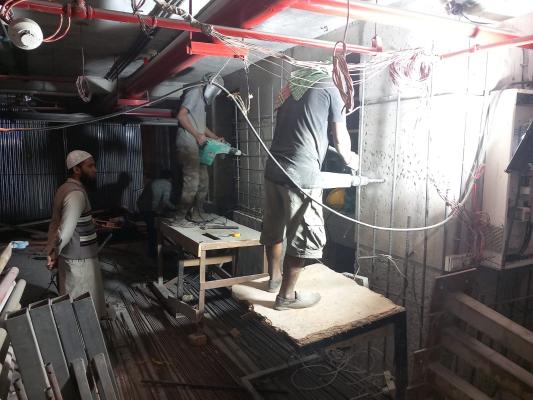

on 3-01-23
on 3-01-23

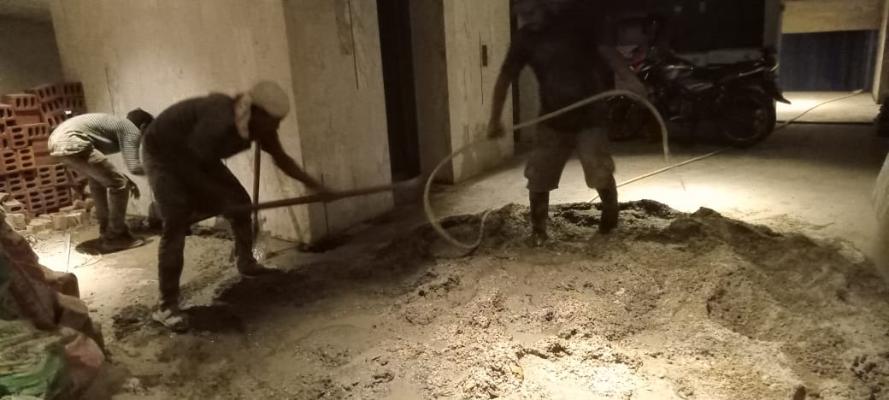

Basement-3 Lift-wall Concreting on 9-01-23
Basement-3 Lift-wall Concreting on 9-01-23

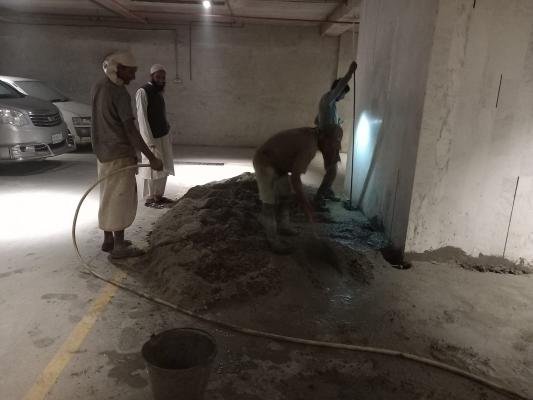

on 11-01-23
on 11-01-23

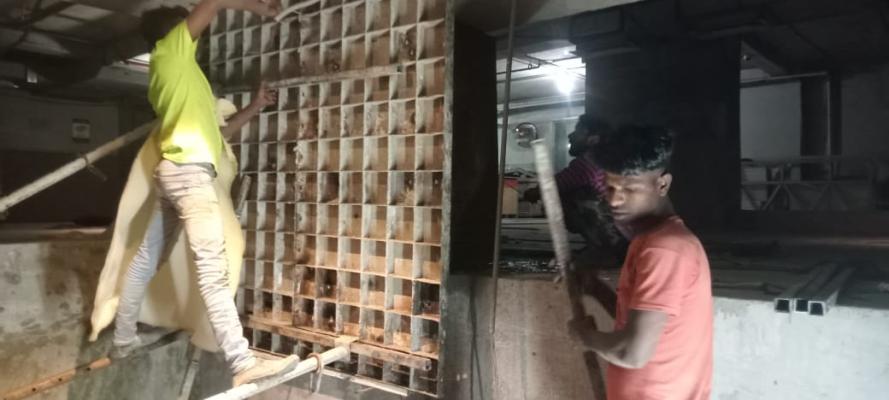

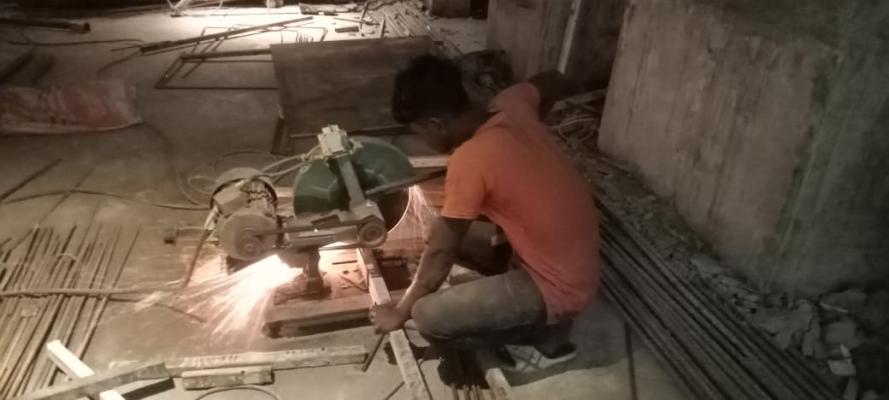

on 17-01-23
on 17-01-23

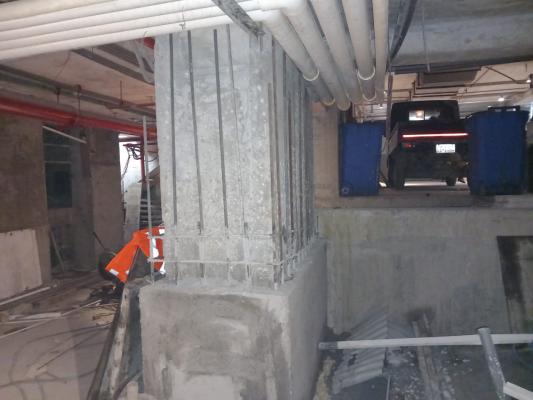

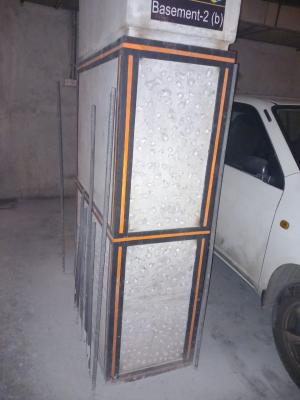

on 26-01-23
on 26-01-23

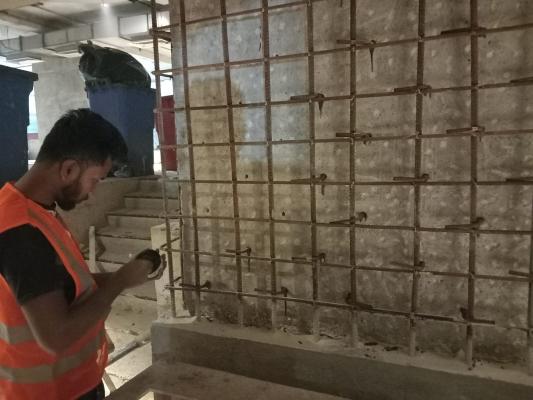

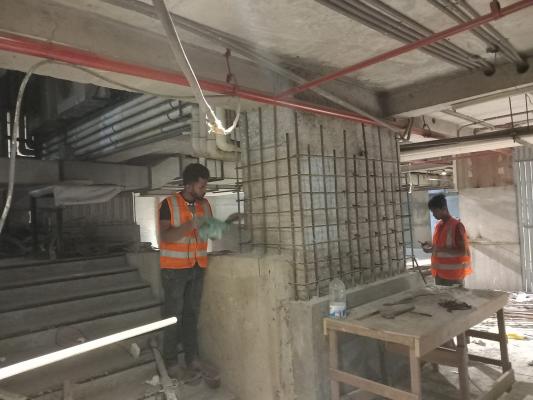

Col.Retrofitting on 5-02-23
Shear Wall Retro. on 5-02-23

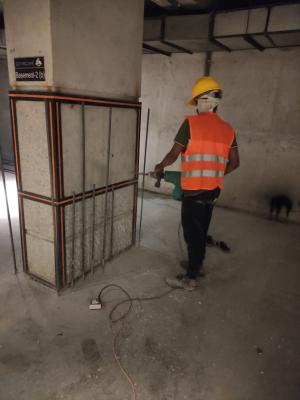

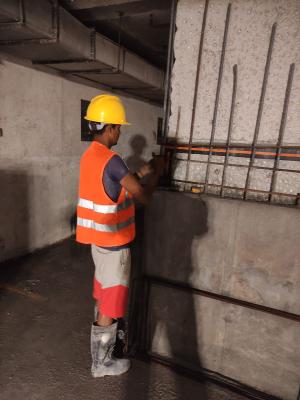

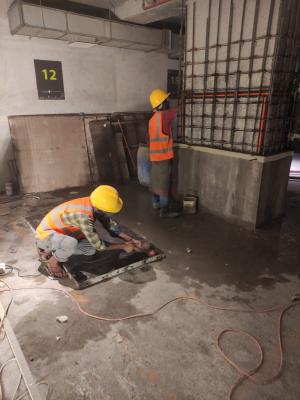

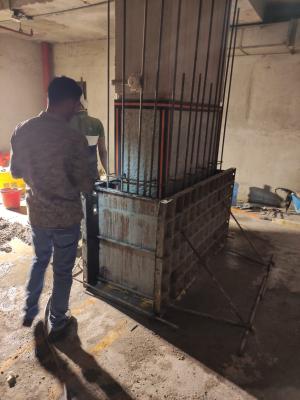

Basement-2-Column retrofitting on 8-02-23
Basement-2-Column retrofitting on 8-02-23
Work closed from 27-01-23 to 03-02-23
Labor Contractor claim for rate increasing

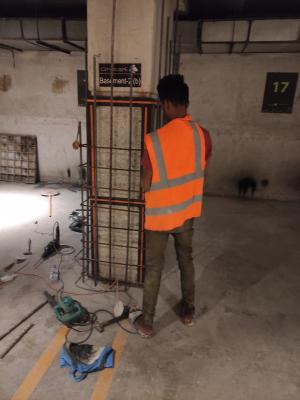

B-2 Col retrofit re-bar work on 15-02-23
B-2 Col retrofit curing on 15-02-23

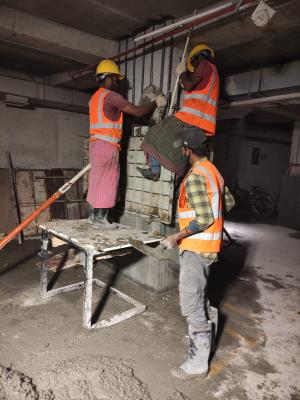

B-2-Col Re-bar work on 18-02-23
B2-Column Shuttering on 18-02-23
B-2 Col retrofit re-bar work on 20-02-23
B2-Col Retrofit re-bar work on 20-02-23

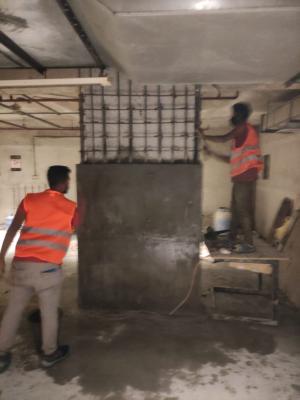

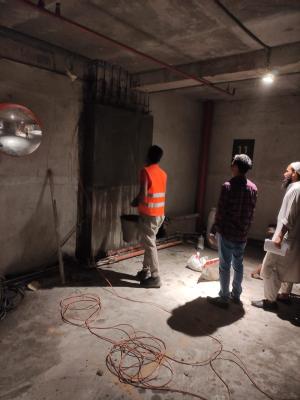

B-2 Col retrofit re-bar work on 22-02-23
B2-Col Retrofit re-bar work on 22-02-23

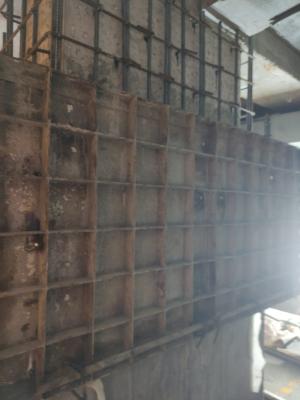

Retrofit-B-2 Column Shuttering on 27-02-23
Retrofit-B2-Column Concrete on 27-02-23

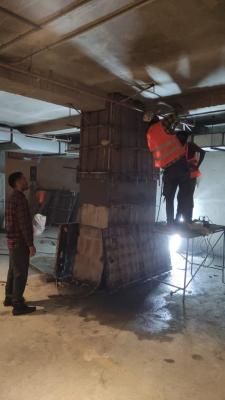

B-2-Column Retrofitting on 1-03-23
B-2-Column Retrofitting on 1-03-23

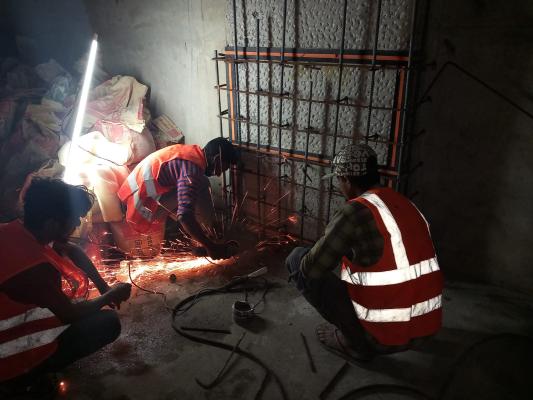

B-2-Col Re-bar work on 4-03-23
B2-Col Retrofit re-bar work on 4-03-23

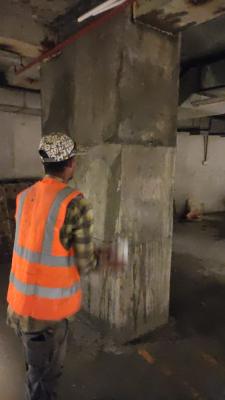

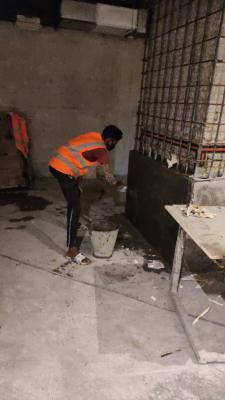

B-1-Column retrofit curing on 6-03-23
B-1-Column retrofit curing on 6-03-23

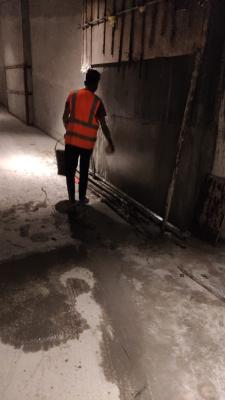

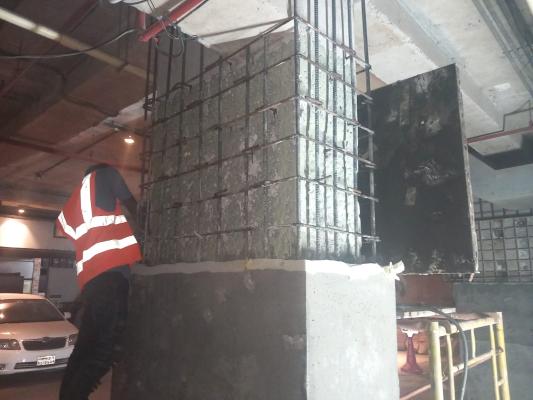

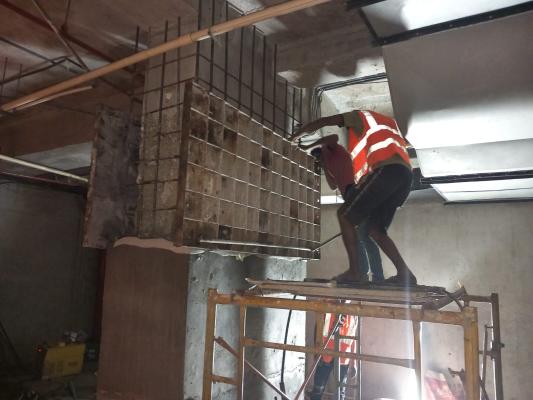

B-1-Column retrofit re-bar work on 9-03-23
B-1-Column retrofit shuttering on 9-03-23

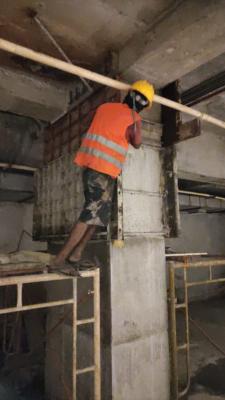

B-1-Column retrofit wo on 11-03-23
B-1-Column retrofit shuttering on 11-03-23

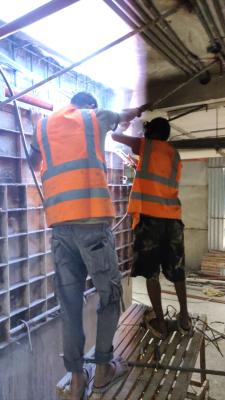

B-1-Column retrofit shuttering on 14-03-23
B-1-Column retrofit concreting on 14-03-23

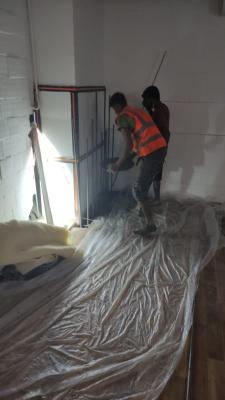

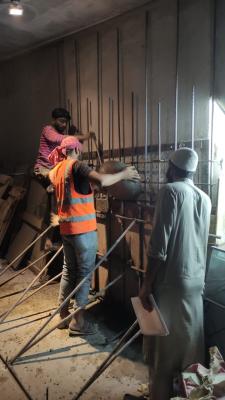

B-3-Column retrofit shuttering on 18-03-23
B-3-Column retrofit concreting on 18-03-23

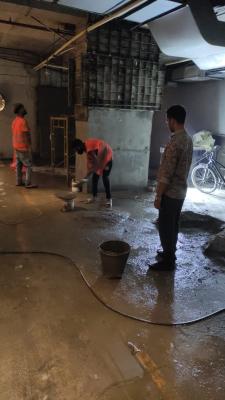

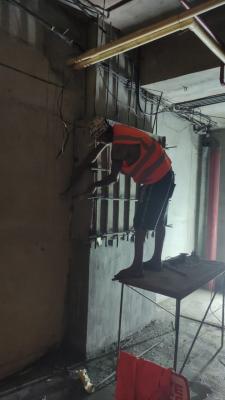

B-3-Column retrofit chipping on 20-03-23
B-3-Column retrofit chipping on 20-03-23

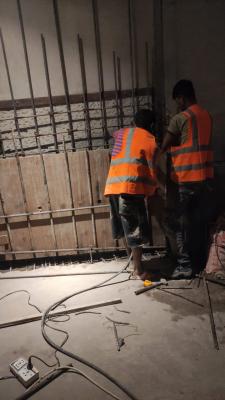

B-3-Column retrofit-shuttering on 22-03-23
B-3-Column retrofit concreting on 22-03-23

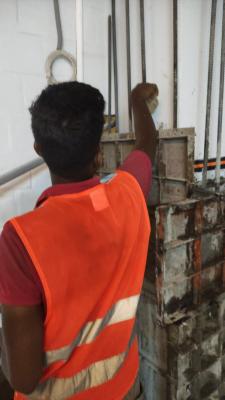

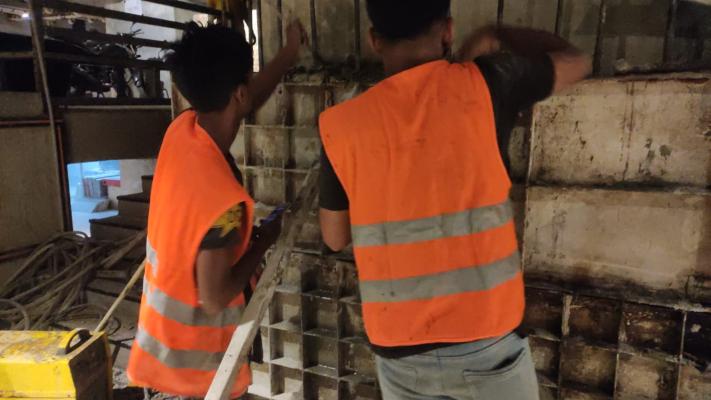

B-2-Column Retrofit shutter removing on 27-03-23
B-3-Column Retrofit Curing on 27-03-23
B-2 Column retrofit shuttering on 29-03-23

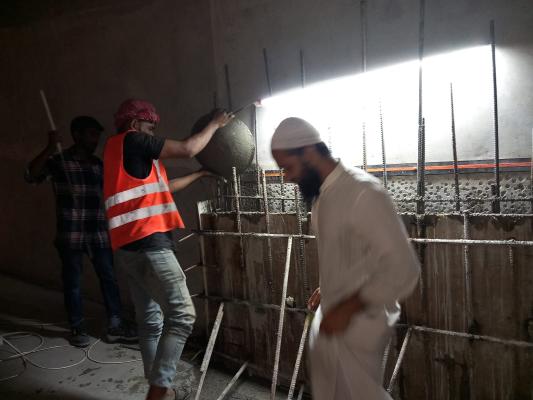

B-2-Column retrofit concreting on 29-03-23

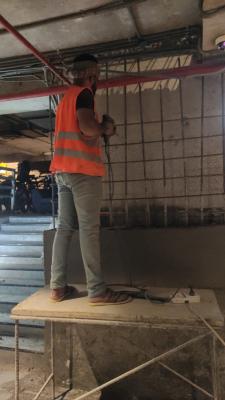

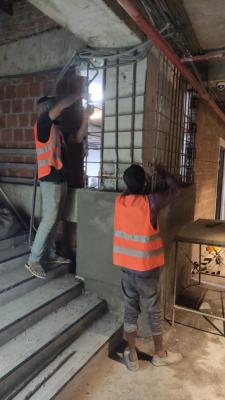

B-2-Column retrofit chipping on 30-03-23
B2-Col Retrofit re-bar work on 30-03-23

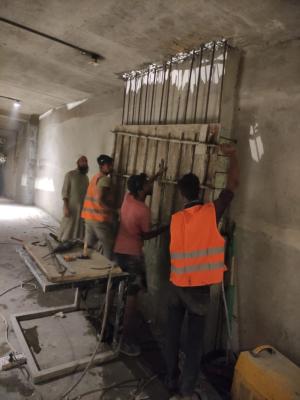

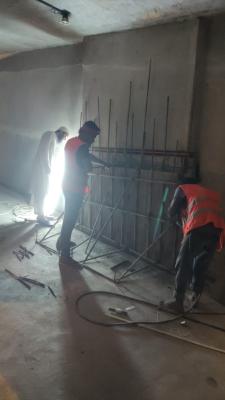

B-2-Column retrofit shuttering on 2-04-23

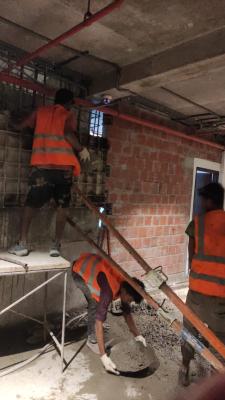

B2-Column retrofit concreting on 2-04-23

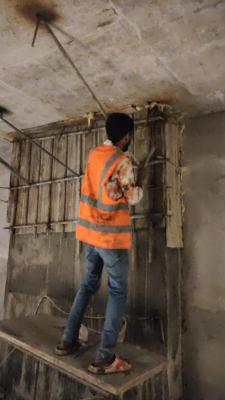

B2-Column retrofit shutter removing on 5-04-23
B-2-Column retrofit curing on 5-04-23

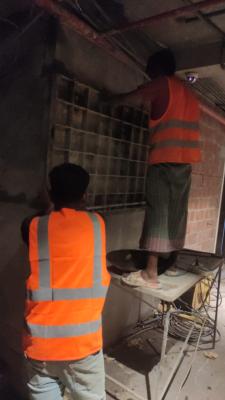

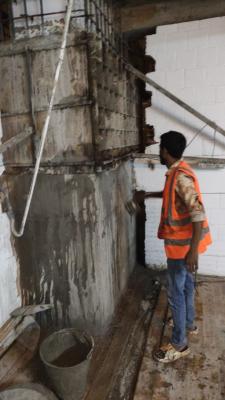

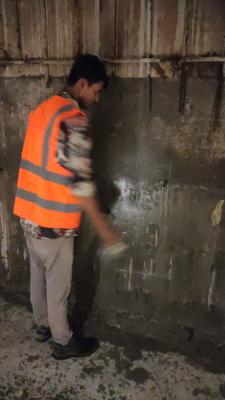

B2-Column Retrofit-Shutter removing on 9-04-23
B2-Column Retrofit-Curing on 9-04-23
