Total Duration: |
124 |
days |
Total Working Days: |
41 |
Total Manpower: |
6176 |
|
|
Planning Progress = 100% |
Acual Progress = 83.2% |
SPI: 0.83 |
Behind Schedule |
Progress as on: 31-May-2021
WBS |
Work Description |
Total Quantity |
Total Done |
Schedule Start
| Schedule Finish |
Actual Start |
Actual Finish |
Lead-Lag(day) |
Not Yet |
01.1 |
Take-over Site |
|
100% |
06-12-20 |
06-12-20 |
06-12-20 |
06-12-20 |
0 |
|
02.01 |
River-side Walkway-Side Wall |
835m |
100% |
07-12-20 |
04-02-21 |
27-01-21 |
05-02-21 |
-1 |
|
02.02 |
River-side Walkway-Filling |
835m |
100% |
10-12-20 |
07-02-21 |
27-01-21 |
05-02-21 |
2 |
|
02.03 |
River-side Walkway-Soling |
5007sqm |
100% |
13-12-20 |
10-02-21 |
27-01-21 |
05-02-21 |
5 |
|
02.04 |
River-side Walkway-CC |
5007sqm |
100% |
16-12-20 |
13-02-21 |
28-01-21 |
05-02-21 |
8 |
|
02.06 |
River-side Boundary-Bottom Beam |
835m |
100% |
07-12-20 |
04-02-21 |
27-01-21 |
01-02-21 |
3 |
|
02.07 |
River-side Boundary-Bot Column |
89nos |
100% |
08-12-20 |
05-02-21 |
27-01-21 |
01-02-21 |
4 |
|
02.08 |
River-side Boundary-Brick Work |
835m |
100% |
10-12-20 |
07-02-21 |
27-01-21 |
01-02-21 |
6 |
|
02.09 |
River-side Boundary-Top Beam |
835m |
100% |
12-12-20 |
09-02-21 |
27-01-21 |
01-02-21 |
8 |
|
02.10 |
River-side Boundary-Top Column |
89nos |
100% |
14-12-20 |
11-02-21 |
27-01-21 |
01-02-21 |
10 |
|
02.11 |
River-side Boundary-Grill |
835m |
95% |
21-12-20 |
18-02-21 |
05-02-21 |
08-02-21 |
10 |
Completed |
02.12 |
River-side Boundary-Column Capital |
89nos |
100% |
21-12-20 |
18-02-21 |
27-01-21 |
01-02-21 |
17 |
|
02.13 |
River-side Boundary-Bontile Texture |
835m |
95% |
28-12-20 |
25-02-21 |
28-01-21 |
03-04-21 |
-37 |
Completed |
02.14 |
River-side Boundary-Grill Enamel Pa |
835m |
95% |
14-02-21 |
28-02-21 |
08-02-21 |
08-03-21 |
-8 |
Completed |
03.01 |
40ft Road-Layout |
|
100% |
12-12-20 |
18-12-20 |
18-12-20 |
18-12-20 |
0 |
|
03.02 |
40ft Road-Filling Work |
|
100% |
19-12-20 |
25-02-21 |
25-02-21 |
25-02-21 |
0 |
|
03.03 |
40 feet Road Levelling and Dressing |
886m |
18% |
26-02-21 |
11-03-21 |
10-02-21 |
31-03-21 |
-20 |
Completed |
04.01 |
12 ft Inner Road-Filling |
m |
80% |
20-12-20 |
12-02-21 |
05-02-21 |
28-02-21 |
-16 |
Completed |
04.02 |
12 Ft Inner Road-Soling |
sqm |
60% |
21-12-20 |
13-02-21 |
27-01-21 |
08-02-21 |
5 |
Completed |
04.03 |
12 ft Inner Road-CC |
sqm |
60% |
22-12-20 |
14-02-21 |
05-02-21 |
08-02-21 |
6 |
Completed |
05.01 |
Outside Plaster-Building-B |
|
10% |
26-01-21 |
25-02-21 |
27-01-21 |
29-01-21 |
27 |
Completed |
05.06 |
Outside Plaster-Building-J |
|
60% |
11-01-21 |
09-02-21 |

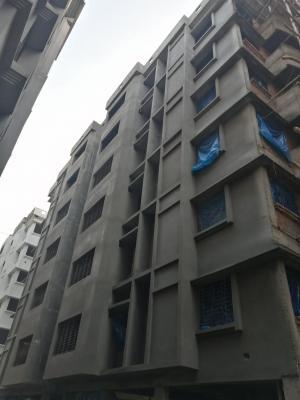

28-01-21 |
28-01-21 |
12 |
Completed |
05.09 |
Outside Plaster-Building-M |
|
60% |
11-01-21 |
09-02-21 |
01-02-21 |
01-02-21 |
8 |
Completed |
05.10 |
Outside Plaster-Building-N |
|
86% |
11-01-21 |
09-02-21 |
29-01-21 |
31-05-21 |
-111 |
Completed |
05.11 |
Outside Plaster-Building-Q |
|
91% |
18-01-21 |
16-02-21 |
29-01-21 |
09-05-21 |
-82 |
Completed |
05.12 |
Outside Plaster-Building-R |
|
95% |
18-01-21 |
16-02-21 |
29-01-21 |
01-05-21 |
-74 |
Completed |
06.01.1 |
Mock-up Flat-GF-Brick Flat Soling |
|
100% |
01-01-21 |
05-01-21 |
05-01-21 |
05-01-21 |
0 |
|
06.01.2 |
Mock-up Flat-Ground Floor-CC |
|
100% |
03-01-21 |
07-01-21 |
07-01-21 |
07-01-21 |
0 |
|
06.02 |
Mock-up Flat-Dismantling Work |
|
100% |
01-01-21 |
21-01-21 |
27-01-21 |
27-01-21 |
-6 |
|
06.03 |
Mock-up Flat-Const Joint & Extensn |
|
100% |
27-01-21 |
31-01-21 |
29-01-21 |
05-02-21 |
-5 |
|
06.04.1 |
Mock-up Flat-Brick Work |
|
95% |
17-01-21 |
31-01-21 |
29-01-21 |
05-02-21 |
-5 |
Completed |
06.04.2 |
Mock-up Flat-Plaster |
|
87% |
07-01-21 |
10-02-21 |
18-02-21 |
25-02-21 |
-15 |
Completed |
06.06.2 |
Mock-up Flat-Elect Conceal |
|
85% |
15-01-21 |
31-01-21 |
29-01-21 |
08-02-21 |
-8 |
Completed |
07.01 |
New Mosque-Pile Work |
|
100% |
07-12-20 |
31-12-20 |
31-12-20 |
31-12-20 |
0 |
|
07.02 |
New Mosque-Excavation n Pile head b |
|
100% |
23-12-20 |
31-01-21 |
31-01-21 |
31-01-21 |
0 |
|
07.03 |
New Mosque-Mat |
790m2 |
100% |
20-01-21 |
08-02-21 |
08-02-21 |
08-02-21 |
0 |
|
07.04.1 |
Mosque-Basement-RW,Column, Stair |
|
100% |
09-02-21 |
09-03-21 |
09-03-21 |
09-03-21 |
0 |
|
07.04.2 |
Mosque-Ground Floor Slab |
790m2 |
100% |
10-03-21 |
21-03-21 |
21-03-21 |
21-03-21 |
0 |
|
07.04.3 |
Mosque-Basement-Plaster Work |
|
5% |
10-04-21 |
09-05-21 |
14-04-21 |
14-04-21 |
25 |
Completed |

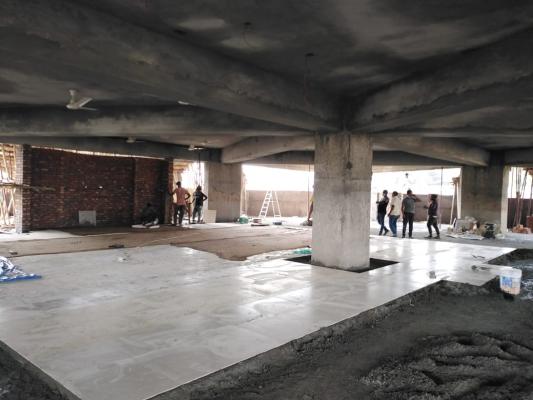

07.04.4 |
Mosque-Basement Tile work |
790m2 |
52% |
10-04-21 |
19-04-21 |
11-04-21 |
31-05-21 |
-42 |
Completed |
07.04.5 |
Mosque-Basement-Ancillary Works |
|
30% |
16-04-21 |
25-05-21 |
16-04-21 |
04-05-21 |
21 |
Completed |
07.05.1 |
Mosque-Ground Floor-Column |
|
100% |
22-03-21 |
02-04-21 |
24-03-21 |
28-03-21 |
5 |
|
07.05.2 |
Mosque-Ground Floor-Roof Slab |
790m2 |
100% |
03-04-21 |
09-04-21 |
27-03-21 |
06-04-21 |
3 |
|
07.05.3 |
Mosque-Ground Floor-Stair |
6nos |
83% |
22-03-21 |
15-04-21 |
25-03-21 |
11-04-21 |
4 |
Completed |
07.05.4 |
Mosque-Ground Floor-Ancillary works |
|
30% |
16-04-21 |
25-05-21 |
14-04-21 |
31-05-21 |
-6 |
Completed |
07.06.1 |
Mosque- 20ft Connecting Road-Fillin |
|
5% |
01-04-21 |
14-04-21 |
31-03-21 |
31-03-21 |
14 |
Completed |
07.07.1 |
Mosque-1st Floor-Column |
|
15% |
10-04-21 |
21-04-21 |
18-04-21 |
24-04-21 |
-3 |
Completed |
08.1 |
Landing Station-Excavation |
|
5% |
22-05-21 |
04-06-21 |
22-05-21 |
22-05-21 |
13 |
|
Site Photographs |
|

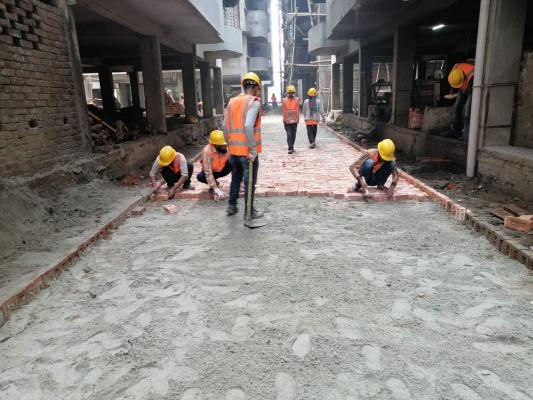

Inner Road CC Work on 27-01-21 |
|

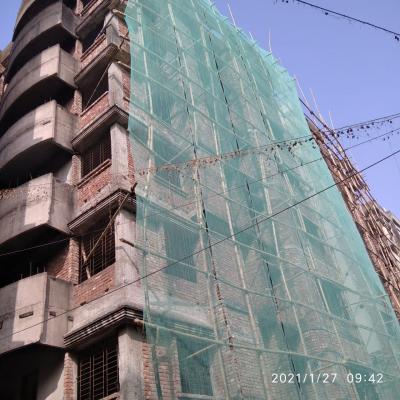

Scaffoloding for Outside Plaster-Buildin on 27-01-21 |
|
|
|
Building-J outside plastering on 28-01-21 |
|
Riverside walkway CC work on 28-01-21 |
|
|
|

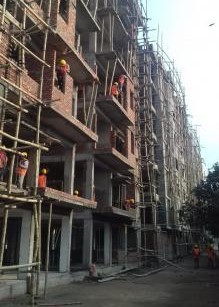

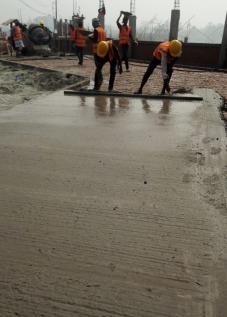

Building- outside plastering on 29-01-21 |
|
Scaffolding for outside plastering Build on 29-01-21 |
|
|
|
Riverside Bontile Rectification & Lighti on 1-02-21 |
|
Lanscape Lighting on 1-02-21 |
|
|
|

Boundary Grill Painting on 5-02-21 |
|

Out-side Plaster Work on 5-02-21 |
|
|
|

Riverside Boundary Fencing on 8-02-21 |
|
Building Outside Painting on 8-02-21 |
|
|
|

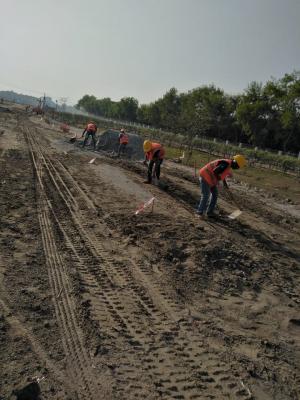

40 ft Road Levelling and dressing on 10-02-21 |
|
River Side Boundary Fencing on 10-02-21 |
|
|
|
on 18-02-21 |
|
on 18-02-21 |
Project was closed 11-17 Feb 2021 due to Honourable Z.H. Sikder death |
|
|

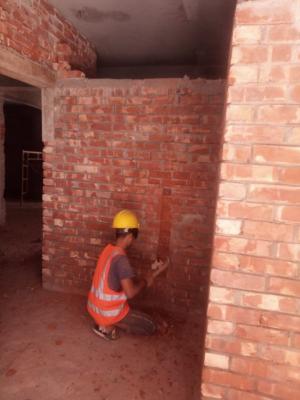

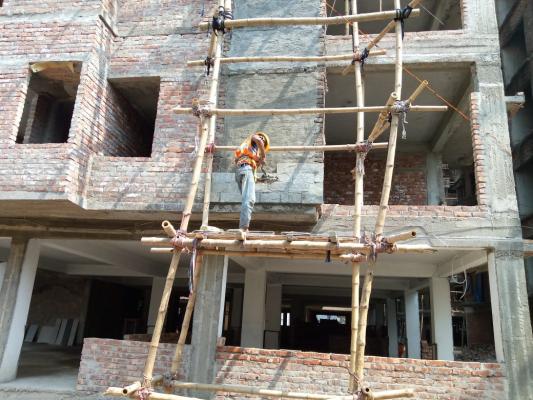

Mock-up-Exterior Sand Stone Fixing on 25-02-21 |
|
Electrical Conduit Consealing on 25-02-21 |
|
|
|

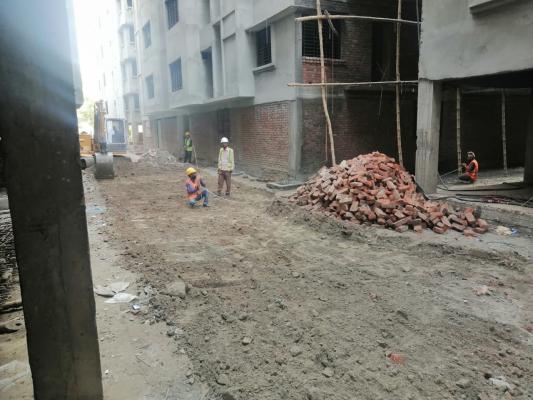

40 ft Road Dressing and Levelling on 28-02-21 |
|
12 ft Road Filling on 28-02-21 |
|
|
|
40 ft Road Dressing and Levelling on 1-03-21 |
|

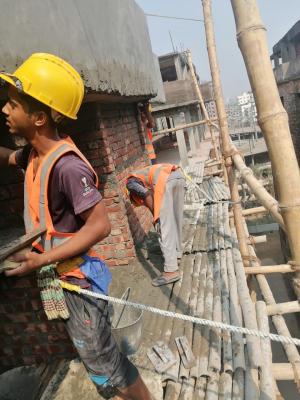

Building Outside Plastering on 1-03-21 |
|
|
|

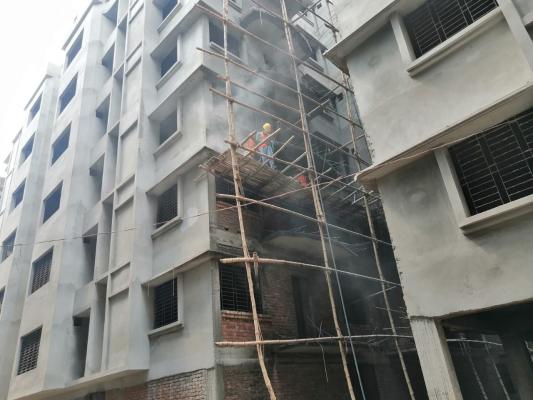

Building Outside Plastering on 8-03-21 |
|

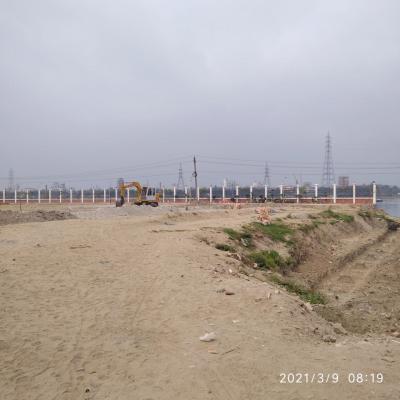

Riverside Boundary Fencing on 8-03-21 |
|
|
|

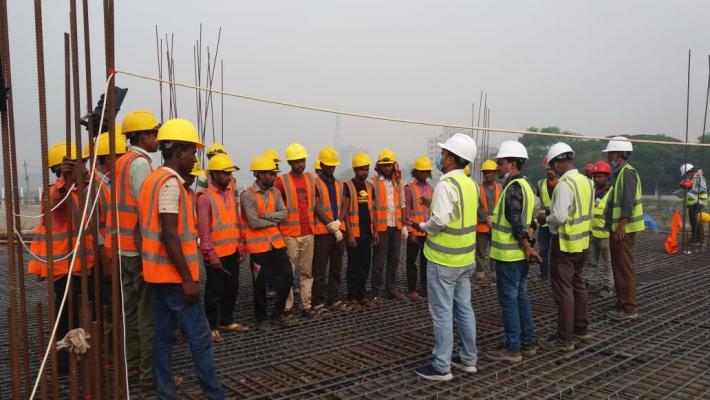

Breifing instruction before Concreting on 21-03-21 |
|

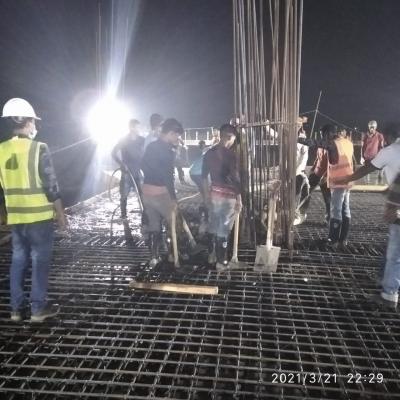

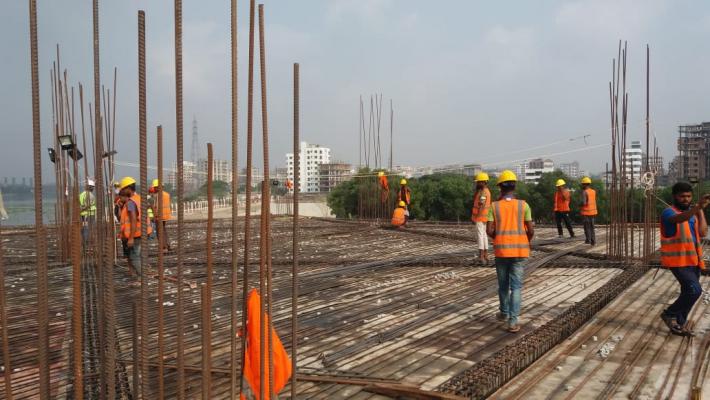

Mosque Ground Floor Slab Concreting on 21-03-21 |
|
|
|
Cityscape Security Training on 24-03-21 |
|

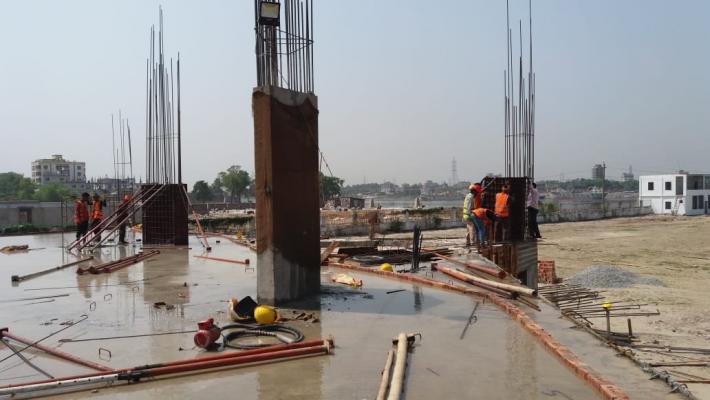

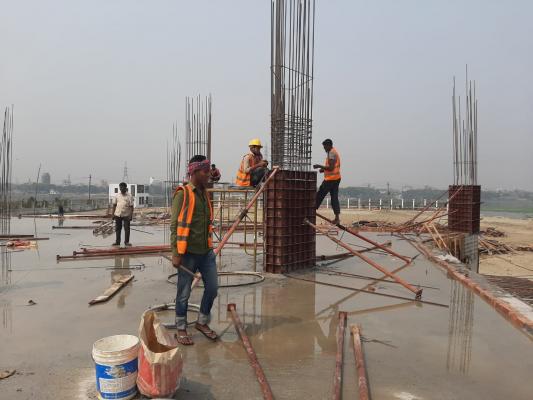

Mosque GF Column 2nd Lift Re-bar Work on 24-03-21 |
|
|
|
Mosque-GF Column Work on 25-03-21 |
|

Mosque-GF-Stair Case Foundation Work on 25-03-21 |
|
|
|

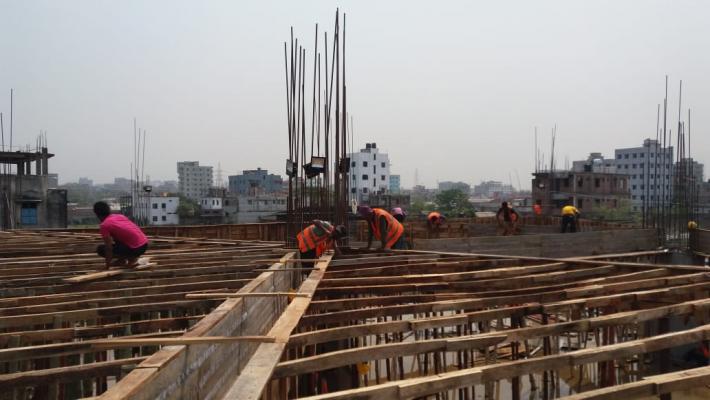

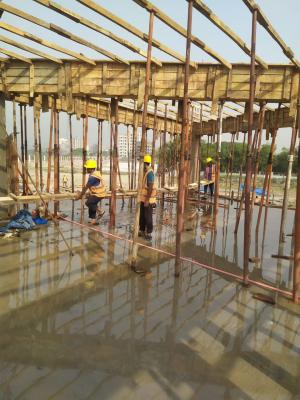

Mosque 1st Floor Slab Shuttering on 27-03-21 |
|

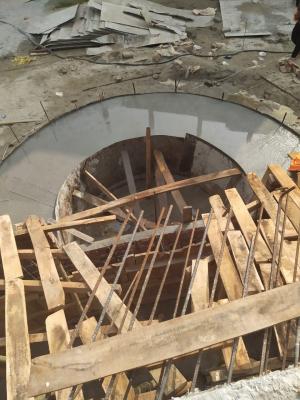

Mosque Ground Floor Stair Concreting on 27-03-21 |
|
|
|
Mosque 1st Floor Slab Shuttering on 28-03-21 |
|
Mosque Ground Floor Stair Concreting on 28-03-21 |
|
|
|

Mosque-20ft Connecting Road-Filling on 31-03-21 |
|

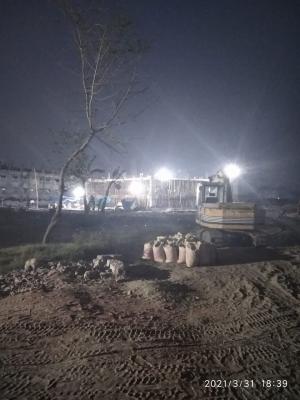

Mosque-Night Shift Work on 31-03-21 |
|
|
|

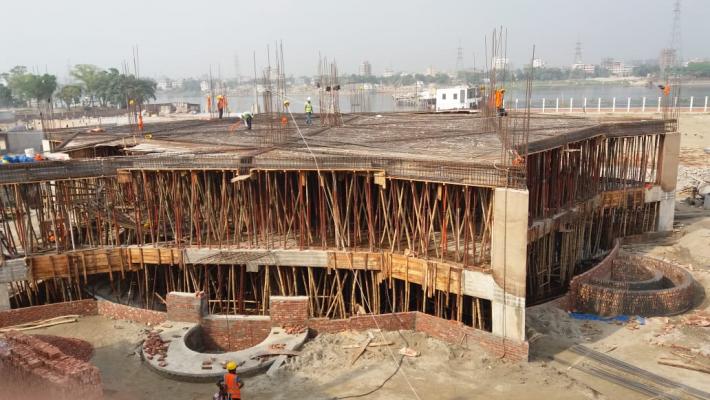

Mosque 1st Floor Slab Re-bar Work on 3-04-21 |
|
Mosque Building in Construction on 3-04-21 |
|
|
|

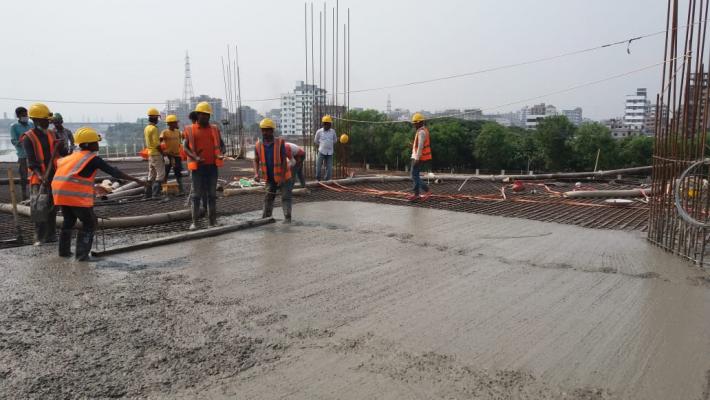

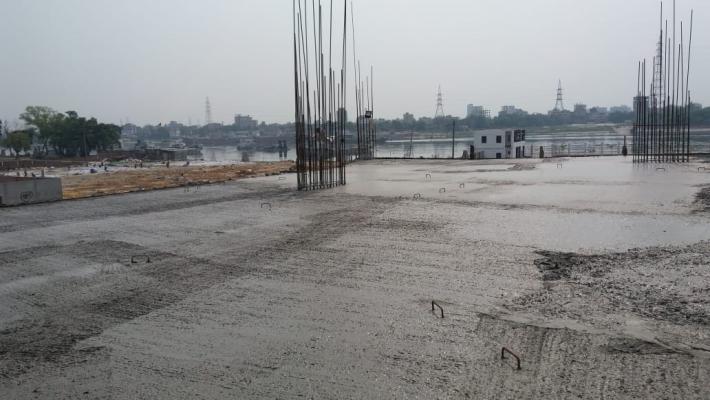

Mosque 1st Floor Slab Concreting on 6-04-21 |
|
Mosque 1st Floor Slab Concreting on 6-04-21 |
|
|
|

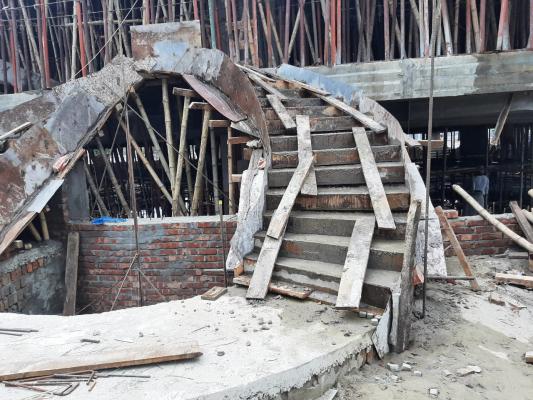

Mosque-Esatside Stair Case on 11-04-21 |
|
Mosque-Basement Tiles Work on 11-04-21 |
|
|
|

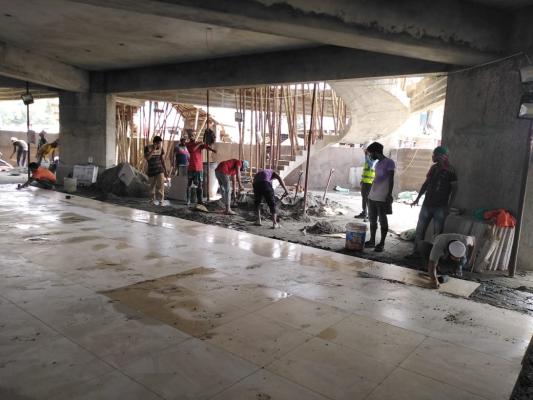

on 12-04-21 |
|

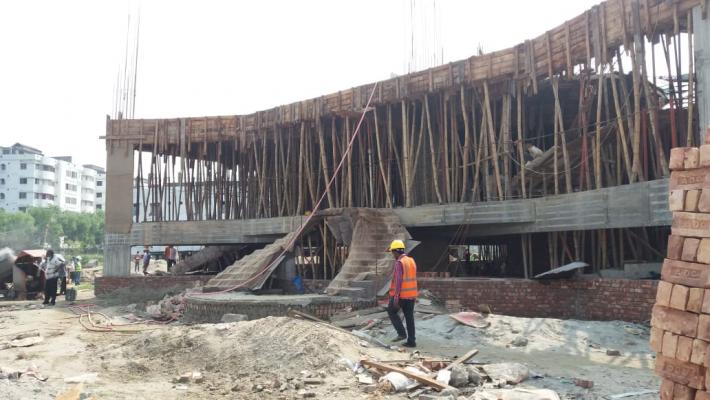

Mosque-Basement-Tile Work on 12-04-21 |
|
|
|

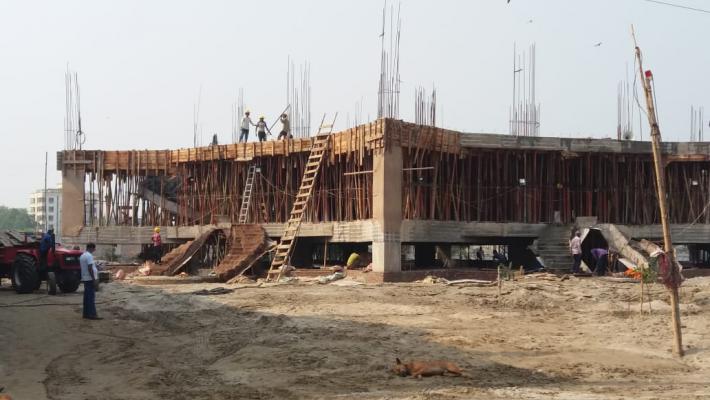

Mosque under Construction on 13-04-21 |
|
Mosque-Basement-Tile Work on 13-04-21 |
|
|
|

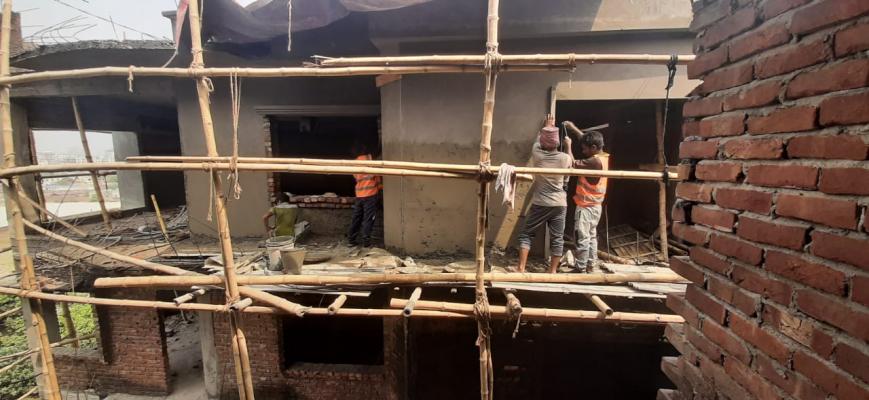

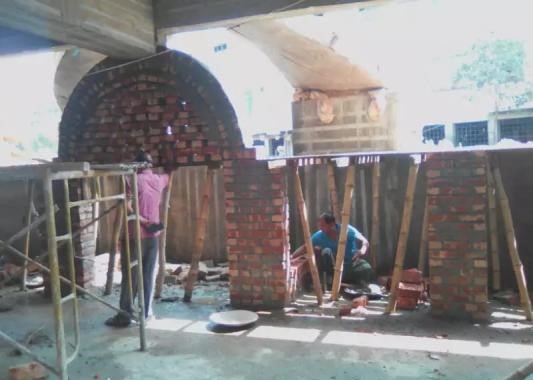

Mosque-Basment Plaster Work on 14-04-21 |
|
Mosque-Ground Floor Ancilary Works on 14-04-21 |
|
|
|

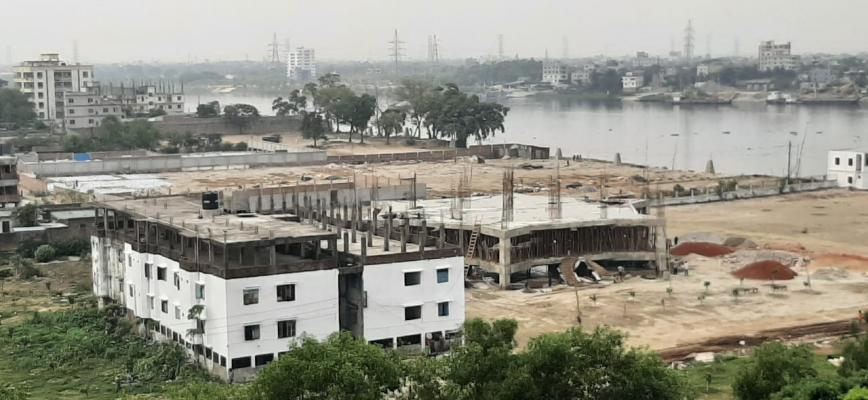

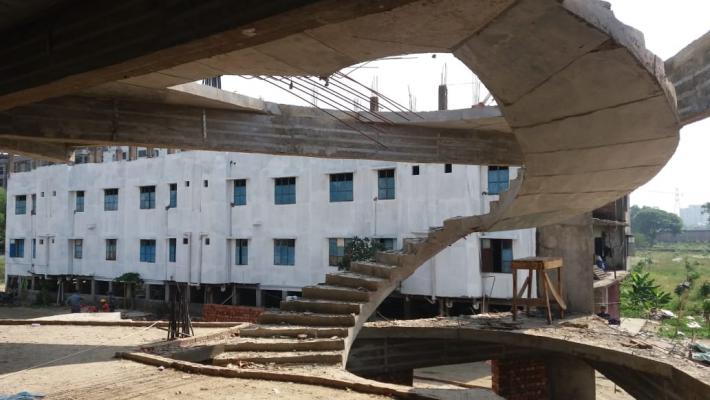

Out-side Plastering on 15-04-21 |
|
Mosque in Construction on 15-04-21 |
|
|
|

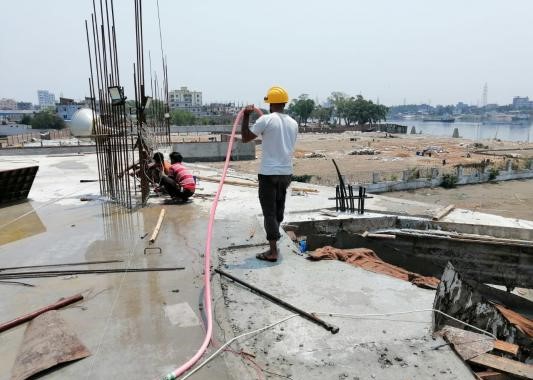

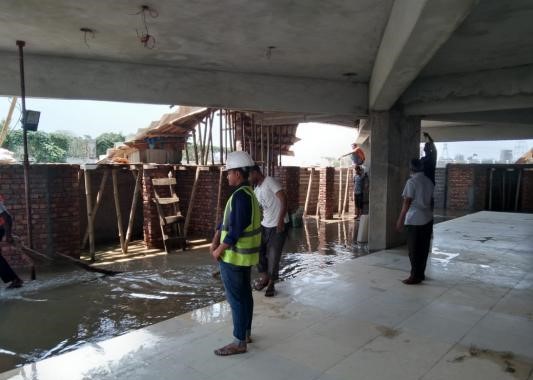

Mosque-Basement-Tile Work on 16-04-21 |
|
Mosque-Basement-Ancliary Work on 16-04-21 |
|
|
|
Out-side Plastering on 17-04-21 |
|
Mosque-Basement-Ancliary Work on 17-04-21 |
|
|
|

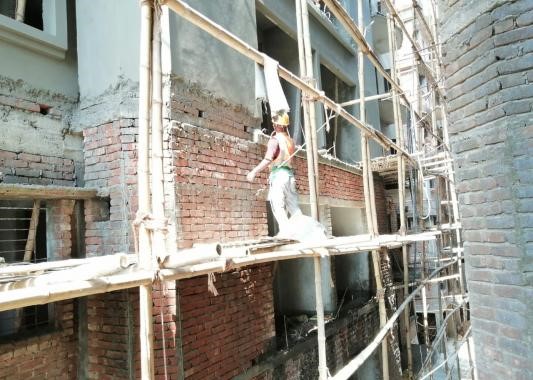

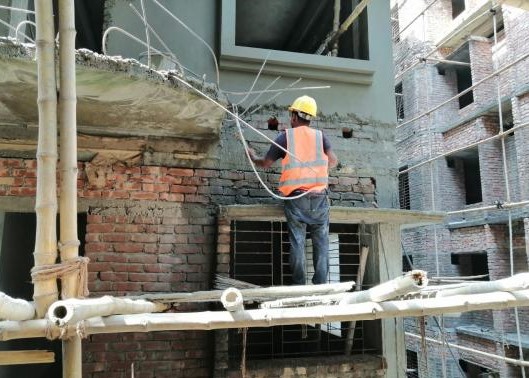

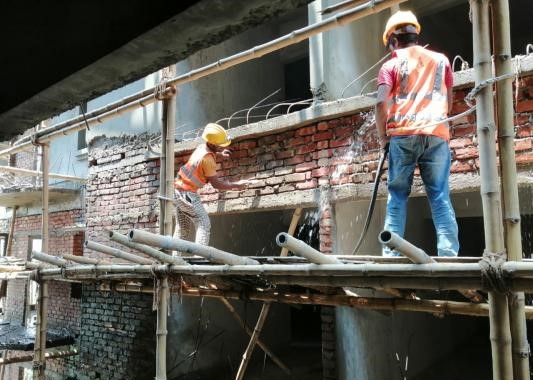

Out-side Plastering on 19-04-21 |
|

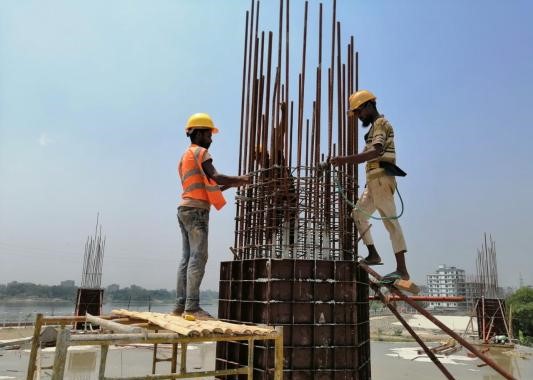

Mosque-1st Floor Column Re-bar Work on 19-04-21 |
|
|
|
Out-side Plastering on 20-04-21 |
|

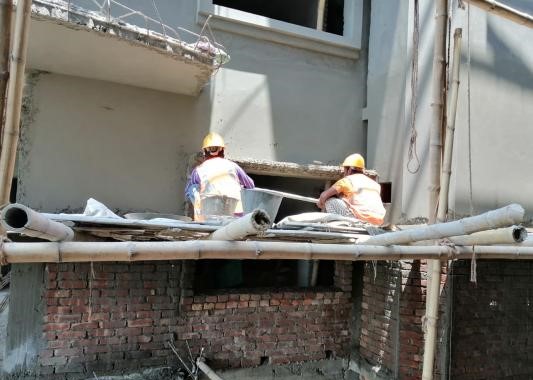

Out-side Plaster Work on 20-04-21 |
|
|
|

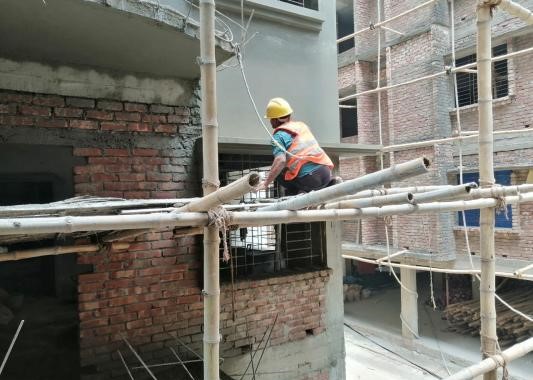

Out-side Plastering on 22-04-21 |
|

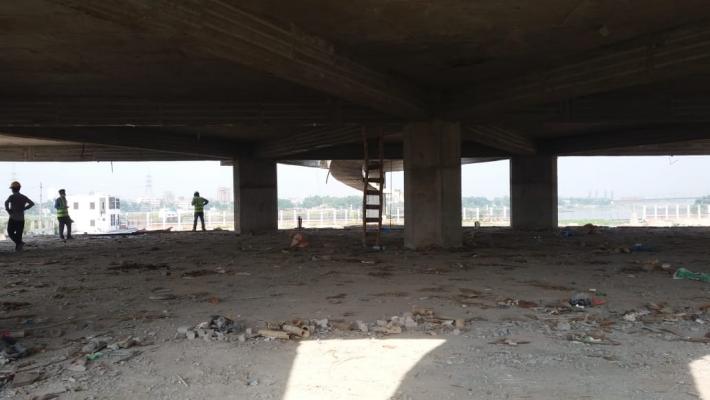

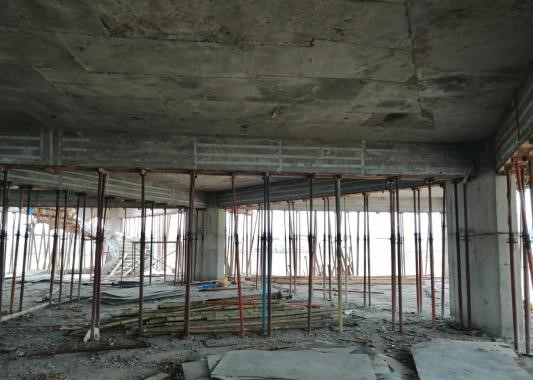

Mosque-Ground Floor-Roof Slab de-shutter on 22-04-21 |
|
|
|
Mosque-Gr.Floor Roof De-shuttering on 24-04-21 |
|

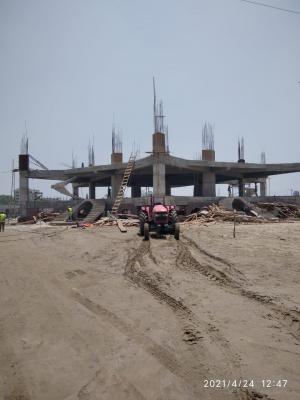

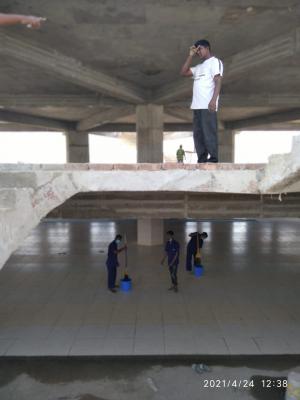

Mosque Building in Construction on 24-04-21 |
|
|
|
Mosque-Stair Case on 25-04-21 |
|
1st Floor Roof-De-shuttering on 25-04-21 |
|
|
|

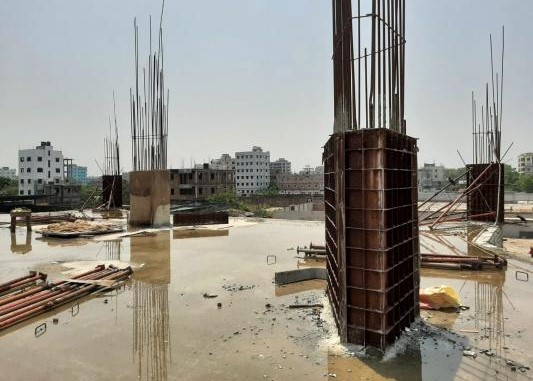

Mosque-1st Floor-Column Shuttering on 26-04-21 |
|
Mosque-Basement-Ancliary Work on 26-04-21 |
|
|
|

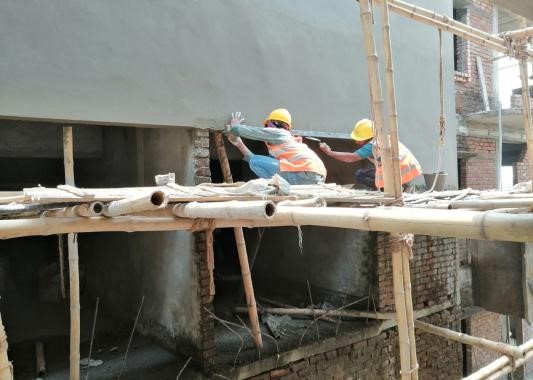

Out-side Plastering on 28-04-21 |
|

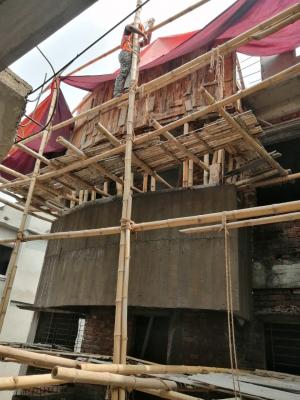

Drop Wall Shuttering on 28-04-21 |
|
|
|
Drop Wall Shuttering on 1-05-21 |
|
Out-side Plaster Work on 1-05-21 |
|
|
|
Out-side Plastering on 2-05-21 |
|
Mosque-Gr./1st Floor-Ancillary Works on 2-05-21 |
|
|
|
Mosque-Gr/1st Floor-Anciliary works on 4-05-21 |
|
Out-side Plaster Work on 4-05-21 |
|
|
|
Bulding-Q-Out-side Plastering on 9-05-21 |
|
Bulding-Q-Out-side Plastering on 9-05-21 |
|
|
|
Landing Station-Excavation on 22-05-21 |
|
Landing Station-Excavation on 22-05-21 |
Project Closed 10-21 May due to Eid-ul Fitre Vacation |
|
|
on 30-05-21 |
|
on 30-05-21 |
|
|
|
Mosque-Basement-Tile Work on 31-05-21 |
|
Mosque-Ground Floor-Ancillary Works on 31-05-21 |
|
|
