TOTAL PROGRES REPORT

From 25-December-2019 to 31-January-2022
Project Code: 17 Name: Shimanto Conference Center
Client: Border Guard Bangladesh Contractor: Sarker Steel Ltd.
Progress as on: 31-January-2022
Total Duration: 768 days Total Working Days: 138 Total Manpower: 15479
Planning Progress = 99.6% Acual Progress = 92.6% SPI: 0.93 Behind Schedule
WBS Work Description
Total Quantity Total Done Schedule Start Schedule Finish Actual Start Actual Finish Lead-Lag(day) Not Yet
0.03 Mobilization 0 100% 19-12-19 25-12-19 25-12-19 25-12-19 0
0.04 Fencing 627m2 100% 24-12-19 07-01-20 07-01-20 07-01-20 0
0.05 Layout 2021m2 100% 09-12-19 22-12-19 26-12-19 26-12-19 -4
0.06 Design and Drawing 0 100% 09-12-19 26-04-20 26-04-20 26-04-20 0
0.07 Tree Cutting 0 100% 21-12-19 09-01-20 09-01-20 09-01-20 0
0.08.1.1 Excavation for Mat 6733m3 100% 03-01-20 21-04-20 21-04-20 21-04-20 0
0.08.1.2 Level Fixing at Field 0 100% 10-01-20 19-03-20 19-03-20 19-03-20 0
0.08.1.3 Layout for Foundation 0 100% 18-04-20 19-04-20 19-04-20 19-04-20 0
0.08.1.4 Footing 0 100% 24-03-20 26-04-20 26-04-20 16-12-21 -599
0.08.1.5 Mat Foundation 0 100% 31-03-20 22-06-20 10-06-20 22-06-20 0
0.08.1.6 Basement 2000m2 100% 23-05-20 19-07-20 03-07-20 27-10-20 -100

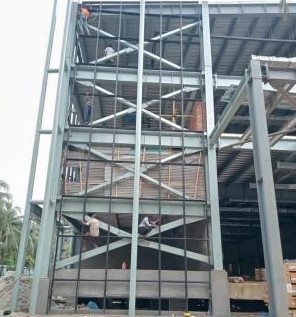

0.09.6 Steel Frame Erection 4stor 100% 28-11-20 02-02-21 15-12-20 16-02-21 -14
0.09.7 Decking Slab Installation 4stor 100% 03-02-21 20-03-21 22-03-21 05-04-21 -16
1.1.1.1 Fire Tank-Excavation 874m3 100% 01-05-21 18-08-21 11-05-21 15-10-21 -58
1.1.1.2 Fire Tank-CC 210m2 100% 21-05-21 20-08-21 10-09-21 12-10-21 -53
1.1.1.3 Fire Tank-Base 210m2 100% 23-05-21 27-08-21 29-09-21 20-10-21 -54
1.1.1.4 Fire Tank-Wall 394m2 100% 30-05-21 15-09-21 01-10-21 16-11-21 -62
1.1.1.5 Fire Tank-Top Slab 210m2 100% 18-06-21 21-09-21 31-10-21 16-11-21 -56
1.1.2.1 Domestic Water Tank-Base 42m2 100% 01-05-21 05-05-21 01-05-21 03-05-21 2
1.1.2.2 Domestic Water Tank-Wall 52m2 100% 06-05-21 04-06-21 31-05-21 16-06-21 -12
1.1.2.3 Domestic Water Tank-Top Slab 42m2 100% 05-06-21 14-06-21 23-06-21 25-06-21 -11
1.1.3.1 Canopy-Base Excavation 10nos 100% 01-05-21 19-08-21 01-05-21 18-10-21 -60
1.1.3.2 Canopy-Base CC 10nos 100% 06-05-21 19-08-21 01-05-21 18-10-21 -60
1.1.3.3 Canopy-Base 10nos 100% 21-05-21 20-08-21 03-05-21 18-10-21 -59
1.1.3.4 Canopy-Short Column 10nos 100% 26-05-21 21-08-21 06-05-21 18-10-21 -58
1.1.3.5 Canopy-Anchor Bolt 10nos 100% 31-05-21 21-08-21 09-06-21 18-10-21 -58
1.1.3.6 Canopy-Grade Beam 184m 100% 05-06-21 26-08-21 02-06-21 19-10-21 -54
1.1.4.1 Stair Case-Ground Floor 4nos 100% 01-05-21 28-08-21 31-05-21 24-10-21 -57
1.1.4.2 Stair-Ground Floor Mezzanine 4nos 100% 25-05-21 01-09-21 25-06-21 24-10-21 -53
1.1.4.3 Stair-1st Floor 4nos 100% 01-06-21 12-09-21 18-07-21 16-11-21 -65
1.1.5.1 Substation-Generator Room-Layout 100% 29-05-21 29-05-21 05-06-21 05-06-21 -7
1.1.5.10 Substation-Generator Room- Floor 180m2 100% 15-09-21 21-09-21 31-08-21 11-09-21 10
1.1.5.2 Substation-Generator Room-Excavatio 12nos 100% 30-05-21 03-06-21 07-06-21 18-07-21 -45
1.1.5.3 Substation-Generator Room-Footing 12nos 100% 01-06-21 05-06-21 16-06-21 18-07-21 -43
1.1.5.4 Substation-Generator Room-Padestal 12nos 100% 03-06-21 07-06-21 16-08-21 29-08-21 -83
1.1.5.5 Substation-Generator Room-GradBeam 84m 100% 08-06-21 10-08-21 01-08-21 29-08-21 -19
1.1.5.6 Substation-Generator Room-Column 12nos 100% 11-08-21 17-08-21 16-08-21 29-08-21 -12
1.1.5.7 Substation-Generator Room-Slab m2 100% 18-08-21 24-08-21 19-09-21 30-09-21 -37
1.1.5.8 Generator Foundation 1nos 100% 04-08-21 10-08-21 29-08-21 08-09-21 -29
1.1.5.9 Substation-Generator Room- Brickwor 100m3 100% 15-09-21 21-09-21 21-08-21 30-11-21 -70
1.1.6 Roof Slab 1785m2 100% 01-05-21 07-05-21 01-05-21 07-05-21 0
1.1.7 Gutter 100% 08-05-21 12-09-21 30-08-21 30-11-21 -79

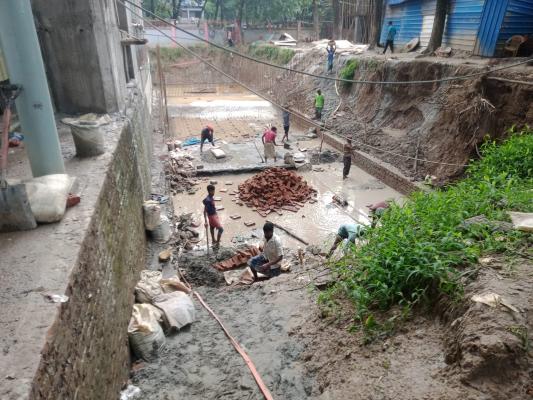

1.1.8.1 Septic Tank-Excavation 100% 12-09-21 18-09-21 12-09-21 21-09-21 -3
1.1.8.2 Septic Tank-CC Work 100% 19-09-21 21-09-21 15-09-21 20-09-21 1
1.1.8.3 Septic Tank-Wall 47m2 100% 22-09-21 28-09-21 20-09-21 14-10-21 -16
1.1.8.4 Septic Tank-Plaster with NCF 100% 29-09-21 01-10-21 31-10-21 31-10-21 -30
1.1.8.5 Septic Tank-Top Slab 100% 02-10-21 04-10-21 31-10-21 16-11-21 -43
1.2.2 ACP Supporting Pipe Installation 30nos 100% 02-06-21 21-06-21 25-05-21 01-07-21 -10
1.2.3.1 Steel Structure Painting-Gr.Floor 539m2 100% 01-05-21 18-08-21 23-06-21 16-11-21 -90
1.2.3.2 Steel Structure Painting-GF-Mezzani 1533m2 100% 23-05-21 21-08-21 23-06-21 12-12-21 -113
1.2.3.3 Steel Structure Painting-1st.Floor 101m2 100% 05-06-21 22-08-21 23-06-21 12-12-21 -112
1.2.3.4 Steel Structure Painting-1st Flr Me 1785m2 95% 18-06-21 04-09-21 18-07-21 15-12-21 Completed
1.3.1.1 Brick Work-Ground Floor 1340m2 100% 01-05-21 18-08-21 05-05-21 31-01-22 -166
1.3.1.2 Brick Work-GF Mezzanine 780m2 95% 28-05-21 18-08-21 16-06-21 12-12-21 Completed
1.3.1.3 Brick Work-1st Floor 1210m2 100% 28-05-21 04-09-21 18-08-21 31-01-22 -149
1.3.1.4 Brick Work-1st Floor Mezzananie 780m2 95% 28-05-21 04-09-21 22-08-21 12-12-21 Completed
1.3.2.1 Plaster Work-Basement 1785m2 100% 09-05-21 26-08-21 31-05-21 21-09-21 -26
1.3.2.2 Plaster-Ground Floor 2680m2 100% 09-05-21 20-08-21 27-06-21 31-01-22 -164
1.3.2.3 Plaster-Gr.Floor-Mezzanine 1560m2 95% 05-06-21 12-09-21 25-06-21 12-12-21 Completed
1.3.2.4 Plaster-1st Floor 2420m2 95% 29-08-21 12-09-21 20-08-21 31-01-22 Completed
1.3.2.5 Plaster-1st Floor Mezzanine 1560m2 95% 10-09-21 16-09-21 23-08-21 31-01-22 Completed
1.3.3 Tiles Work 70% 10-05-21 26-09-21 30-11-21 31-01-22 Completed
1.3.4.1 ACP-Shipment 2787m2 100% 01-05-21 06-05-21 05-05-21 05-05-21 1
1.3.4.2 ACP-Port Inspection 2787m2 100% 07-05-21 07-05-21 25-05-21 25-05-21 -18
1.3.4.3 ACP-Arrive at Site 2787m2 100% 08-05-21 10-05-21 20-07-21 20-07-21 -71
1.3.4.4 ACP-Fabrication n Installation 2787m2 88% 19-08-21 28-09-21 16-10-21 17-12-21 Completed
1.3.5.1 Painting-Exterior m2 93% 19-09-21 30-09-21 19-09-21 17-12-21 Completed
1.3.5.2 Painting-Interior-Basement 85% 03-10-21 18-10-21 03-10-21 14-12-21 Completed
1.4.1 Sanitary and Plumbing-Space Zero 0 50% 27-08-21 25-09-21 16-12-21 16-12-21 Completed
1.4.2 Internal Electrification 65% 07-05-21 30-06-21 30-11-21 15-12-21 Completed
1.4.3 Substation Temporary Line 100% 20-08-21 28-09-21 16-12-21 16-12-21 -79
1.4.4 Generator-Temporary Line 100% 20-08-21 28-09-21 16-12-21 16-12-21 -79
1.4.5.1 AC-Design Approval 100% 01-05-21 03-05-21 05-05-21 05-05-21 -2
1.4.5.2.1 AC-Duct-Material Approval 100% 04-05-21 04-05-21 05-05-21 05-05-21 -1

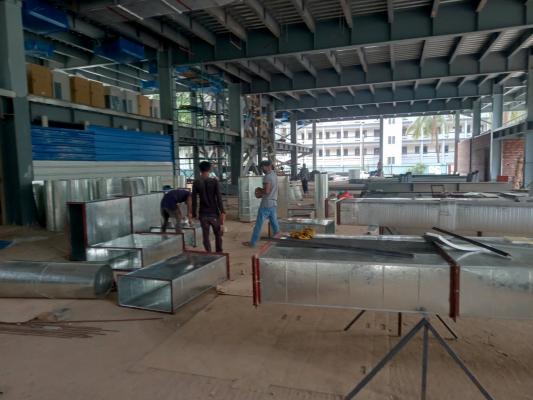

1.4.5.2.2 AC-Duct Fabrication 1771m2 98% 04-05-21 03-06-21 19-05-21 18-07-21 Completed
1.4.5.2.3 AC-Duct-Installation 1771m2 98% 21-05-21 10-06-21 22-05-21 18-07-21 Completed
1.4.5.3.1 AC-Copper Pipe-Marking, Hanging 2165m 98% 21-05-21 28-05-21 09-05-21 18-07-21 Completed
1.4.5.3.2 AC-Copper Pipe-Installation-Riser 98% 23-05-21 19-06-21 08-07-21 18-07-21 Completed
1.4.5.4 AC-Drain Pipe Work 98% 21-05-21 12-06-21 08-07-21 18-07-21 Completed
1.4.5.5 AC-Electrical-Comunication Cable 0 50% 06-08-21 14-09-21 16-12-21 16-12-21 Completed
1.4.5.6.1 AC-Indoor Unit mark, support hang 87nos 98% 03-05-21 10-05-21 05-05-21 18-07-21 Completed
1.4.5.6.2 AC-Indoor Unit Hanging, Installatio 87nos 98% 03-05-21 09-06-21 05-05-21 18-07-21 Completed
1.4.5.6.3 AC-Outdoor Unit Base Preparation 98% 04-05-21 10-05-21 08-07-21 08-07-21 Completed
1.4.5.6.4 AC-Outdoor Unit Installation 98% 21-05-21 22-05-21 18-07-21 18-07-21 Completed
1.4.5.7 AC- diffuser,Grill,Louver 0 50% 24-06-21 23-08-21 16-12-21 16-12-21 Completed
1.4.5.8 AC- commissioning-Handover 0 50% 23-08-21 15-10-21 16-12-21 16-12-21 Completed
2.1.1 Glass-Frame arrive at Site 1254m2 100% 01-05-21 09-05-21 09-05-21 12-10-21 -156

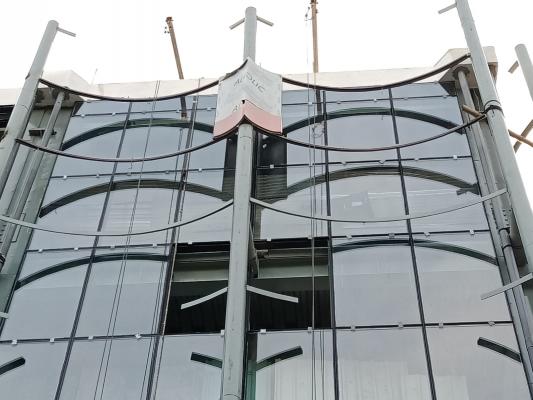

2.1.2 Glass-Frame Fixing 1254m2 88% 10-05-21 30-06-21 09-05-21 17-12-21 Completed
2.1.3 Glass-Measurement for Supply 1254m2 100% 01-07-21 03-07-21 18-07-21 12-12-21 -162
2.1.4 Glass-Arrive at site 1254m2 88% 03-09-21 05-09-21 03-08-21 17-12-21 Completed
2.1.5 Glass-Fixing 1254m2 88% 06-09-21 30-09-21 08-08-21 17-12-21 Completed
2.2 Louver Fixing 90% 07-09-21 06-10-21 31-10-21 15-12-21 Completed

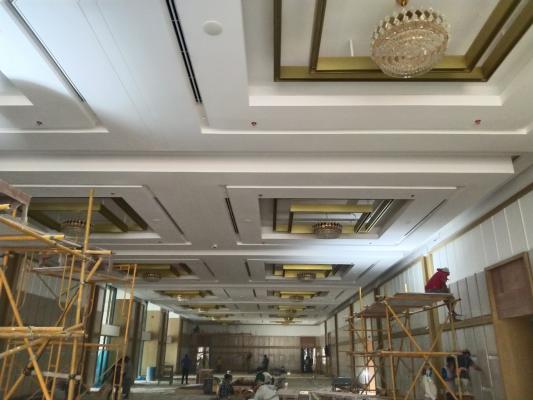

2.3.1.1 Interior-False Ceiling-GF 100% 09-09-21 08-10-21 09-09-21 05-01-22 -89
2.3.1.2 Interior-False Ceiling-1st Floor 0 70% 16-09-21 15-10-21 31-01-22 31-01-22 Completed
2.4 Stage 50% 31-08-21 30-10-21 17-12-21 17-12-21 Completed
2.5.1 Substation 25% 08-08-21 28-10-21 16-12-21 16-12-21 Completed
2.5.2 Generator 80% 15-09-21 27-10-21 16-12-21 31-01-22 Completed
2.5.3.1.1 RCC Lift Wall-Ground Floor 100% 28-06-21 23-08-21 30-06-21 04-10-21 -42
2.5.3.1.2 RCC Lift Wall-Gr.Floor Mezzanine 100% 23-08-21 04-09-21 29-08-21 04-10-21 -30

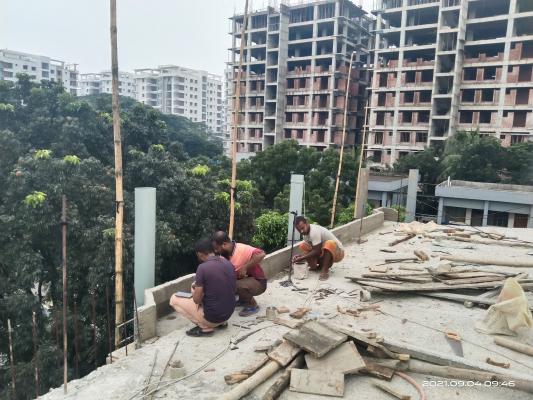

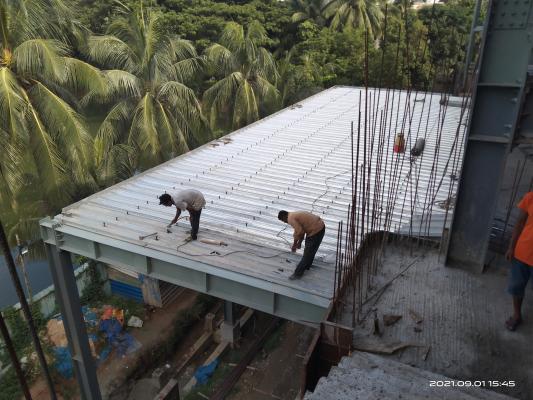

2.5.3.1.3 RCC Lift Wall-1st Floor 100% 04-09-21 16-09-21 01-09-21 04-10-21 -18
2.5.3.1.4 RCC Lift Wall-1st Floor Mezzanine 100% 16-09-21 28-09-21 04-09-21 04-10-21 -6
2.5.3.2 Lift-Shipment 100% 01-05-21 24-09-21 16-08-21 16-08-21 39
2.5.3.3 Lift-Port Inspection 100% 24-09-21 25-09-21 29-08-21 29-08-21 27
2.5.3.4 Lift-Receive at Site 100% 25-09-21 28-09-21 29-08-21 29-08-21 30
2.5.3.5 Lift-Installation 95% 28-09-21 30-10-21 04-10-21 16-12-21 Completed

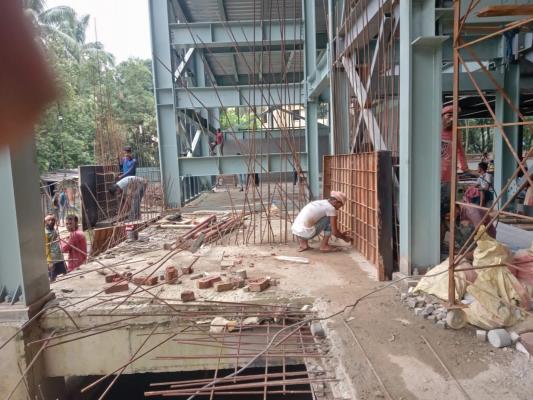

2.5.4.1 Fire-Local Material Receive 80% 11-08-21 05-09-21 19-08-21 12-12-21 Completed
2.5.4.2 Fire-Local Material Installation 60% 27-08-21 16-10-21 21-08-21 14-12-21 Completed
2.5.4.3 Fire-LC for Foreign Materials 50% 15-08-21 22-08-21 29-08-21 29-08-21 Completed
2.5.4.4 Fire-Shipment 50% 22-08-21 11-10-21 30-11-21 30-11-21 Completed
2.5.4.5 Fire-Port Inspection % 11-10-21 13-10-21 Started
2.5.4.6 Fire-Foreign Material Receive % 13-10-21 16-10-21 Started
2.5.4.7 Fire-Foreign Material Installation 0% 16-10-21 30-10-21 30-11--1 Started
2.7 Road and Landscaping 100% 10-08-21 18-10-21 25-09-21 05-01-22 -79

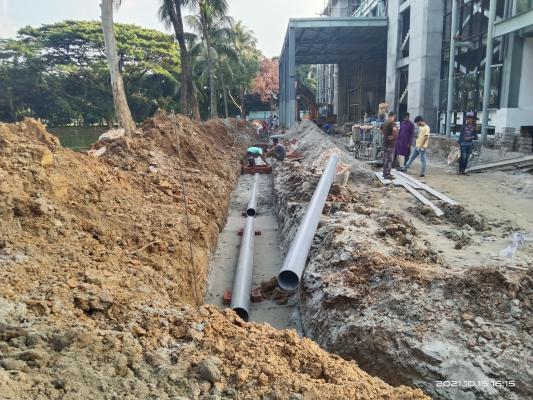

2.8 Outside Sanitary and Plumbing Work 100% 22-08-21 30-10-21 14-10-21 05-01-22 -67
3.1 Retrofitting-Design 100% 09-08-21 15-08-21 14-08-21 14-08-21 1

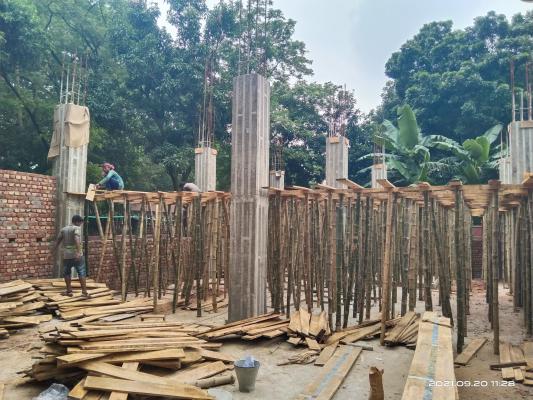

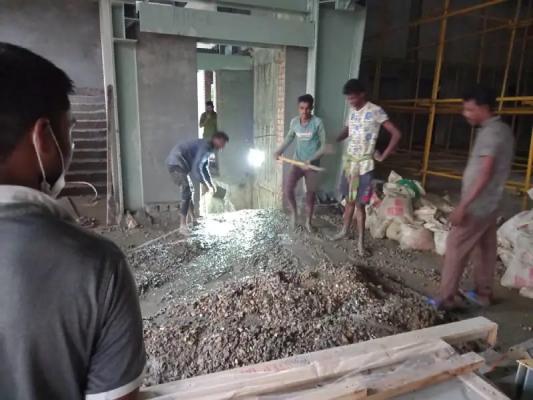

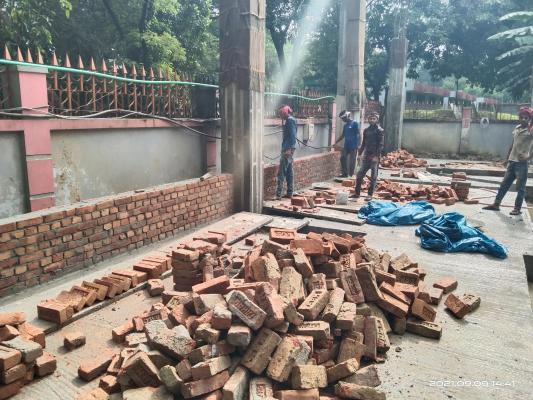

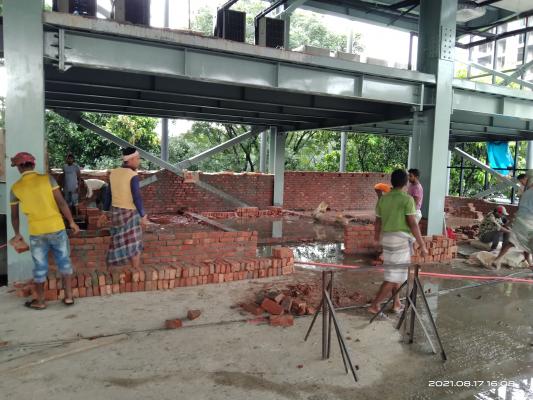

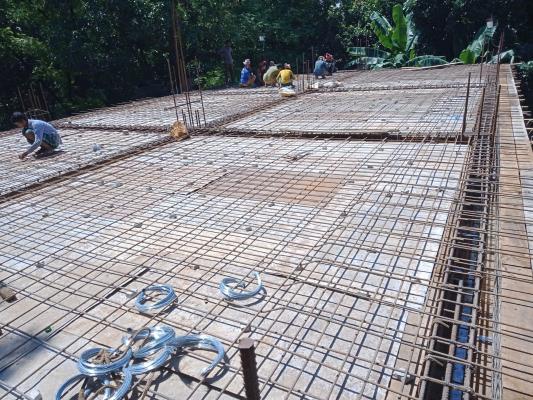

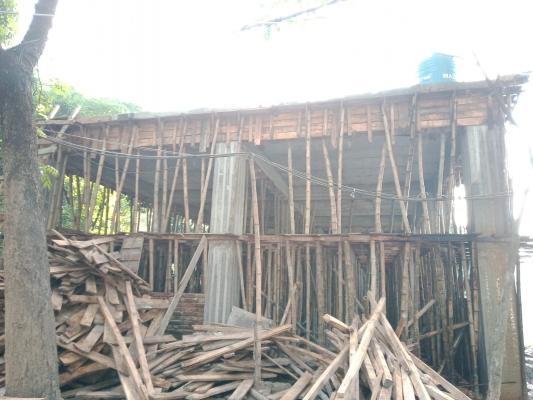

3.2 Retrofitting-Demolition 305m2 100% 16-08-21 14-09-21 17-08-21 05-09-21 9

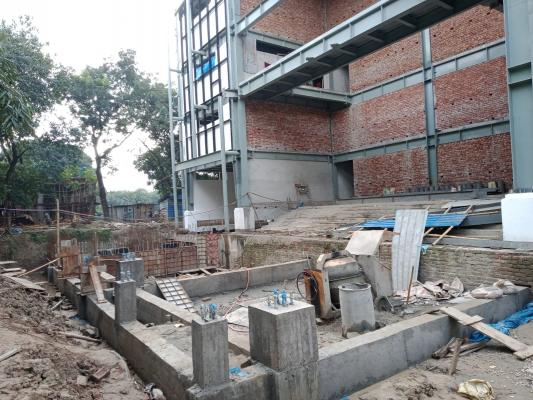

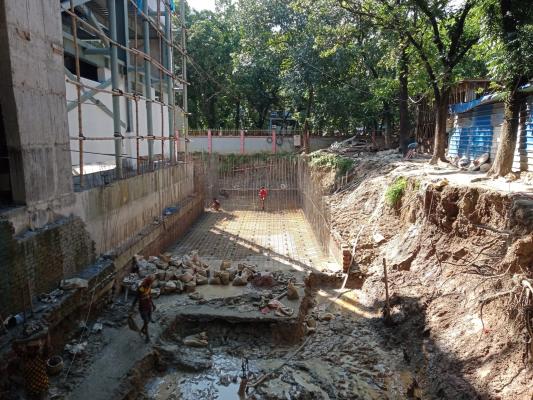

3.3 Retrofitting-Re-construction 100% 15-09-21 14-10-21 01-09-21 30-09-21 14
4 Handover % 31-10-21 31-10-21 Started

DAILY MANPOWER

CUMMULATIVE ACTUAL WORK PROGRESS

CUMMULATIVE PLAN WORK PROGRESS

CUMMULATIVE WORK PROGRESS

SCHEDULE AHEAD-BEHIND

Site Photographs
Material and Equipment mobilized on 25-12-19
Site Office Container mobilized on 25-12-19
Layout on 26-12-19
Layout approved by DG on 26-12-19
Fencing-Angle fixing on 7-01-20
Fencing-Sheet mobilized on 7-01-20
Marking Tree before cutting on 9-01-20
Tree cutting by Handsaw on 9-01-20
Drawing checking before Level fixing on 19-03-20
Level fixing at Field on 19-03-20
Layout for Footing on 19-04-20
Layout checked by Architect and DDG, BGB on 19-04-20
Excavation for Mat on 21-04-20
Excavation by Excavator on 21-04-20
Meeting at BGB Regarding Design-Drawing on 26-04-20
Footing Casting on 26-04-20
Tool Box Meeting on 10-06-20
Water Proofing Membrane Fixing on 10-06-20

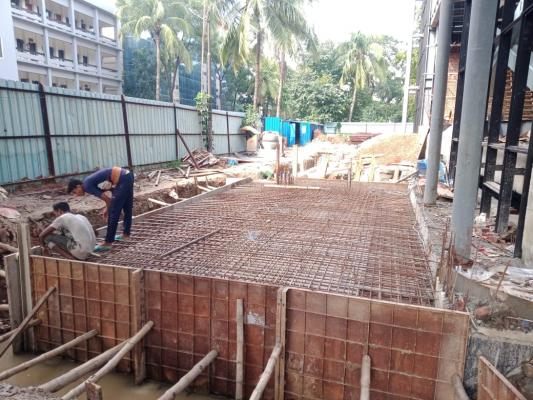

Consultant Checking before Concreting on 22-06-20
Mat Concreting on 22-06-20
Column Concreting on 3-07-20
Lift Core Wall concreting on 3-07-20
Retaining Wall Concreting on 29-07-20
Anchor Bolt Setting on 29-07-20
Ground Floor Slab Shuttering on 22-10-20
Consultant Shutter Checking before concr on 22-10-20
Consultant Re-bar checking before concre on 27-10-20

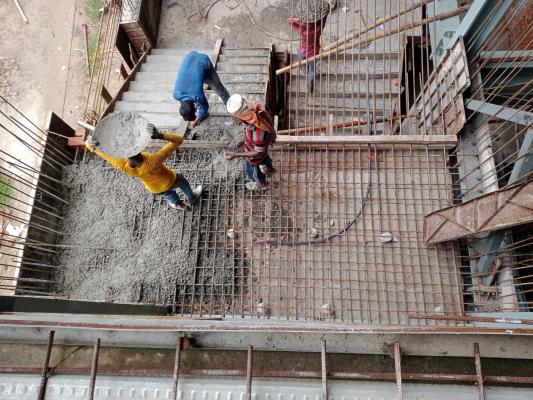

Ground Floor Slab Concreting on 27-10-20

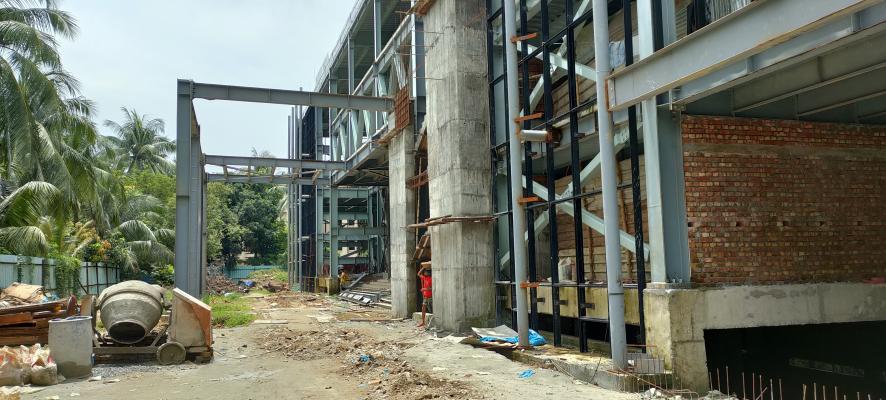

Steel Frame Installation on 15-12-20
steel Frame Installation on 15-12-20

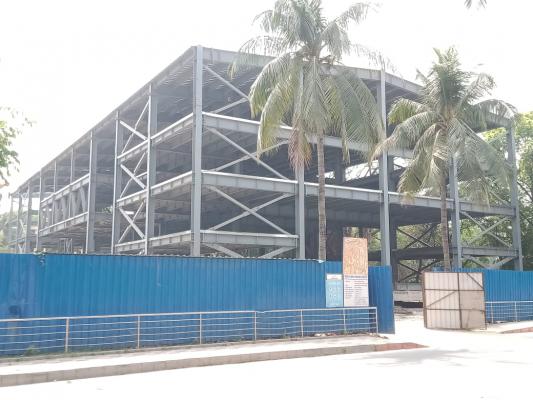

Decking Slab installation on 22-03-21
Decking Slab installation on 22-03-21

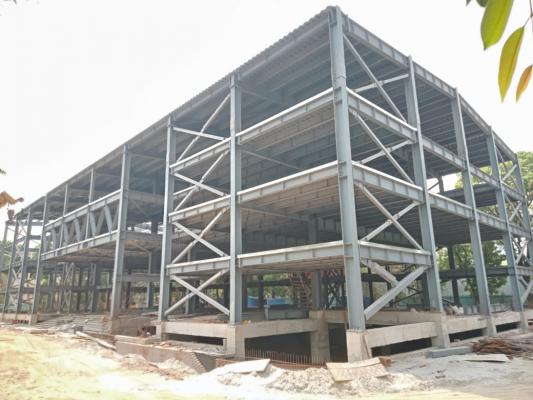

Decking Slab installation on 5-04-21

Roof Top Decking on 5-04-21

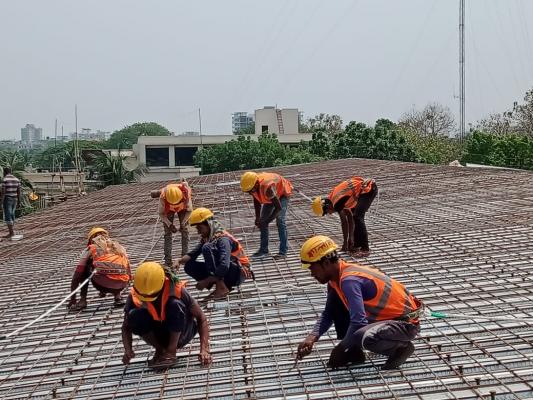

Roof Slab Re-bar Work on 1-05-21
Domestic Water Tank Re-bar work on 1-05-21

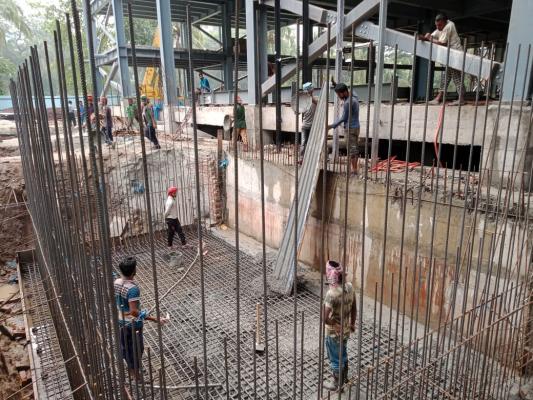

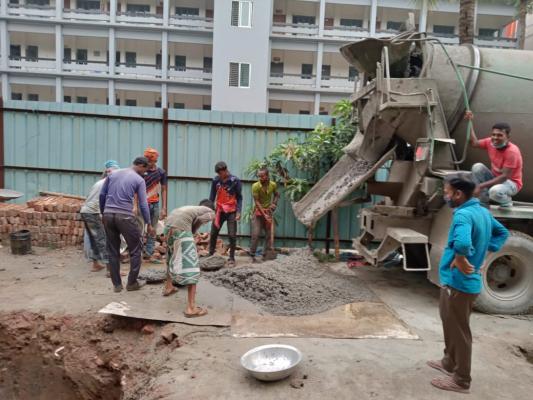

Canopy Base Concreting on 3-05-21
Domestic Water Tank Base concreting on 3-05-21

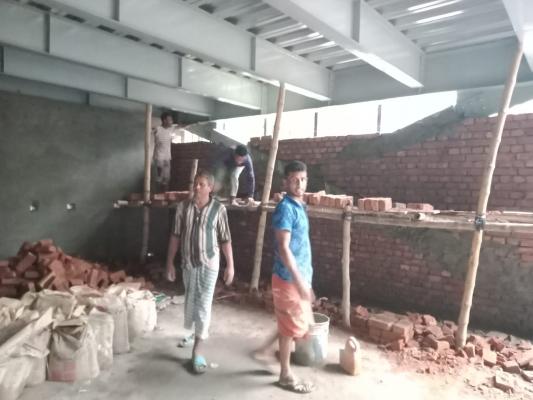

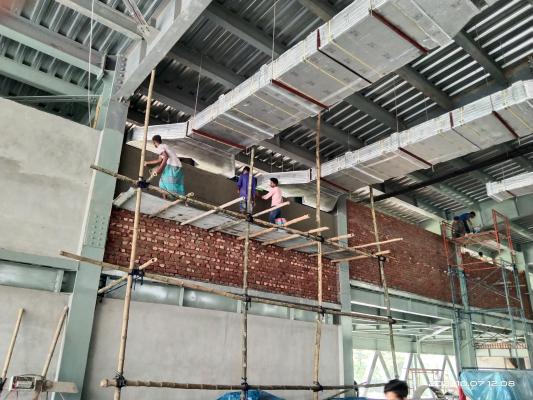

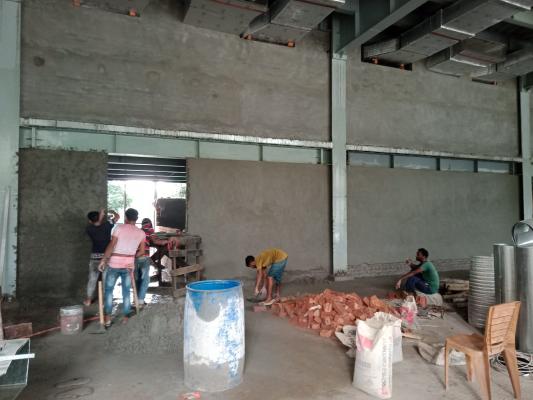

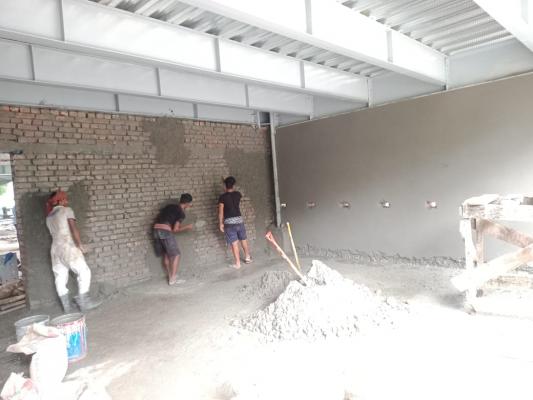

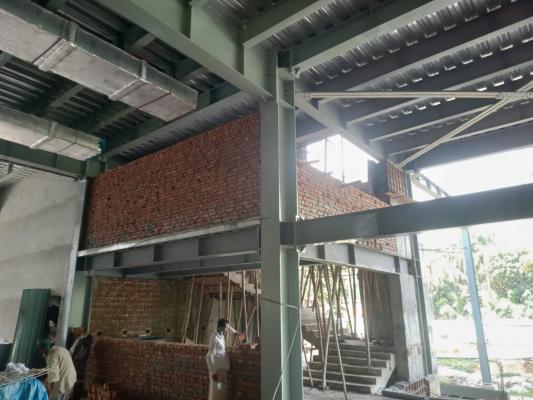

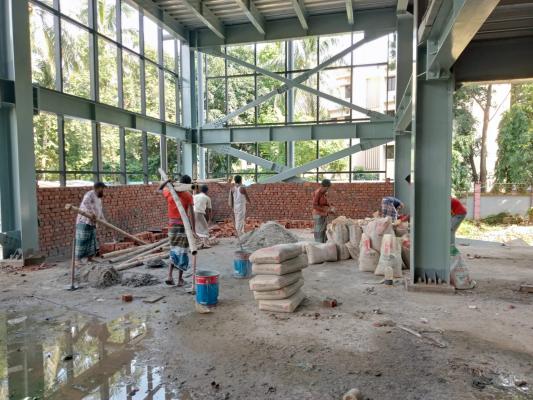

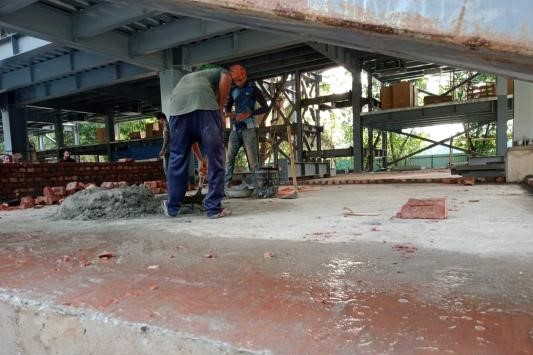

Ground Floor Brick Work on 5-05-21

ACP Post Setting on 5-05-21
Cannot get roof slab concreting Schedule from RMC

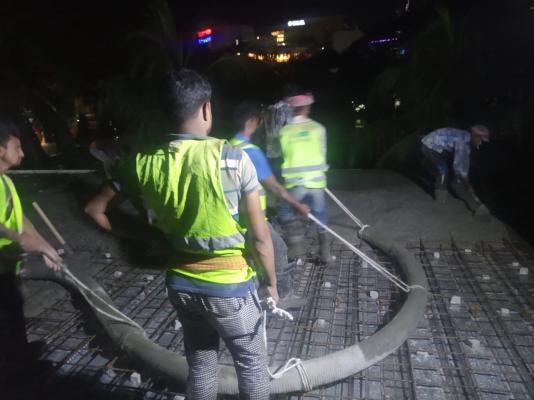

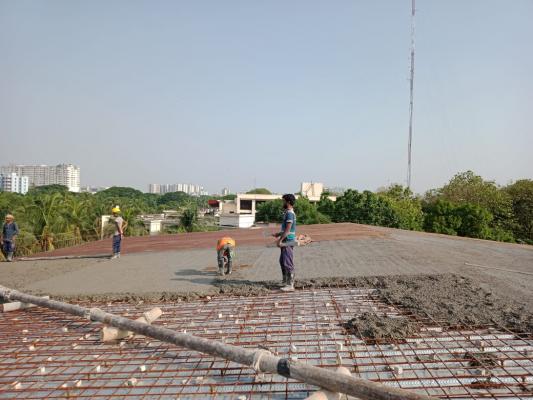

Roof Slab Concreting on 6-05-21
Hessain Cloth Covering after Contreting on 6-05-21

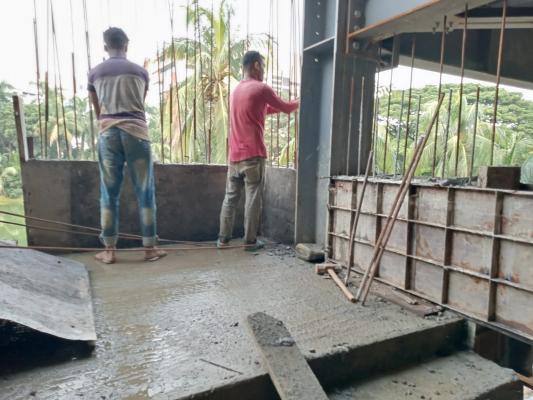

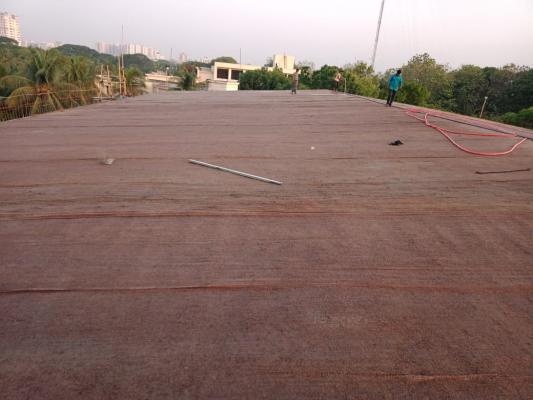

Roof Slab Conreting Completed on 7-05-21
Hessain Cloth Covering after Concreting on 7-05-21

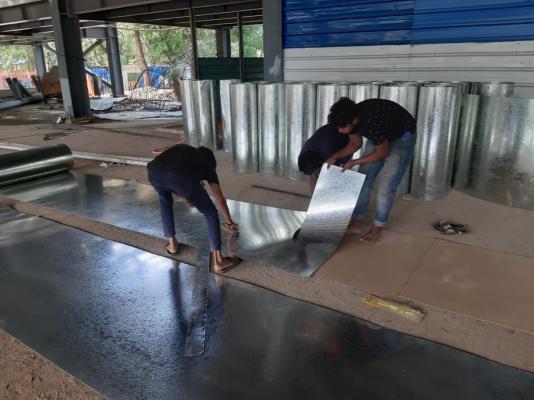

AC Indoor Unit Hanging on 9-05-21

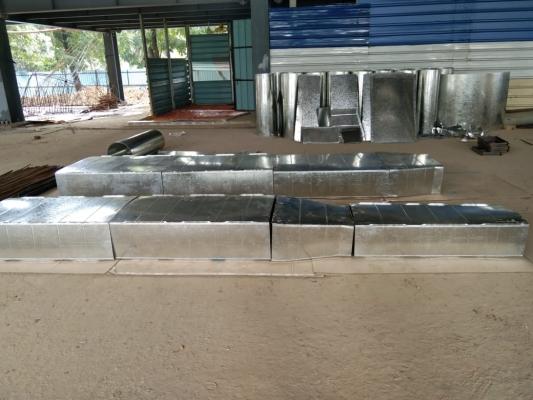

AC Duct Making on 9-05-21

AC Duct on 11-05-21

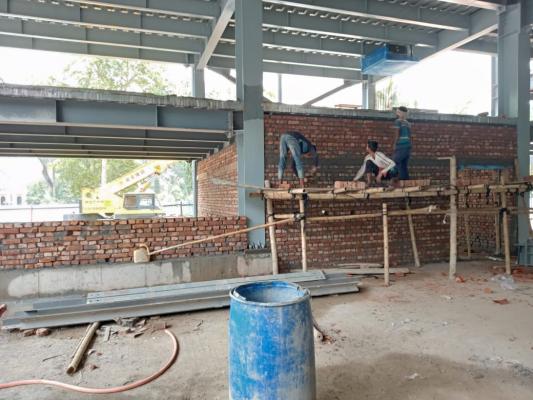

Ground Floor Brickwork on 11-05-21

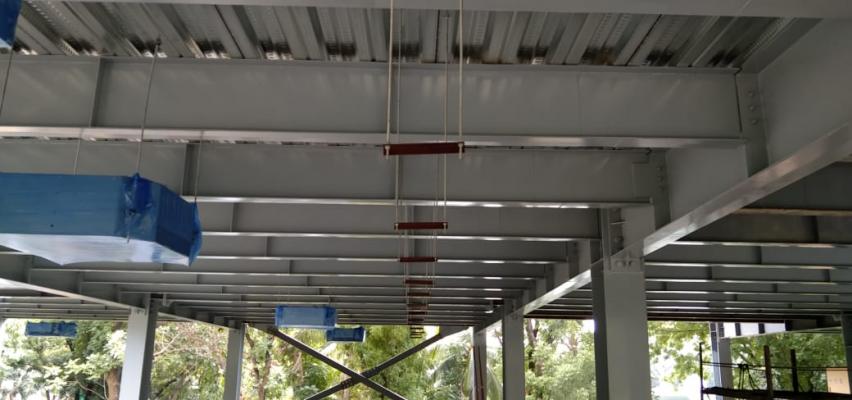

on 18-05-21
on 18-05-21
Project closed 12-17 May due to Eid-ul Future

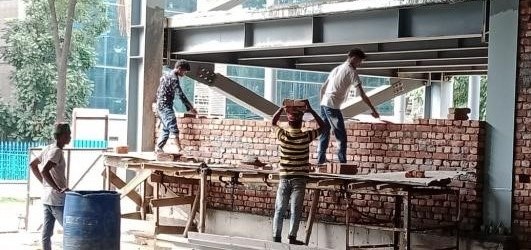

Ground Floor Brick Work on 19-05-21
AC Duct Making on 19-05-21
Ground Floor Brick Work on 22-05-21
AC Duct Hanging on 22-05-21

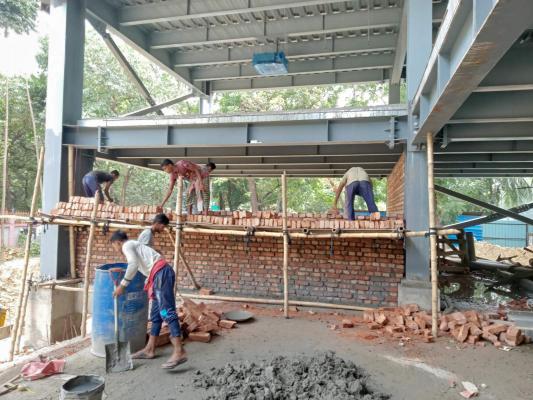

Ground Floor Brick Work on 25-05-21
AC Duct Fabrication on 25-05-21

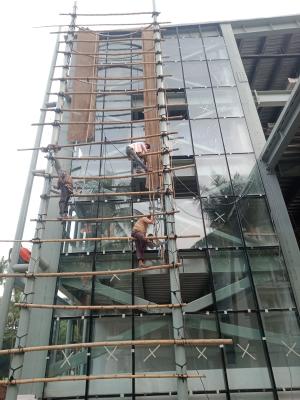

Glass Frame Fixing on 31-05-21
Ground Floor Stair Wall Concreting on 31-05-21
Domestic Water Tank Wall Shuttering on 2-06-21

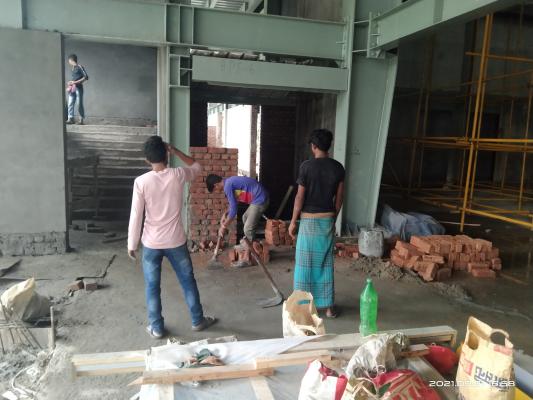

Clearing for Substation Room Layout on 2-06-21

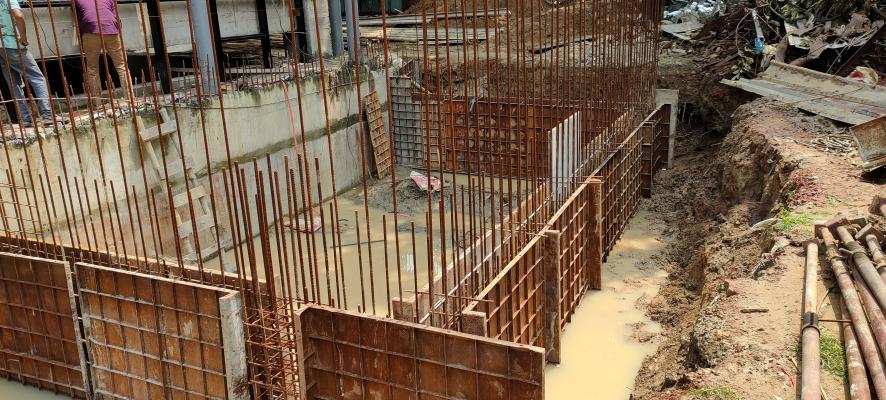

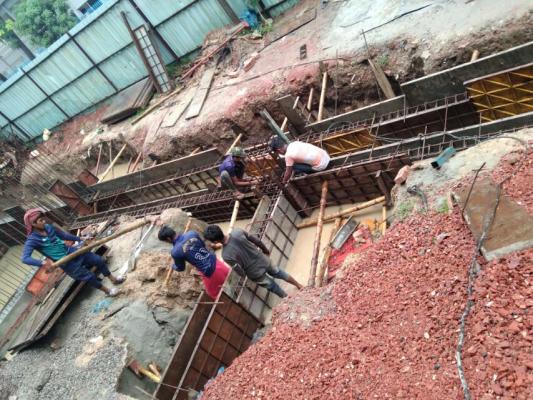

Domestic Water Tank-1st Lift Concreting on 4-06-21
Ground Floor-Stair Shuttering on 4-06-21
Ground Floor Stair Shuttering on 5-06-21

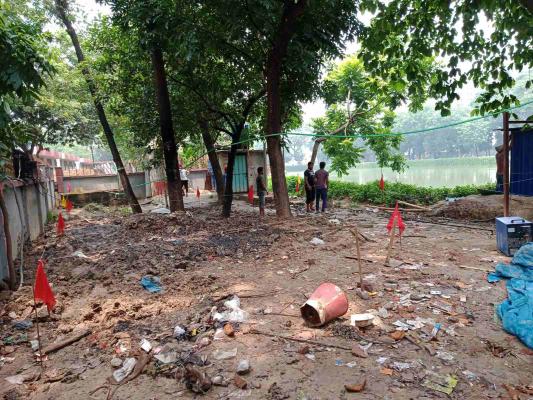

Substation-Generator Room-Layout on 5-06-21

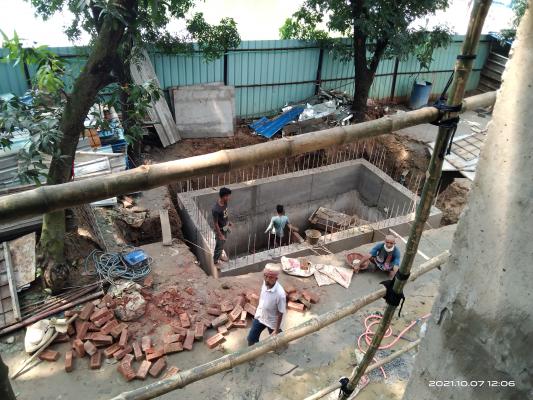

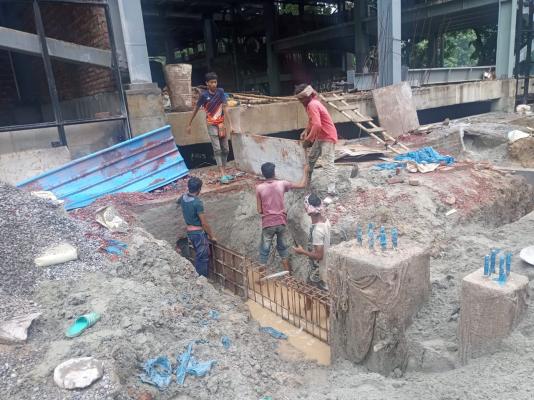

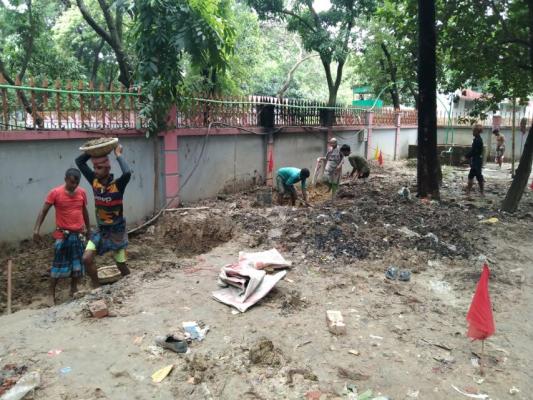

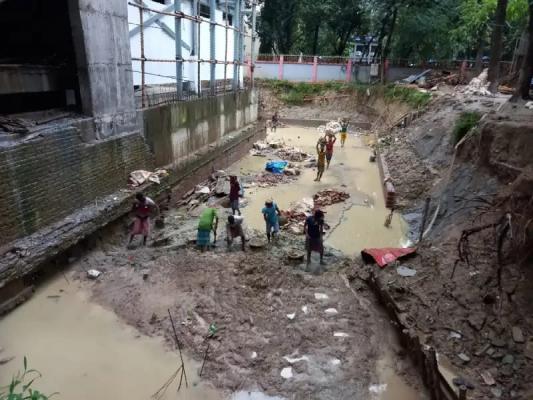

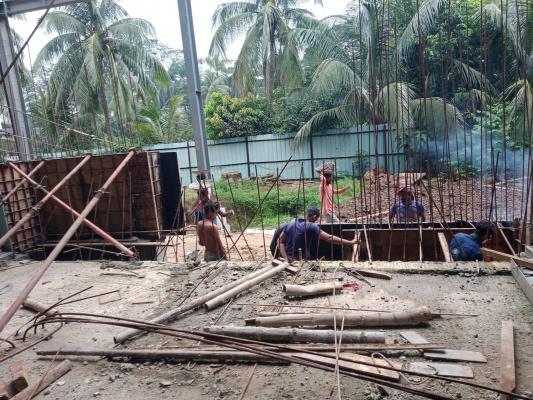

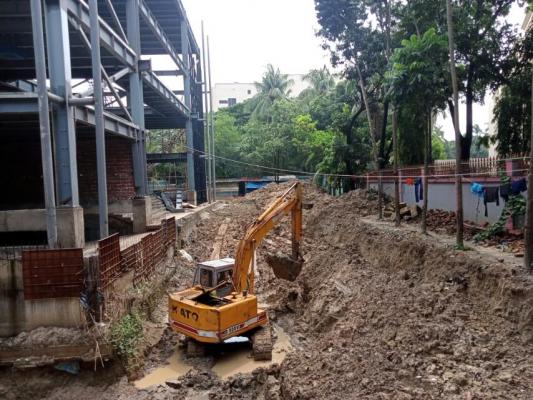

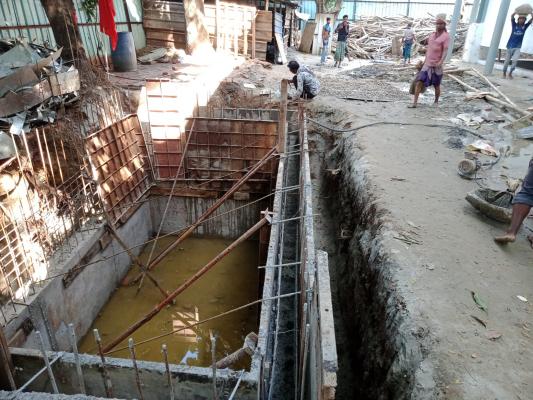

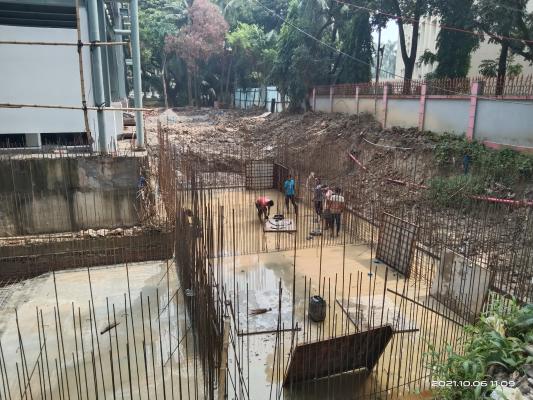

Fire water reservoir excavation on 7-06-21

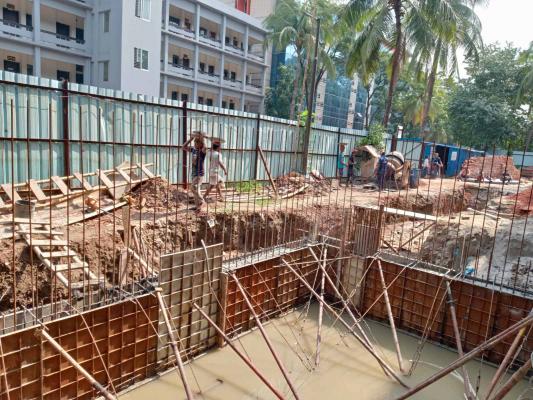

Substation n Generator Base excavation on 7-06-21
Porch Grade Beam Shuttering on 9-06-21

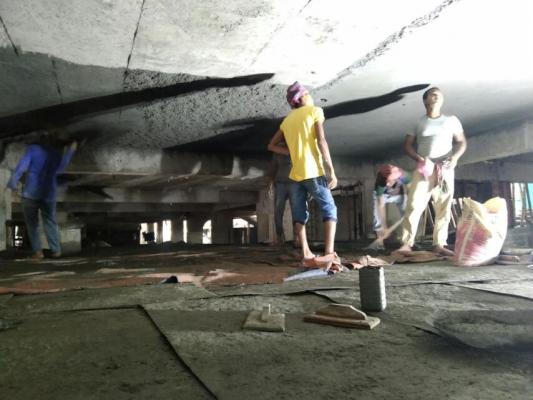

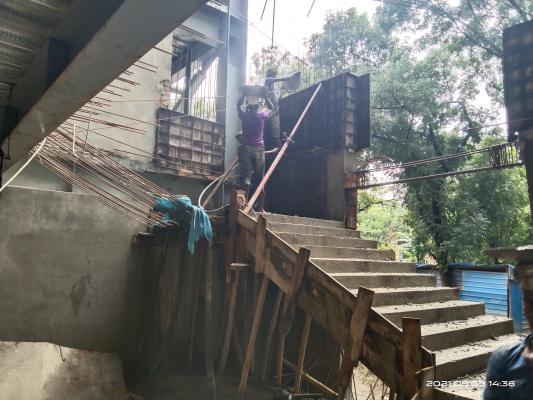

Basement Ceiling Plastering on 9-06-21

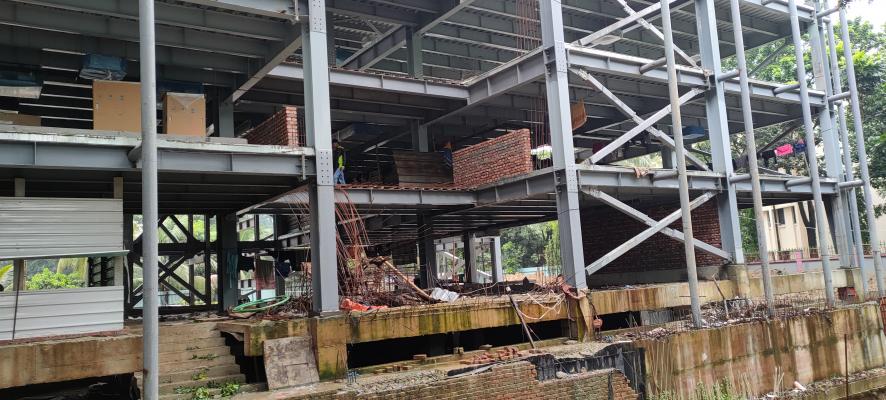

GF Mezzanine Stair Wall Concreting on 16-06-21
Gr.Floor Mezzanine Brick Work on 16-06-21

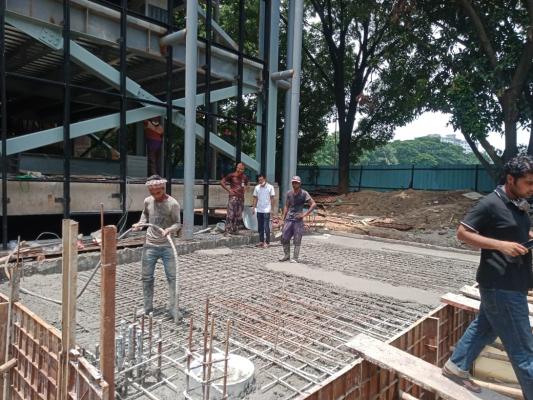

Domestic Water Tank Slab Re-barwork on 23-06-21

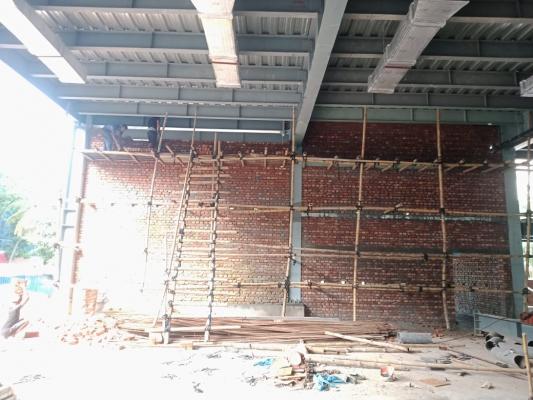

Gr.Floor Mezzanine Brick Work on 23-06-21
Somestic Water Tank Slab Concreting on 25-06-21

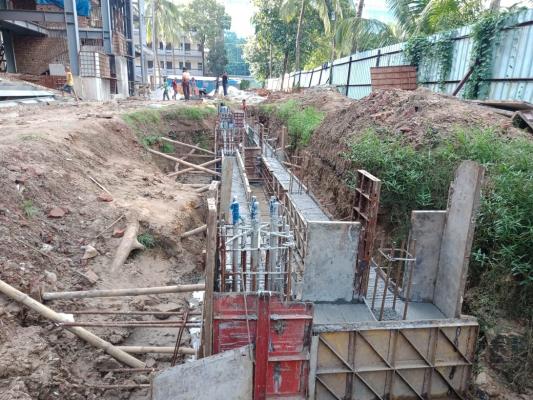

Porch Grade Beam Beam Concreting on 25-06-21

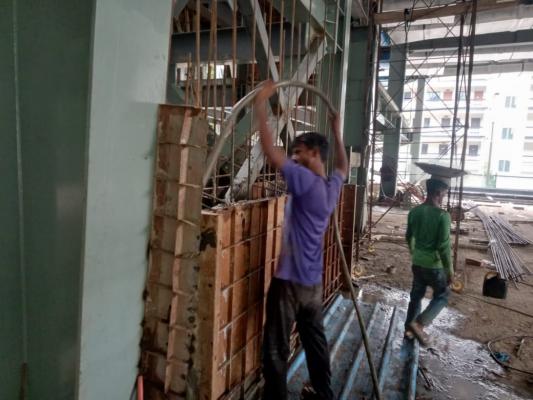

1st Floor Stair Concreting on 27-06-21

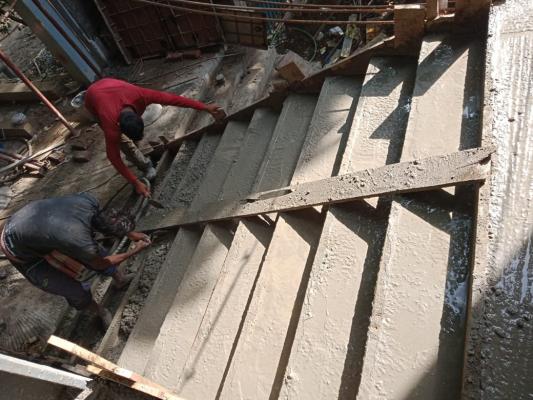

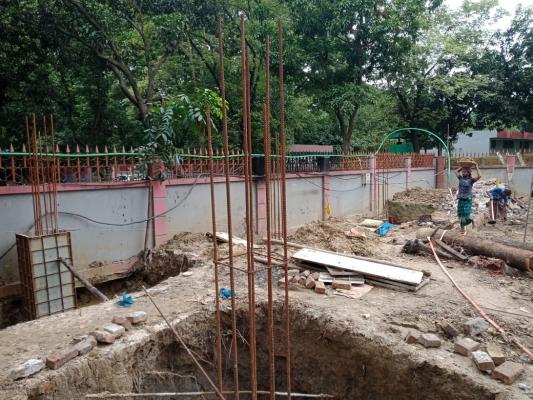

Substation-Generator Room-Excavation on 27-06-21
Ground Floor Lift Wall Concreting on 30-06-21
Ground Floor-Plastering on 30-06-21
Semi-Lockdown from 28th to 30th Jun 21 due to COVID19
Ground Floor Stair Re-bar work on 1-07-21

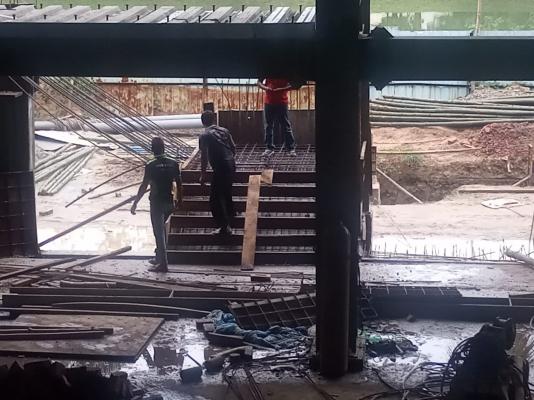

Porch Grade Beam Beam Shuttering on 1-07-21
Lock-down Started from 1st July 2021 due to COVID-19

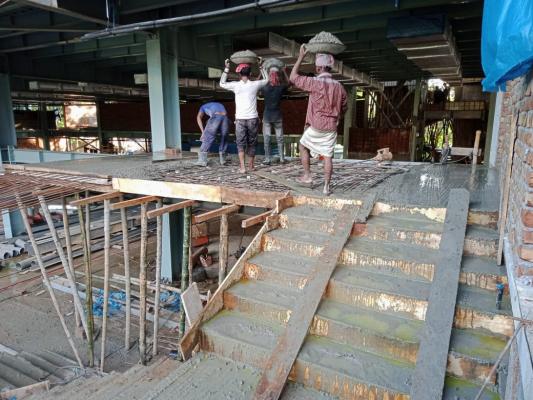

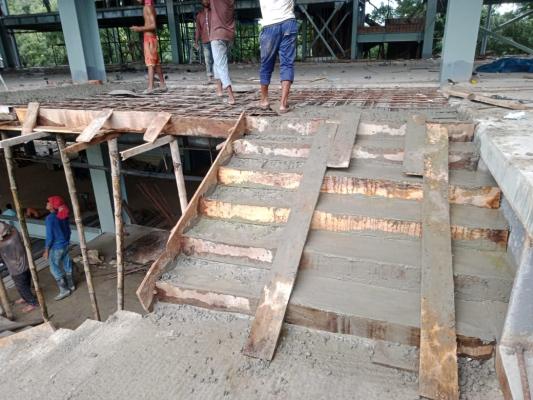

Gr.Floor 3-Flight Stair Concreting on 8-07-21

Gr.Floor Mezzanine Brick-Work on 8-07-21

Substation Footing Conctreting on 18-07-21

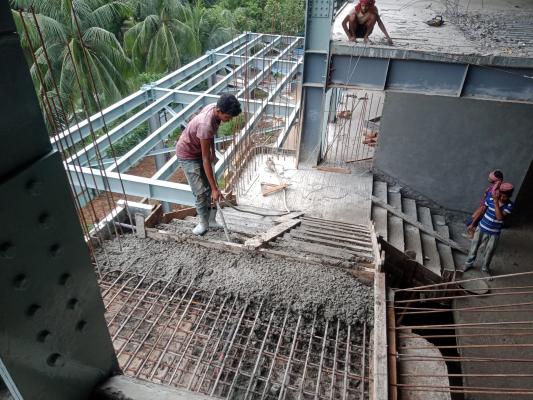

Gr.Floor Mezzanine Stair Concreting on 18-07-21

ACP arrived at site on 20-07-21
ACP arrived at site on 20-07-21
Project closed from 19 Jul 2021 for Eid-ul Adha Vacation
1st floor stair rod binding on 1-08-21

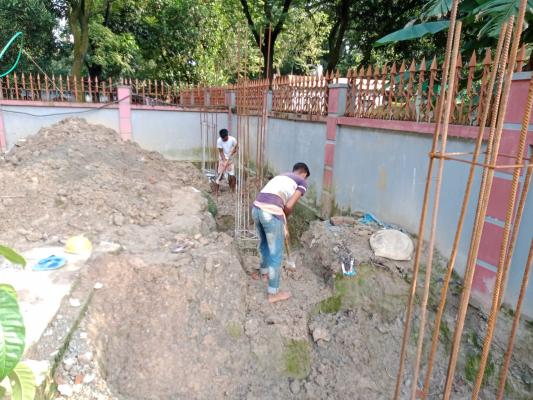

Sub-station grade beam earth cutting on 1-08-21
Site closed on 19.07.2021 and open on 01.08.2021 due to eid ul azha vacation with covid-19 Lock-down
Sub-station grade beam earth cutting wor on 2-08-21

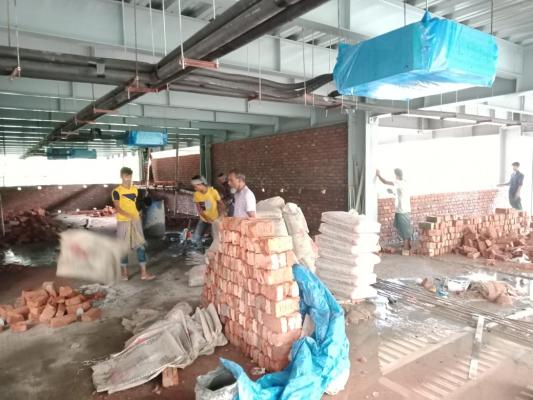

GF mezzanine brick work on 2-08-21

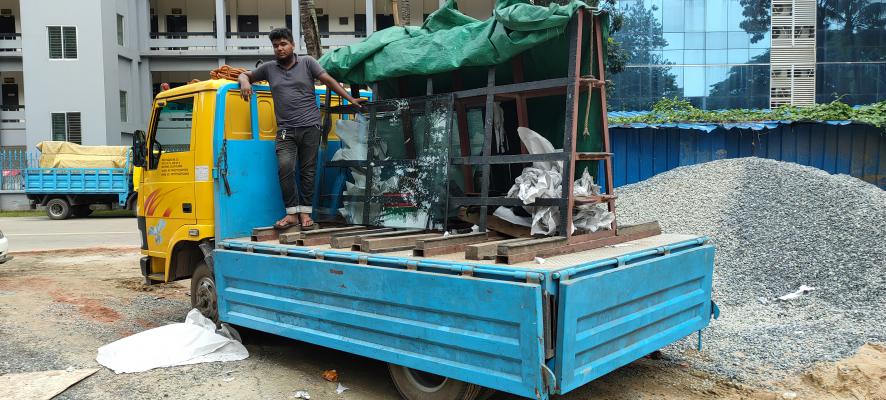

Glasses un-loading on 3-08-21
GF merzzanine brick work on 3-08-21

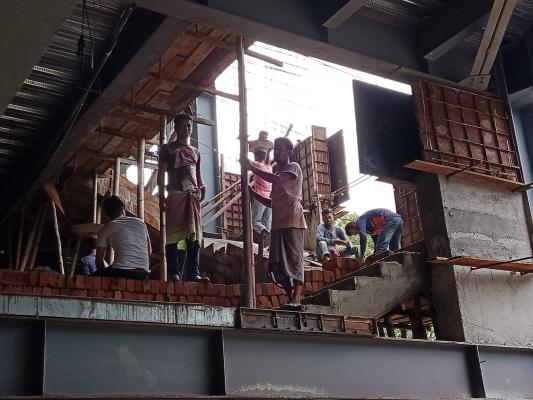

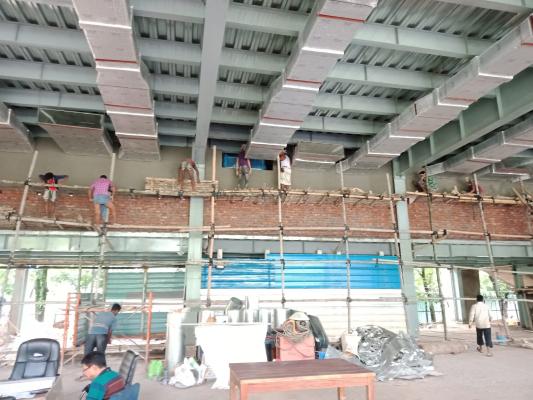

GF Mazzanine stair wall casting on 4-08-21
GF Mazzanine wall plaster on 4-08-21
GF brick work on 5-08-21
GF Mazzanine brick work on 5-08-21

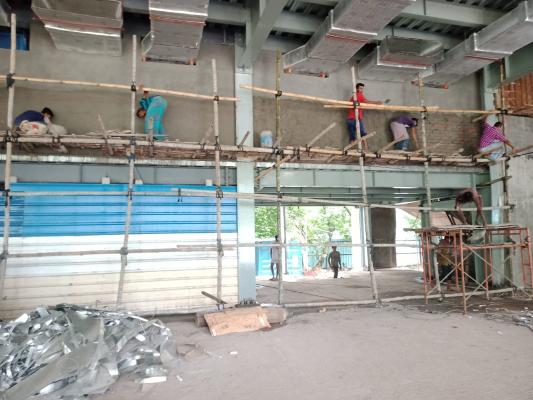

Ground Floor Mezzanine Plastering on 6-08-21
Steel Canopy Installing on 6-08-21

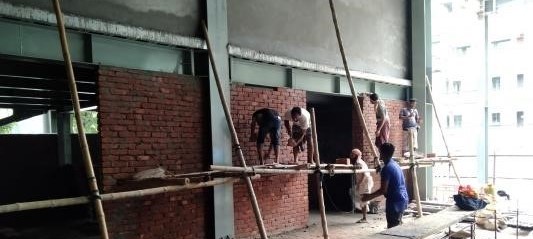

GF brick and plaster work on 7-08-21

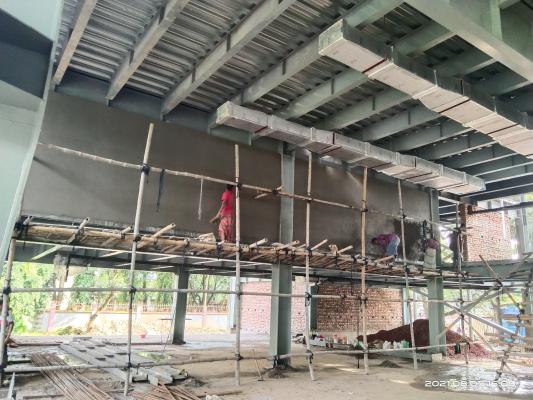

GF Mezzanine plaster work on 7-08-21

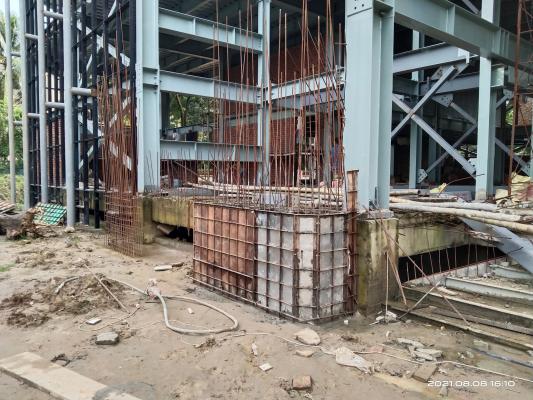

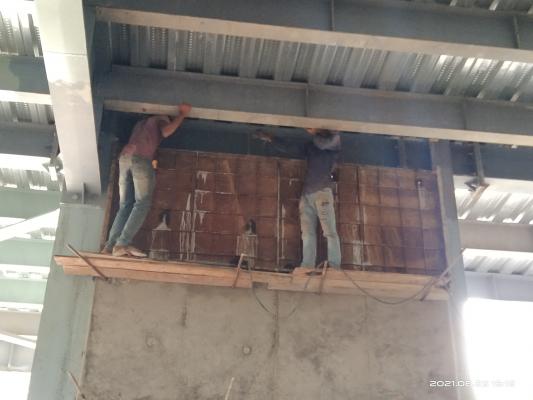

GF Stair no-3 shuttering and casting on 8-08-21

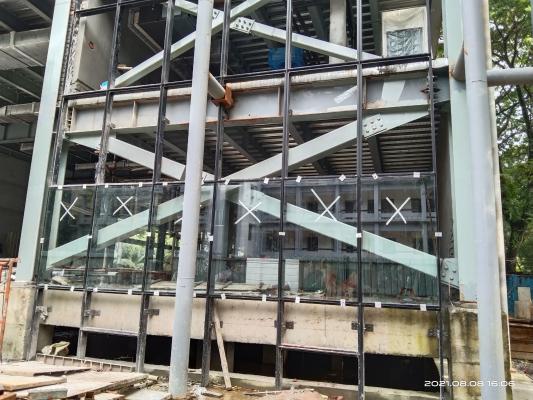

GF Glass fixing (31 sqm)=334 sft on 8-08-21

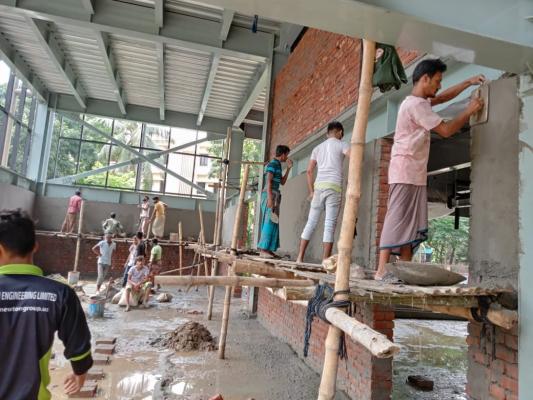

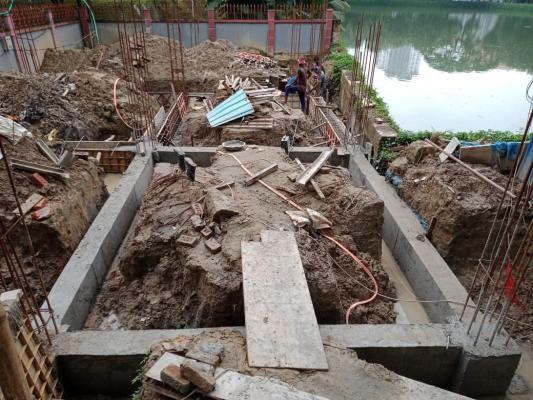

Substation Grade Beam Concreing on 9-08-21
GF Mezzanine Shear Wall Plasteing on 9-08-21
GF brick work on 10-08-21
GF stair work (stair no-3) on 10-08-21

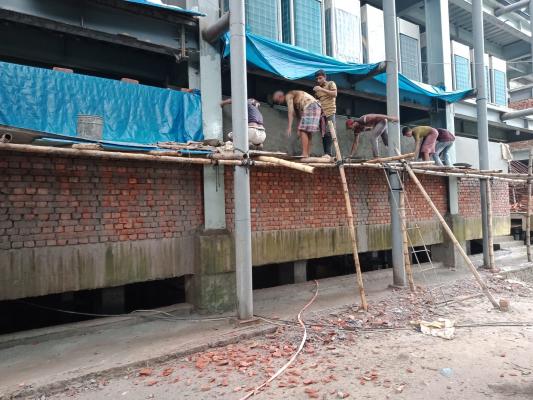

GF Stair work (stair no. 3) on 11-08-21
GF Brick wall on 11-08-21
GF Brick work on 12-08-21

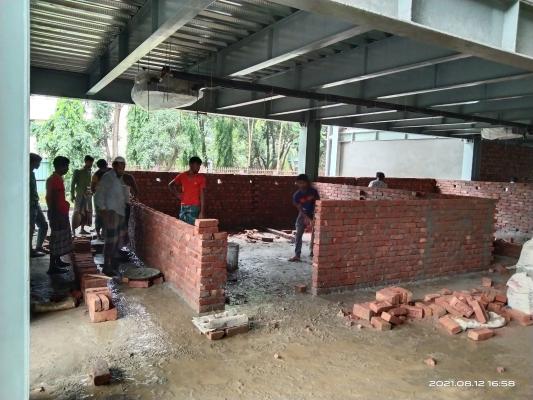

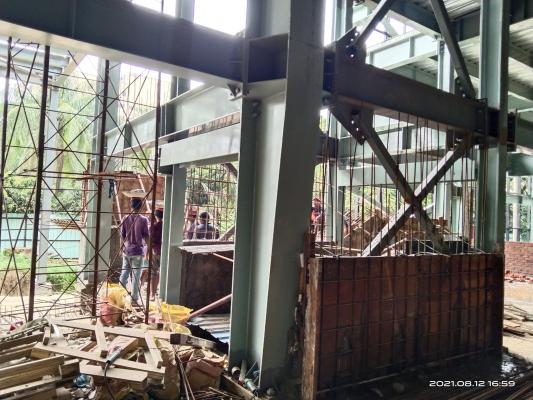

GF Stair work on 12-08-21
GF plaster work on 13-08-21
Out side glass frame cleaning on 13-08-21
GF Brick work on 14-08-21

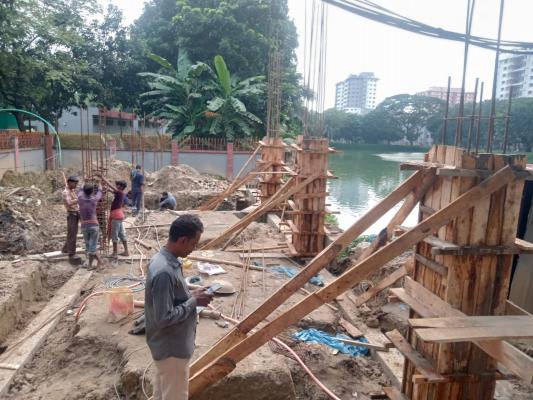

Generator room column casting on 14-08-21

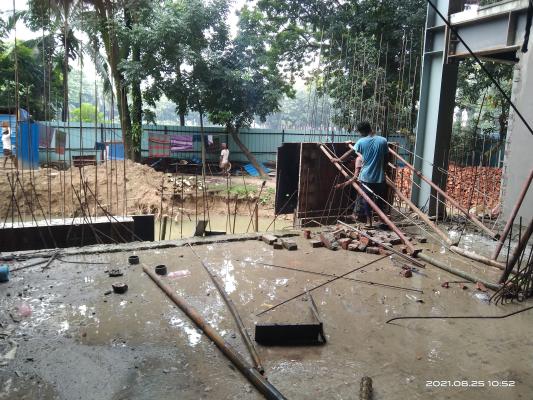

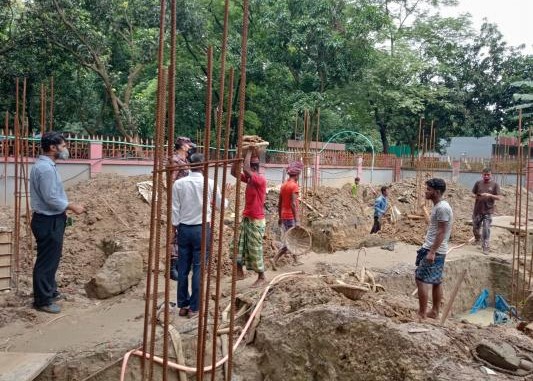

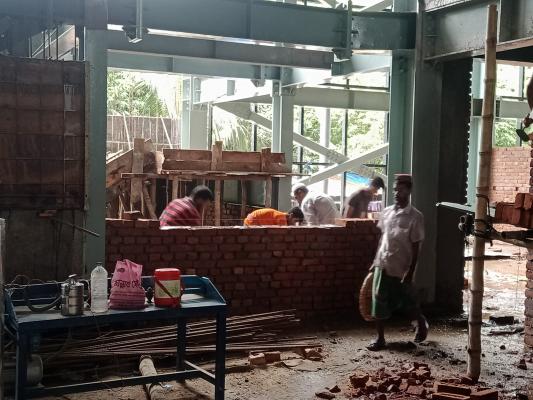

GF brick work on 15-08-21
FF Mezzanine floor dismantling on 15-08-21

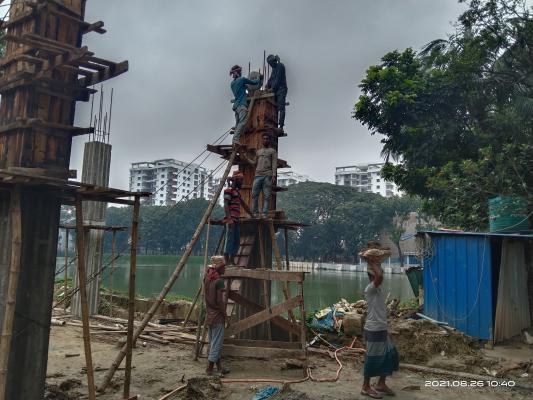

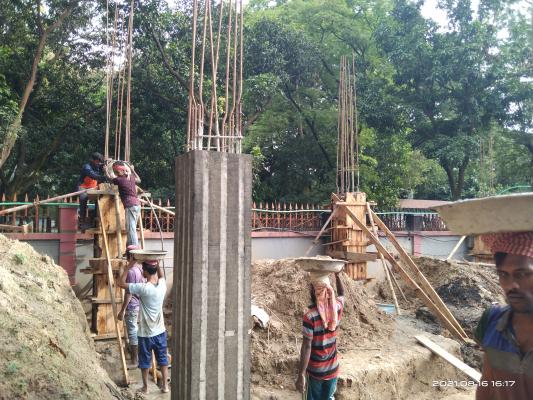

Generator and substation column casting on 16-08-21

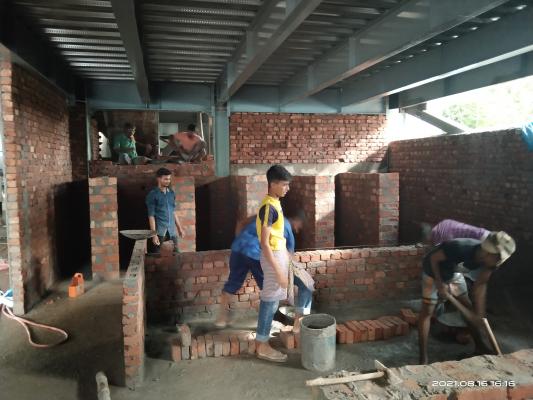

GF Brick work on 16-08-21

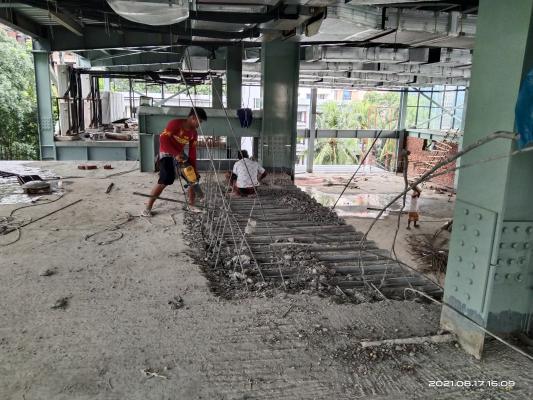

FF Mezzanine slab dismantling on 17-08-21
GF brick work on 17-08-21

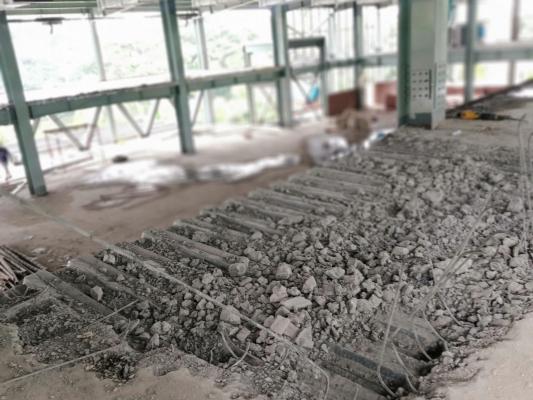

FF Mezzanine floor dismantling work on 18-08-21

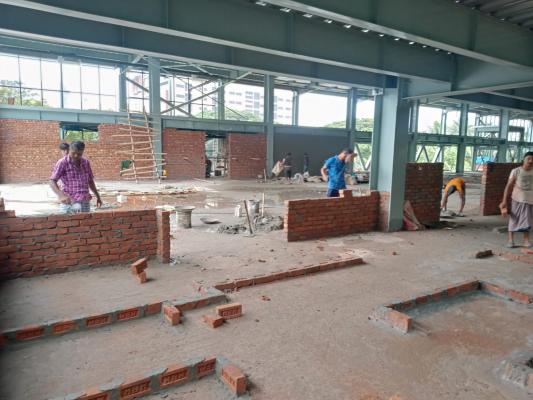

FF brick work on 18-08-21

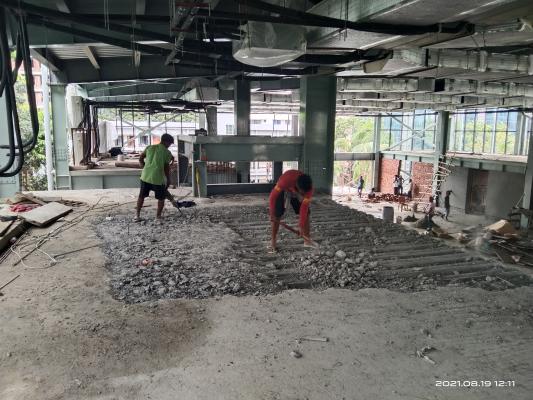

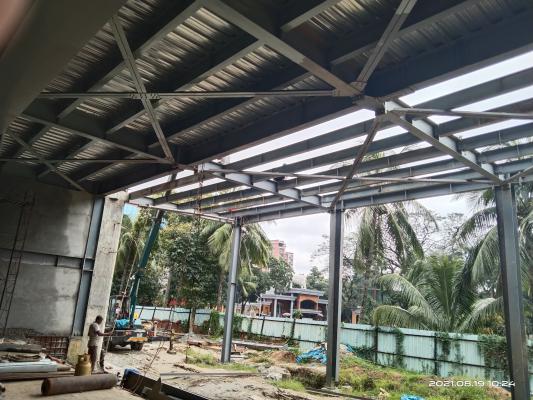

FF Mezzanine floor dismantling on 19-08-21
East steel canopy on 19-08-21

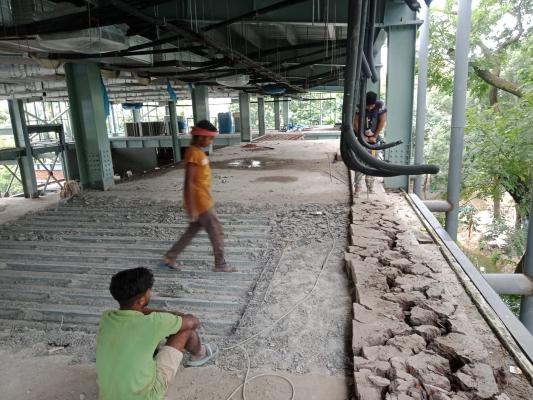

FF Mezzanine dismantling work on 20-08-21
GF stair-3 2nd flight casting on 20-08-21

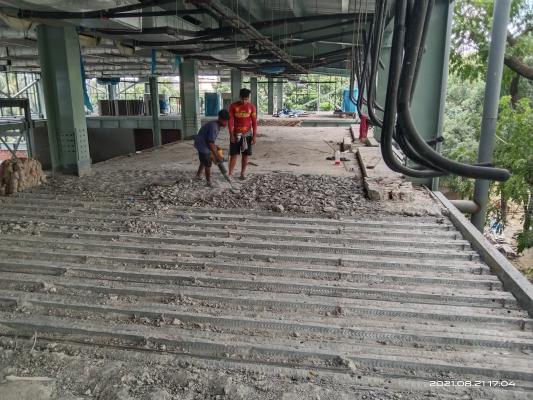

FF Mezzanine floor dismantling work on 21-08-21
FF Mezzanine stair casting on 21-08-21
FF wall plaster on 22-08-21

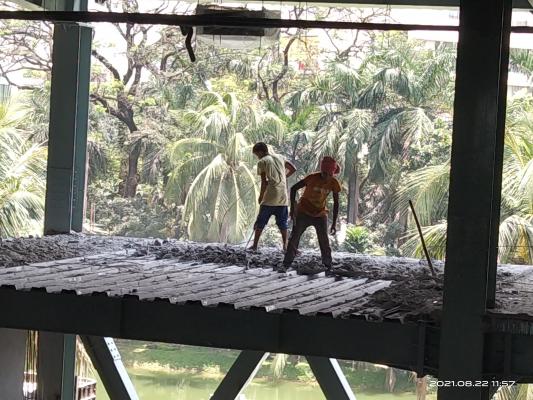

FF Mezzanine floor dismantling on 22-08-21
GF Stair Shuttering on 23-08-21

Piping work for fire on 23-08-21
FFMezzanine stair casting on 24-08-21

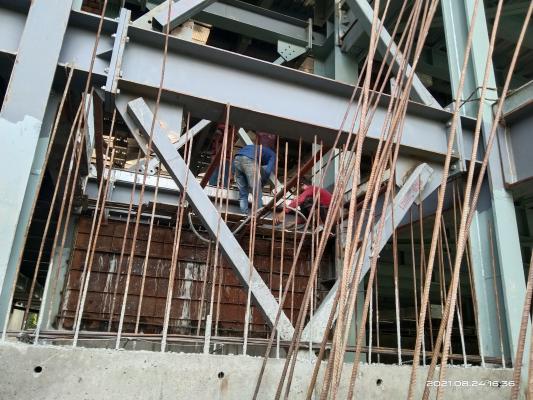

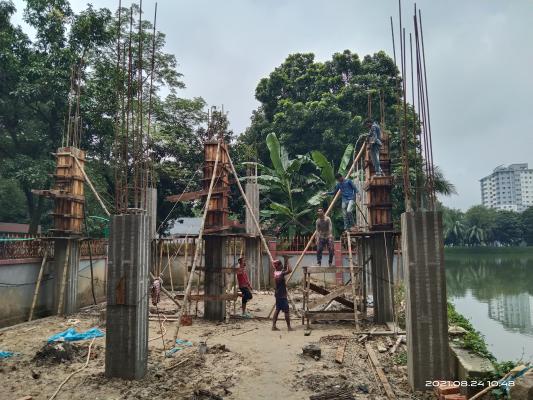

Generator room column casting on 24-08-21
GG stair wall (stair no-4) on 25-08-21

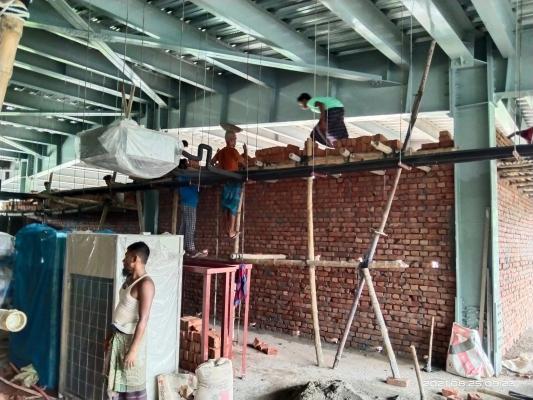

FFM brick wall on 25-08-21

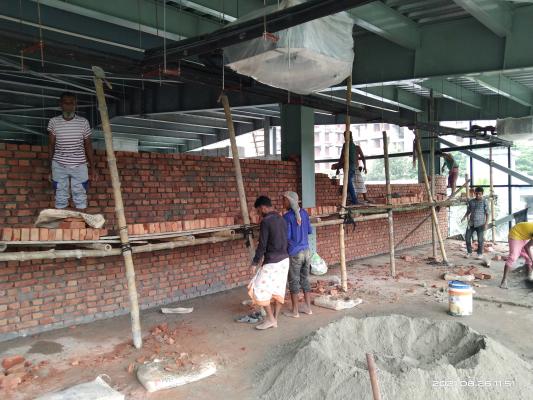

FFM brick work on 26-08-21
Generator room Column casting on 26-08-21

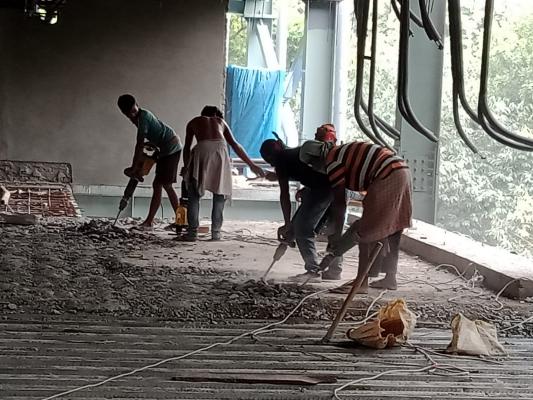

FFM slab dismantling work on 27-08-21

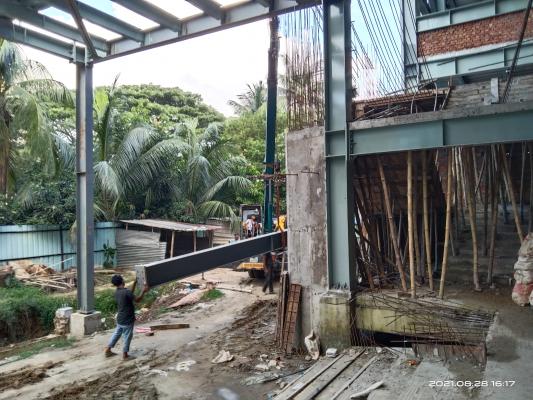

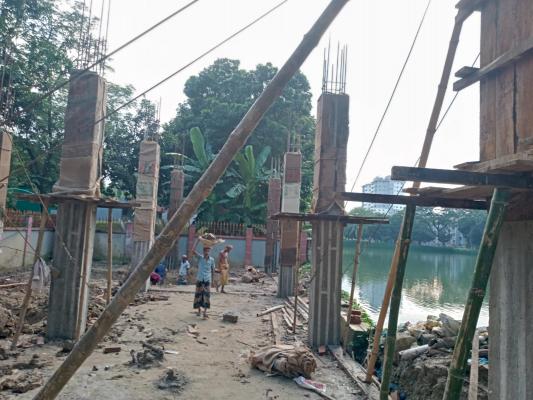

Generator room column shuttering on 27-08-21

Steel beam shifting on 28-08-21

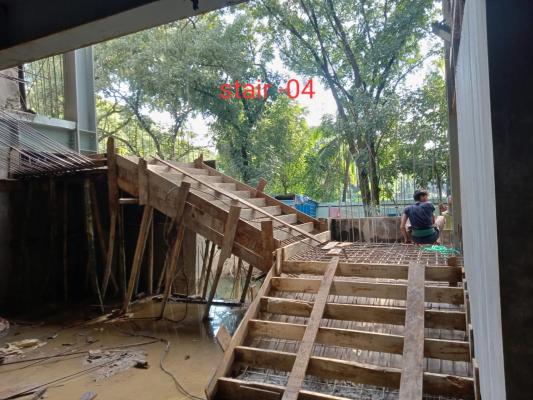

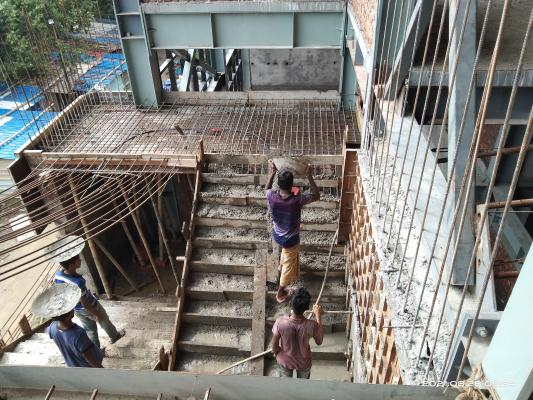

GFM stair casting (stair no. 4) on 28-08-21
Lift receive at site on 29-08-21
Basement ceiling plaster on 29-08-21

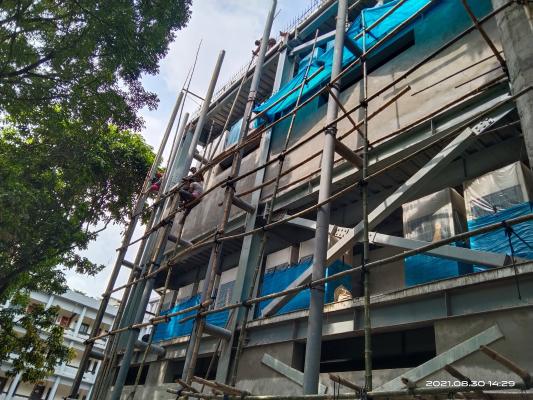

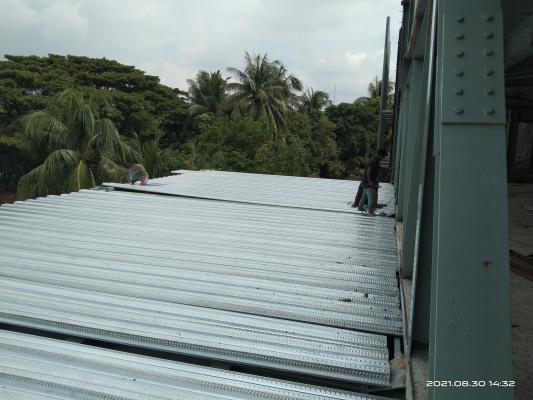

East Canopy decking sheet shitting on 30-08-21
Gutter Scaffolding work on 30-08-21

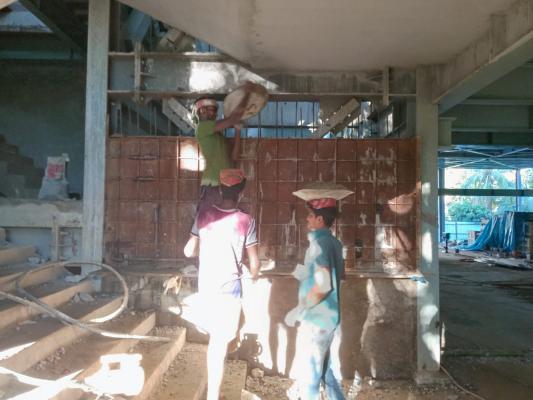

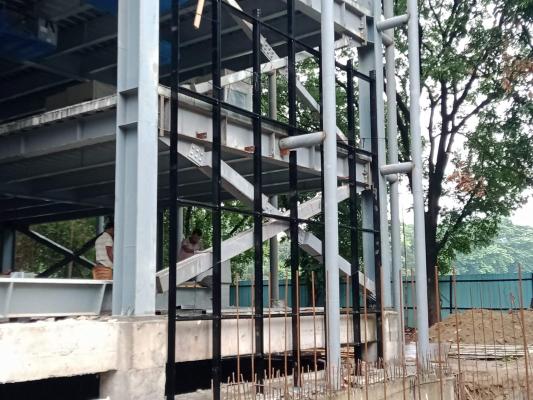

GF Lift wall Casting on 31-08-21
GF Stair casting on 31-08-21
East Canopy Roofing work on 1-09-21
Sub-Station room floor Development work on 1-09-21

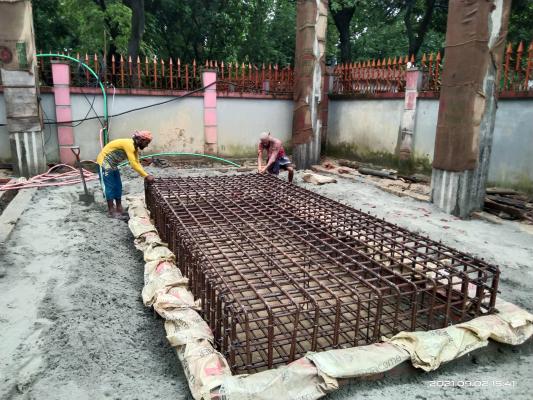

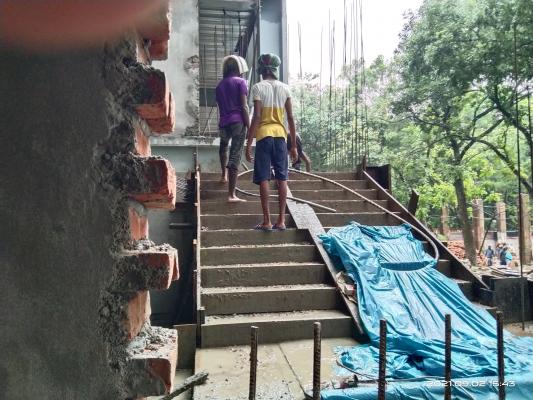

Grond floor stair casting on 2-09-21
Generator foundation rod binding on 2-09-21
Basement Ceiling plaster on 3-09-21
Stair rod binding on 3-09-21

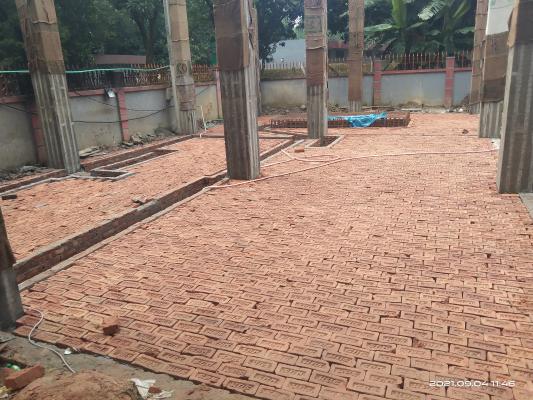

Generator room floor soling work on 4-09-21
Roof top Gutter work on 4-09-21
Generator floor rod binding on 5-09-21
Stair casting on 5-09-21

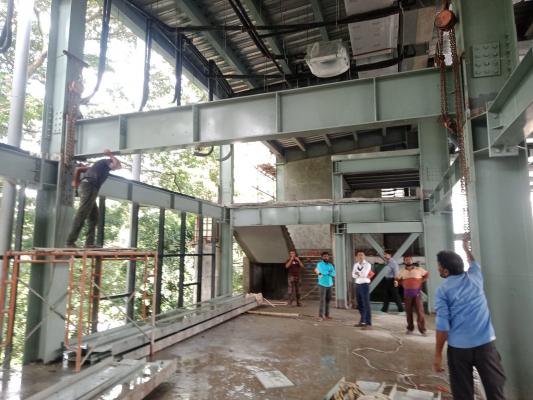

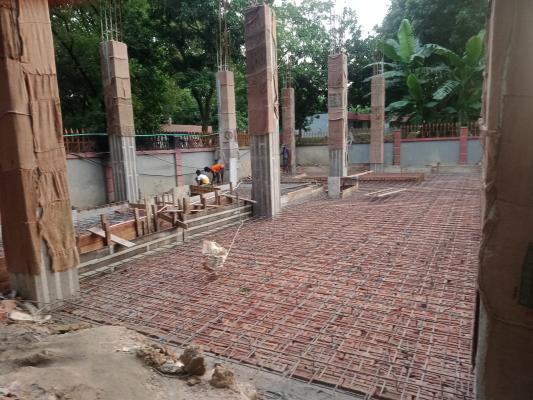

Generator room floor rod binding on 6-09-21
FF Mezzanine floor re-construction on 6-09-21

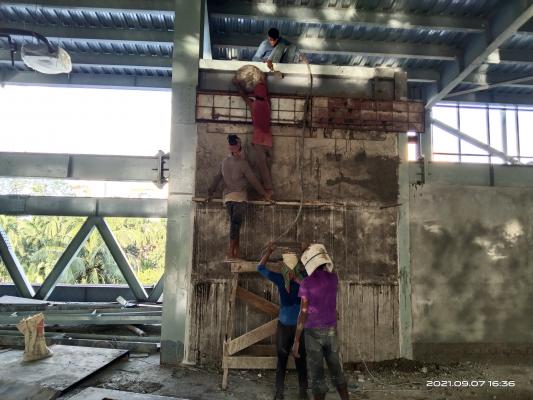

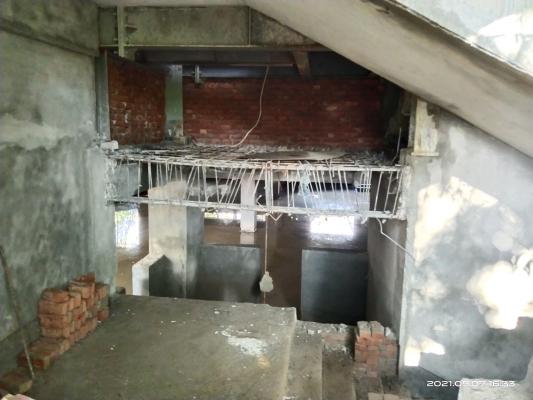

Beam dismantling for MDB Room on 7-09-21
Lift wall casting on 7-09-21
Canopy Casting on 8-09-21

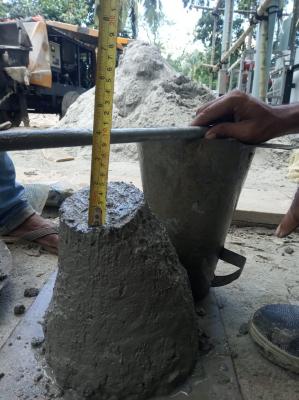

Generator floor casting Slump Test on 8-09-21
Generator room brick work on 9-09-21

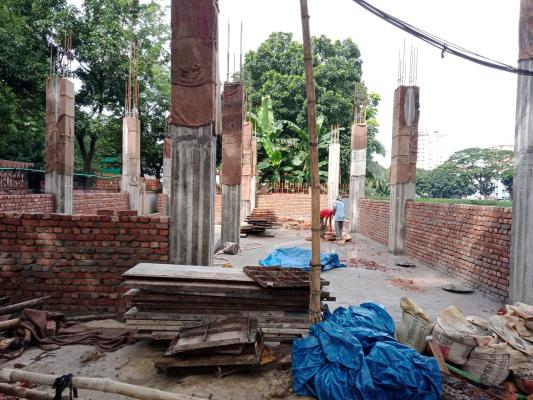

Stair wall casting (stair-4) on 9-09-21

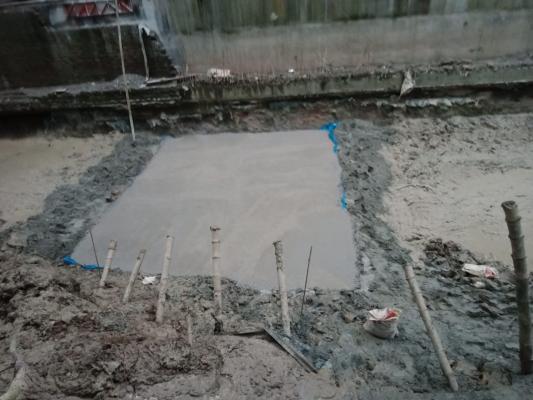

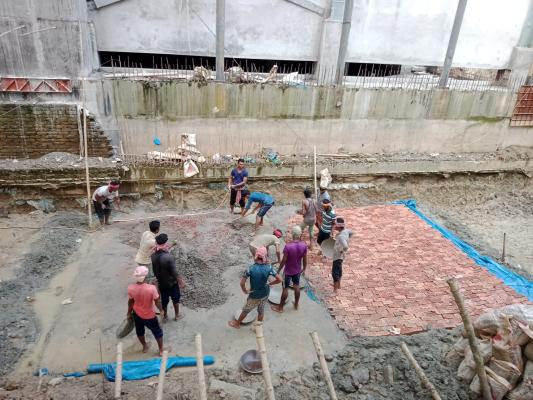

Fire Tank CC Base Casting on 10-09-21
Generator room brick work on 10-09-21

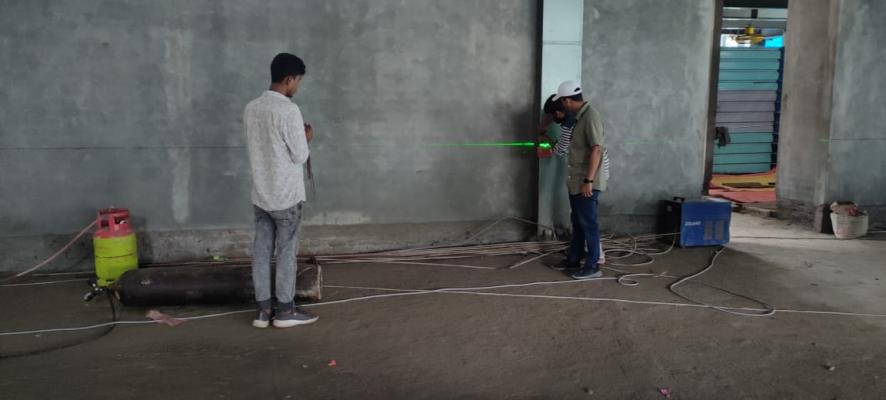

False ceiling level marking on 11-09-21
Fire tank base cc casting on 11-09-21

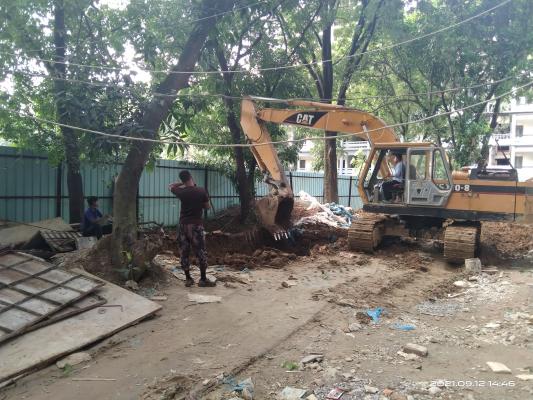

Earth excavation work for septic tank on 12-09-21

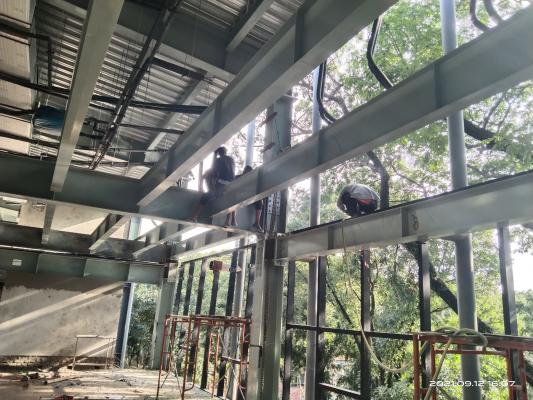

Retrofitting work at 1st floor mezzanine on 12-09-21

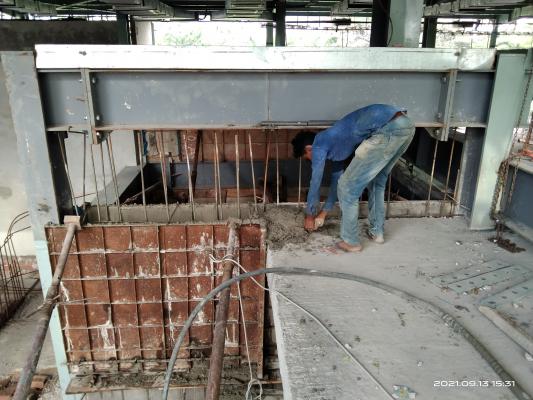

Lift wall casting on 13-09-21
Fire tank clay remove on 13-09-21
Brick work for lift on 14-09-21
Gutter plaster work on 14-09-21

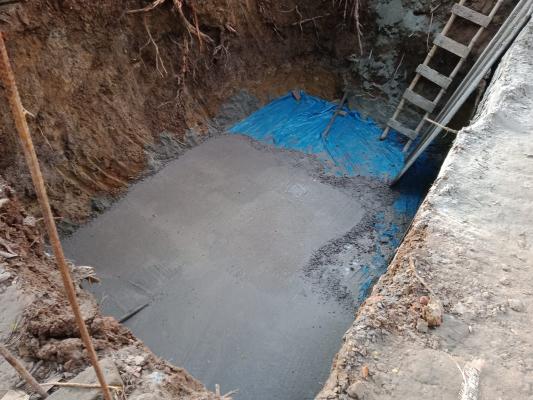

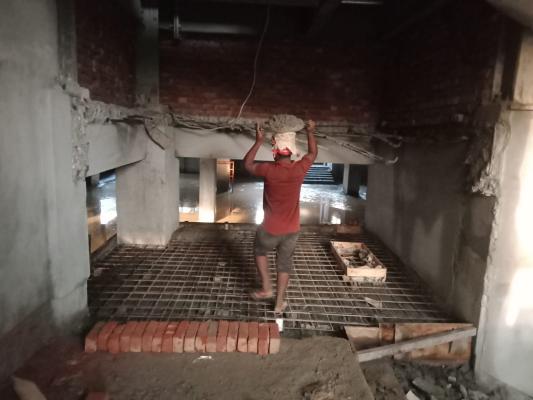

Septic tank cc work on 15-09-21
MDB room slab casting on 15-09-21
Fire tank cc work on 16-09-21

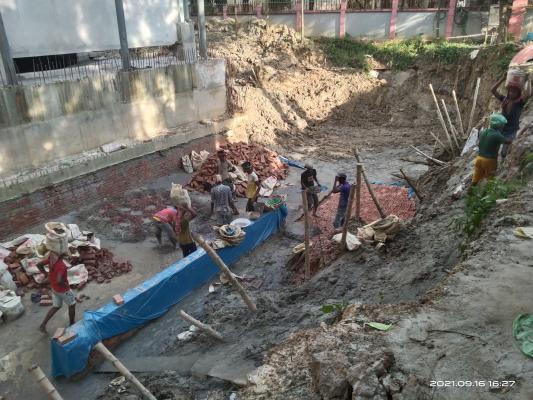

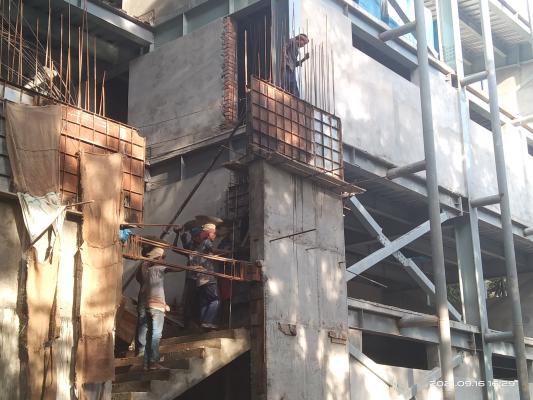

Stair wall casting on 16-09-21

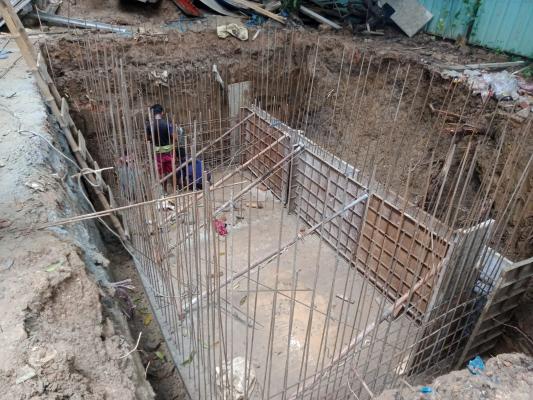

Sptic tank RCC Base casting on 17-09-21

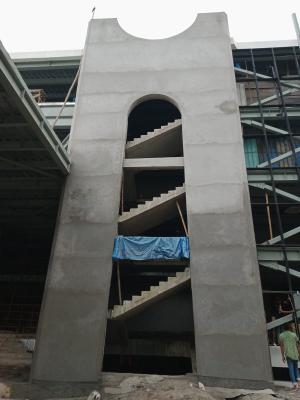

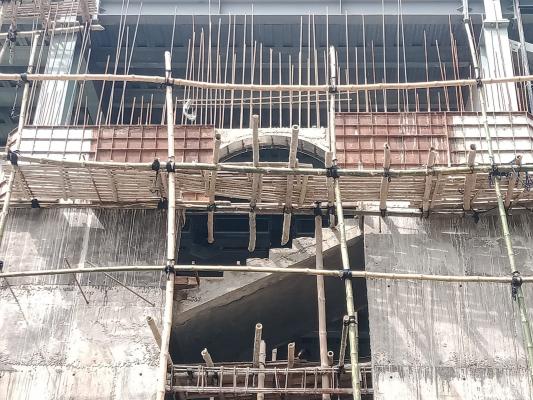

Stair Arch Casting (stair no. 2) on 17-09-21
Fire tank cc work on 18-09-21

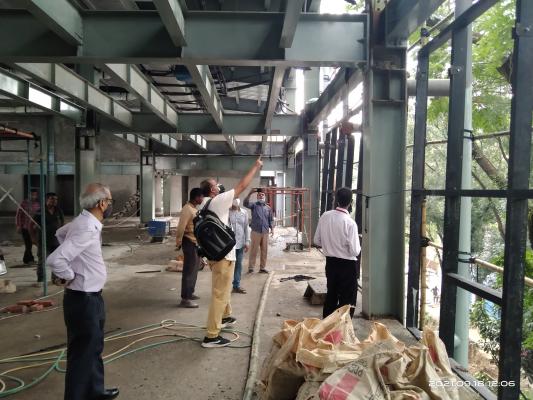

Consultent site visit (Architectural and on 18-09-21
Fire Tank CC work on 19-09-21

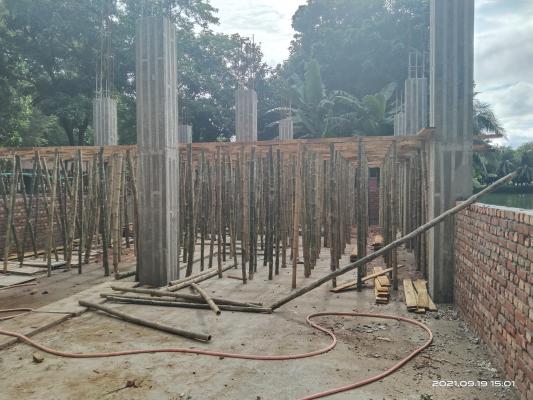

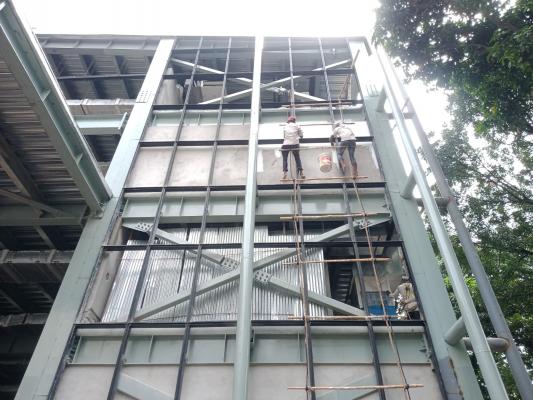

Outside painting work on 19-09-21
Septic Tank wall shuttering and casting on 20-09-21
Sub-Station and Generator room staging f on 20-09-21
Exterior wall painting work on 21-09-21
Lift front brick work as per opening on 21-09-21

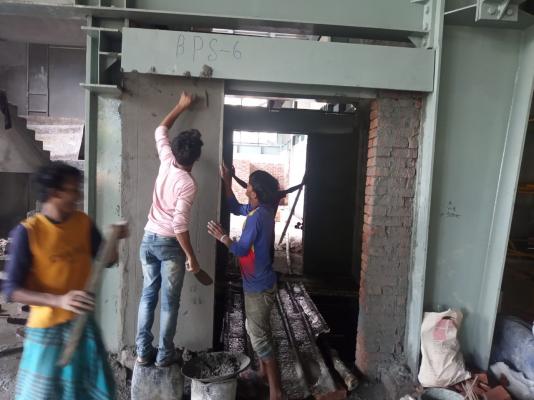

Lift door wall plaster on 22-09-21
Earth remove from fire tank base on 22-09-21
Generator room shuttering work on 23-09-21

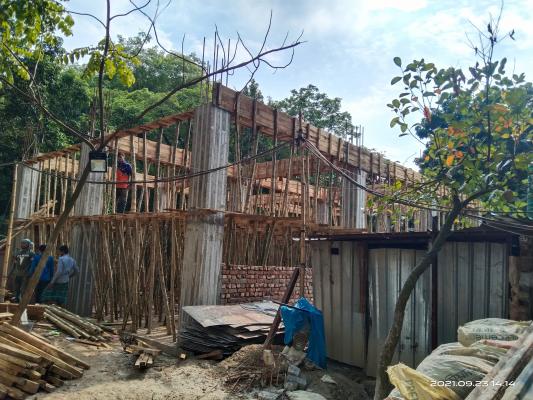

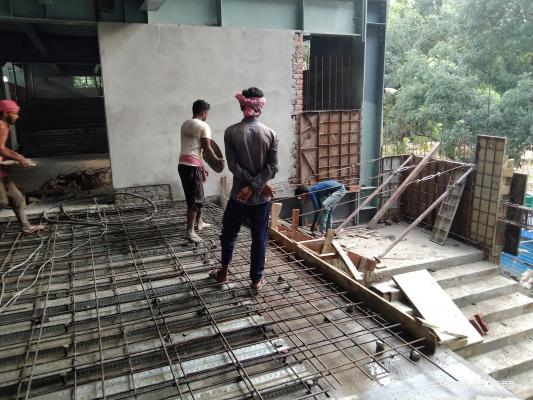

GF Mezzanine stair casting (4-no) on 23-09-21
Meeting with consultent at site (Fire an on 24-09-21

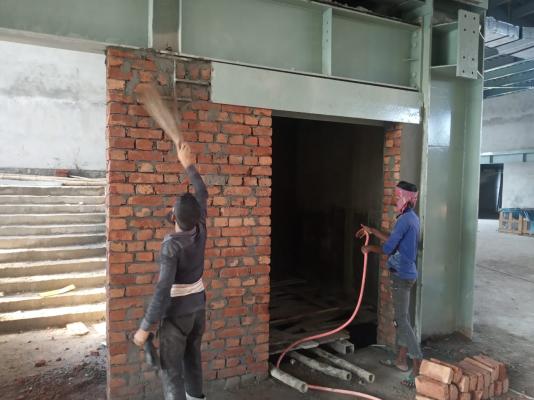

1st Floor lift door side brick wall on 24-09-21
Fire tank base clean on 25-09-21
Stair wall casting on 25-09-21
Rod binding at 1st floor mezzanine on 26-09-21

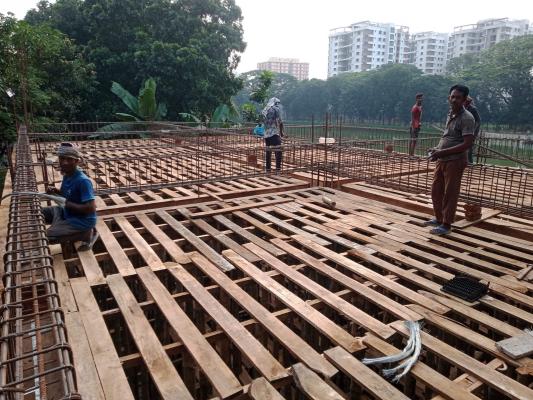

Generator room slab shuttering on 26-09-21
Glass fitting work on 27-09-21

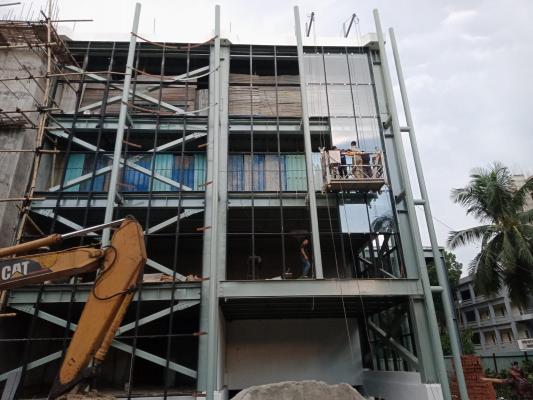

Rod binding work at Generator room slab on 27-09-21

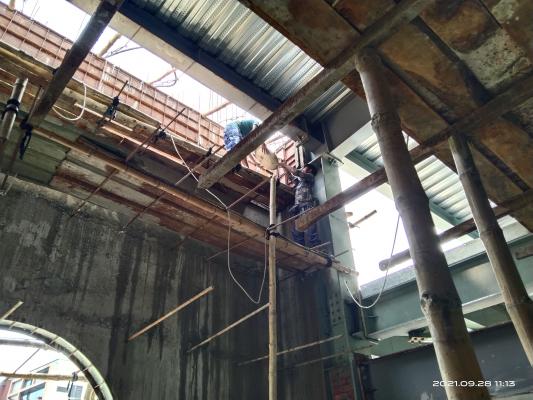

Stair wall casting on 28-09-21

Fire tank base clay remove on 28-09-21

Fire pipe fitting at basement floor on 29-09-21

Preperation of subgrade bed of road on 29-09-21

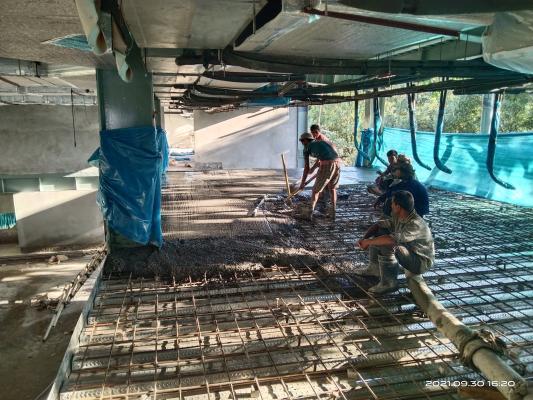

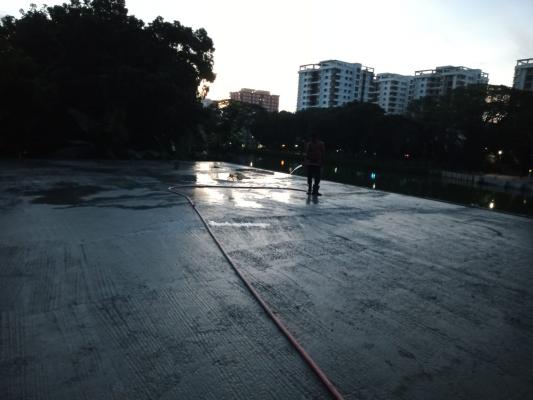

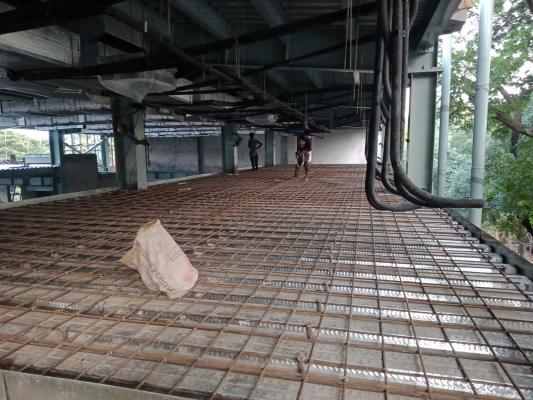

1F Mezzanine Slab Concreting on 30-09-21
Substation Roof-Slab Concreting on 30-09-21
Septic tank wall shuttering on 1-10-21

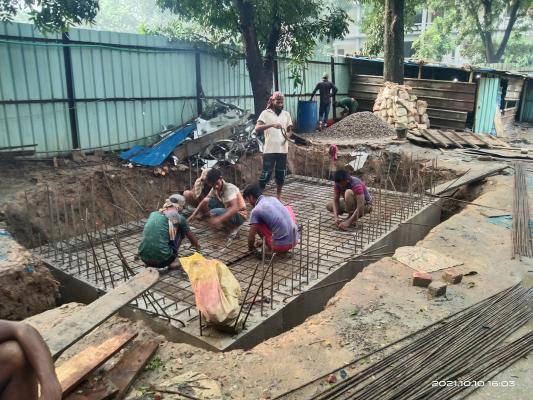

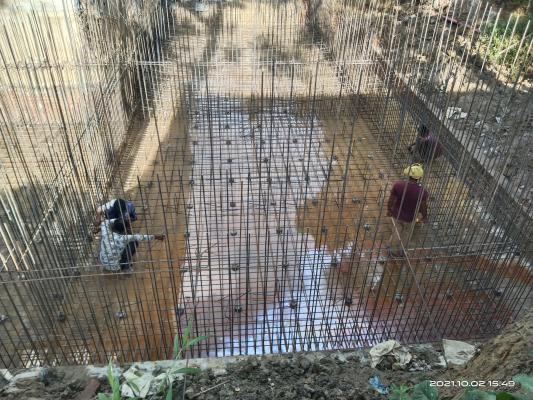

Fire tank base and wall rod binding on 1-10-21

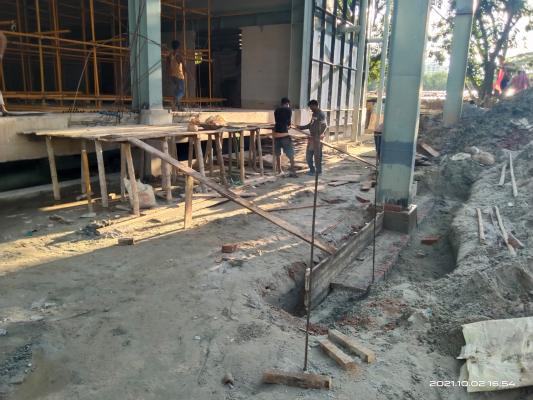

GF north entry stair work on 2-10-21

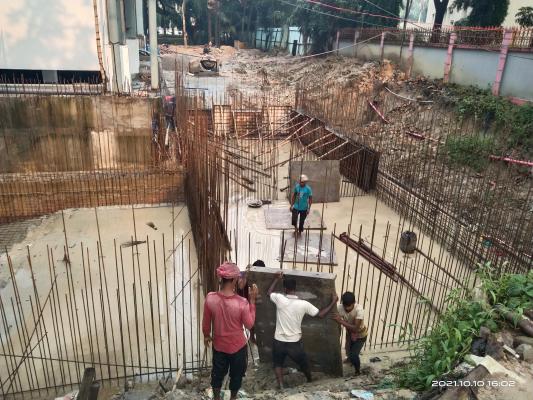

Fire tank base and wall rod binding on 2-10-21
Rain water down pipe fittings on 3-10-21

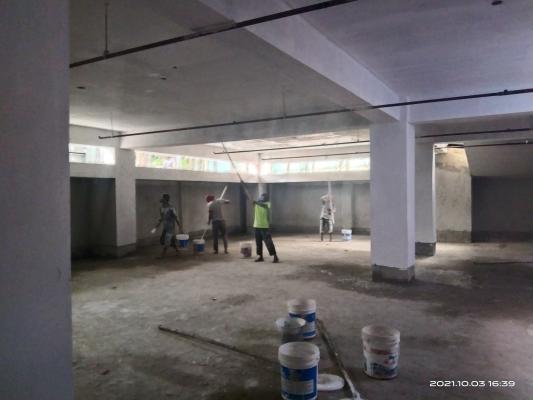

Basement wall and ceiling paint on 3-10-21

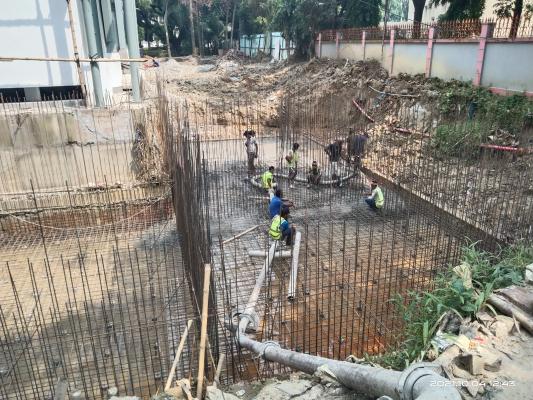

Fire tank base casting on 4-10-21
Site meeting with all vendor and client on 4-10-21

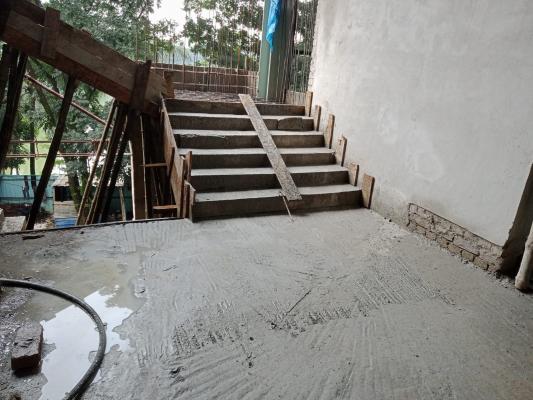

Stair casting on 5-10-21

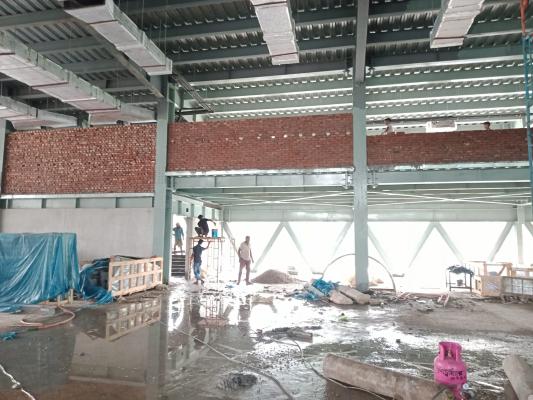

FFM Brick work on 5-10-21
Fire tank wall shuttering on 6-10-21

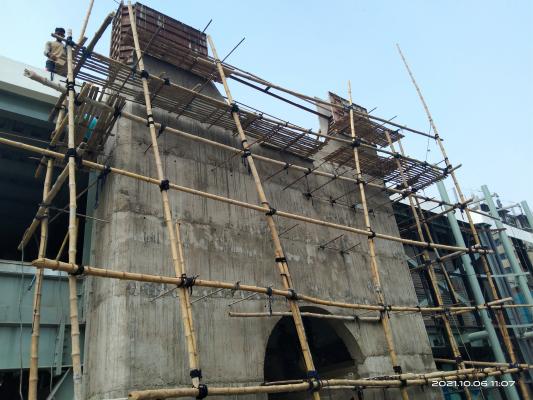

Stair wall casting of stair no. 02 on 6-10-21
FFM wall plaster on 7-10-21
Septic partition wall on 7-10-21
Fire Tank clay protection wall making on 8-10-21
FFM brick wall plaster on 8-10-21

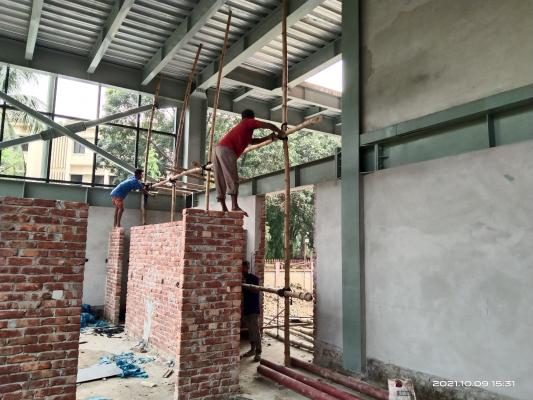

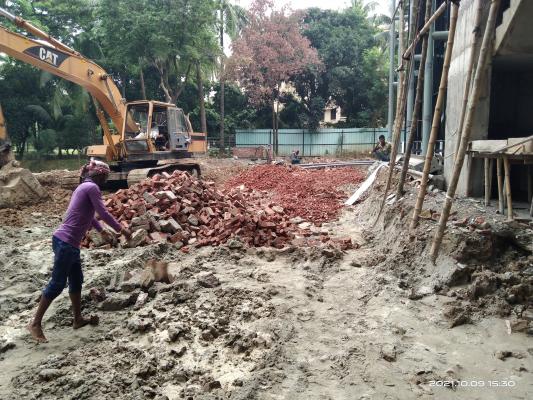

Scaffolding work for brick wall on 9-10-21
Road work on 9-10-21
Septic tank top slab rod binding on 10-10-21
Fire tank wall shuttering and tasting on 10-10-21

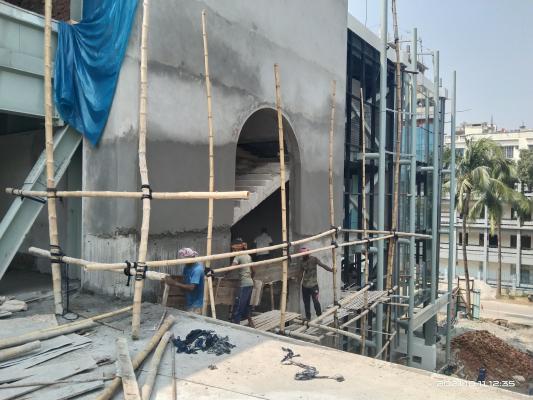

Stair no.2 Outside plaster on 11-10-21

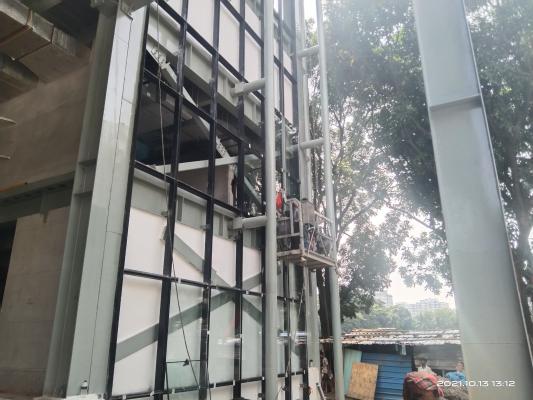

ACP angle frame setting on 11-10-21

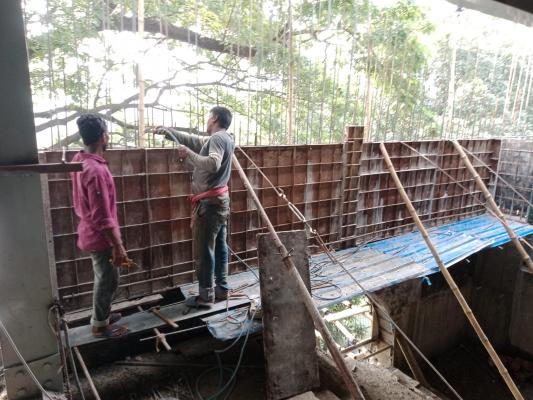

Stair RCC wall shuttering and casting on 12-10-21

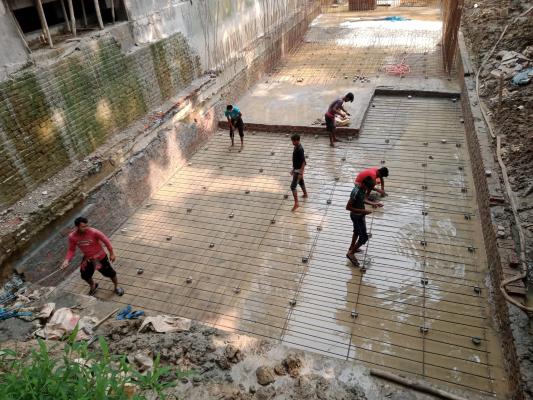

Fire tank base rod binding on 12-10-21

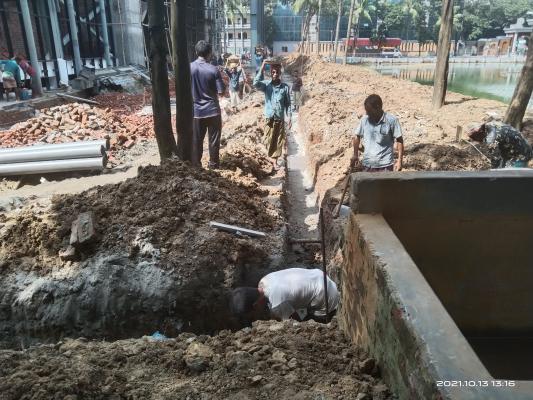

Outside drain work with pit on 13-10-21
Glass fitting on 13-10-21
South canopy GB casting on 14-10-21
Stair-02 outside plaster complete on 14-10-21

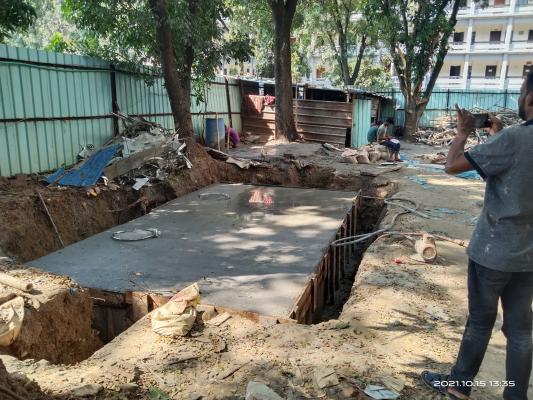

Septic tank top slab casting on 15-10-21
Under ground uPVC pipe line work on 15-10-21
Generator room shutter remove on 16-10-21
ACP angle fitting on 16-10-21

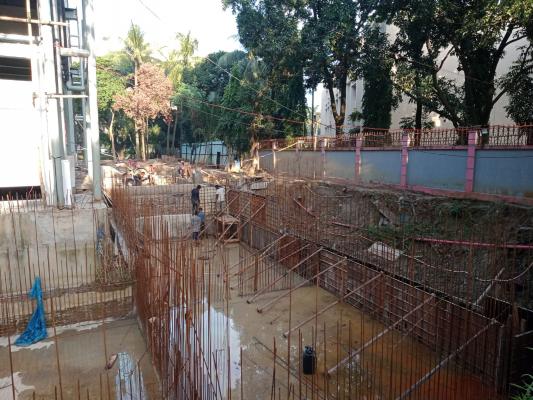

Fire Tank wall shuttering on 17-10-21

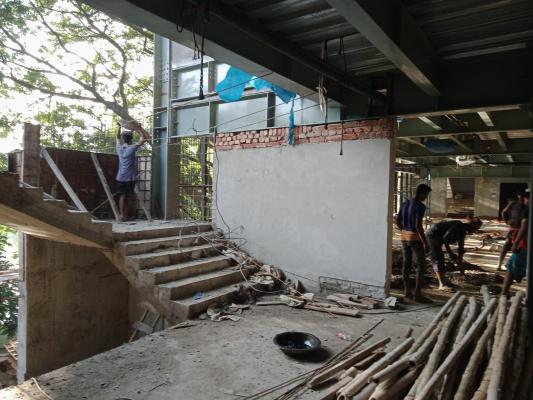

Stair RCC wall shuttering on 17-10-21

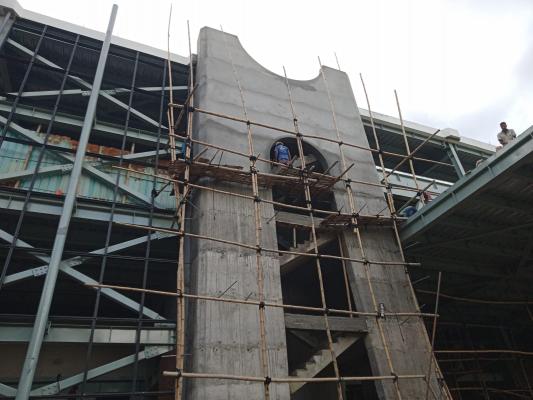

Outside stair plaster on 18-10-21

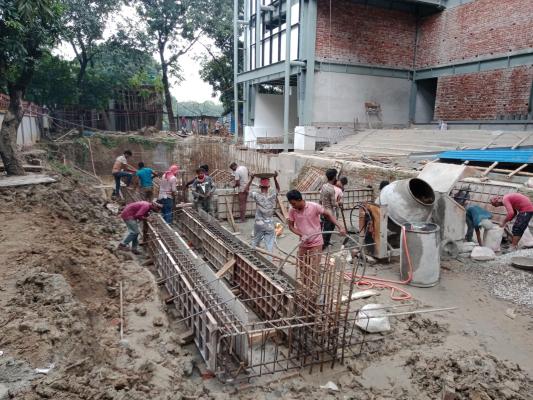

Canopy short column and GB casting on 18-10-21
Fire Tank wall casting on 19-10-21

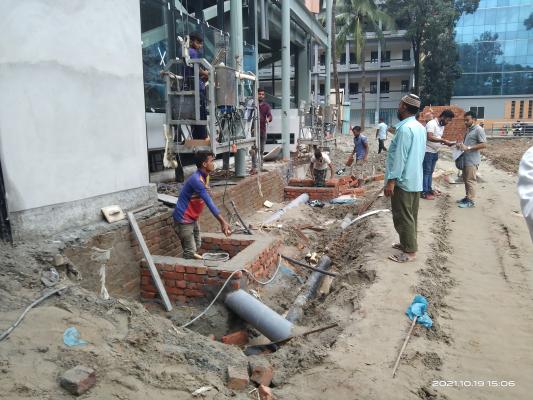

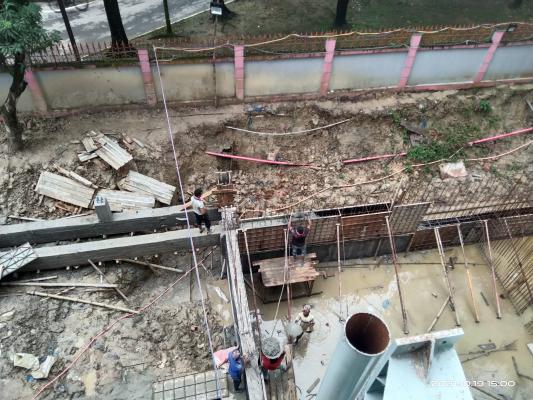

Inspection pit work on 19-10-21

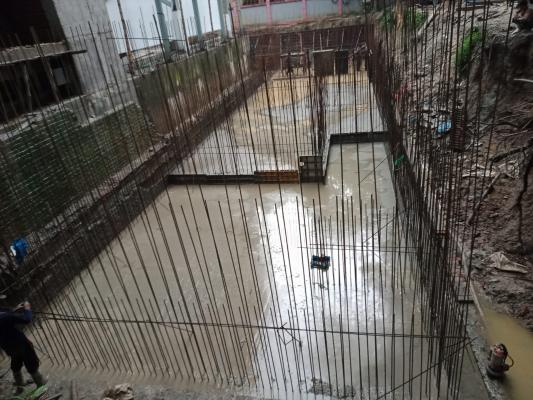

Fire Tank base casting on 20-10-21
Generator Room shutter remove on 20-10-21

ACP fitting on 21-10-21

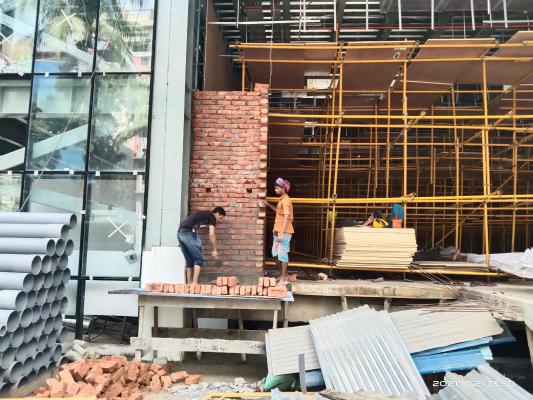

North side front brick work on 21-10-21

South East corner glass fitting on 24-10-21

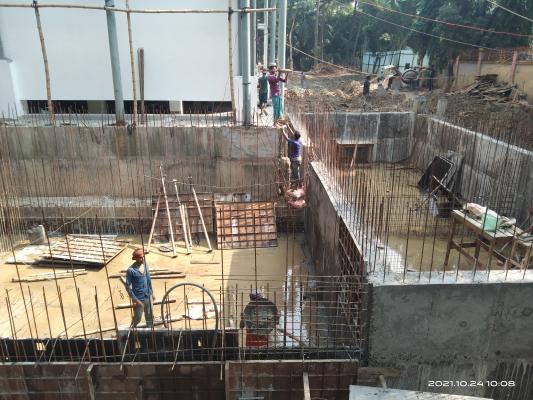

Fire tank wall casting on 24-10-21

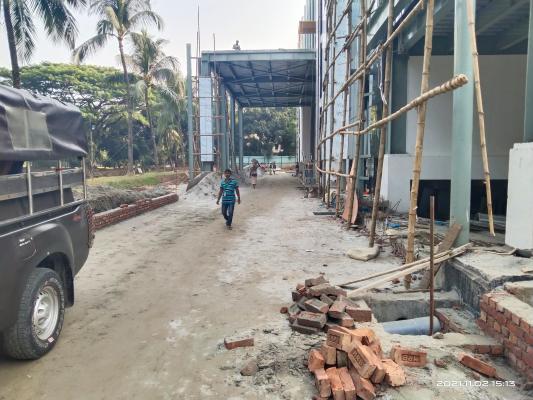

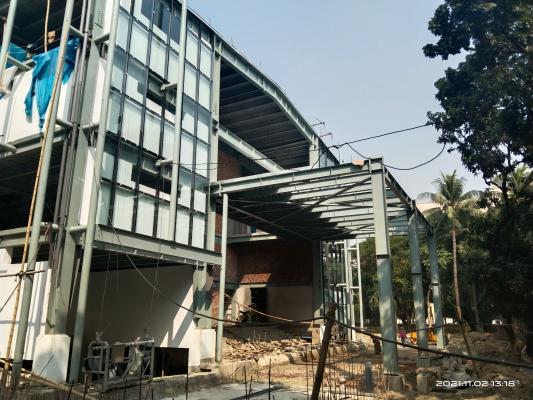

South steel canopy on 31-10-21
Road sub-base work on 31-10-21

RMC Truck for Fire Tank and Porch Slab C on 16-11-21
Porch Slab Concreting on 16-11-21

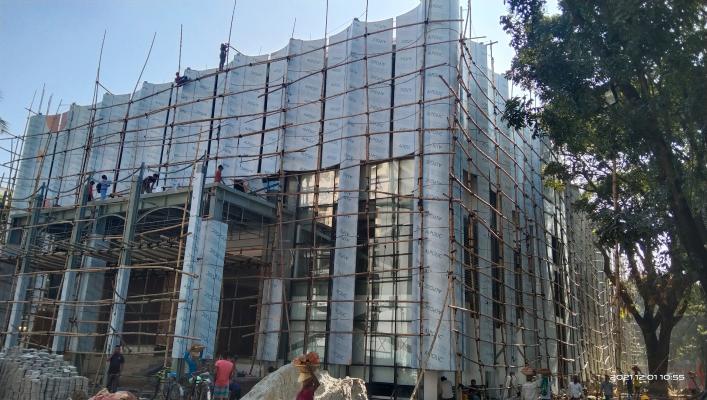

North view of conference center on 30-11-21

Road Construction on 30-11-21
North-East View on 12-12-21
Ground Floor Interior Works on 12-12-21

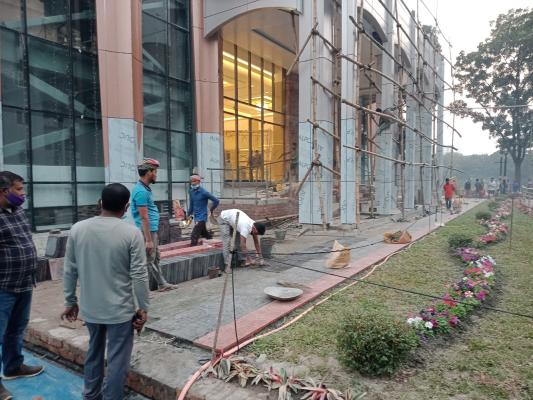

Generator room on 13-12-21
East entry on 13-12-21

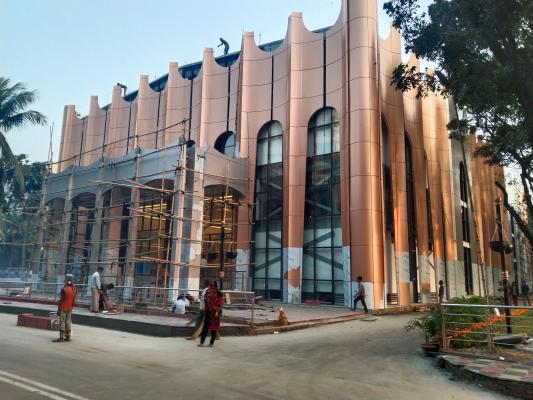

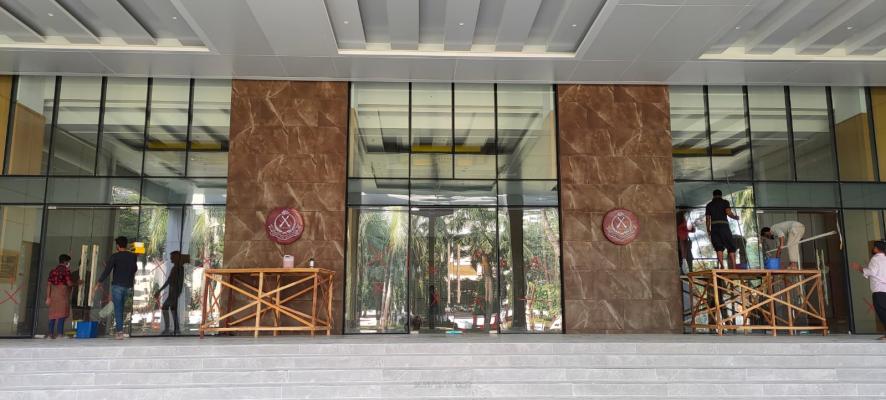

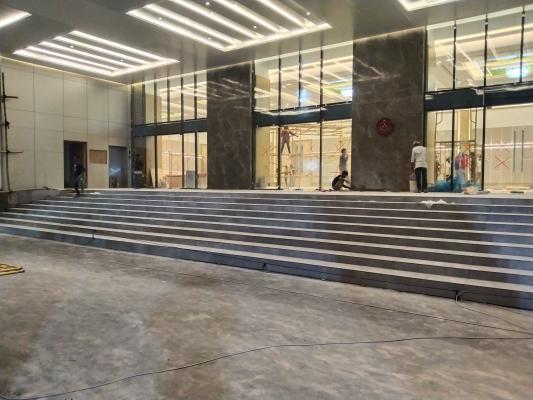

Front view on 14-12-21
East entry on 14-12-21
Carpeting road on 15-12-21
Interior work on 15-12-21

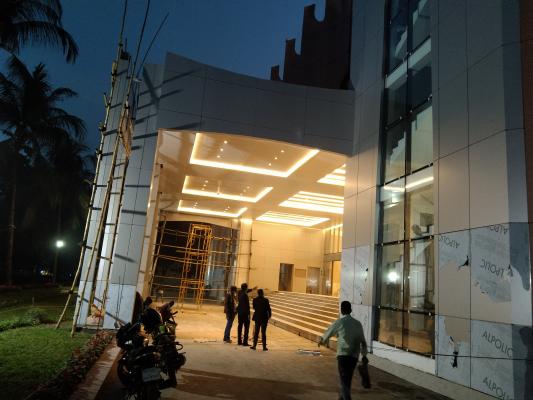

Interior works on 16-12-21
False Ceiling on 16-12-21
Stage work on 17-12-21
Main Entrance on 17-12-21
Inaugurated by Hon'ble Pri Minister on 19-12-21
East-North View on 19-12-21

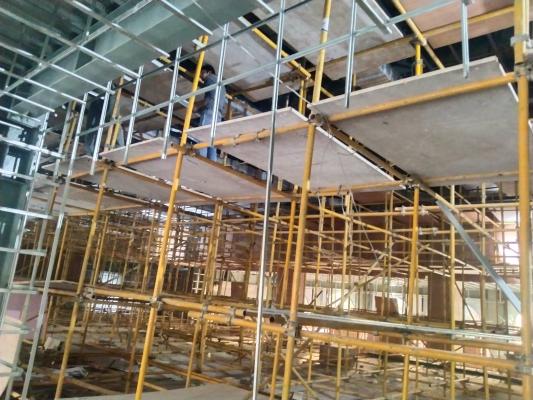

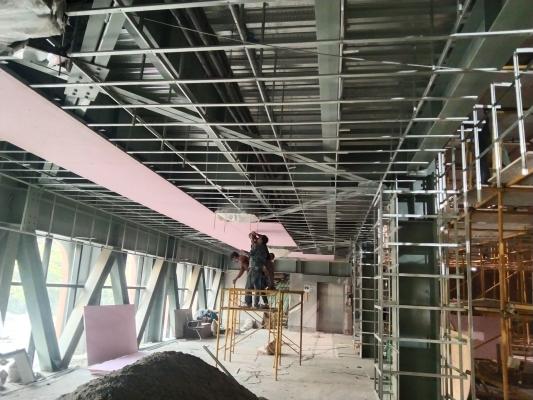

First floor ceiling work on 5-01-22
Interior ceiling on 5-01-22
Work stopped 19-26 Dec 2021 due to Inauguration Ceremony
Tiles work on 31-01-22
Interior work on 31-01-22
