Progress as on: 21-January-2021 |
WBS | Work Description |
Total Quantity | Upto 31-12-20 | This Month | Total Done |
Schedule Start | Schedule Finish | Actual Finish |
03.02 |
Mobilization-Material for Prelimina |
|
0% |
5% |
5% |
08-12-20 |
05-02-21 |
13-01-21 |
03.03.01 |
Soling n Plaster for PVC Water Tank |
|
60% |
20% |
80% |
15-01-21 |
22-01-21 |
20-01-21 |
03.06.02 |
Mobilization-Mechanics Shed-Frame W |
|
0% |
100% |
100% |
15-01-21 |
22-01-21 |
20-01-21 |
03.07 |
Mobilization-Grass Cutting-Roa |
|
30% |
60% |
90% |
28-12-20 |
26-01-21 |
07-01-21 |
03.08.01 |
Mobilization-Guest House-Layout |
130sqm |
30% |
70% |
100% |
06-01-21 |
06-01-21 |
06-01-21 |
03.08.02 |
Mobilization-Guest House-Excavation |
163cum |
0% |
100% |
100% |
07-01-21 |
10-01-21 |
12-01-21 |
03.08.03 |
Mobilization-Guest House-Footi |
16nos |
0% |
100% |
100% |
08-01-21 |
12-01-21 |
15-01-21 |
03.08.04 |
Mobilization-Guest House-Pades |
16nos |
0% |
100% |
100% |
10-01-21 |
13-01-21 |
19-01-21 |
03.08.05 |
Mobilization-Guest House-Grade Beam |
107m |
0% |
65% |
65% |
12-01-21 |
17-01-21 |
21-01-21 |
Site Photographs |
| |
Guest House-Preparation for Layout on 5-01-21 | Guest House-Preparation for Layouton 5-01-21 |
|
|
| |
Guest House-Preparation for Layout on 6-01-21 | Guest House-Preparation for Layouton 6-01-21 |
|
|
| |

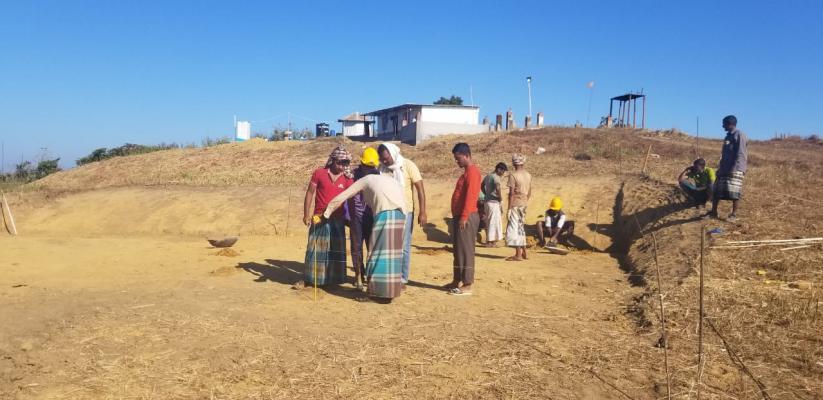

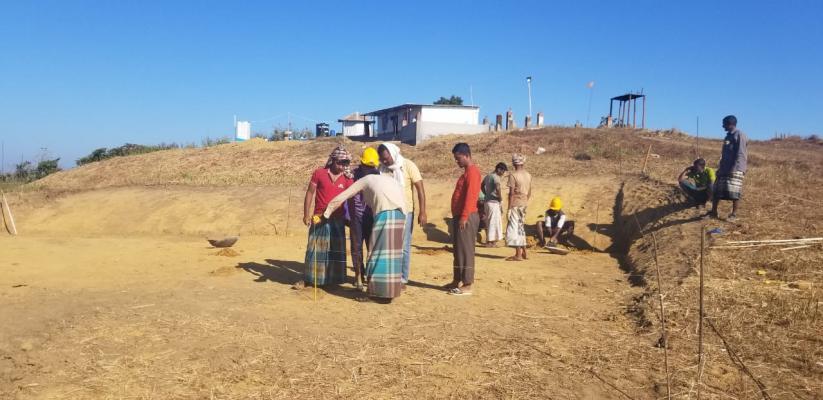

Guest House-Preparation for Layout on 7-01-21 | Guest House-Preparation for Layouton 7-01-21 |
|
|
| |

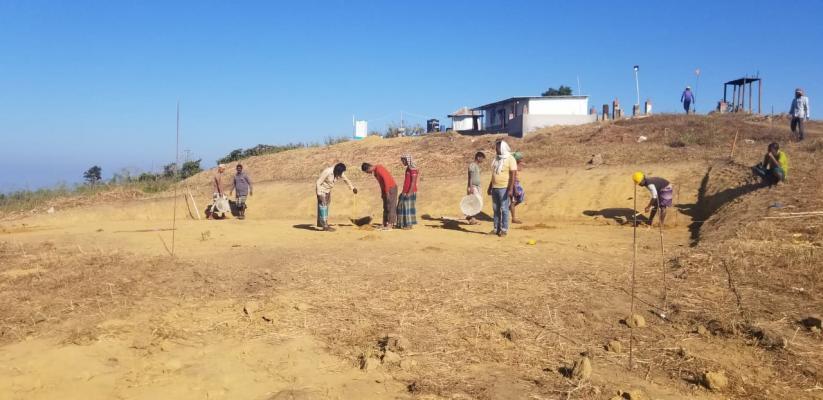

on 8-01-21 | on 8-01-21 |
|
|
| |

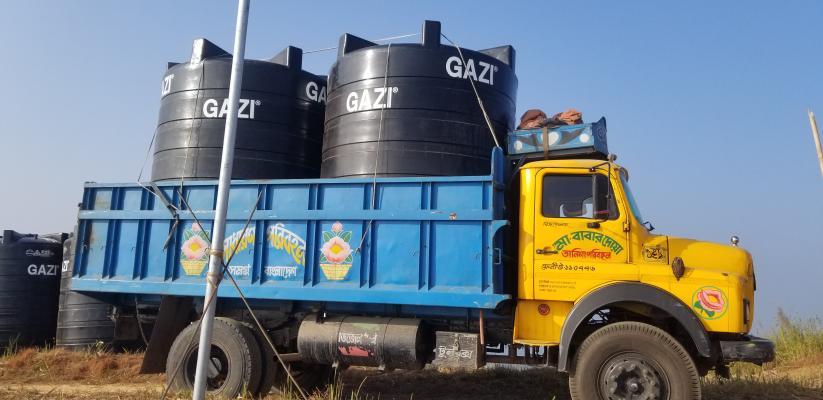

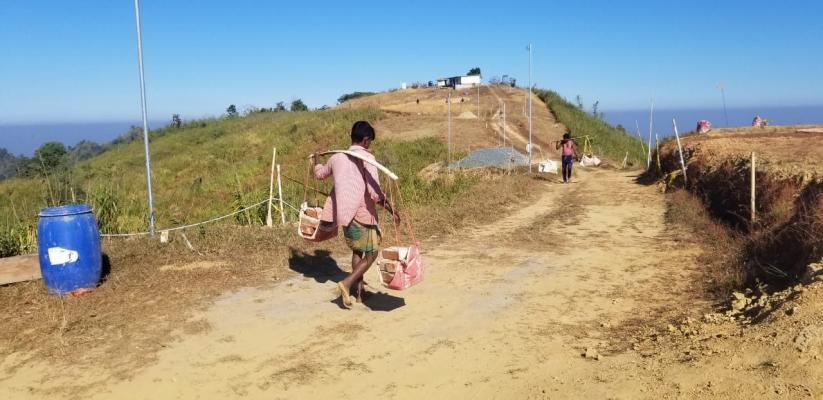

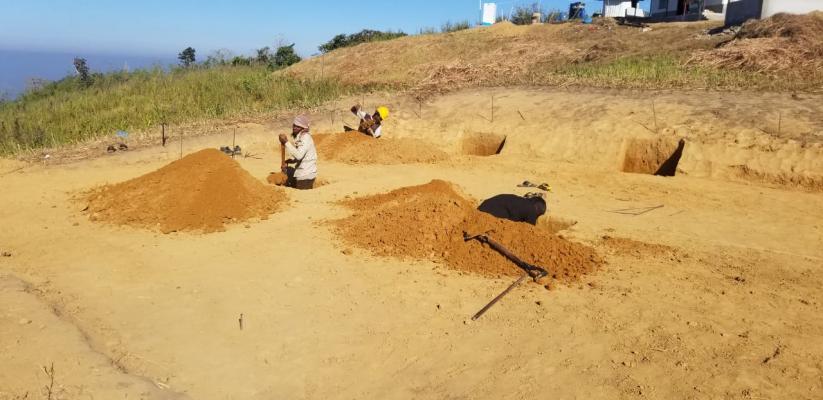

Guest House-Excavation on 9-01-21 | Brick Carryingon 9-01-21 |
|
|
| |

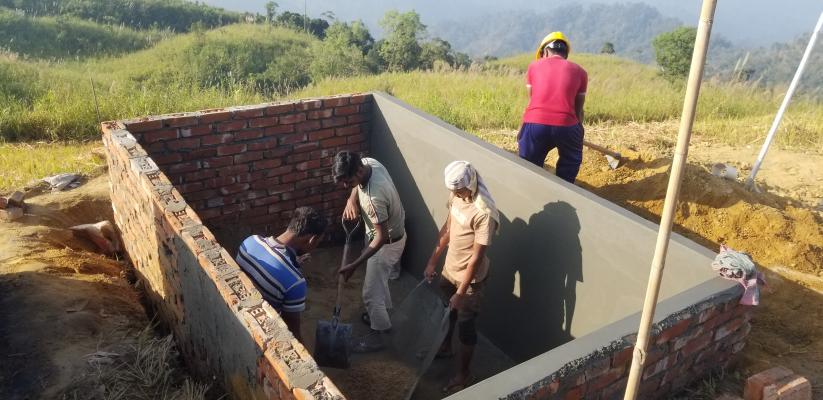

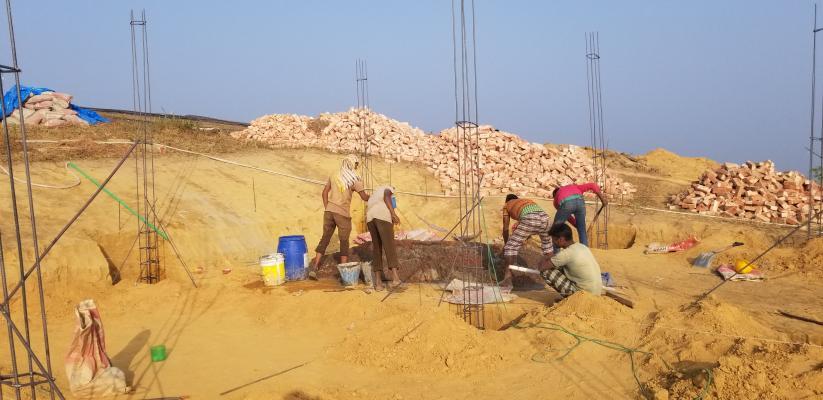

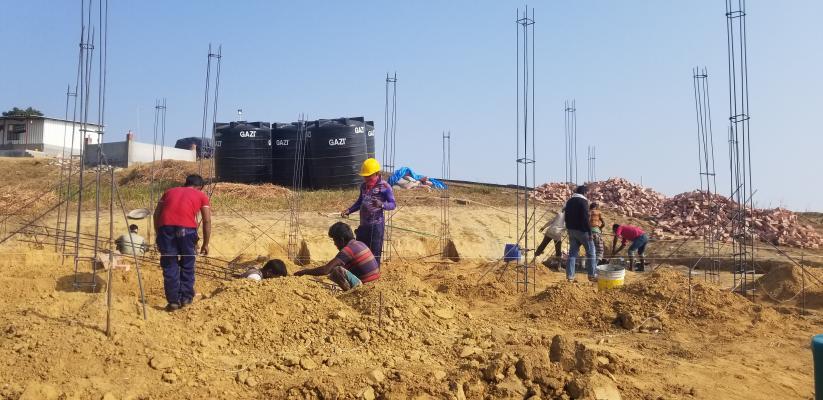

MS rod cutting & binding on 12-01-21 | Plaster work for labour Shedon 12-01-21 |
|
|
| |

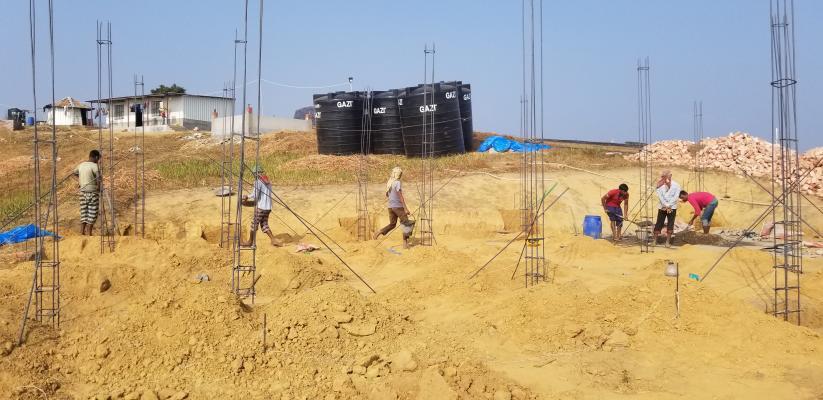

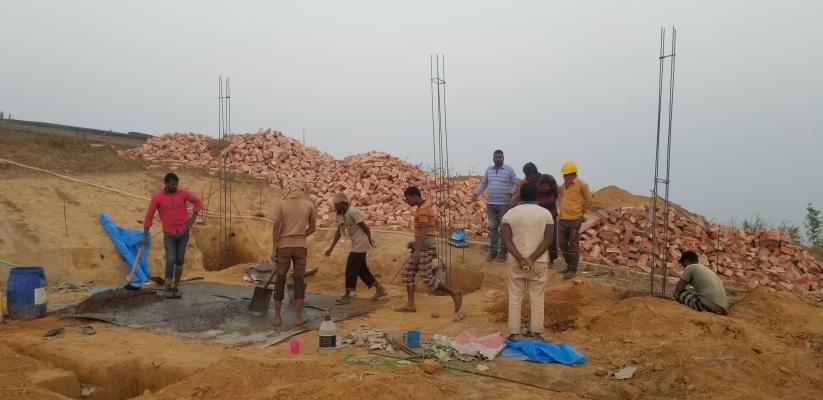

Footing & column casting work on going on 13-01-21 | Reached water tank at projecton 13-01-21 |
|
|
| |

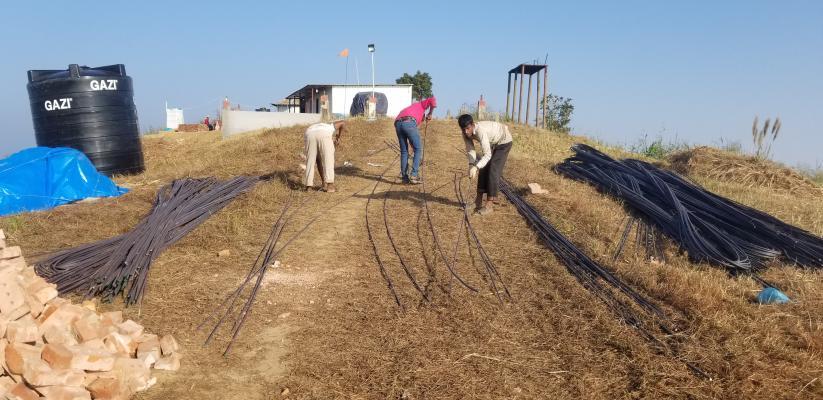

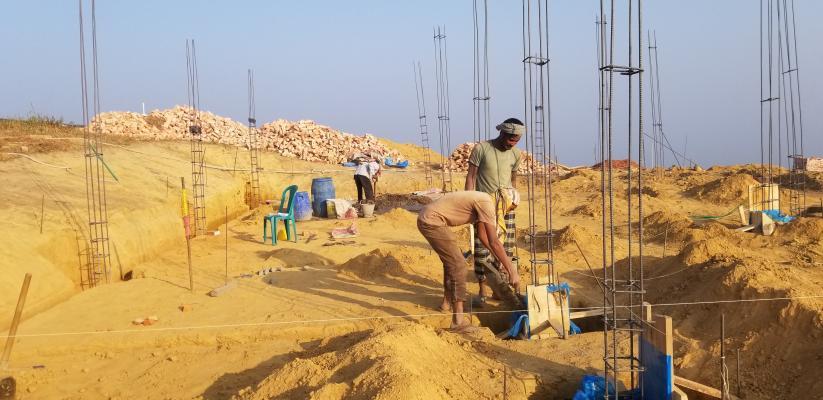

Column standing work on going at G.House on 14-01-21 | Footing & column casting work on going aon 14-01-21 |
|
|
| |
Column standing work on going at G.House on 15-01-21 | Footing casting work on going at G.Houseon 15-01-21 |
|
|
| |

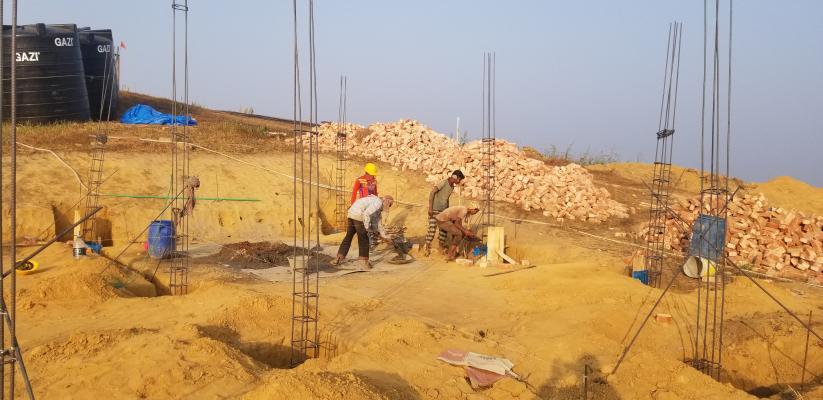

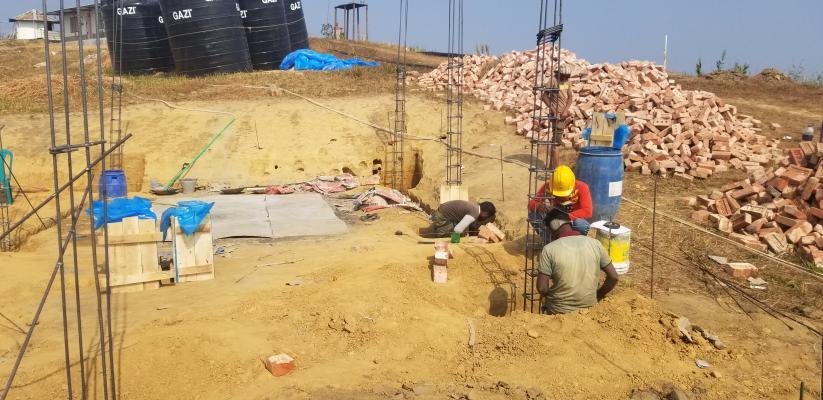

Shuttering fitting work for short column on 16-01-21 | Short column casting work for guest houson 16-01-21 |
|
|
| |

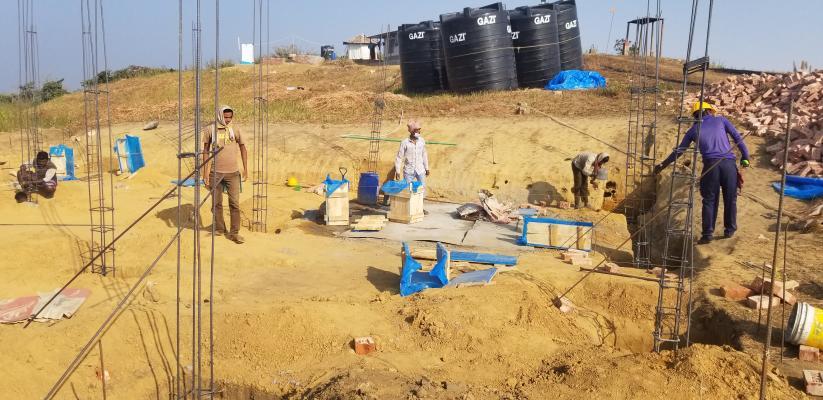

Shuttering fitting work for short column on 17-01-21 | Short column casting work for guest houson 17-01-21 |
|
|
| |

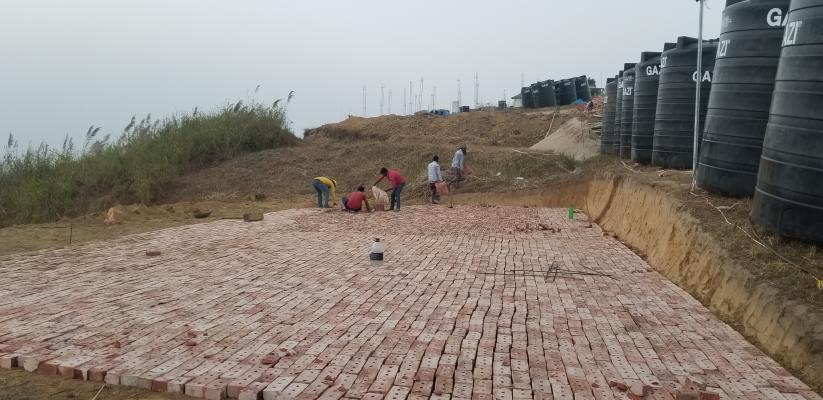

MS rod cutting & binding work for grade on 19-01-21 | Brick solling work for water tank placeion 19-01-21 |
|
|
| |

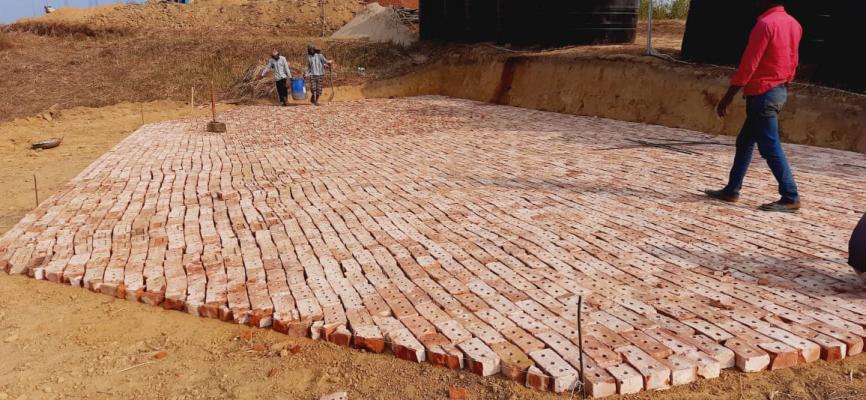

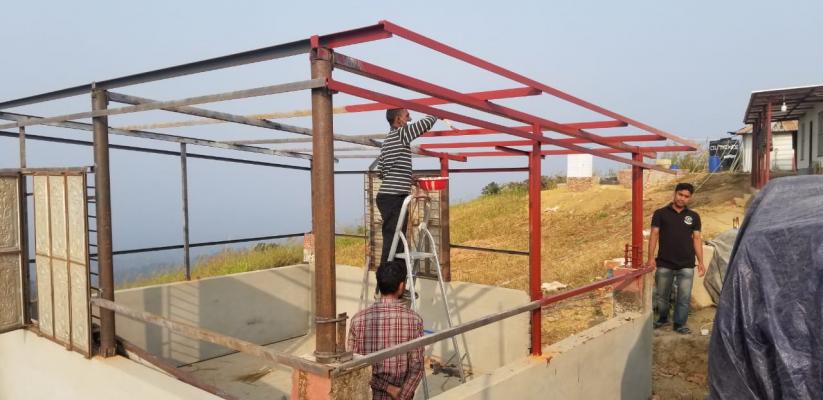

Soling for PVC Water Tank on 20-01-21 | Mechanics Shed Frame Workon 20-01-21 |
|
|
| |

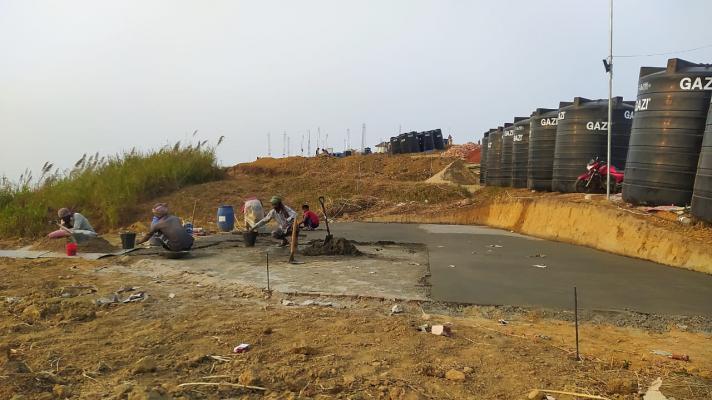

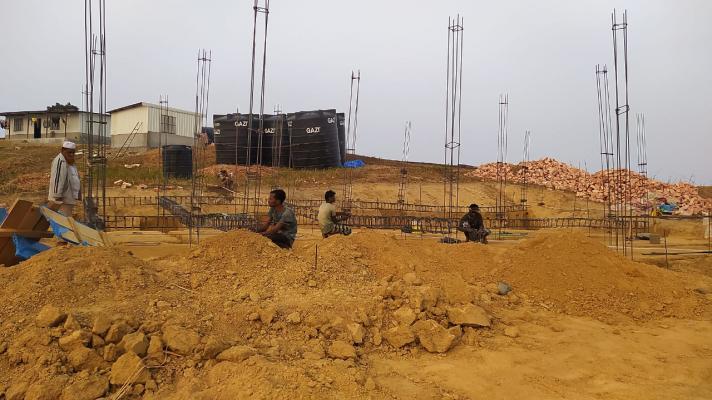

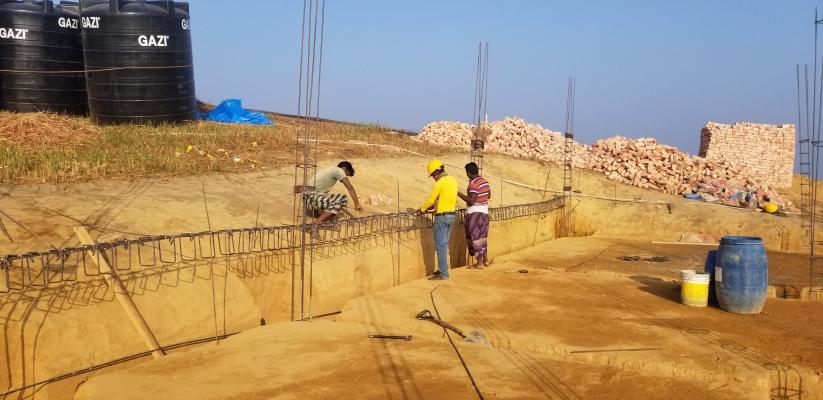

Rod binding work for grade beam at guest on 21-01-21 | Solling joint fillup & plaster work at won 21-01-21 |
|
|
