TOTAL PROGRES REPORT |
From 22-December-2022 to 6-March-2023 | ||||
Project Code: | 61 | Name: | Cityscape Tower Level-15 Bar | |
Client: | Cityscape | Contractor: | Cityscape International Ltd. |
Total Duration: | 74 | days | Total Working Days: | 15 | Total Manpower: | 129 | |||
Planning Progress = 100% | Acual Progress = 54.6% | SPI: 0.55 | Behind Schedule | ||||||
WBS | Work Description | ||||||||
Total Quantity | Total Done | Schedule Start | Schedule Finish | Actual Start | Actual Finish | Lead-Lag(day) | Not Yet | ||
01 | Glass Work | 01 | 90% | 22-12-22 | 21-01-23 | 22-12-22 | 06-03-23 | -44 | Completed |
02 | Carpentry Mock-up | 1sum | 100% | 22-12-22 | 23-12-22 | 22-12-22 | 26-12-22 | -3 | |
03 | Bar Counter | 1sum | 50% | 22-12-22 | 06-01-23 | 22-12-22 | 26-01-23 | -20 | Completed |
04 | Washroom Brickwork | 1sum | 90% | 22-12-22 | 27-12-22 | 22-12-22 | 03-01-23 | -7 | Completed |
05 | Floor Finsh-NCF | 1sum | 100% | 26-12-22 | 31-12-22 | 03-01-23 | 12-02-23 | -43 | |
06 | Wall Paneling | 1sum | 5% | 08-02-23 | 09-03-23 | 08-02-23 | 08-02-23 | 29 |
Site Photographs | |

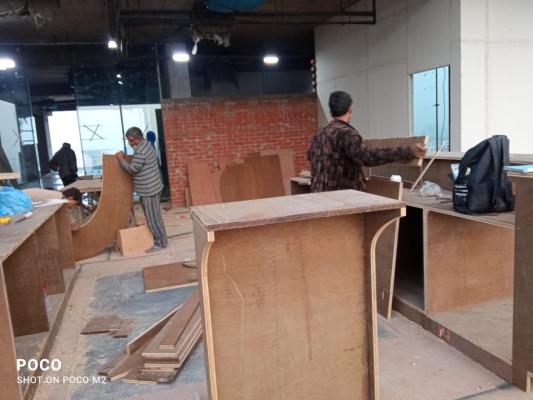

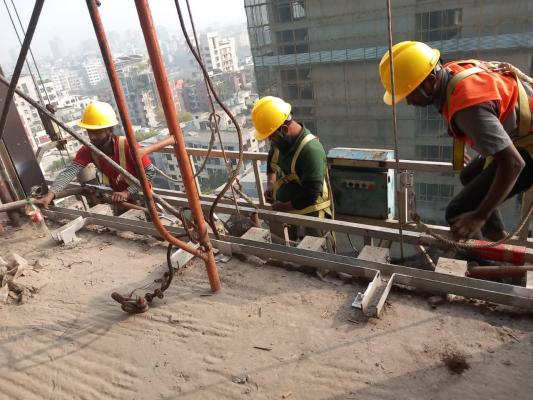

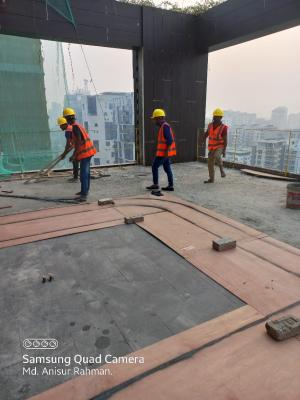

Carpentry Mock-up on 22-12-22 | |

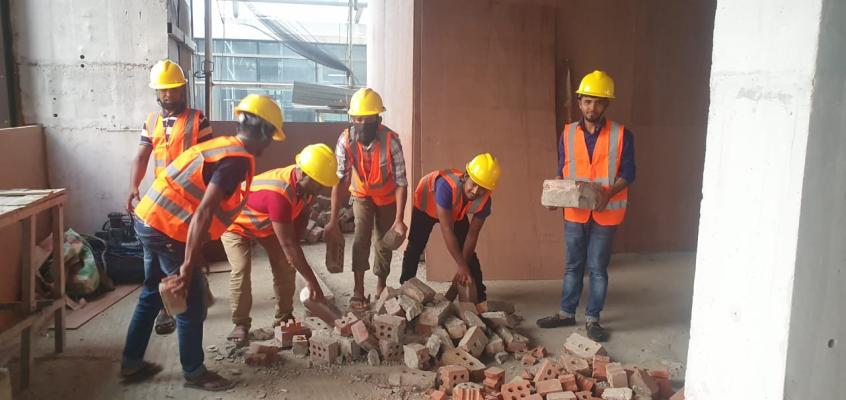

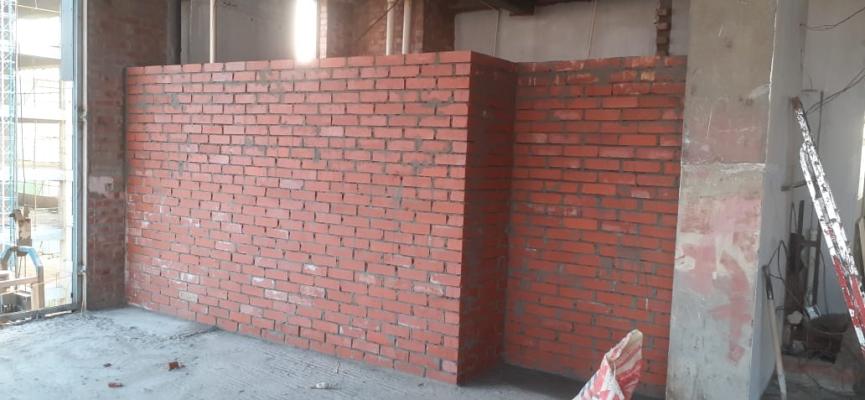

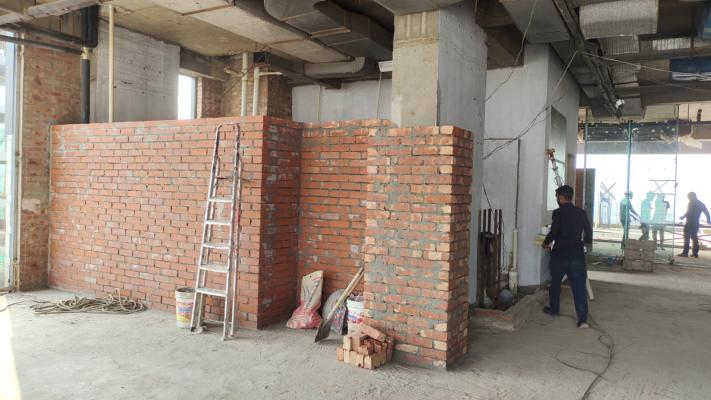

Brick work demolition on 22-12-22 | |
on 23-12-22 | |
on 23-12-22 | |

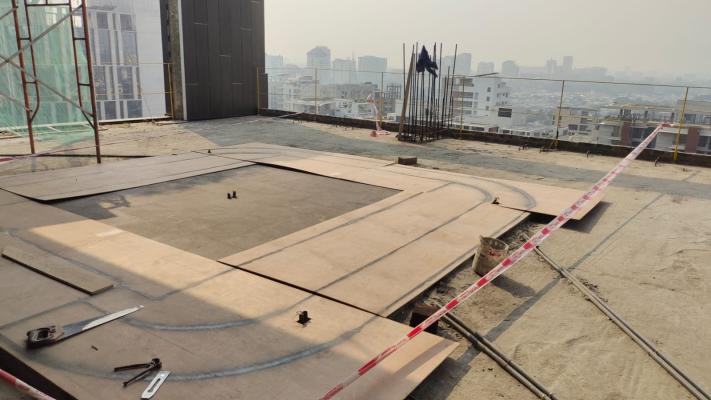

on 26-12-22 | |
on 26-12-22 | |
Glass Work on 31-12-22 | |

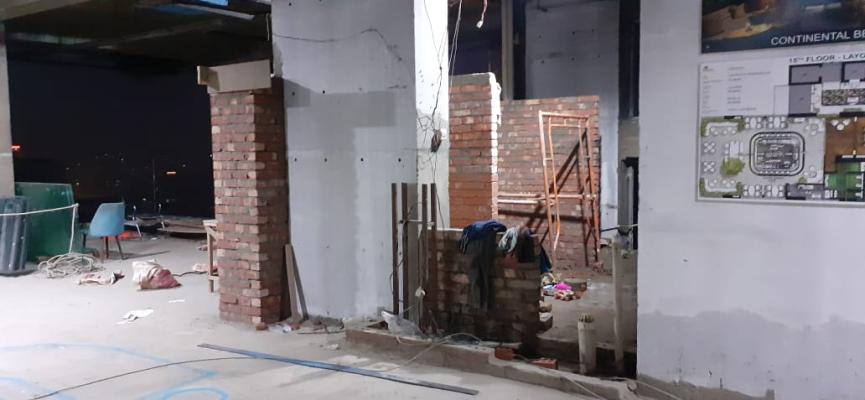

Wash Room Brick work on 31-12-22 | |

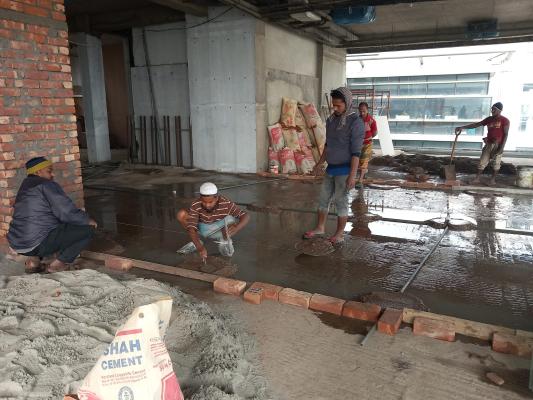

Interior works on 3-01-23 | |
Floor Finishing-NCF on 3-01-23 | |

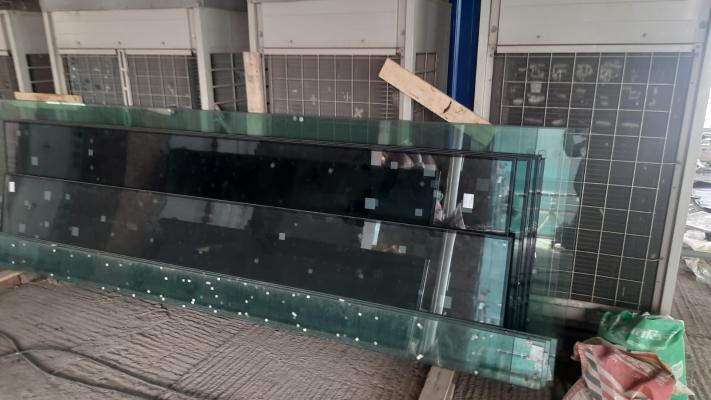

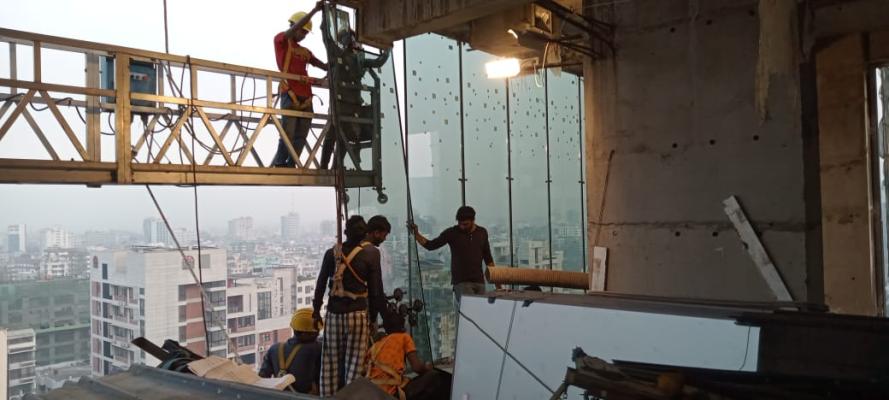

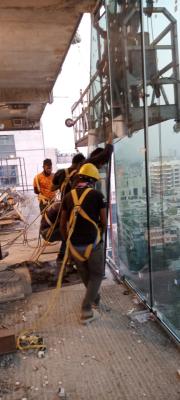

Fixing Glass on 9-01-23 | |
Fixing Glass on 9-01-23 | |

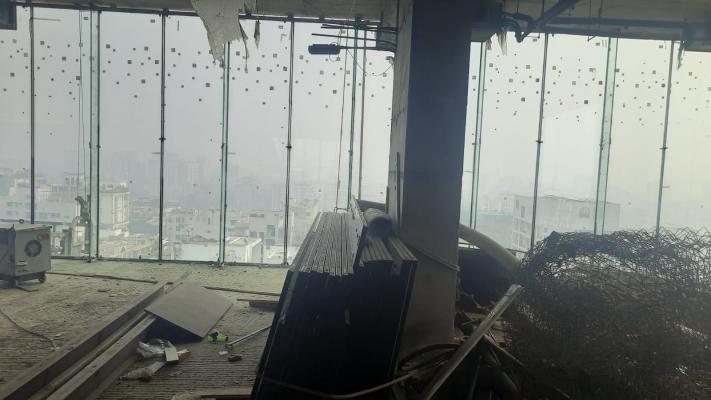

on 14-01-23 | |
on 14-01-23 | |

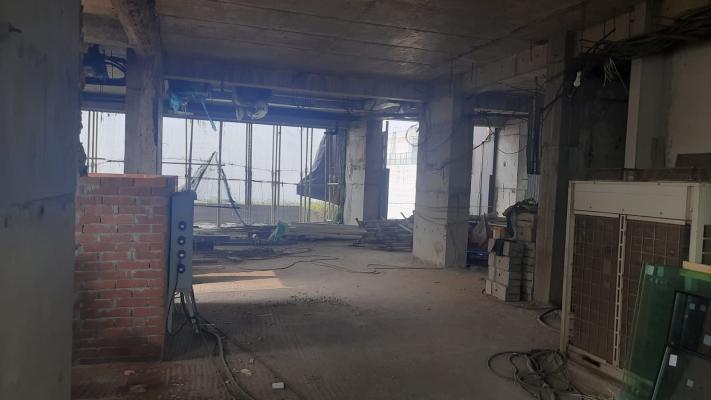

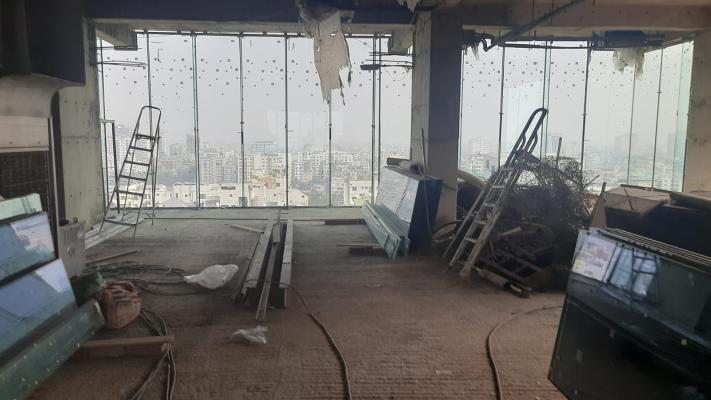

on 17-01-23 | |
on 17-01-23 | |

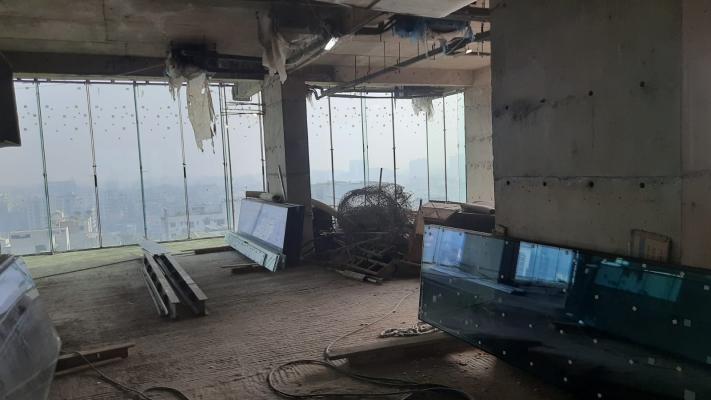

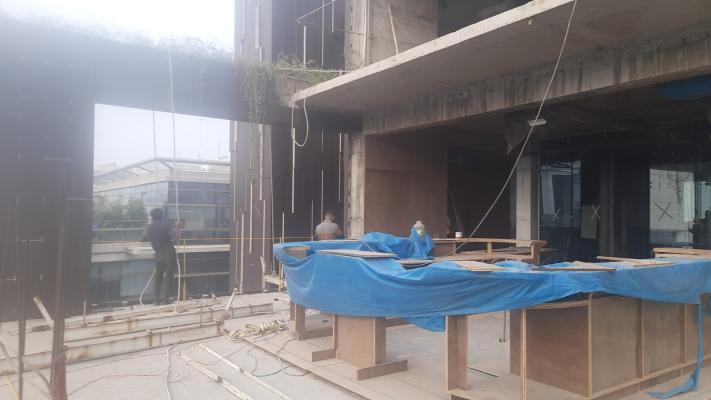

on 26-01-23 | |

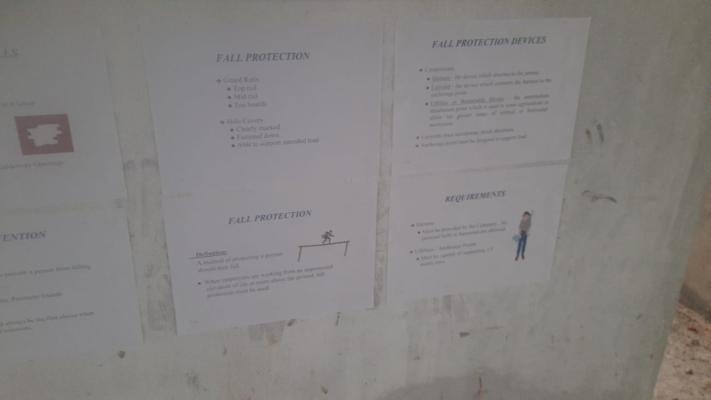

Safety Instruction on 26-01-23 | |

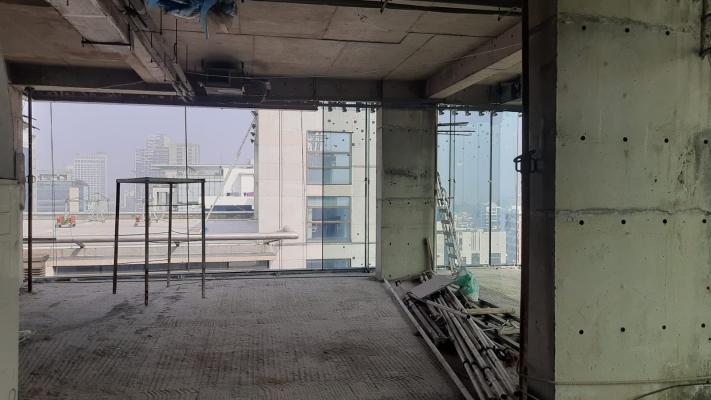

on 31-01-23 | |
on 31-01-23 | |

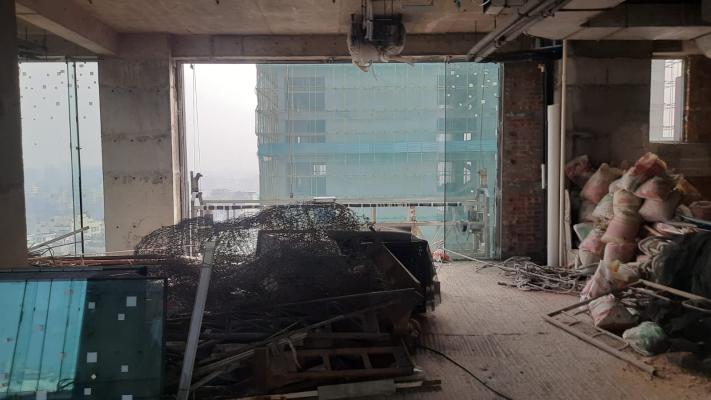

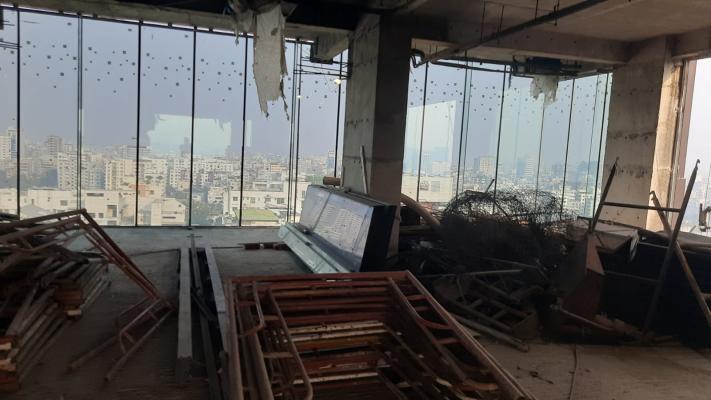

on 5-02-23 | |
on 5-02-23 | |

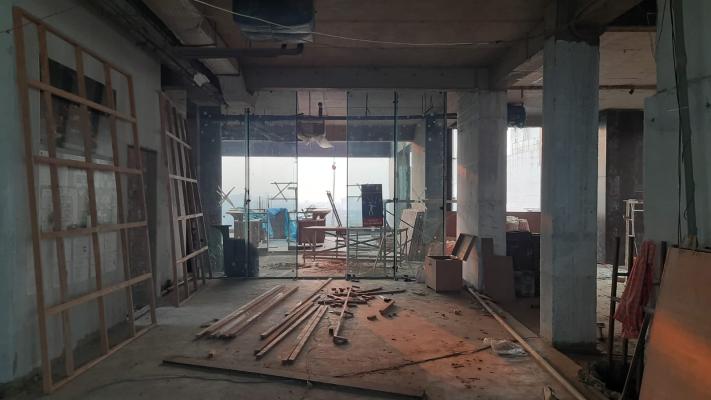

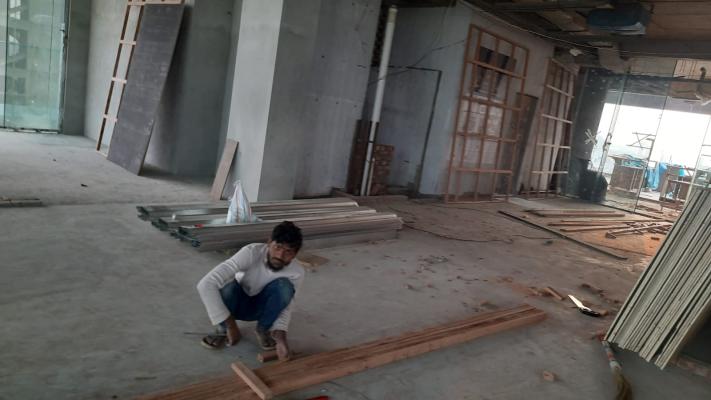

Wall Paneling on 8-02-23 | |
Wall Paneling on 8-02-23 | |

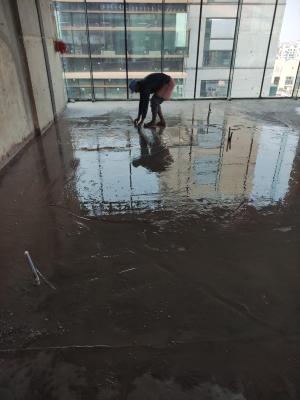

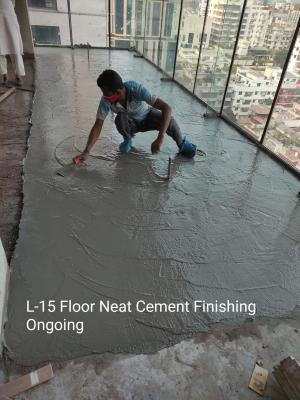

L-15-Floor Neat Cement Finishing on 12-02-23 | |
L-15-Floor Neat Cement Finishing on 12-02-23 | |
L-15-North Side Glass Framing on 27-02-23 | |
L-15-North Side Glass Framing on 27-02-23 | |
L-15-South side glass fixing on 6-03-23 | |
L-15-South side glass fixing on 6-03-23 | |
