TOTAL PROGRES REPORT

From 22-December-2022 to 18-March-2023
Project Code: 60 Name: Coffee Shop-Cityscape Tower GF
Client: Cityscape Contractor: Cityscape International Ltd.
Progress as on: 18-March-2023
Total Duration: 86 days Total Working Days: 18 Total Manpower: 229
Planning Progress = 100% Acual Progress = 100% SPI: 1 Ahead Schedule
WBS Work Description
Total Quantity Total Done Schedule Start Schedule Finish Actual Start Actual Finish Lead-Lag(day) Not Yet
01 French Door 3nos 100% 22-12-22 03-01-23 22-12-22 06-03-23 -62
02 Arch Paneling 1sum 100% 22-12-22 25-12-22 22-12-22 06-03-23 -71
03 Coffee and Breakfast Counter 1sum 100% 22-12-22 29-12-22 22-12-22 04-03-23 -65
04 Breakfast Couter Glass 1sum 100% 23-12-22 02-01-23 28-12-22 28-02-23 -57
05 Sliding Door-1 1sum 100% 23-12-22 02-01-23 31-12-22 09-01-23 -7
06 Painting-excluding Final Coat 1sum 100% 22-12-22 22-12-22 22-12-22 22-12-22 0
07 Outside Shed 1sum 100% 22-12-22 01-01-23 22-12-22 18-03-23 -76

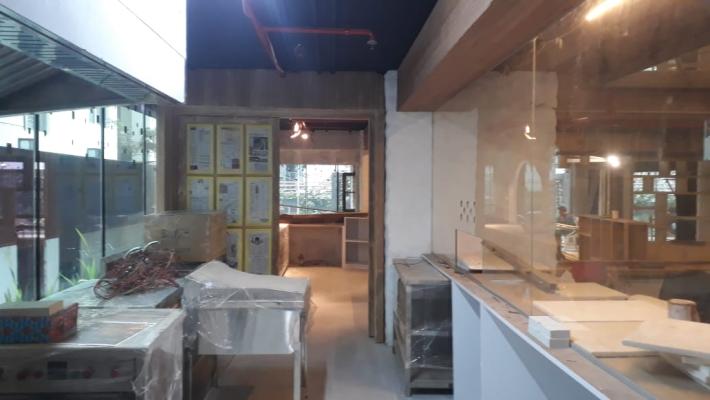

08 Sliding Door-2 and 3 2nos 100% 15-01-23 25-01-23 17-01-23 26-01-23 -1


DAILY MANPOWER








CUMMULATIVE ACTUAL WORK PROGRESS








CUMMULATIVE PLAN WORK PROGRESS








CUMMULATIVE WORK PROGRESS








SCHEDULE AHEAD-BEHIND






Site Photographs

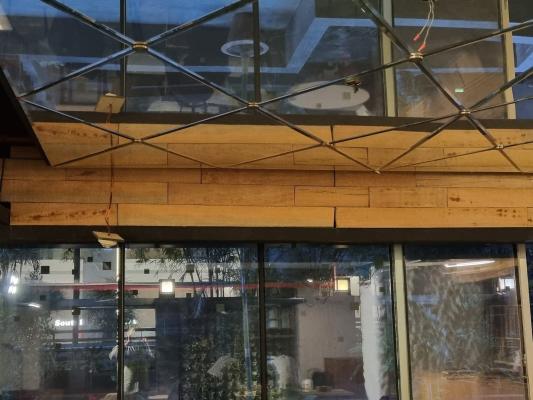

on 22-12-22
on 22-12-22

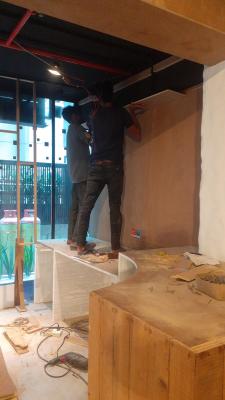

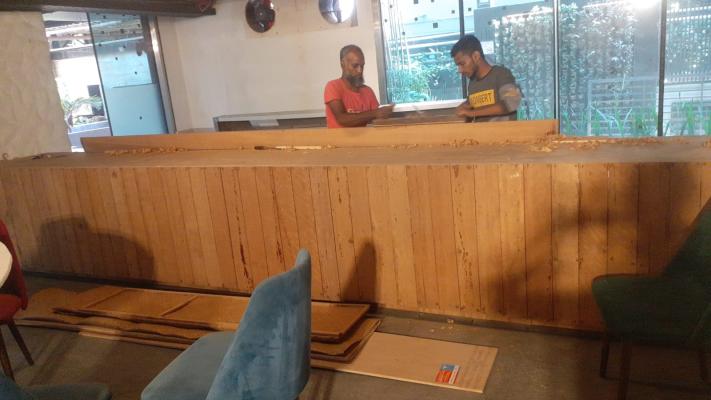

on 23-12-22
on 23-12-22

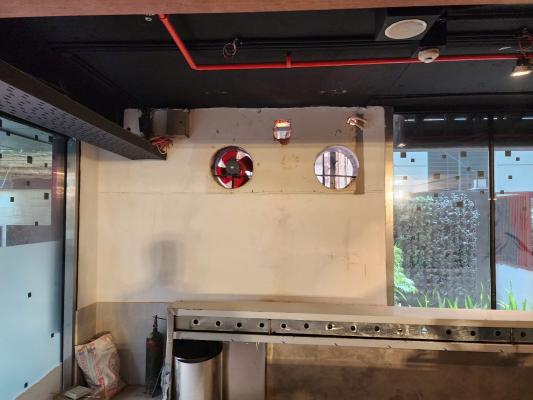

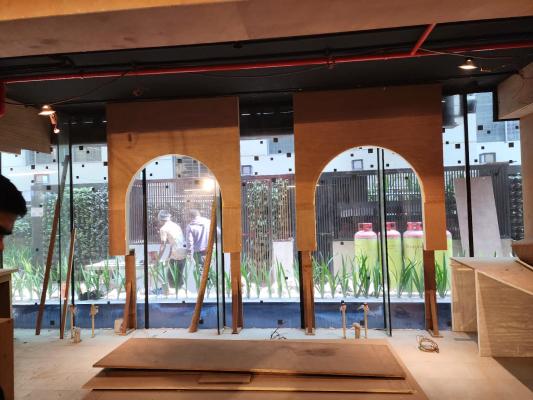

on 26-12-22
on 26-12-22

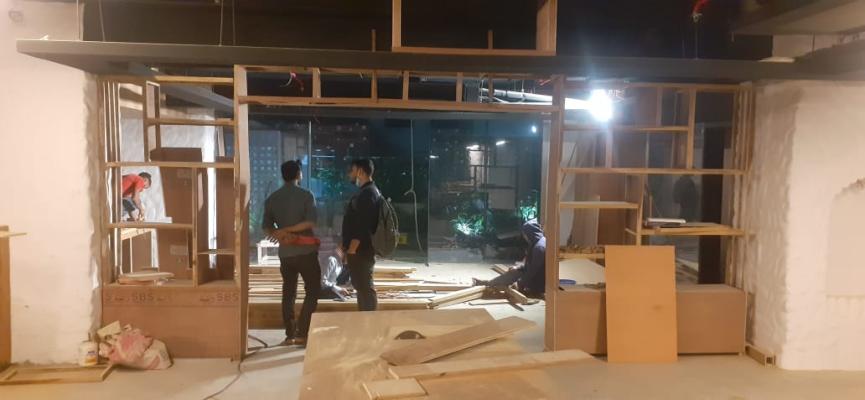

on 28-12-22
on 28-12-22

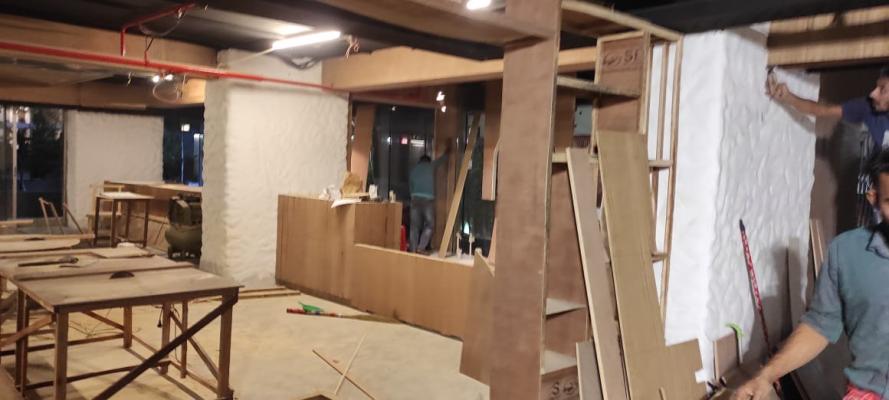

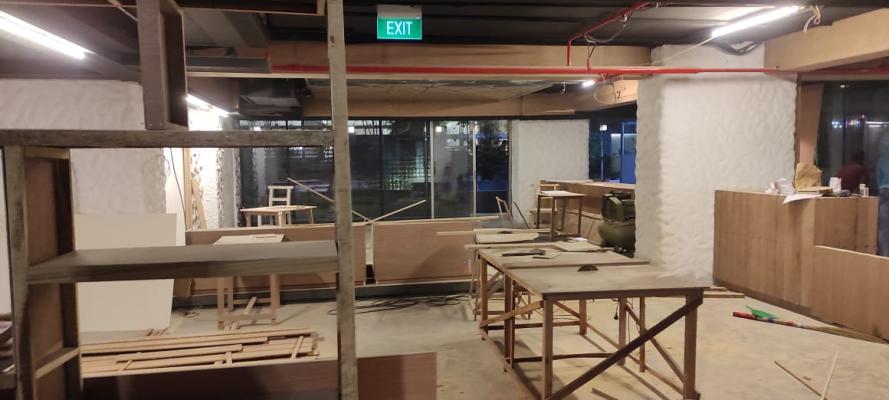

on 31-12-22
on 31-12-22

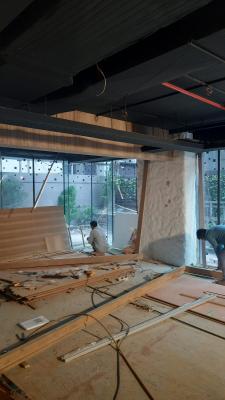

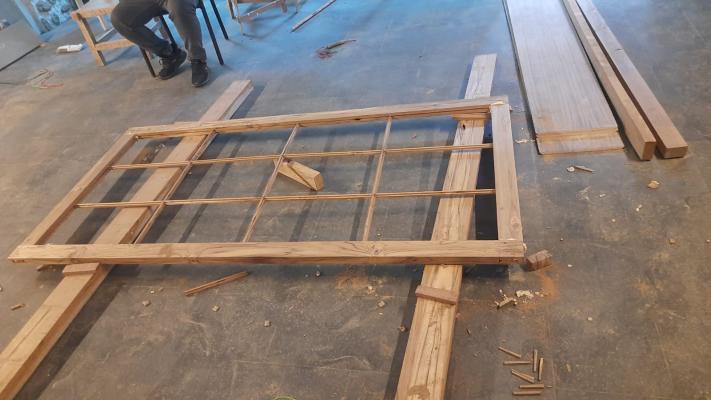

on 2-01-23
on 2-01-23

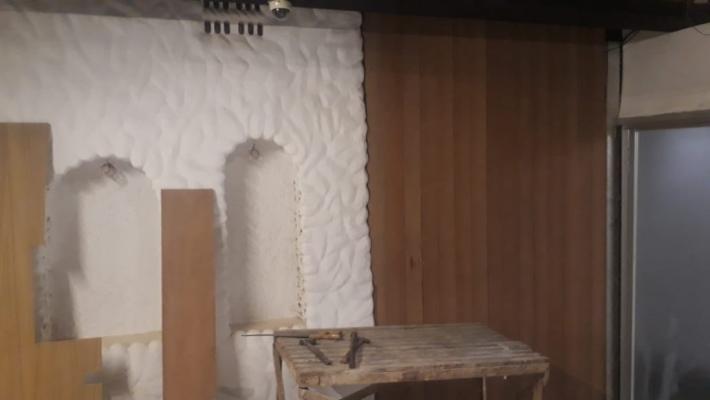

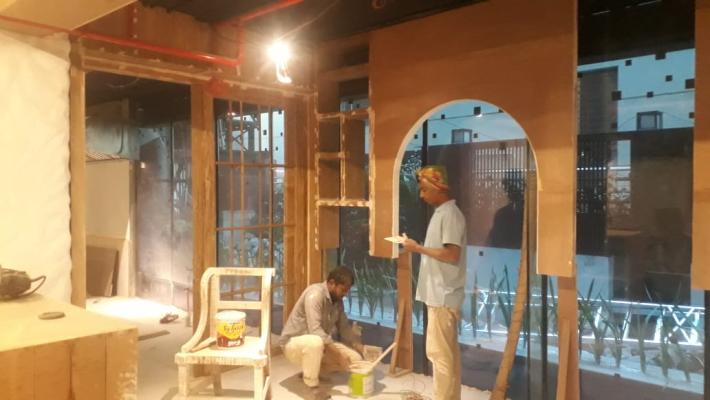

on 3-01-23
on 3-01-23

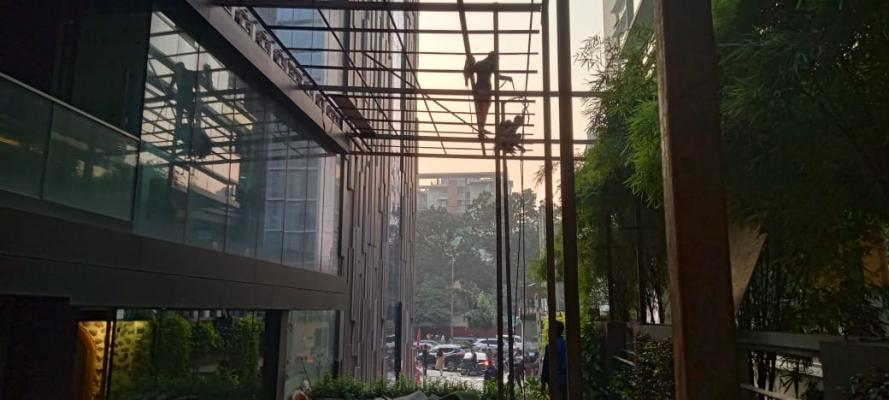

Outside Shed on 9-01-23

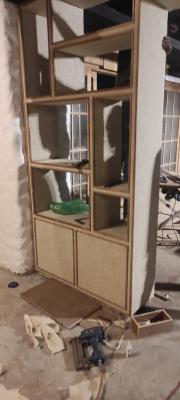

Interior Works on 9-01-23

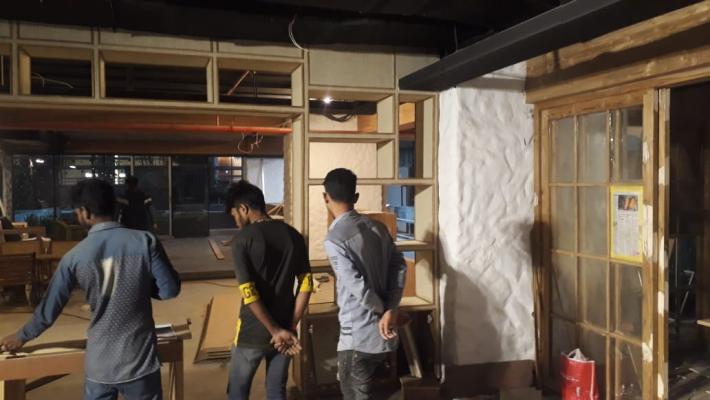

on 14-01-23
on 14-01-23

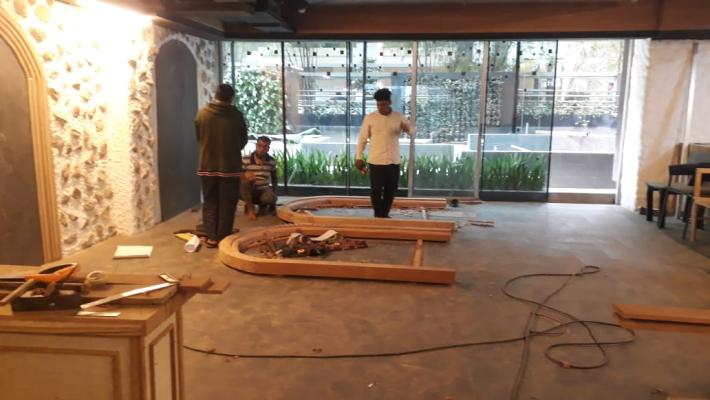

on 17-01-23
on 17-01-23

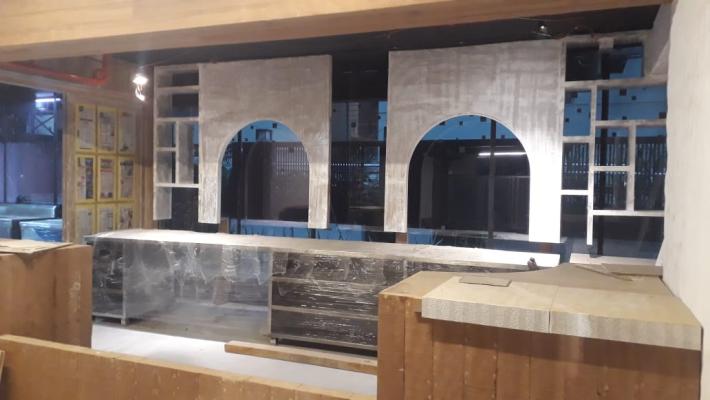

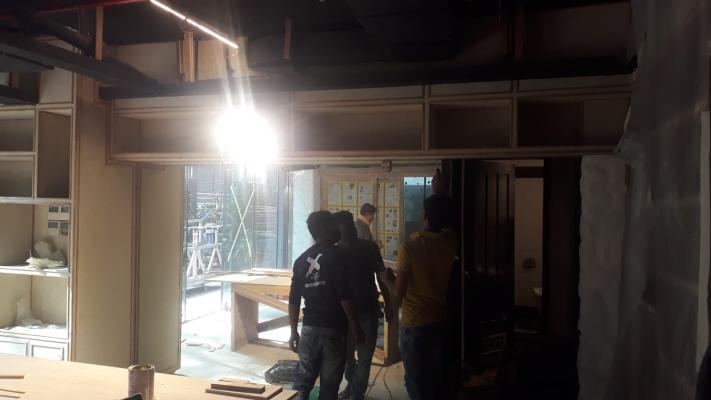

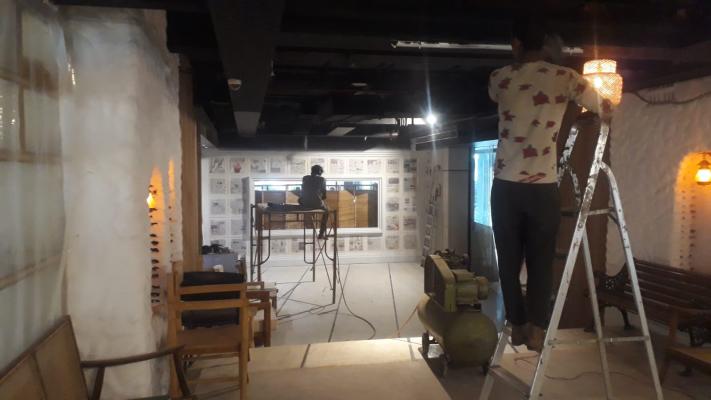

on 26-01-23
on 26-01-23

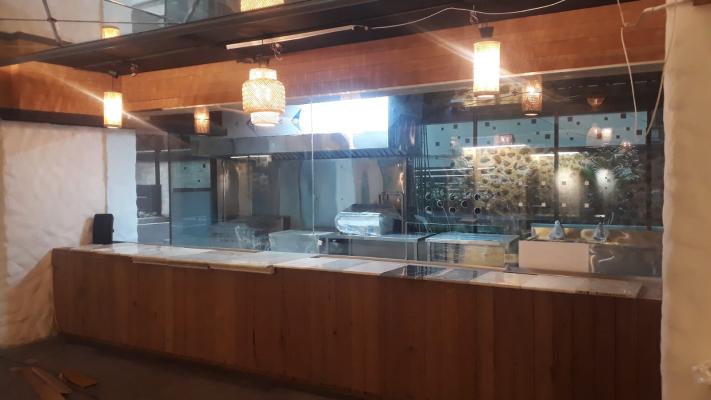

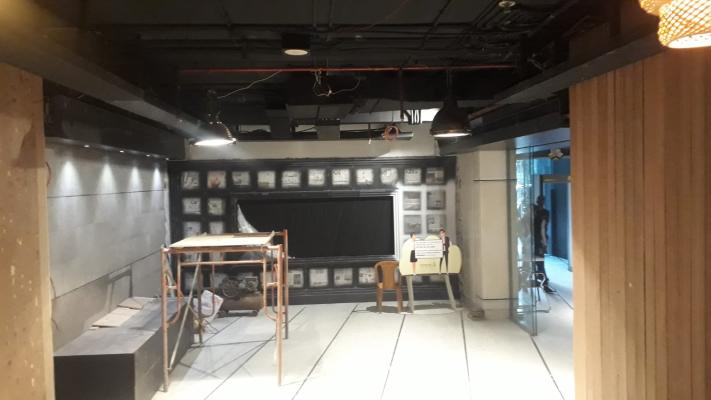

on 31-01-23
on 31-01-23

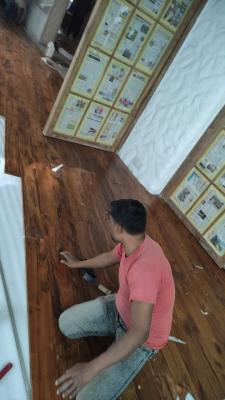

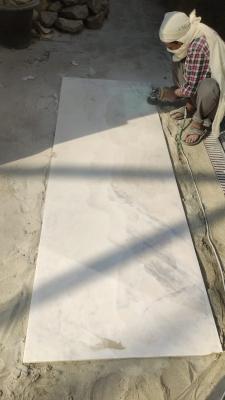

Wooden Floor fixing on 28-02-23
Marble Polishing on 28-02-23
GF-Coffee Shop inter on 4-03-23
GF-Coffee Shop interior on 4-03-23
BBQ Rustic tile fixing on 6-03-23
Coffee shop interior on 6-03-23
Coffee shop outside shed sheeting on 9-03-23
Coffee shop outside shed sheeting on 9-03-23
Coffee shop interior on 14-03-23
Coffee shop interior on 14-03-23
Coffee shop outside BBQ shed on 18-03-23
Coffee shop outside shed on 18-03-23
