TOTAL PROGRES REPORT

From 6-January-2021 to 2-September-2021
Project Code: 42 Name: NBL Tower-Superstucure
Client: National Bank Limited Contractor:
Progress as on: 2-September-2021
Total Duration: 239 days Total Working Days: 60 Total Manpower: 20318
Planning Progress = 93% Acual Progress = 87.1% SPI: 0.94 Behind Schedule
WBS Work Description
Total Quantity Total Done Schedule Start Schedule Finish Actual Start Actual Finish Lead-Lag(day) Not Yet
01 Ground Floor 100% 11-11-20 12-12-20 12-12-20 12-12-20 0
03 2nd Floor 100% 18-12-20 06-01-21 06-01-21 06-01-21 0
04.1.1 3rd Floor-South Tower-Column 14nos 100% 02-01-21 08-01-21 06-01-21 06-01-21 2
04.1.2 3rd Floor-South Tower-Lift Core 2nos 100% 02-01-21 08-01-21 06-01-21 06-01-21 2
04.1.3 3rd Floor-South Tower-Stair 2nos 100% 09-01-21 13-01-21 11-01-21 11-01-21 2
04.1.4 3rd Floor-South Tower-Roof Slab 958sqm 100% 09-01-21 13-01-21 11-01-21 11-01-21 2
04.2.1 3rd Floor-North Tower-Column 11nos 100% 07-01-21 13-01-21 14-01-21 14-01-21 -1
04.2.2 3rd Floor-North Tower-Lift Core 2nos 100% 07-01-21 13-01-21 16-01-21 16-01-21 -3
04.2.3 3rd Floor-North Tower-Stair 2nos 100% 14-01-21 18-01-21 14-01-21 18-01-21 0
04.2.4 3rd Floor-North Tower-Roof Slab 958sqm 100% 14-01-21 18-01-21 14-01-21 18-01-21 0
05.1.1 4th Floor-South Tower-Column 14nos 100% 14-01-21 20-01-21 14-01-21 14-01-21 6
05.1.2 4th Floor-South Tower-Lift Core 2nos 100% 14-01-21 20-01-21 14-01-21 16-01-21 4
05.1.3 4th Floor-South Tower-Stair 2nos 100% 21-01-21 25-01-21 20-01-21 21-01-21 4
05.1.4 4th Floor-South Tower-Roof Slab 960sqm 100% 21-01-21 25-01-21 20-01-21 21-01-21 4
05.2.1 4th Floor-North Tower-Column 11nos 100% 19-01-21 25-01-21 19-01-21 19-01-21 6
05.2.2 4th Floor-North Tower-Lift Core 2nos 100% 19-01-21 25-01-21 20-01-21 22-01-21 3
05.2.3 4th Floor-North Tower-Stair 2nos 100% 26-01-21 30-01-21 27-01-21 27-01-21 3
05.2.4 4th Floor-North Tower-Roof Slab 960sqm 100% 26-01-21 30-01-21 27-01-21 27-01-21 3
06.1.1 5th Floor-South Tower-Column 14nos 100% 26-01-21 01-02-21 22-01-21 22-01-21 10
06.1.2 5th Floor-South Tower-Lift Core 2nos 100% 26-01-21 01-02-21 24-01-21 24-01-21 8
06.1.3 5th Floor-South Tower-Stair 2nos 100% 02-02-21 06-02-21 01-02-21 01-02-21 5
06.1.4 5th Floor-South Tower-Roof Slab 840sqm 100% 02-02-21 06-02-21 01-02-21 01-02-21 5
06.2.1 5th Floor-North Tower-Column 11nos 100% 31-01-21 06-02-21 29-01-21 29-01-21 8
06.2.2 5th Floor-North Tower-Lift Core 2nos 100% 31-01-21 06-02-21 30-01-21 02-02-21 4
06.2.3 5th Floor-North Tower-Stair 2nos 100% 07-02-21 11-02-21 06-02-21 06-02-21 5
06.2.4 5th Floor-North Tower-Roof Slab 960sqm 100% 07-02-21 11-02-21 06-02-21 06-02-21 5
07.1.1 6th Floor-South Tower-Column 14nos 100% 07-02-21 13-02-21 03-02-21 03-02-21 10
07.1.2 6th Floor-South Tower-Lift Core 2nos 100% 07-02-21 13-02-21 04-02-21 06-02-21 7
07.1.3 6th Floor-South Tower-Stair 2nos 100% 14-02-21 18-02-21 16-02-21 16-02-21 2
07.1.4 6th Floor-South Tower-Roof Slab 963sqm 100% 14-02-21 18-02-21 16-02-21 16-02-21 2
07.2.1 6th Floor-North Tower-Column 11nos 100% 12-02-21 18-02-21 08-02-21 08-02-21 10
07.2.2 6th Floor-North Tower-Lift Core 2nos 100% 12-02-21 18-02-21 15-02-21 18-02-21 0
07.2.3 6th Floor-North Tower-Stair 2nos 100% 19-02-21 23-02-21 22-02-21 23-02-21 0
07.2.4 6th Floor-North Tower-Roof Slab 960sqm 100% 19-02-21 23-02-21 22-02-21 23-02-21 0
08.1.1 7th Floor-South Tower-Column 14nos 100% 19-02-21 25-02-21 19-02-21 19-02-21 6
08.1.2 7th Floor-South Tower-Lift Core 2nos 100% 19-02-21 25-02-21 19-02-21 22-02-21 3
08.1.3 7th Floor-South Tower-Stair Case 2nos 100% 26-02-21 02-03-21 01-03-21 01-03-21 1
08.1.4 7th Floor-South Tower-Roof Slab 950sqm 100% 26-02-21 02-03-21 01-03-21 01-03-21 1
08.2.1 7th Floor-North Tower-Column 11nos 100% 24-02-21 02-03-21 25-02-21 25-02-21 5
08.2.2 7th Floor-North Tower-Lift Core 2nos 100% 24-02-21 02-03-21 26-02-21 02-03-21 0
08.2.3 7th Floor-North Tower-Stair Case 2nos 100% 03-03-21 07-03-21 08-03-21 08-03-21 -1
08.2.4 7th Floor-North Tower-Slab 960m2 100% 03-03-21 07-03-21 08-03-21 08-03-21 -1
09.1.1 8th Floor-South Tower-Column 14nos 100% 03-03-21 09-03-21 05-03-21 05-03-21 4
09.1.2 8th Floor-South Tower-Lift Core 2nos 100% 03-03-21 09-03-21 08-03-21 11-03-21 -2
09.1.3 8th Floor-South Tower-Stair Case 2nos 100% 10-03-21 14-03-21 17-03-21 17-03-21 -3
09.1.4 8th Floor-South Tower-Roof Slab 963m2 100% 10-03-21 14-03-21 17-03-21 17-03-21 -3
09.2.1 8th Floor-North Tower-Column 11nos 100% 08-03-21 14-03-21 12-03-21 12-03-21 2
09.2.2 8th Floor-North Tower-Lift Core 2nos 100% 08-03-21 14-03-21 14-03-21 20-03-21 -6
09.2.3 8th Floor-North Tower-Stair Case 2nos 100% 15-03-21 19-03-21 05-04-21 05-04-21 -17
09.2.4 8th Floor-North Tower-Roof Slab 958m2 100% 15-03-21 19-03-21 05-04-21 05-04-21 -17
10.1.1 9th Floor-South Tower-Column 14nos 100% 15-03-21 21-03-21 28-03-21 31-03-21 -10
10.1.2 9th Floor-South Tower-Lift Core 2nos 100% 15-03-21 21-03-21 28-03-21 06-04-21 -16
10.1.3 9th Floor-South Tower-Stair 2nos 100% 22-03-21 26-03-21 13-04-21 13-04-21 -18
10.1.4 9th Floor-South Tower-Roof Slab 963m2 100% 22-03-21 26-03-21 13-04-21 13-04-21 -18
10.2.1 9th Floor-North Tower-Column 11nos 100% 20-03-21 26-03-21 09-04-21 09-04-21 -14
10.2.2 9th Floor-North Tower-Lift Core 2nos 100% 20-03-21 26-03-21 12-04-21 16-04-21 -21
10.2.3 9th Floor-North Tower-Stair 2nos 100% 27-03-21 31-03-21 23-04-21 23-04-21 -23
10.2.4 9th Floor-North Tower-Roof Slab 958m2 100% 27-03-21 31-03-21 23-04-21 23-04-21 -23
11.1.1 10th Floor-South Tower-Column 14nos 100% 27-03-21 02-04-21 17-04-21 17-04-21 -15
11.1.2 10th Floor-South Tower-Lift Core 2nos 100% 27-03-21 02-04-21 17-04-21 21-04-21 -19
11.1.3 10th Floor-South Tower-Stair 2nos 100% 03-04-21 07-04-21 04-05-21 04-05-21 -27
11.1.4 10th Floor-South Tower-Roof Slab 963m2 100% 03-04-21 07-04-21 04-05-21 04-05-21 -27
11.2.1 10th Floor-North Tower-Column 11nos 100% 01-04-21 07-04-21 27-04-21 27-04-21 -20
11.2.2 10th Floor-North Tower-Lift Core 2nos 100% 01-04-21 07-04-21 29-04-21 02-05-21 -25
11.2.3 10th Floor-North Tower-Stair 2nos 100% 08-04-21 12-04-21 10-05-21 10-05-21 -28
11.2.4 10th Floor-North Tower-Roof Slab 958m2 100% 08-04-21 12-04-21 10-05-21 10-05-21 -28
12.1.1 11th Floor-South Tower-Column 14nos 100% 08-04-21 14-04-21 09-05-21 09-05-21 -25
12.1.2 11th Floor-South Tower-Lift Core 2nos 100% 08-04-21 14-04-21 09-05-21 12-06-21 -59
12.1.3 11th Floor-South Tower-Stair 2nos 100% 15-04-21 19-04-21 02-09-21 02-09-21 -136
12.1.4 11th Floor-South Tower-Roof Slab 963m2 100% 15-04-21 19-04-21 02-09-21 02-09-21 -136
12.2.1 11th Floor-North Tower-Column 11nos 100% 13-04-21 19-04-21 31-05-21 04-06-21 -46
12.2.2 11th Floor-North Tower-Lift Core 2nos 50% 13-04-21 19-04-21 15-06-21 15-06-21 -57 Completed
12.2.3 11th Floor-North Tower-Stair 2nos 0% 20-04-21 24-04-21 0 Started
12.2.4 11th Floor-North Tower-Roof Slab 958m2 0% 20-04-21 24-04-21 0 Started
13.1.1 12th Floor-South Tower-Column 13nos % 20-04-21 26-04-21 0 Started
13.1.2 12th Floor-South Tower-Lift Core 2nos % 20-04-21 26-04-21 0 Started
13.2.1 12th Floor-North Tower-Column 11nos % 25-04-21 01-05-21 0 Started
13.2.2 12th Floor-North Tower-Lift Core 2nos % 25-04-21 01-05-21 0 Started

DAILY MANPOWER

CUMMULATIVE ACTUAL WORK PROGRESS

CUMMULATIVE PLAN WORK PROGRESS

CUMMULATIVE WORK PROGRESS

SCHEDULE AHEAD-BEHIND

Site Photographs

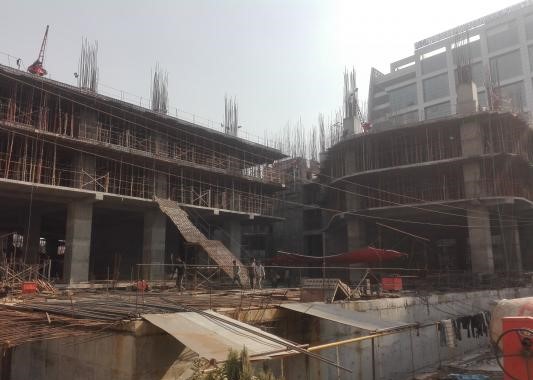

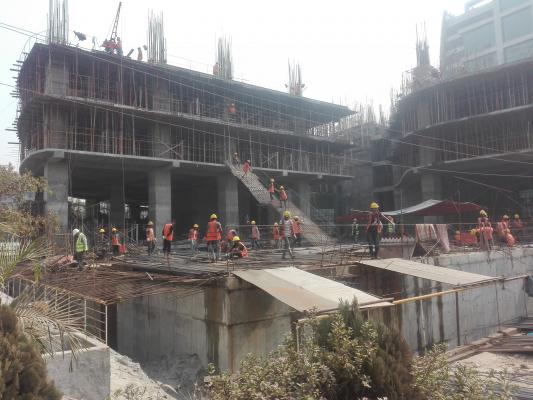

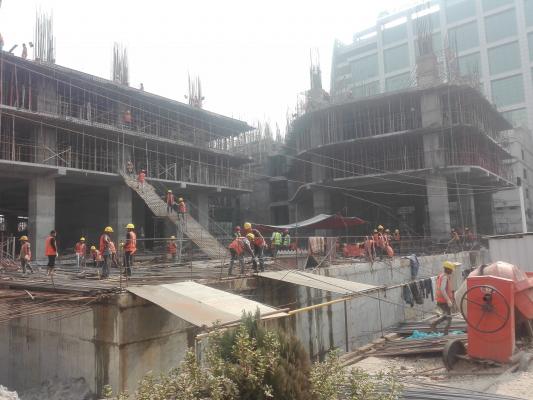

3rd Floor South Tower-Column Complete on 6-01-21
3rd Floor South Tower Lift Core Complete on 6-01-21
3rd Floor South Tower-Stair Complete on 11-01-21
3rd Floor South Tower Slab Complete on 11-01-21

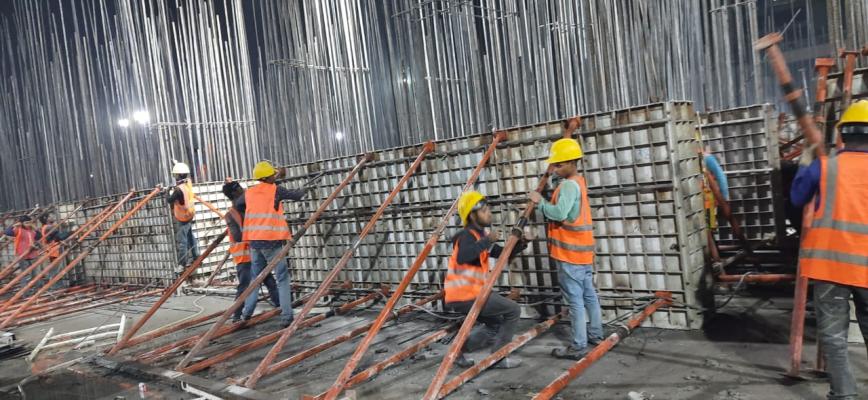

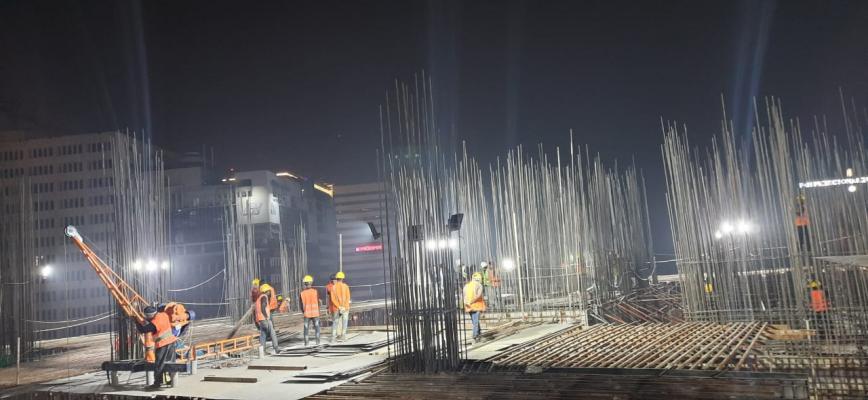

Lift Core Wall Shttering on 14-01-21
Re-bar Lifting by Roof Hoist on 14-01-21

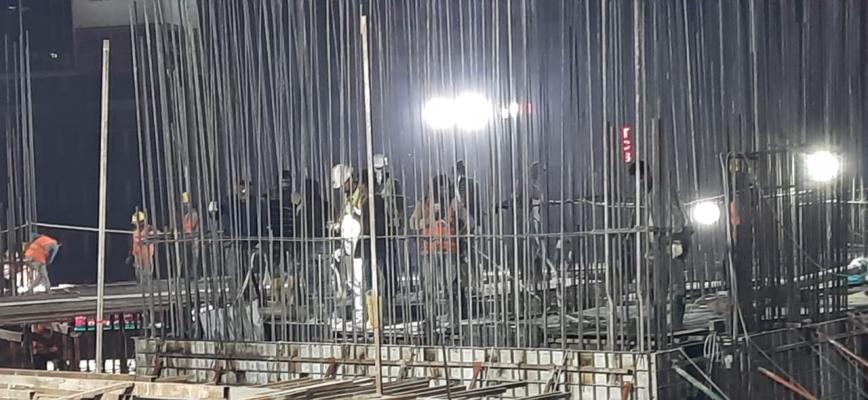

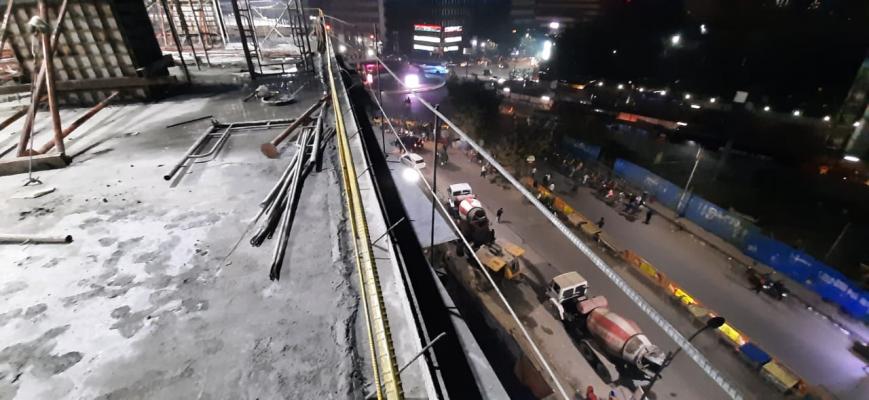

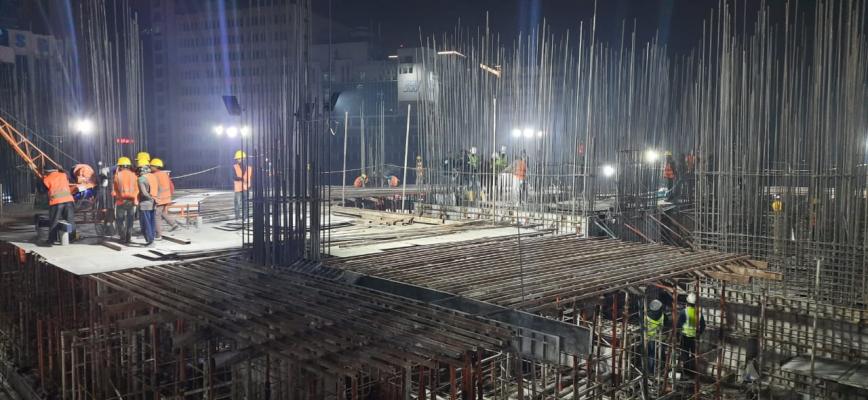

Night Shift Working on 16-01-21

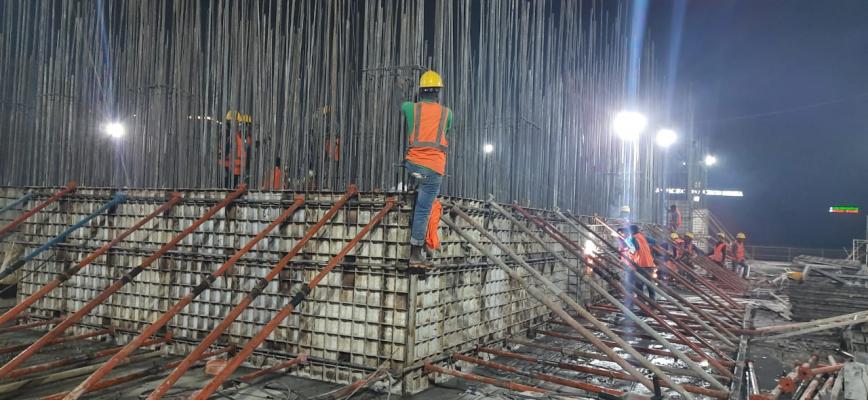

Lift Core Wall Shuttering on 16-01-21

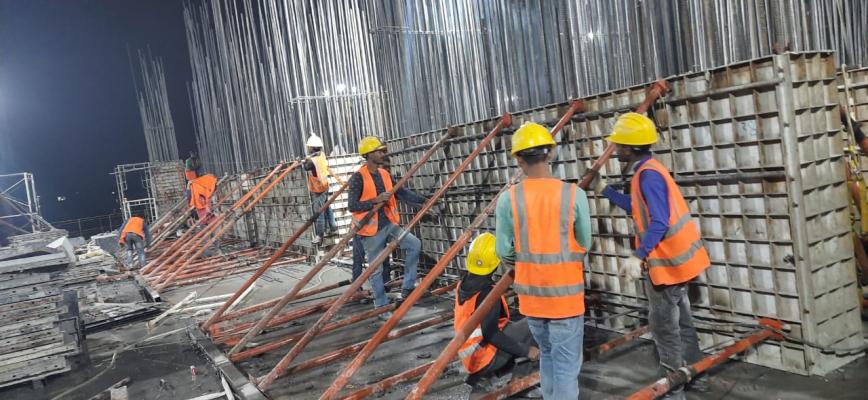

Lift Core Wall Shuttering on 17-01-21
Re-bar Lifting by Roof Hoist on 17-01-21
Re-bar Work on 18-01-21
on 18-01-21
on 19-01-21
on 19-01-21

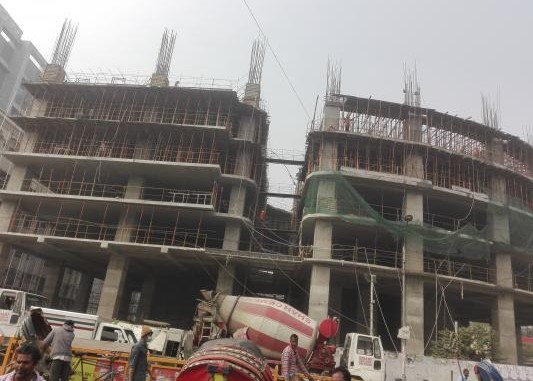

South Tower 4th Floor Roof Slab Running on 20-01-21
North Tower 4th Floor Lift Core Running on 20-01-21
South Tower 4th Floor Roof Slab Concreti on 21-01-21

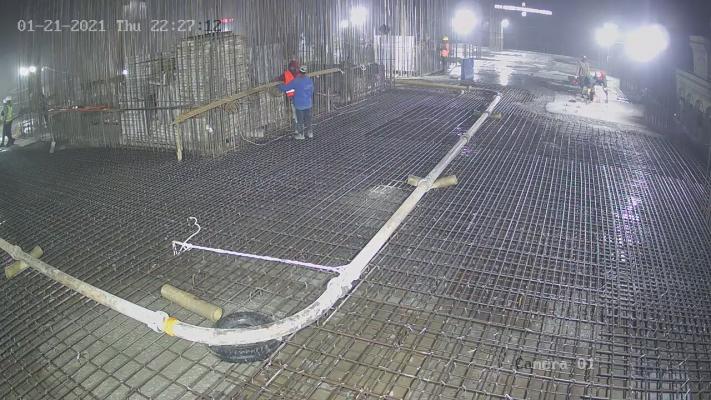

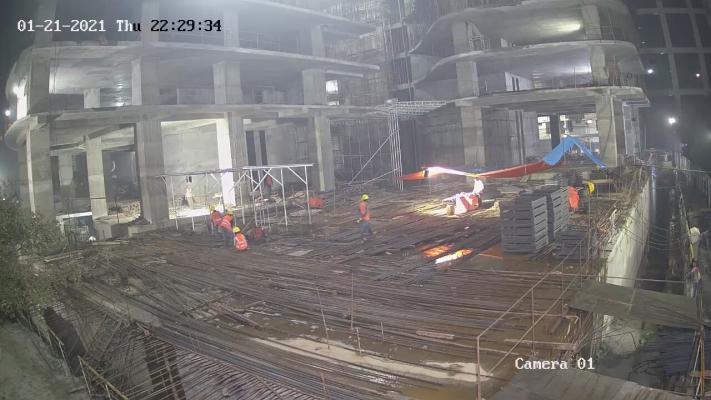

Night Shift Working on 21-01-21

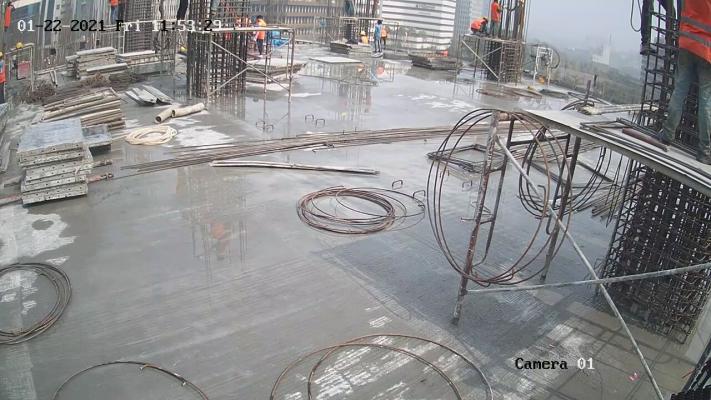

Curing after 4F South Tower Slab Concret on 22-01-21

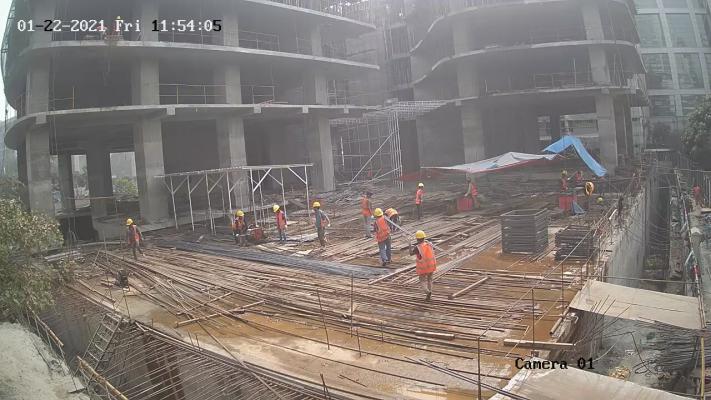

Re-bar Work on 22-01-21

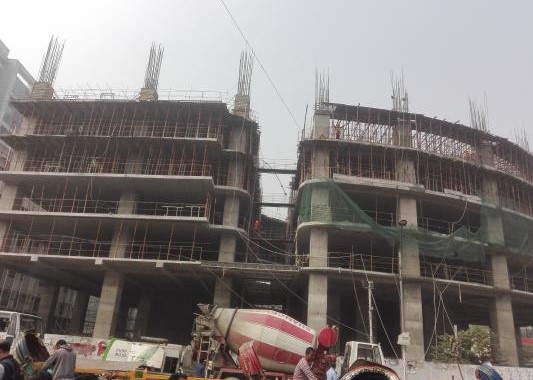

Project Picture on 24-01-21
Project Picture on 24-01-21

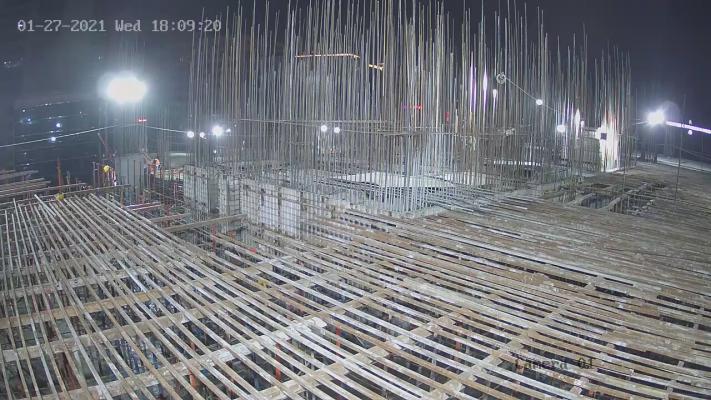

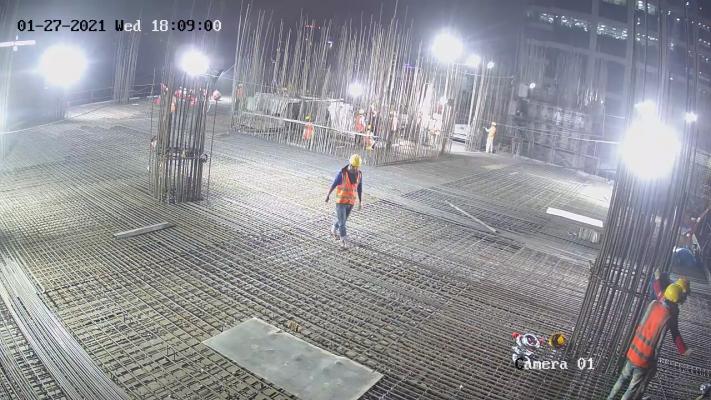

Slab Re-bar Work on 27-01-21
Slab Shuttering on 27-01-21

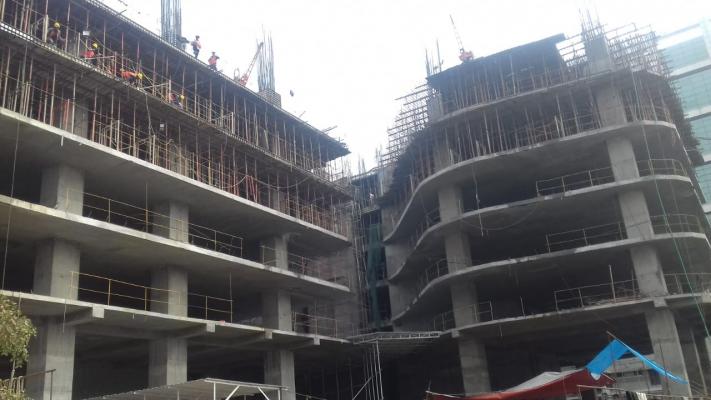

Project Picture on 29-01-21

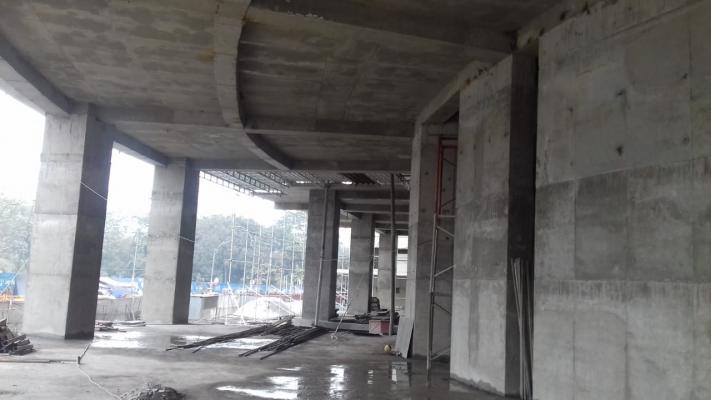

Inside Building on 29-01-21

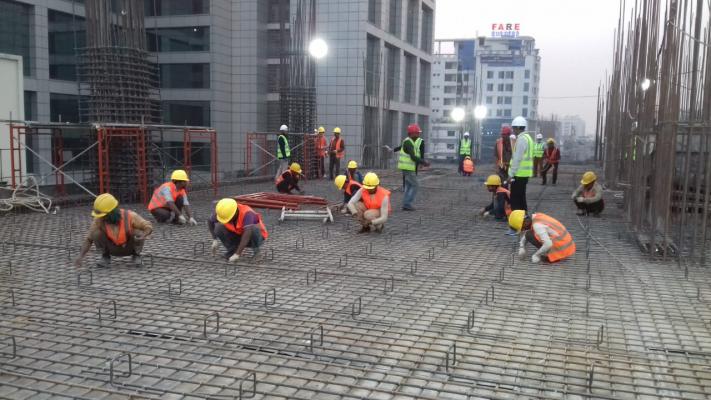

Slab Re-bar Work on 30-01-21
Work Inspection on 30-01-21

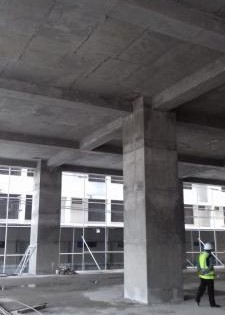

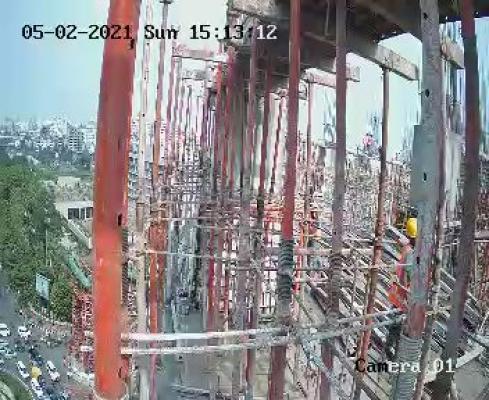

Roof Slab on 1-02-21
Inside on 1-02-21

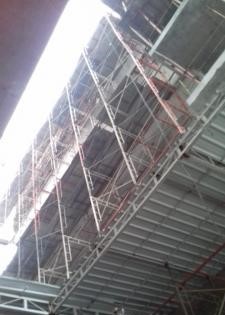

Safety Railing on 3-02-21
Project Picture on 3-02-21

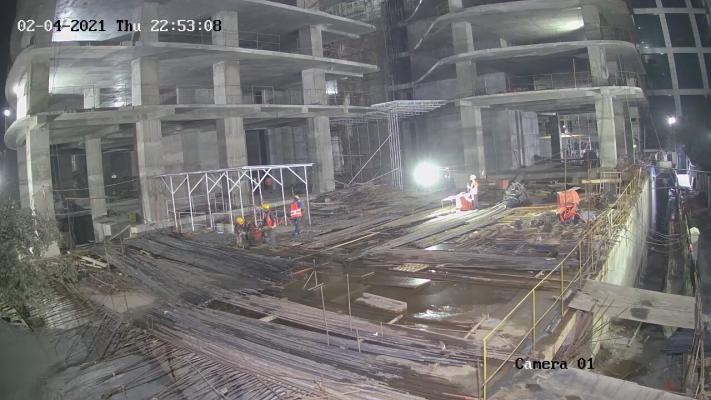

Night Shift Working on 4-02-21
Night Shift Working on 4-02-21

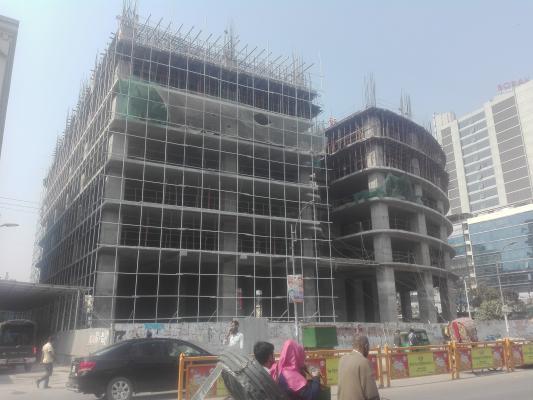

Project View from East Side on 6-02-21
Project View from West Side on 6-02-21

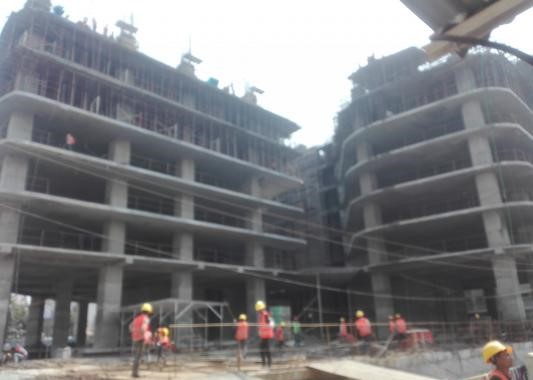

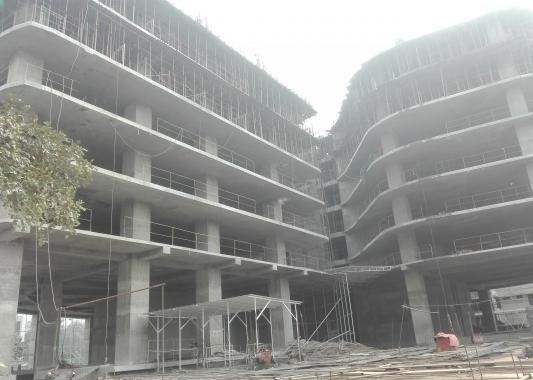

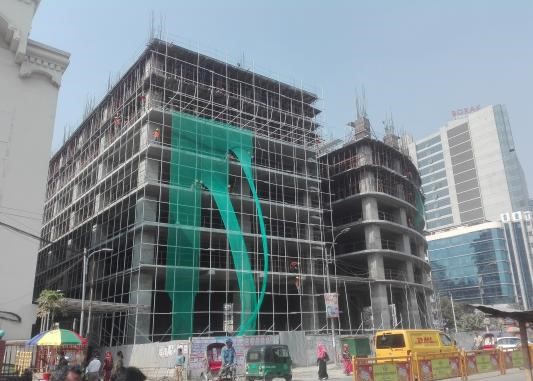

View from East Side on 8-02-21
View from West Side on 8-02-21
Project was closed 11-14 Feb 2021 due to on 15-02-21
on 15-02-21

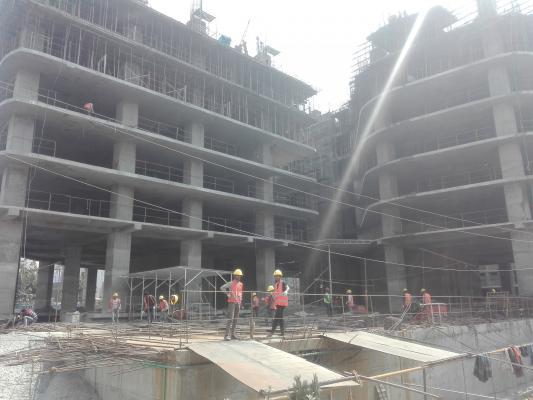

on 16-02-21
on 16-02-21

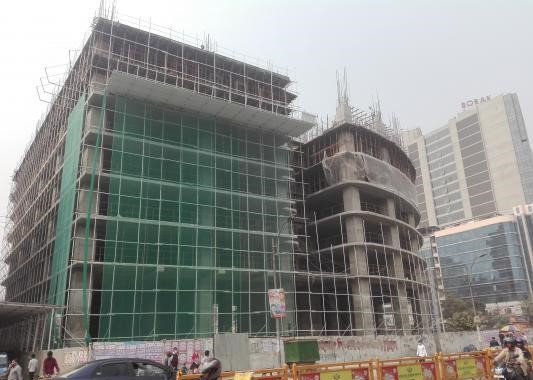

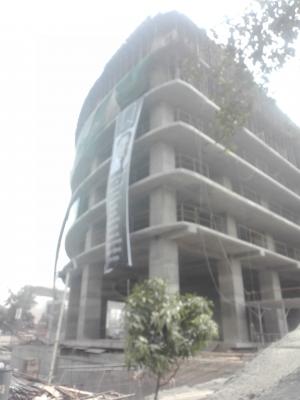

on 18-02-21
on 18-02-21

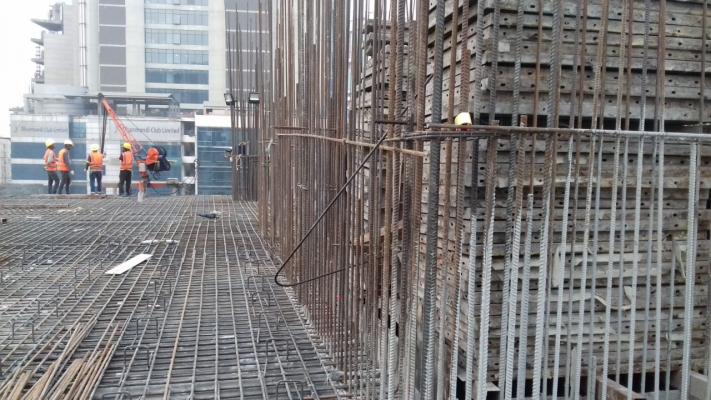

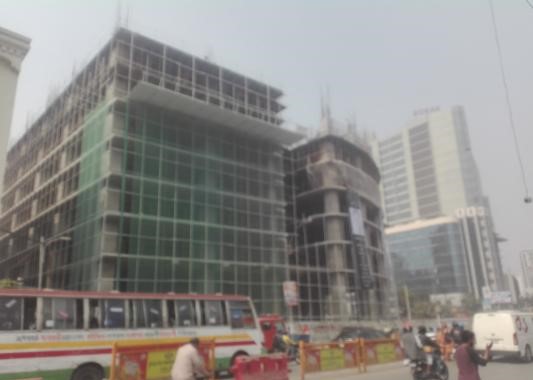

on 19-02-21
on 19-02-21

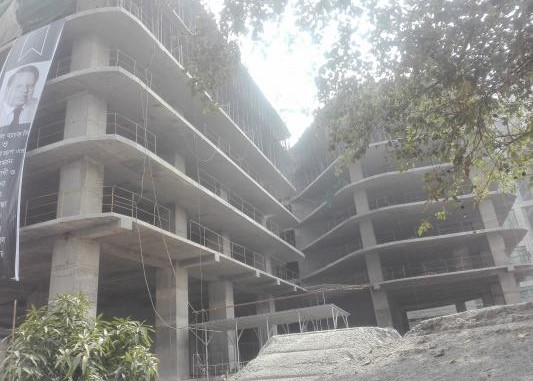

on 20-02-21
on 20-02-21
on 21-02-21
on 21-02-21

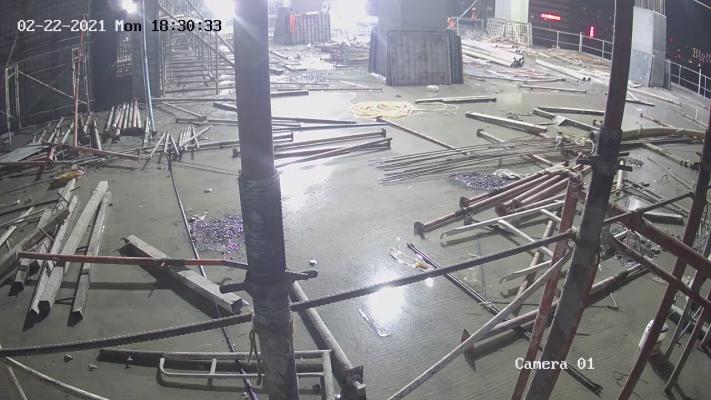

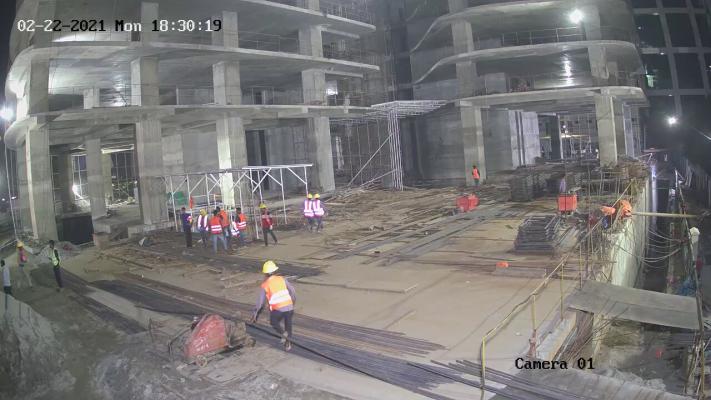

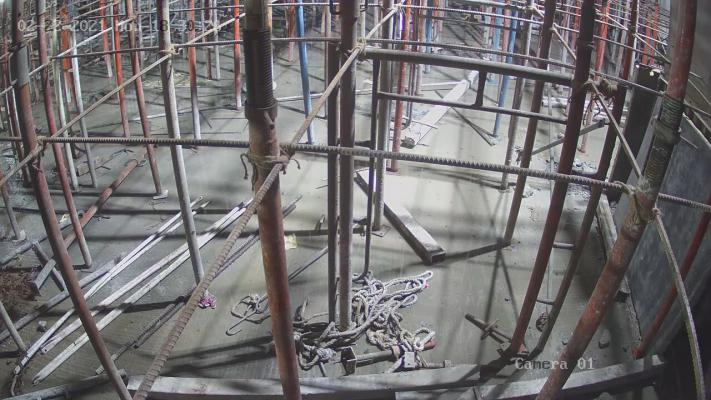

on 22-02-21
on 22-02-21

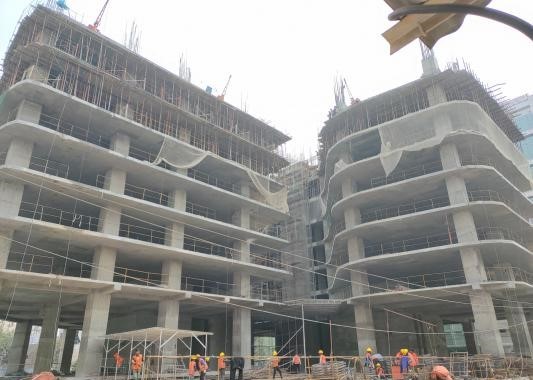

on 23-02-21
on 23-02-21
on 25-02-21
on 25-02-21

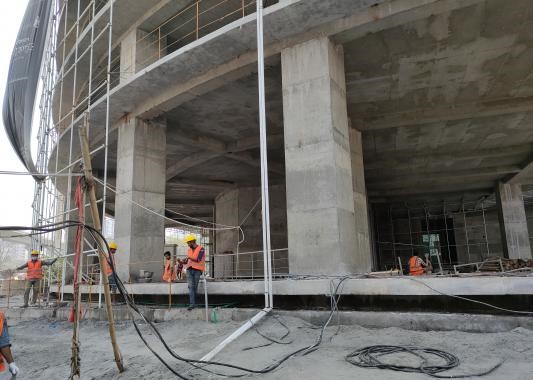

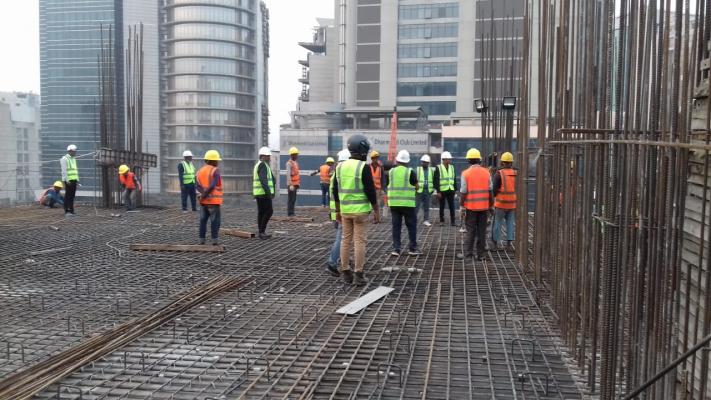

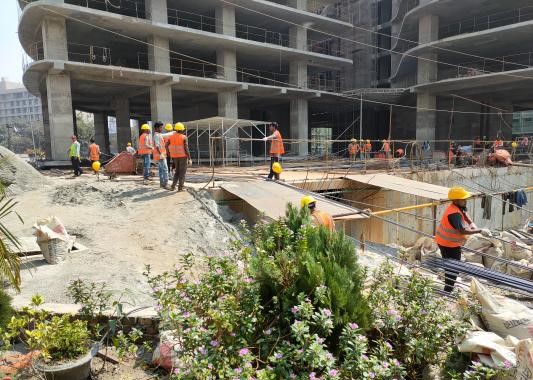

on 26-02-21
on 26-02-21

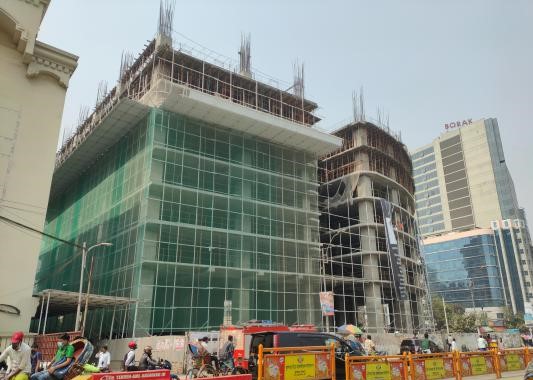

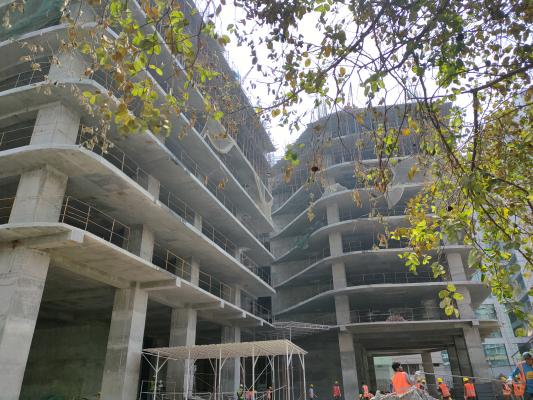

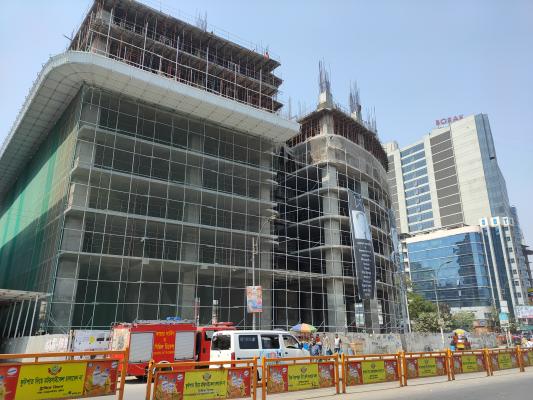

on 1-03-21
on 1-03-21

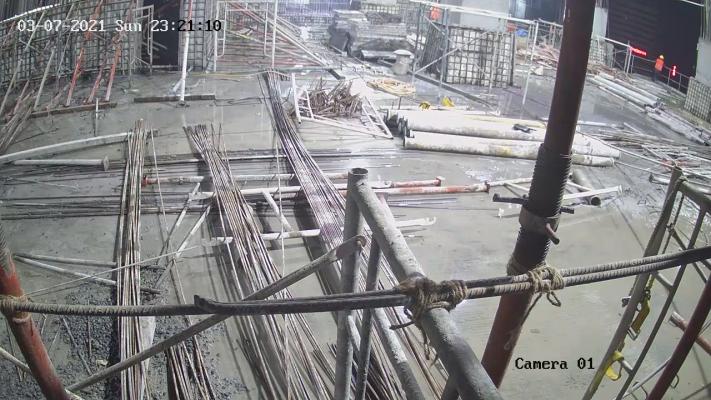

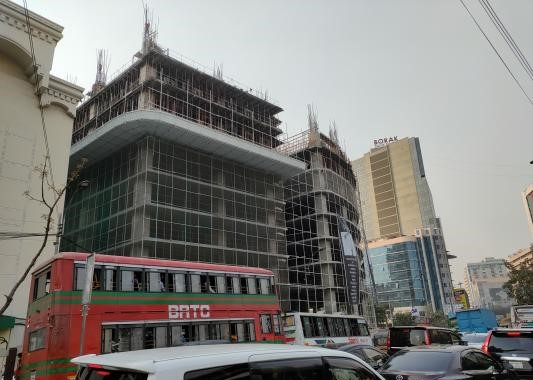

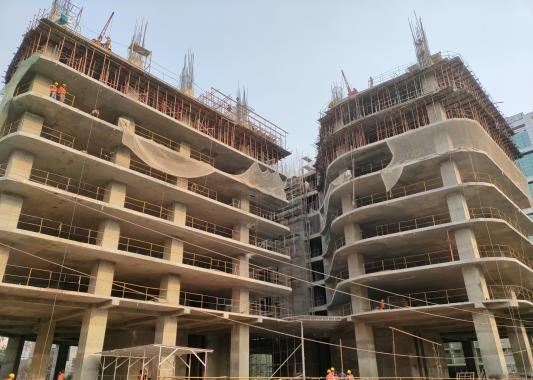

on 2-03-21
on 2-03-21

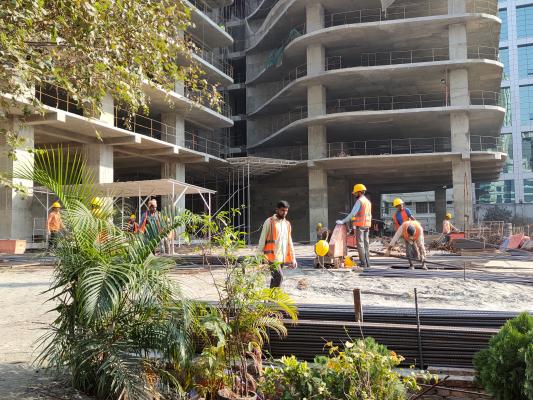

on 5-03-21
on 5-03-21

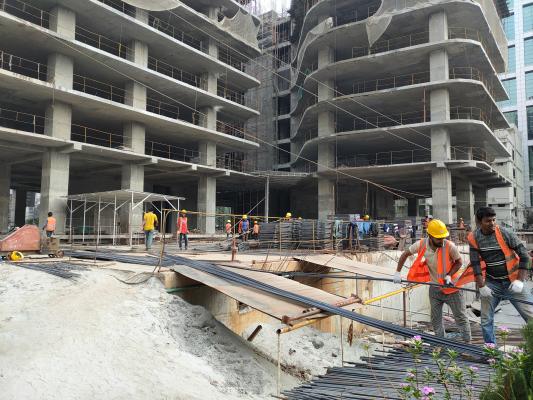

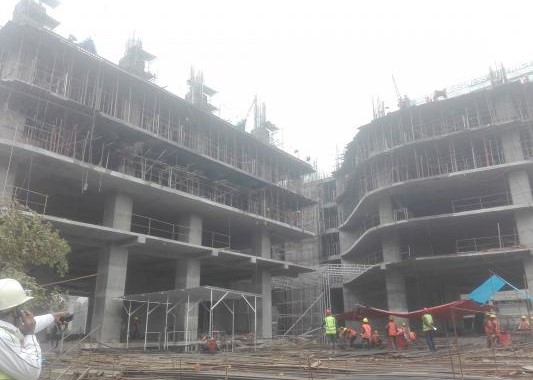

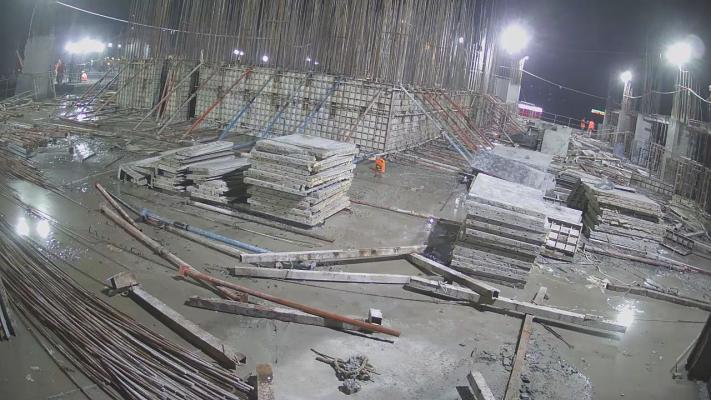

on 8-03-21
on 8-03-21

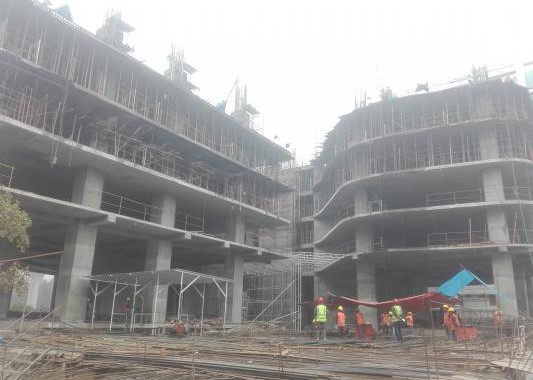

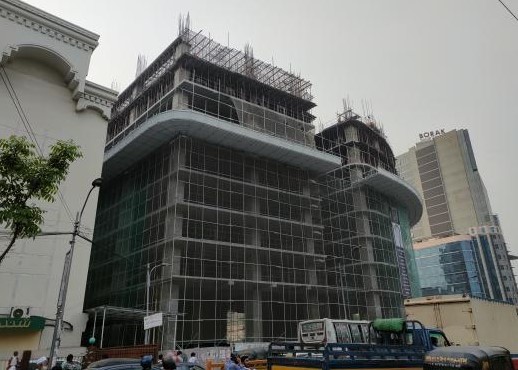

on 11-03-21
on 11-03-21
on 12-03-21
on 12-03-21
on 14-03-21
on 14-03-21

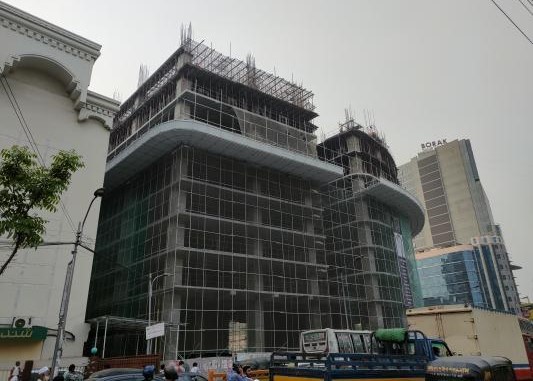

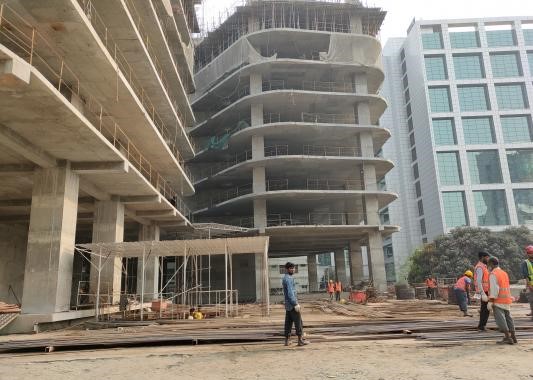

on 17-03-21
on 17-03-21

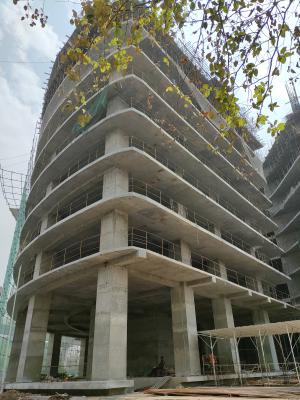

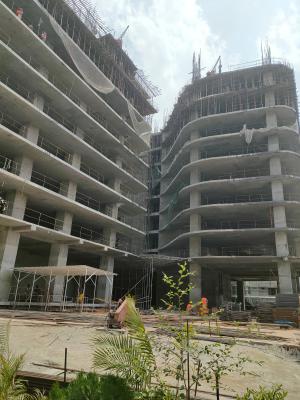

on 20-03-21
on 20-03-21

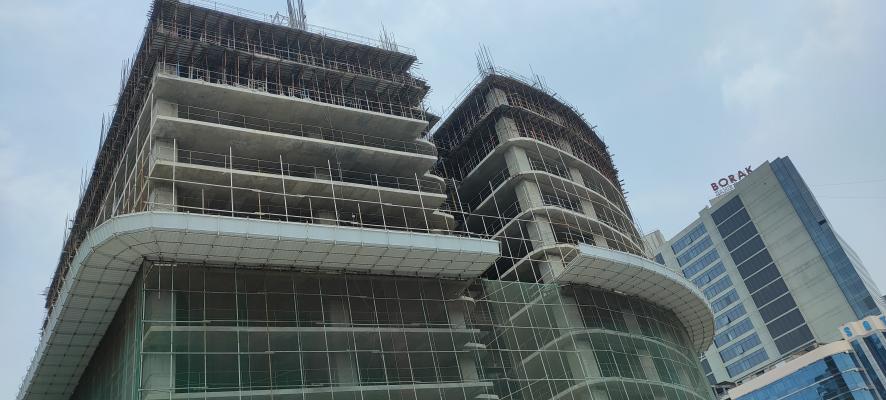

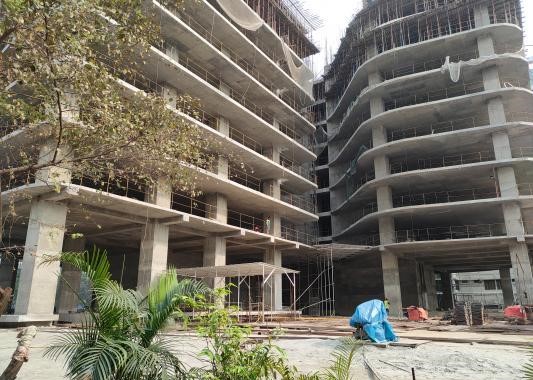

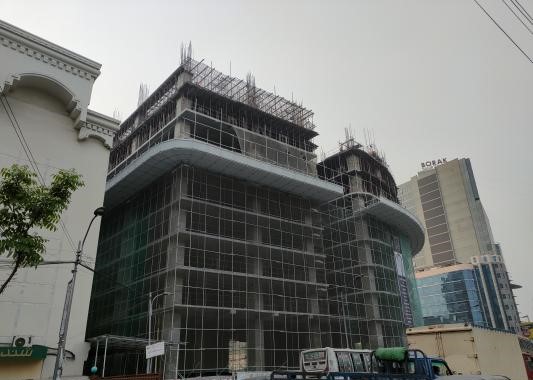

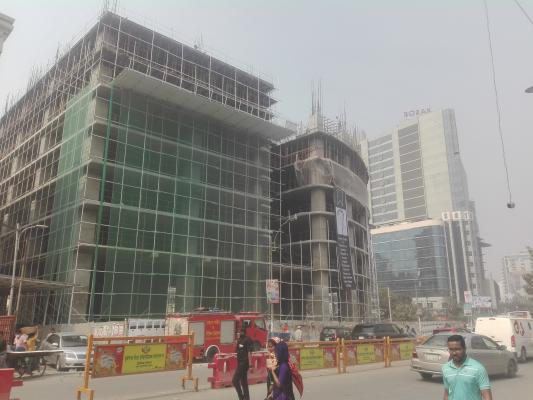

View from East Side on 28-03-21
View from East Side on 28-03-21

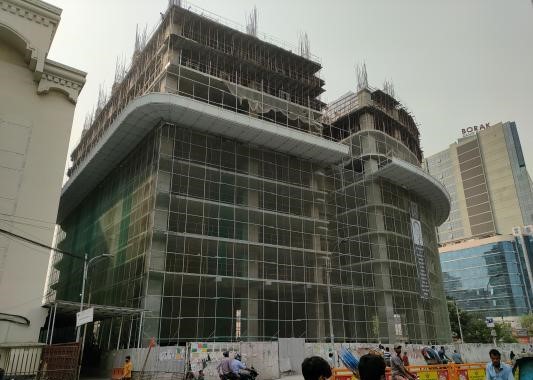

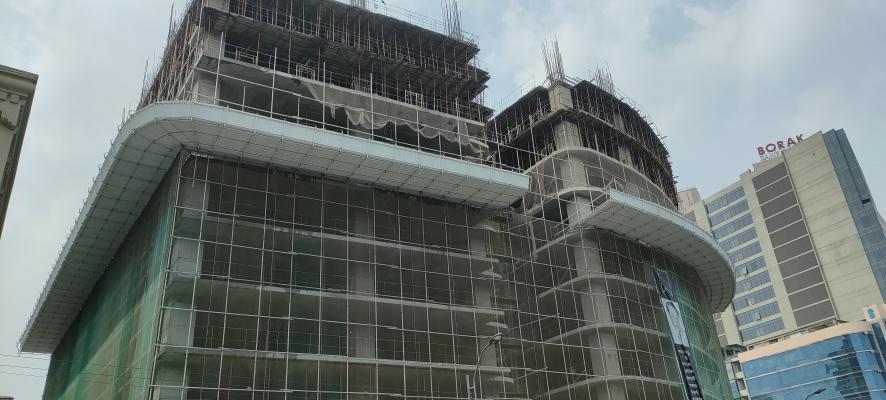

View from East Side on 31-03-21

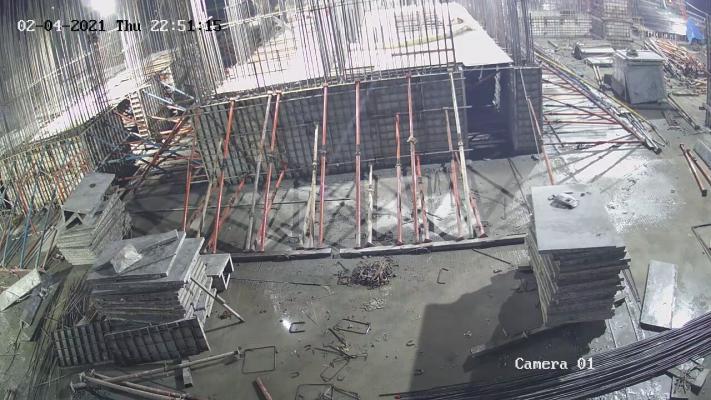

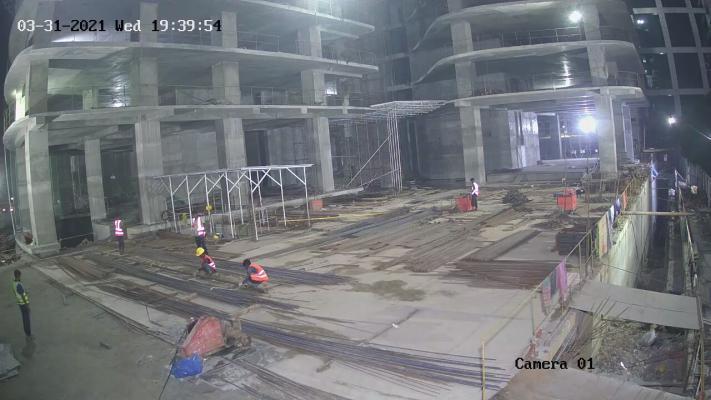

Night Shift Working on 31-03-21
8th Floor North Tower Roof Slab Casting on 5-04-21
8th Floor North Tower Roof Slab Casting on 5-04-21

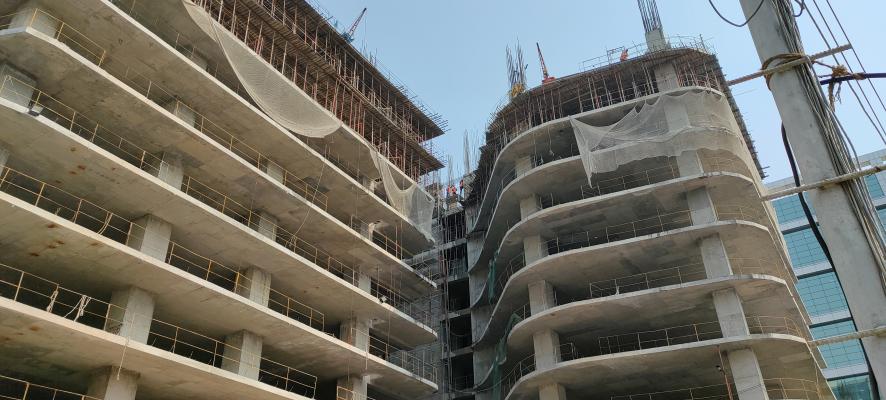

on 6-04-21
on 6-04-21

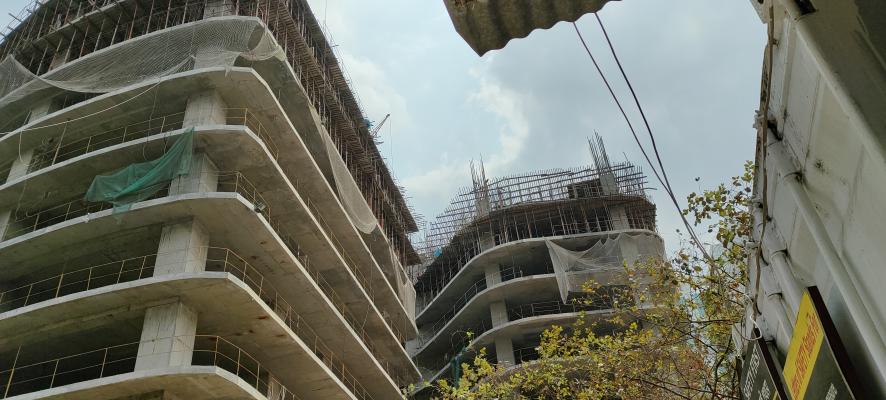

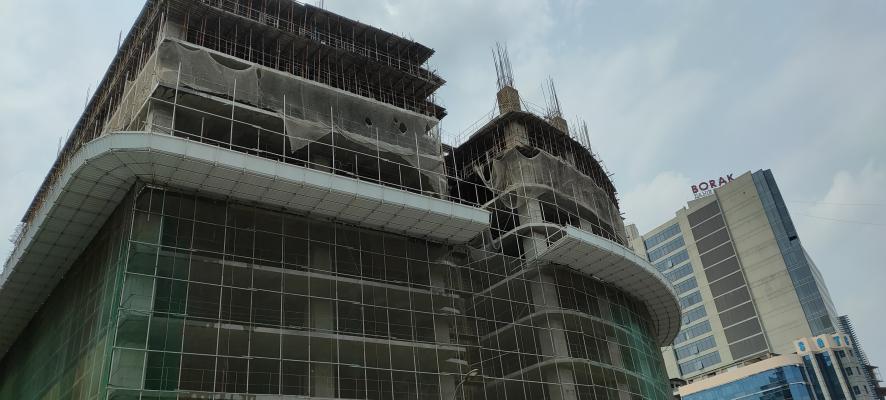

on 9-04-21
on 9-04-21

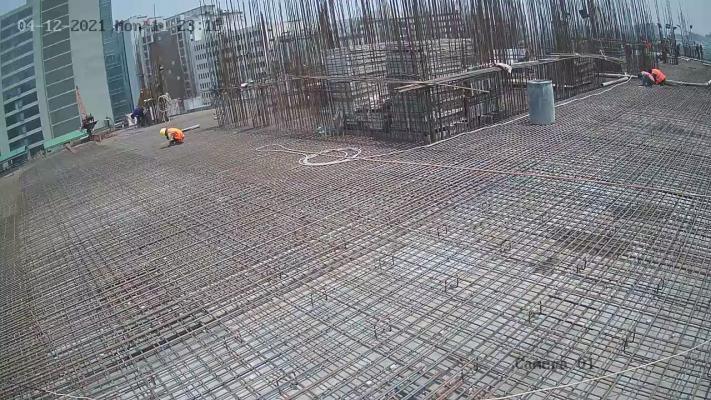

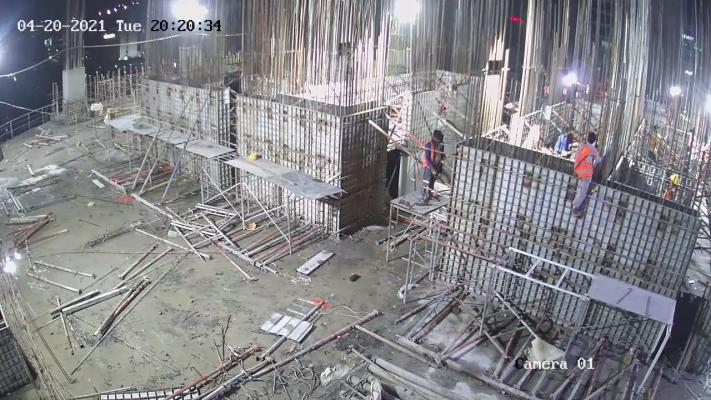

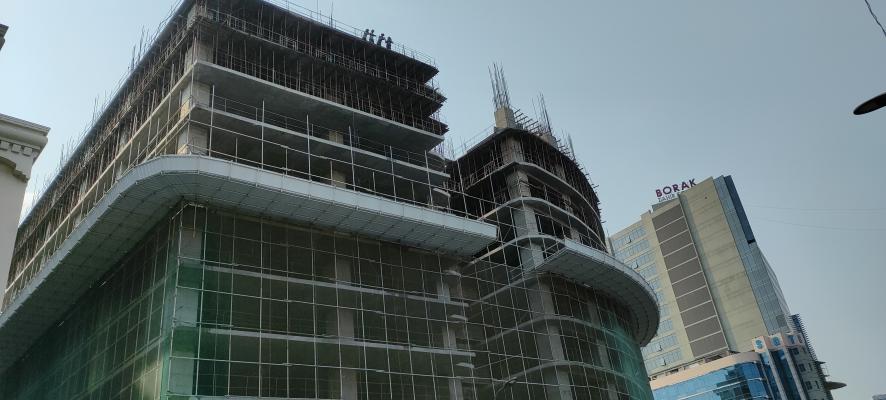

on 12-04-21
on 12-04-21
on 13-04-21

South Tower 10th Floor Slab Concreting on 13-04-21

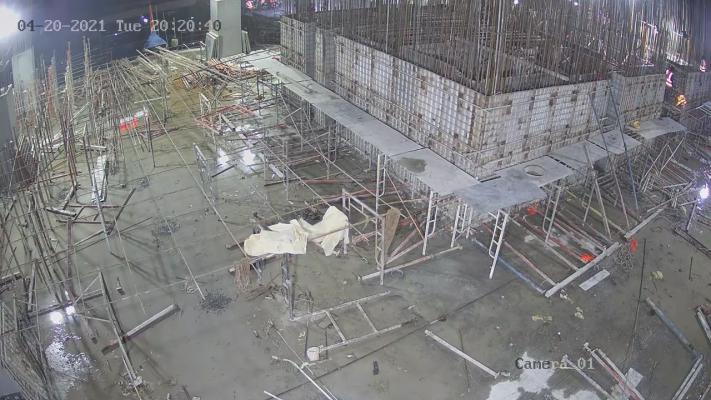

on 16-04-21
on 16-04-21

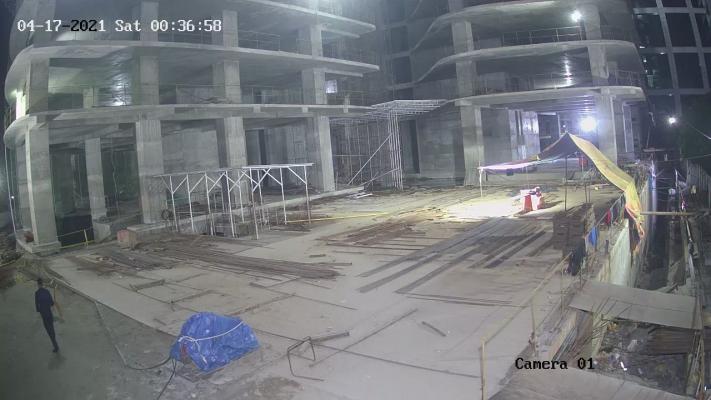

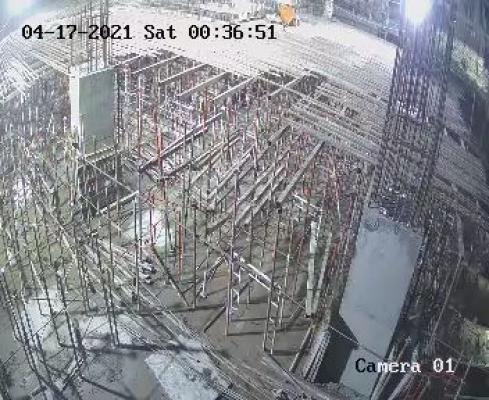

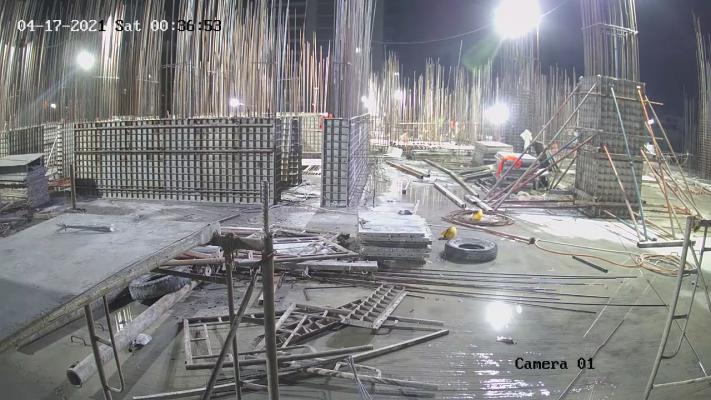

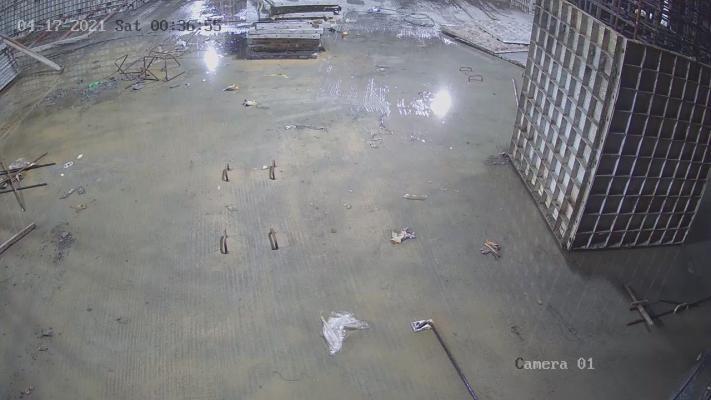

on 17-04-21
on 17-04-21
on 21-04-21
on 21-04-21

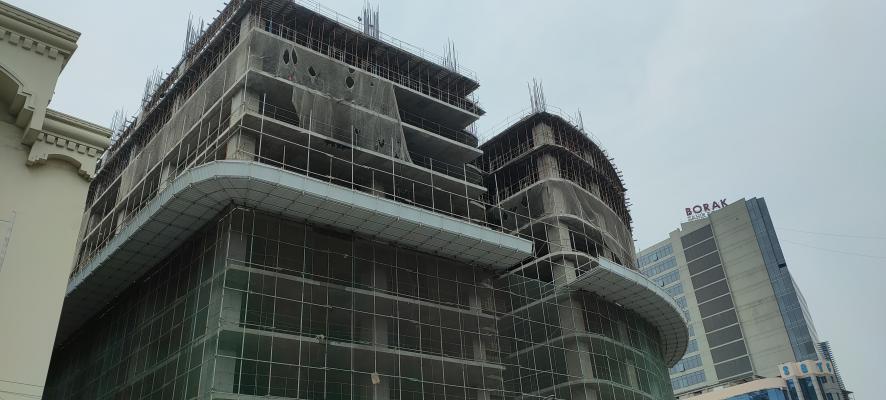

on 23-04-21
on 23-04-21

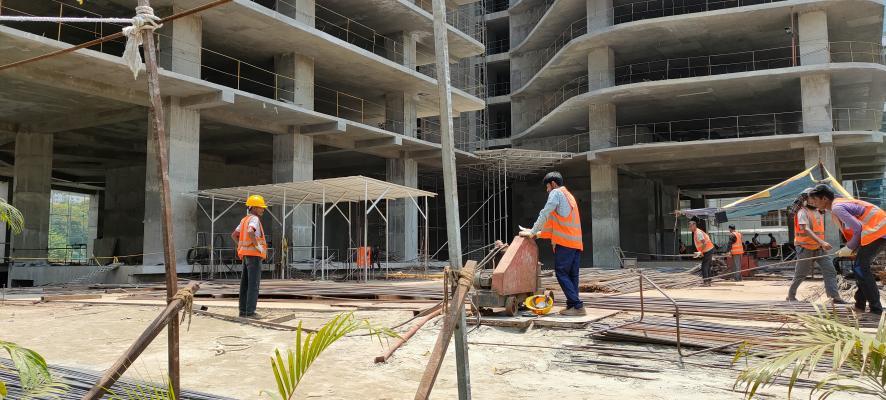

on 27-04-21
on 27-04-21

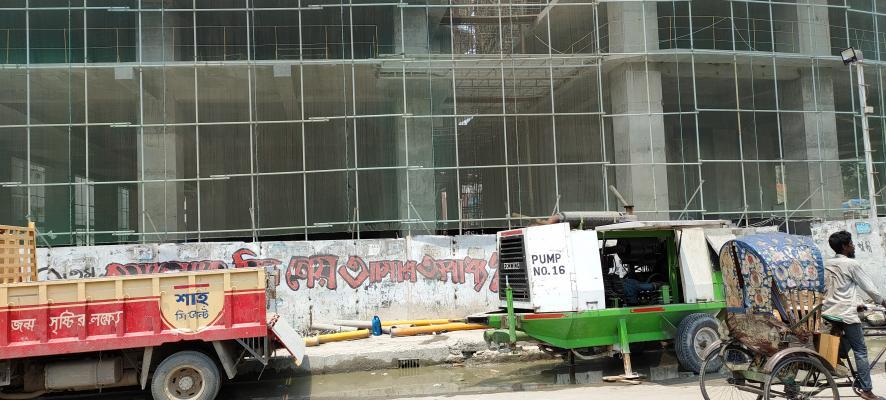

on 29-04-21
on 29-04-21

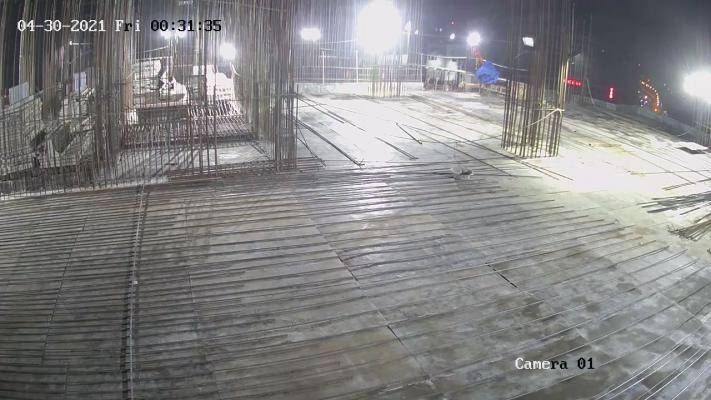

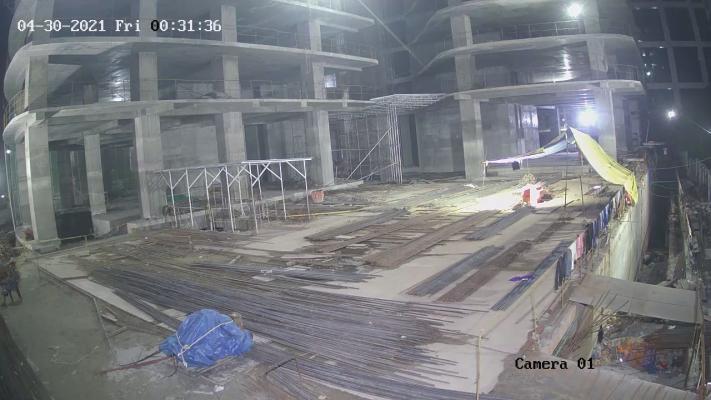

on 30-04-21
on 30-04-21

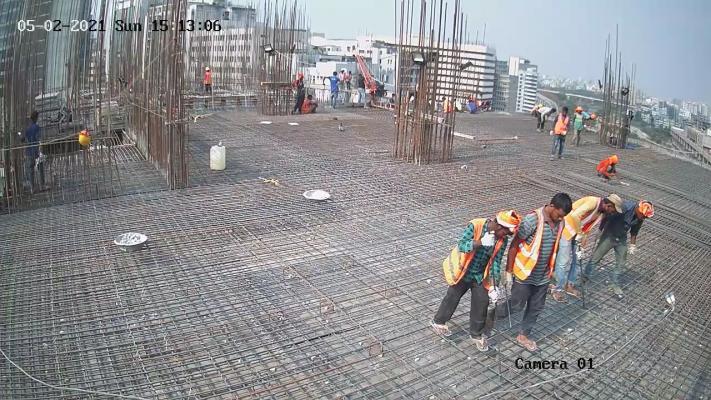

on 2-05-21
on 2-05-21

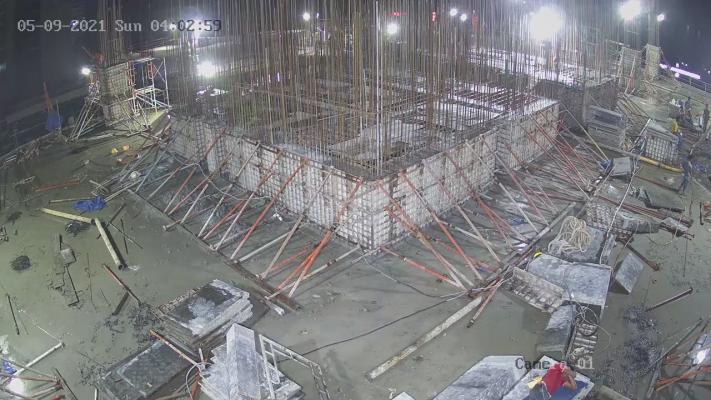

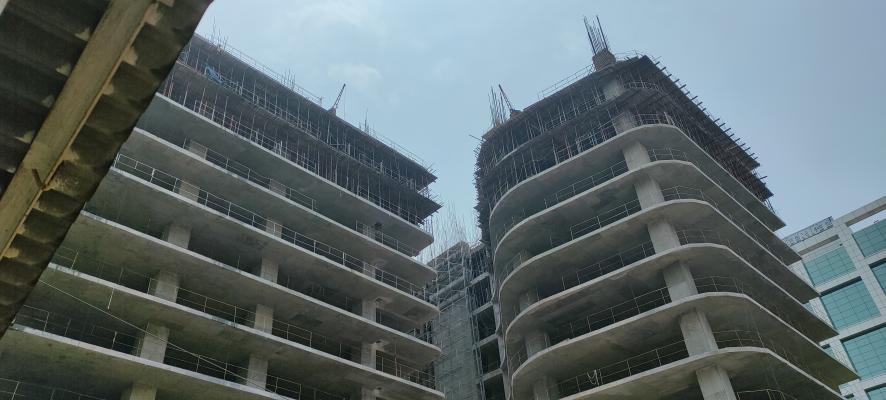

on 9-05-21
on 9-05-21
on 10-05-21
on 10-05-21

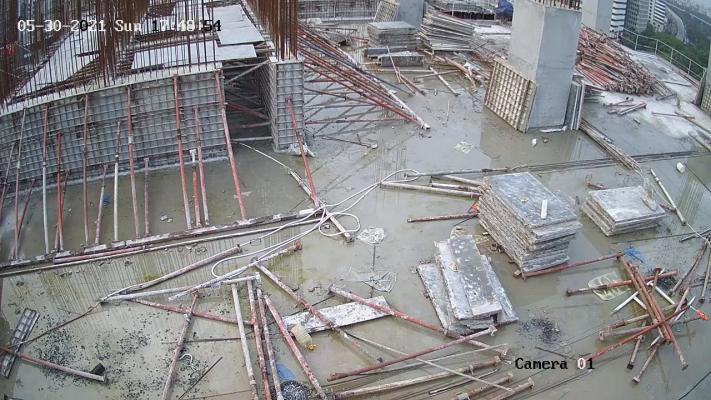

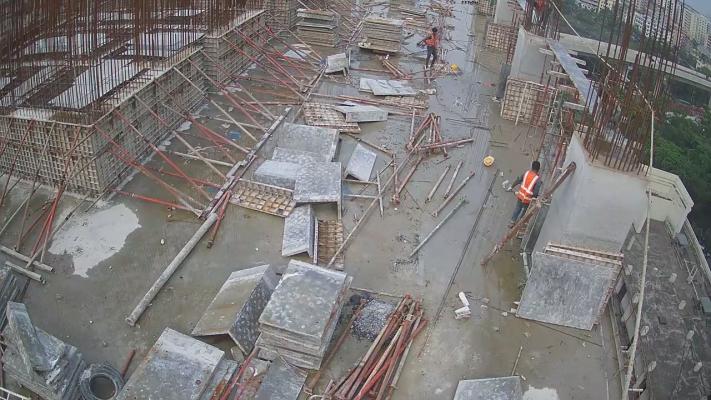

on 31-05-21
on 31-05-21
Project Closed 11-22 May due to Eid-ul Fitre Vacation

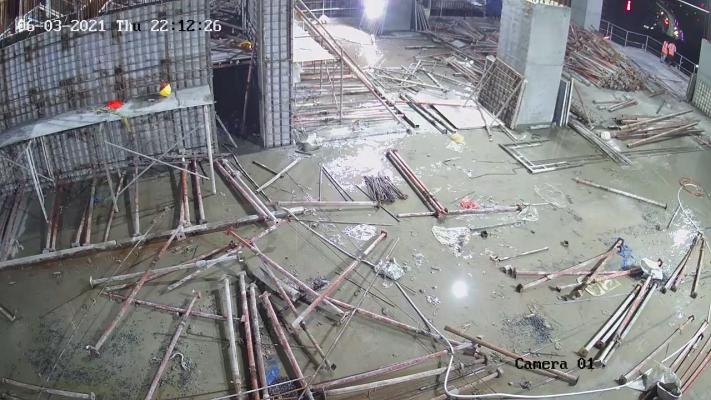

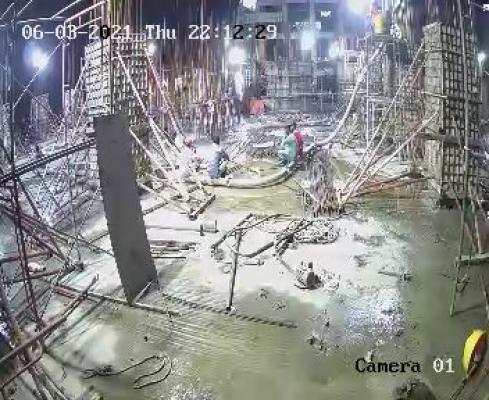

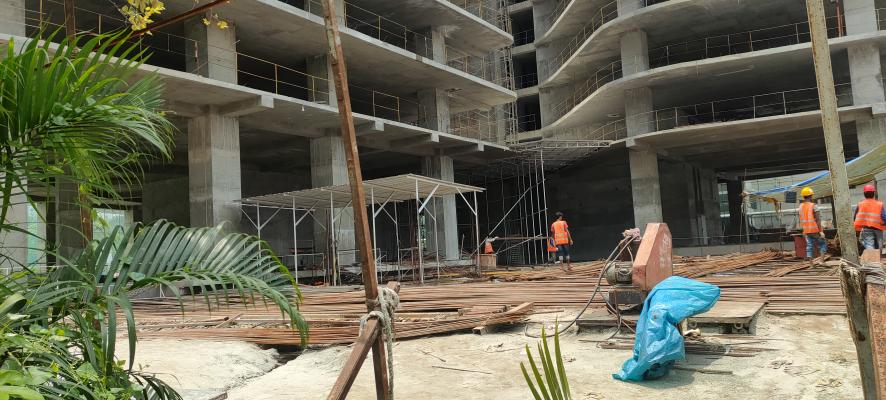

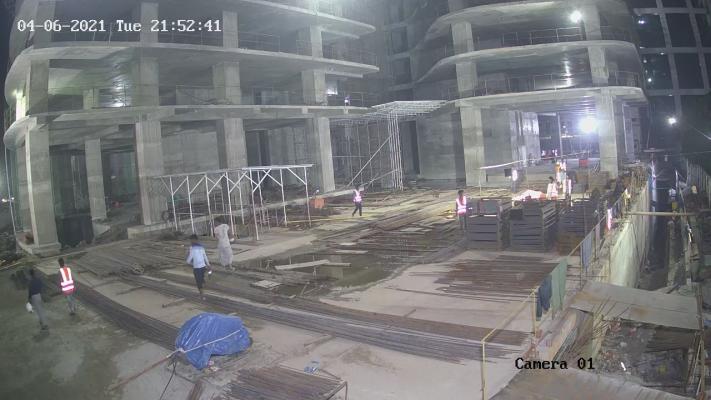

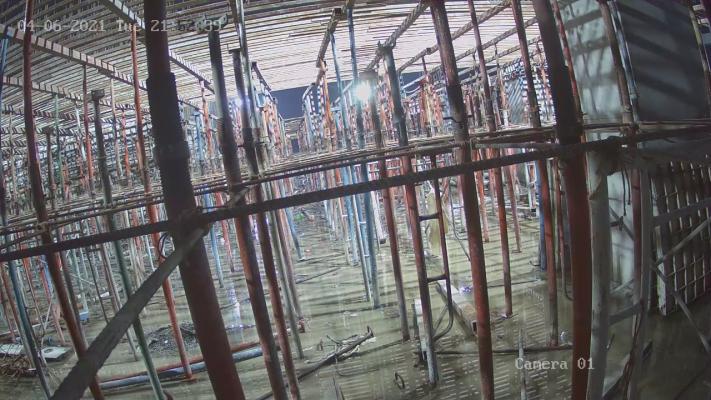

on 4-06-21
on 4-06-21

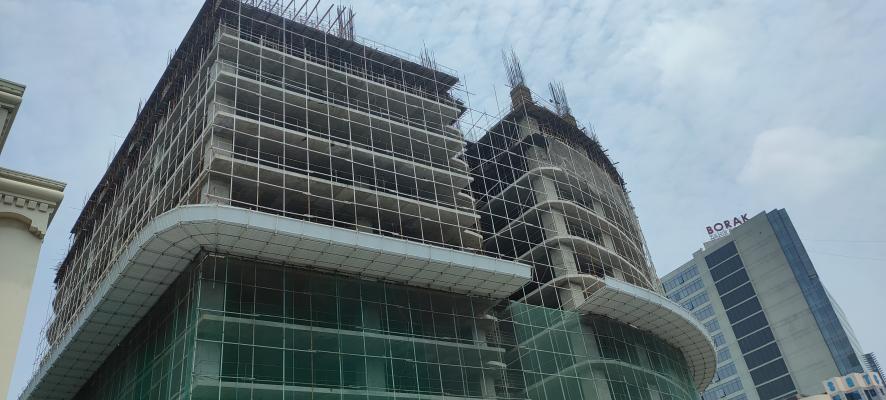

on 12-06-21
on 12-06-21

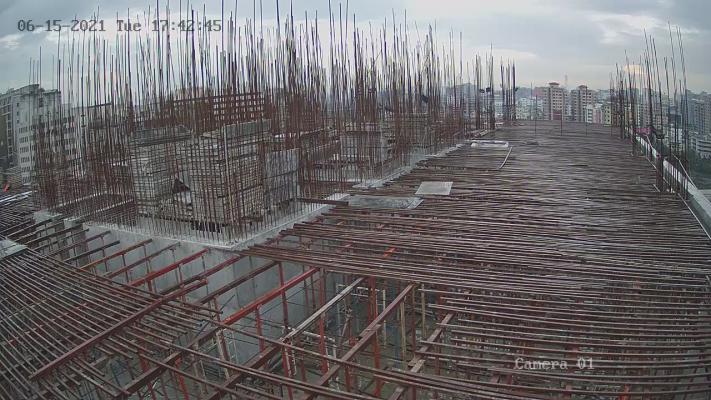

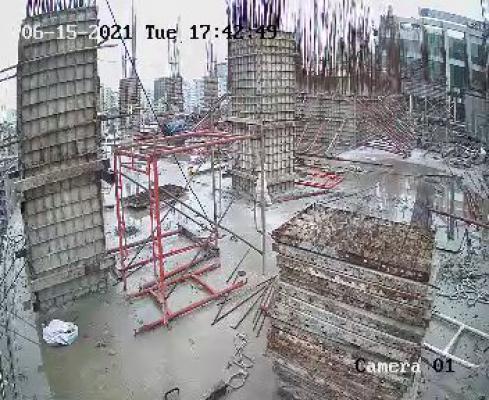

on 15-06-21
on 15-06-21

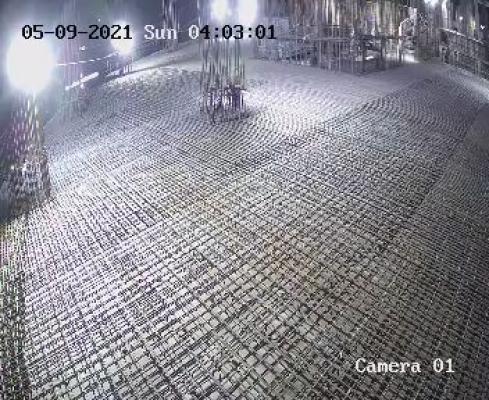

South Tower 11th Floor Slab Concreting on 2-09-21
South Tower 11th Floor Slab Concreting on 2-09-21
