TOTAL PROGRES REPORT |
From 18-September-2020 to 21-February-2022 | ||||
Project Code: | 58 | Name: | The View Hotel Kuakata | |
Client: | Sikder Group | Contractor: |
Total Duration: | 521 | days | Total Working Days: | 73 | Total Manpower: | 6905 | |||
Planning Progress = 92.7% | Acual Progress = 87.1% | SPI: 0.94 | Behind Schedule | ||||||
WBS | Work Description | ||||||||
Total Quantity | Total Done | Schedule Start | Schedule Finish | Actual Start | Actual Finish | Lead-Lag(day) | Not Yet | ||
1.1.01 | Take-over Site for Construction | 100% | 18-09-20 | 18-09-20 | 18-09-20 | 18-09-20 | 0 | ||
2.1.01 | Tower-1-Pile Work | 301nos | 100% | 19-09-20 | 07-11-20 | 05-11-20 | 06-11-20 | 1 | |
2.1.02 | Tower-1-Pile Cap | 26nos | 100% | 22-10-20 | 18-12-20 | 05-11-20 | 18-12-20 | 0 | |
2.1.03 | Tower-1-Padestal | 31nos | 100% | 07-11-20 | 23-12-20 | 28-11-20 | 21-12-20 | 2 | |
2.1.04 | Tower-1-Lift Core Below GB | 2nos | 100% | 12-12-20 | 23-12-20 | 09-12-20 | 21-12-20 | 2 | |
2.1.05 | Tower-1-Grade Beam | 421rm | 100% | 09-12-20 | 30-12-20 | 30-11-20 | 27-01-21 | -28 | |
2.2.01.1 | Tower-1-GF Column | 31nos | 100% | 24-12-20 | 04-01-21 | 09-12-20 | 27-01-21 | -23 | |
2.2.01.2 | Tower-1-GF-Lift Core | 2nos | 100% | 24-12-20 | 04-01-21 | 21-12-20 | 27-01-21 | -23 | |
2.2.01.3 | Tower-1-GF-Stair | 2nos | 100% | 24-12-20 | 15-01-21 | 21-12-20 | 27-01-21 | -12 | |
2.2.01.4 | Tower-1-1st Floor Slab | 1505m2 | 100% | 10-01-21 | 20-01-21 | 15-12-20 | 0 | ||
2.2.02.1 | Tower-1-1st Floor Column | 31nos | 100% | 22-01-21 | 31-01-21 | 27-12-20 | 07-02-21 | -7 | |
2.2.02.2 | Tower-1-1st Floor Lift Core | 2nos | 100% | 02-02-21 | 07-02-21 | 05-02-21 | 07-02-21 | 0 | |
2.2.02.3 | Tower-1-1st Floor Stair | 2nos | 100% | 22-01-21 | 18-02-21 | 05-02-21 | 10-02-21 | 8 | |
2.2.02.4 | Tower-1-2nd Floor Slab | 1672m2 | 100% | 08-02-21 | 18-02-21 | 08-01-21 | 0 | ||
2.2.03.1 | Tower-1-2nd Floor Column | 31nos | 100% | 19-02-21 | 01-03-21 | 05-02-21 | 23-02-21 | 6 | |
2.2.03.4 | Tower-1-3rd Floor Slab | 1672m2 | 100% | 01-03-21 | 11-03-21 | 16-02-21 | 28-02-21 | 11 | |
2.2.04.1 | Tower-1-3rd Floor Column | 31nos | 100% | 12-03-21 | 22-03-21 | 28-02-21 | 25-03-21 | -3 | |
2.2.04.2 | Tower-1-3rd Floor Lift Core | 2nos | 100% | 12-03-21 | 22-03-21 | 11-03-21 | 25-03-21 | -3 | |
2.2.04.3 | Tower-1-3rd Floor Stair | 2nos | 100% | 12-03-21 | 02-04-21 | 11-03-21 | 01-04-21 | 1 | |
2.2.04.4 | Tower-1-4th Floor Slab | 1672m2 | 100% | 23-03-21 | 02-04-21 | 11-03-21 | 01-04-21 | 1 | |
2.2.05.1 | Tower-1-4th Floor-Column | 31nos | 50% | 03-04-21 | 13-04-21 | 22-06-21 | 22-06-21 | -70 | Completed |
2.2.05.2 | Tower-1-4th Floor-Lift Core | 2nos | % | 03-04-21 | 13-04-21 | 0 | Started | ||
2.2.05.3 | Tower-1-4th Floor-Stair | 2nos | % | 03-04-21 | 24-04-21 | 0 | Started | ||
2.2.05.4 | Tower-1-4th Floor-Roof Beam n Slab | 1672m2 | 7% | 14-04-21 | 24-04-21 | 22-06-21 | 22-06-21 | -59 | Completed |
3.1.01 | Tower-2-Pile Boring | 156nos | 100% | 08-11-20 | 12-12-20 | 12-11-20 | 12-12-20 | 0 | |
3.1.02 | Tower-2-Pile Cap | 17nos | 100% | 21-12-20 | 06-02-21 | 21-12-20 | 05-02-21 | 1 | |
3.1.03 | Tower-2-Short Column | 17nos | 100% | 18-01-21 | 13-02-21 | 18-01-21 | 10-02-21 | 3 | |
3.1.04 | Tower-2-Lift Core below Grade Beam | 1nos | 100% | 02-02-21 | 13-02-21 | 10-02-21 | 10-02-21 | 3 | |
3.1.05 | Tower-2-Grade Beam | 192m | 100% | 03-02-21 | 05-03-21 | 23-02-21 | 02-03-21 | 3 | |
3.2.01.1 | Tower-2-GF Column | 17nos | 100% | 05-04-21 | 15-05-21 | 13-03-21 | 25-03-21 | 51 | |
3.2.01.2 | Tower-2-GF Lift Core | 1nos | 100% | 09-04-21 | 15-04-21 | 13-03-21 | 25-03-21 | 21 | |
3.2.01.3 | Tower-2-GF Stair | 1nos | 100% | 09-04-21 | 26-04-21 | 25-03-21 | 19-04-21 | 7 | |
3.2.01.4 | Tower-2-1st Floor Slab | 929m2 | 100% | 16-04-21 | 26-04-21 | 12-04-21 | 19-04-21 | 7 | |
3.2.02.1 | Tower-2-1st Floor-Column | 17nos | 100% | 27-04-21 | 07-05-21 | 28-04-21 | 26-09-21 | -142 | |
3.2.02.2 | Tower-2-1st Floor-Lift Core | 1nos | 100% | 01-05-21 | 07-05-21 | 29-04-21 | 26-09-21 | -142 | |
3.2.02.3 | Tower-2-1st Floor-Stair | 1nos | 100% | 01-05-21 | 28-05-21 | 04-05-21 | 21-09-21 | -116 | |
3.2.02.4 | Tower-2-2nd Floor-Slab | 1115m2 | 100% | 08-05-21 | 28-05-21 | 29-04-21 | 26-09-21 | -121 | |
3.2.03.1 | Tower-2-2nd Floor-Column | 17nos | 65% | 02-10-21 | 12-10-21 | 30-09-21 | 21-02-22 | -132 | Completed |
3.2.03.2 | Tower-2-2nd Floor-Lift core | 1no. | 0% | 06-10-21 | 12-10-21 | 0 | Started | ||
3.2.03.3 | Tower-2-2nd Floor-Stair | 1no. | 0% | 16-10-21 | 02-11-21 | 0 | Started | ||
3.2.03.4 | Tower-2-3rd Floor Slab | 929m2 | 30% | 23-10-21 | 02-11-21 | 28-10-21 | 08-01-22 | -67 | Completed |
4.1 | Porch-Short Column | nos | 100% | 21-01-21 | 29-01-21 | 27-01-21 | 27-01-21 | 2 | |
4.2 | Porch-Grade Beam | m | 100% | 15-01-21 | 05-02-21 | 27-01-21 | 27-01-21 | 9 | |
4.3 | Porch-Column | nos | 100% | 30-01-21 | 10-02-21 | 27-01-21 | 05-02-21 | 5 | |
4.4 | Porch-Beam and Slab | 107m2 | 100% | 11-02-21 | 18-02-21 | 07-02-21 | 07-02-21 | 11 | |
5.01.1 | Restaurant-GF Double Height Column | 12nos | 100% | 28-02-21 | 10-03-21 | 28-02-21 | 25-03-21 | -15 | |
5.01.2 | Restaurant-Porch Slab | 223m2 | 100% | 25-02-21 | 10-03-21 | 02-03-21 | 02-03-21 | 8 | |
5.01.3 | Restaurant-GF Double Height Roof Sl | 557m2 | 100% | 03-03-21 | 31-03-21 | 23-03-21 | 24-04-21 | -24 | |
5.02.1 | Restaurant-2nd Floor-Column | 12nos | 100% | 01-04-21 | 11-04-21 | 19-04-21 | 16-06-21 | -66 | |
5.02.2 | Restaurant-2nd Floor-Roof Slab | 836m2 | 67% | 04-04-21 | 02-05-21 | 24-04-21 | 16-06-21 | -45 | Completed |
6.1 | Between Tower1-2-Short Column | nos | 100% | 09-03-21 | 15-03-21 | 13-03-21 | 13-03-21 | 2 | |
6.2 | Between Tower1-2-Grade Beam | m | 100% | 16-03-21 | 29-03-21 | 25-03-21 | 25-03-21 | 4 | |
6.3 | Between Tower1-2-Column | nos | 100% | 30-03-21 | 12-04-21 | 11-04-21 | 11-04-21 | 1 | |
6.4 | Between Tower1-2-GF Roof Slab | 372m2 | 100% | 13-04-21 | 26-04-21 | 26-04-21 | 26-04-21 | 0 | |
6.5 | Between Tower-1-2-1st Flr Roof Slab | 372m2 | 100% | 27-04-21 | 10-05-21 | 05-06-21 | 05-06-21 | -26 | |
7.1 | East Side Soak Well Slab | 1no. | 100% | 10-01-22 | 27-01-22 | 27-01-22 | 27-01-22 | 0 | |

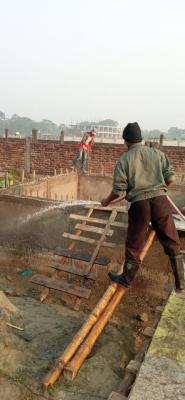

7.2 | West Side Septic Tank | 1no. | 25% | 12-01-22 | 10-02-22 | 27-01-22 | 31-01-22 | 10 | Completed |
7.3 | East Side Septic Tank | 1no. | 30% | 21-01-22 | 19-02-22 | 27-01-22 | 10-02-22 | 9 | Completed |
Site Photographs | |
![]() |
|

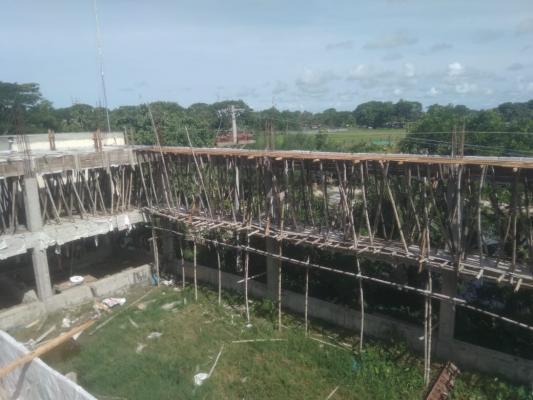

on 18-09-20 | |
![]() |
|
on 18-09-20 | |
![]() |
|

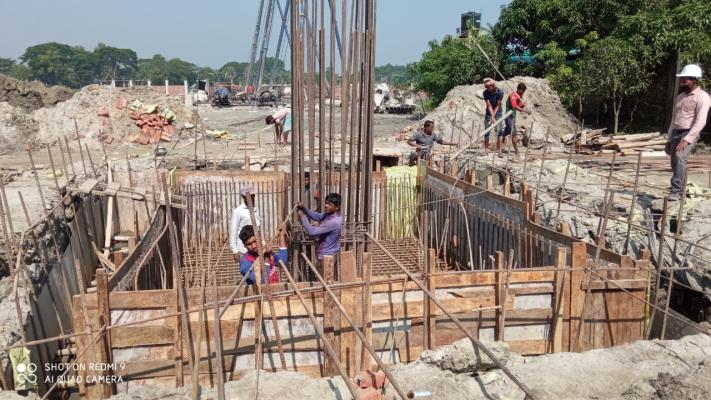

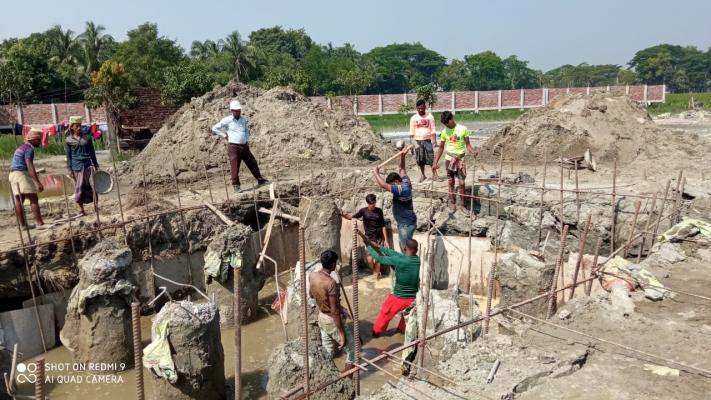

on 6-11-20 | |
![]() |
|
on 6-11-20 | |
![]() |
|

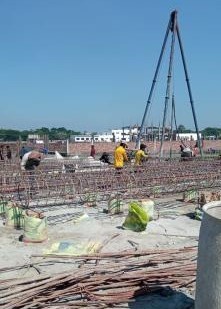

Tower-1 Pile Cap on 12-11-20 | |
![]() |
|
Tower-2-Pile Work on 12-11-20 | |
![]() |
|
Tower-2-Piling Work on 28-11-20 | |
![]() |
|

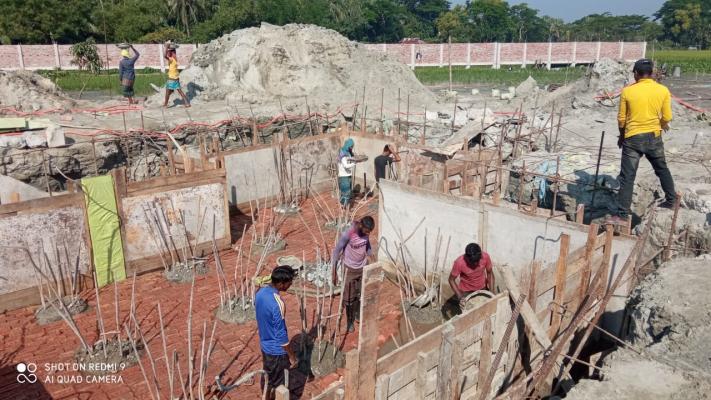

Tower-1-Pile Cap Work on 28-11-20 | |
![]() |
|

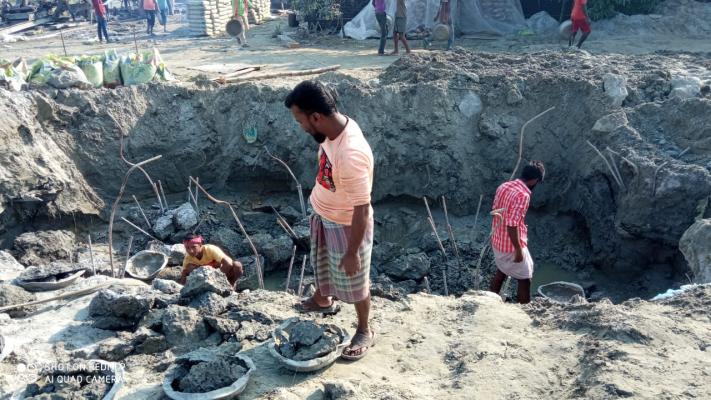

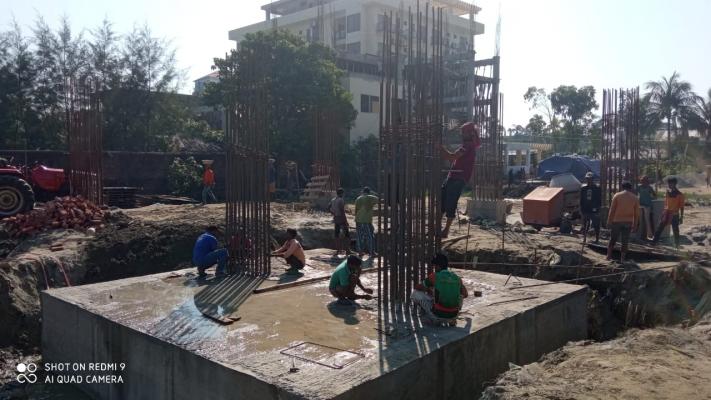

Tower-1 Pile Cap on 30-11-20 | |
![]() |
|

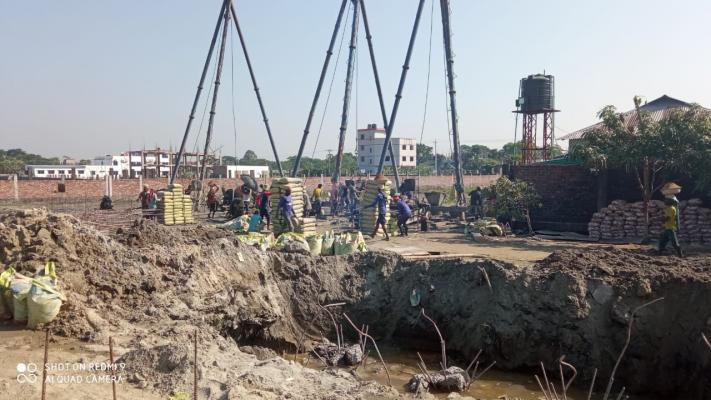

Tower-1-Pilehead breaking on 30-11-20 | |
![]() |
|
Tower-1-Grade Beam on 4-12-20 | |
![]() |
|

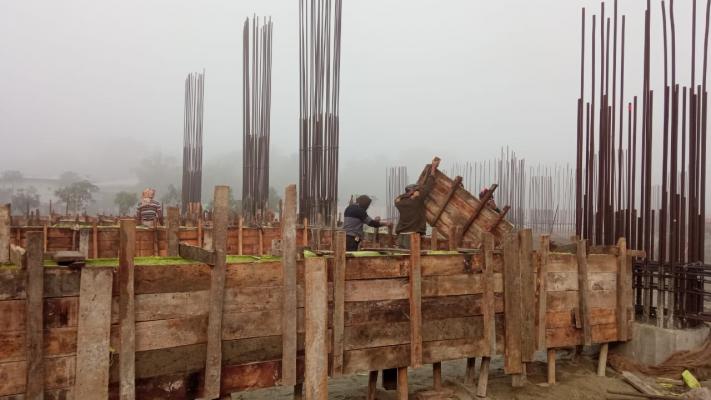

Tower-2-Pile Work on 4-12-20 | |
![]() |
|

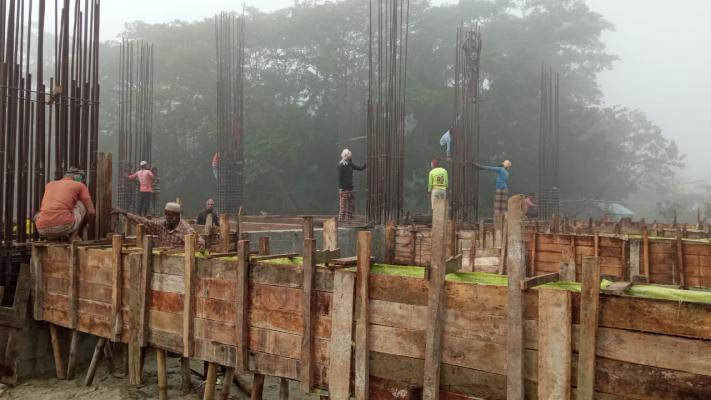

Column Work on 7-12-20 | |
![]() |
|

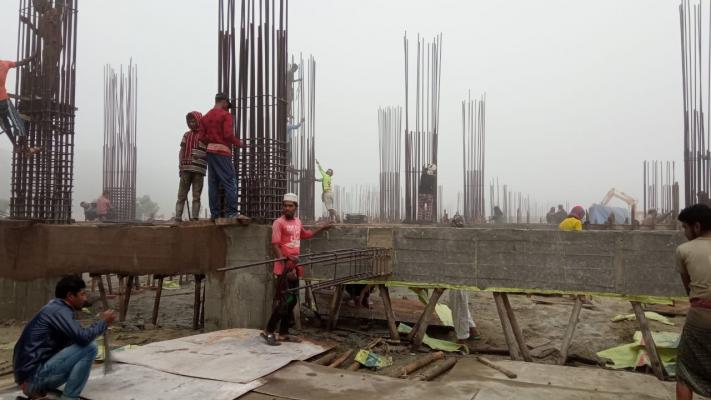

Tower-1 Grade Beam on 7-12-20 | |
![]() |
|

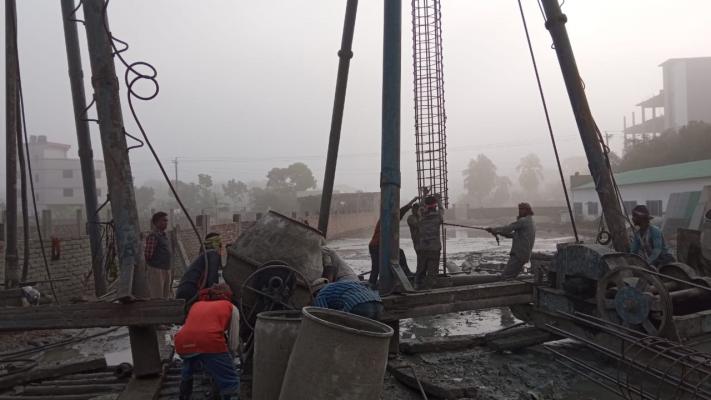

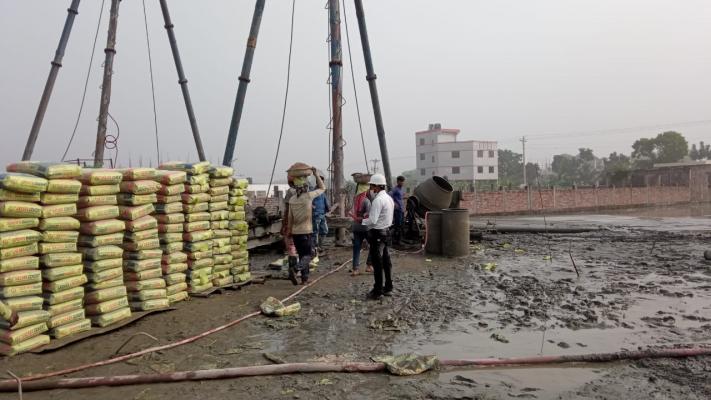

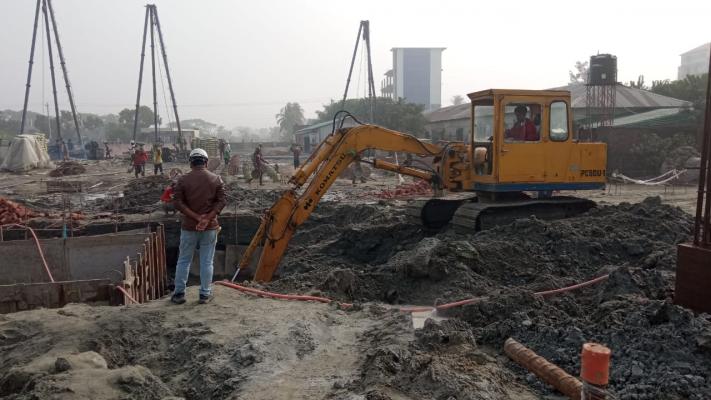

Tower-1-Excavation for Pile Cap on 9-12-20 | |
![]() |
|
Tower-2-Pile Work on 9-12-20 | |
![]() |
|

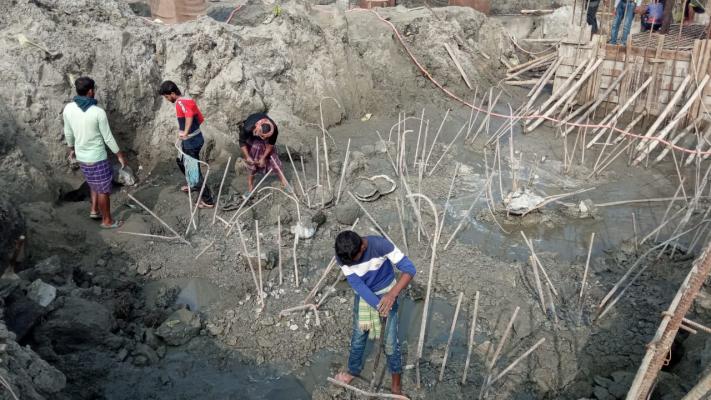

Tower-1-Pile Cap Re-bar Fabrication on 12-12-20 | |
![]() |
|
Tower-1-Pilecap Concreting on 12-12-20 | |
![]() |
|

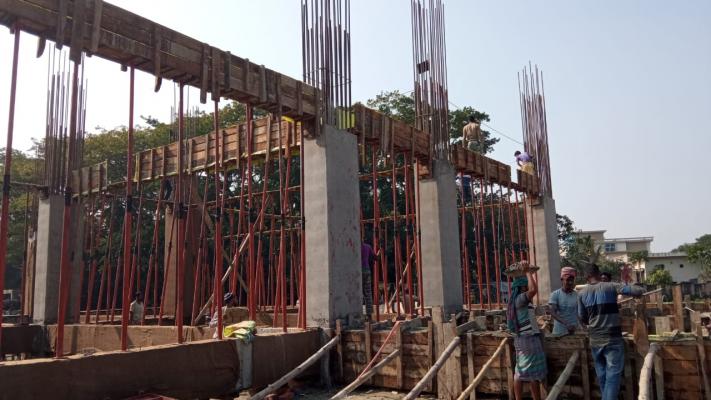

Tower-1-Coliumn Re-bar work on 15-12-20 | |
![]() |
|
Tower-1-GF Beam Shuttering on 15-12-20 | |
![]() |
|

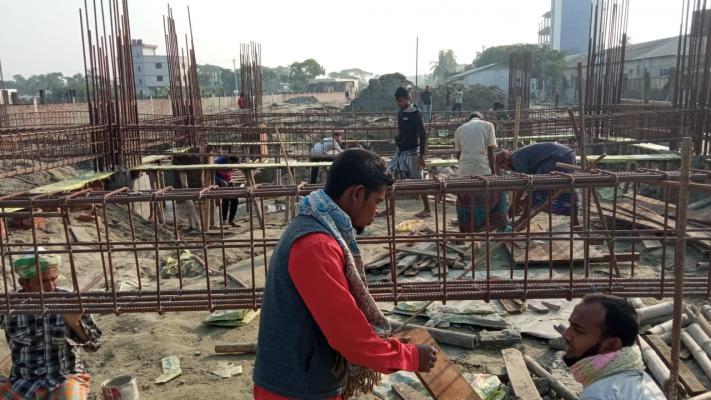

Tower-1-Grade Beam Re-bar Fabrication on 18-12-20 | |
![]() |
|
Tower-1-GF Beam Shuttering on 18-12-20 | |
![]() |
|

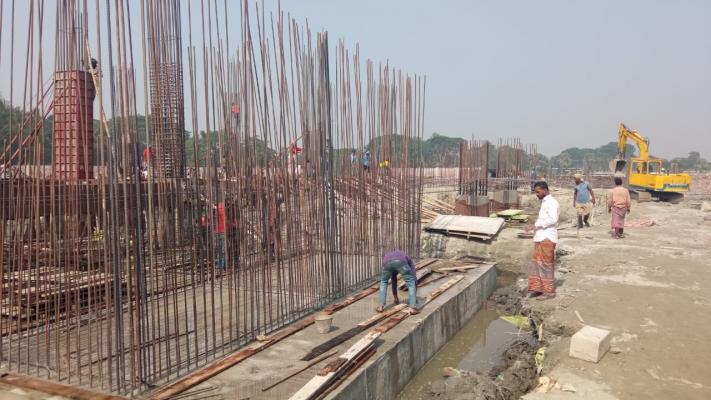

Tower-1-Lift Core Re-bar Work on 20-12-20 | |
![]() |
|
Tower-1-GF Slab Re-bar Work on 20-12-20 | |
![]() |
|

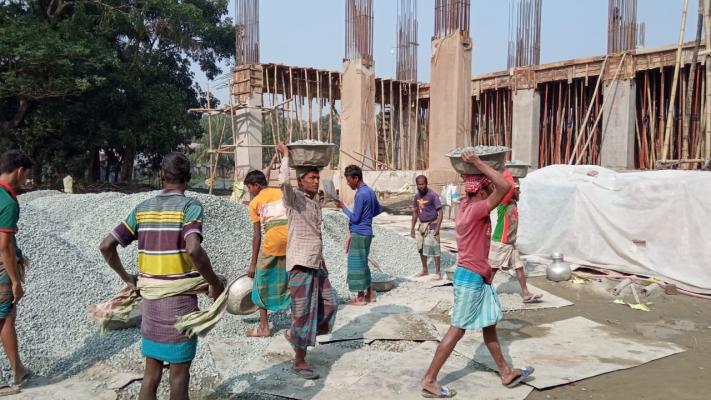

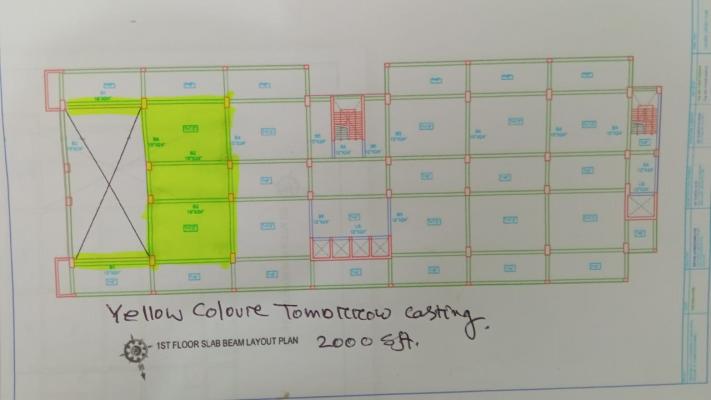

Tower-1-GF Roof Slab-2000 sft Concreting on 21-12-20 | |
![]() |
|
Tower-1-GF Roof Slab Concreting on 21-12-20 | |
![]() |
|

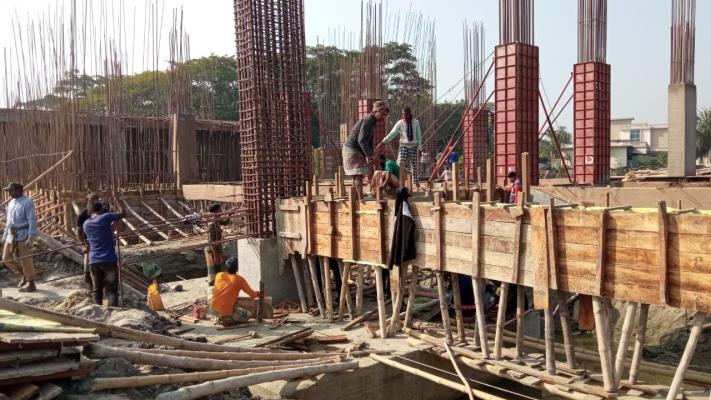

Tower-1-Grade Beam Shuttering on 24-12-20 | |
![]() |
|

Tower-2-Excavation for Pile Head Breakin on 24-12-20 | |
![]() |
|

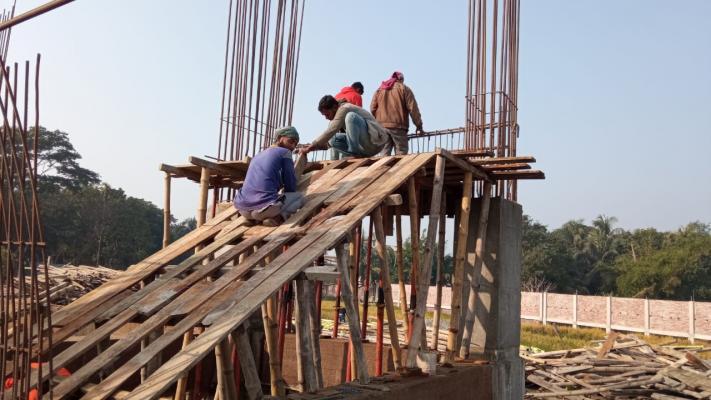

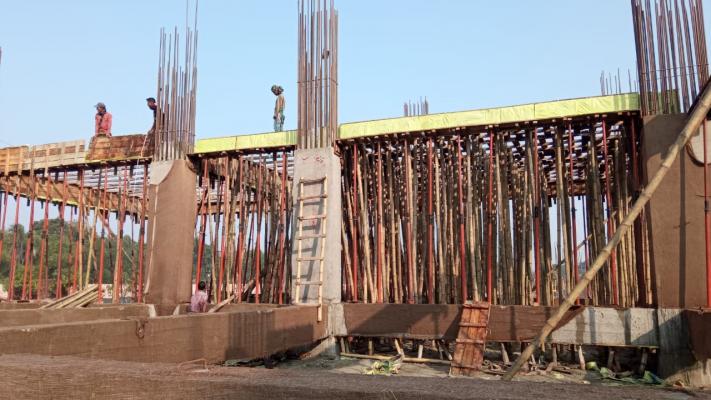

Tower-1-GF Stair Shuttering on 27-12-20 | |
![]() |
|
Tower-2-Pile Head Breaking on 27-12-20 | |
![]() |
|

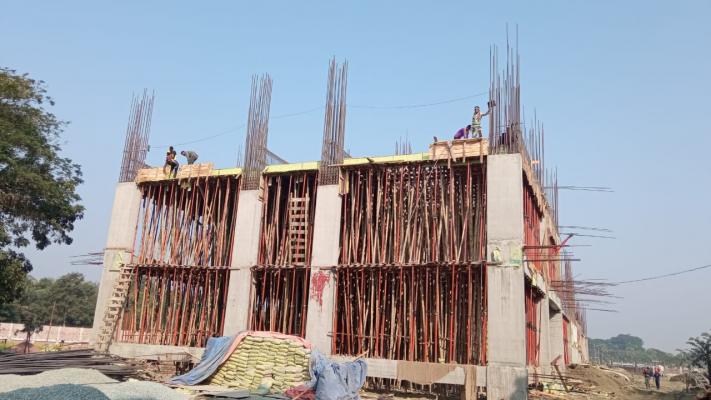

Tower-1-1st Floor Roof Slab Shuttering on 8-01-21 | |
![]() |
|

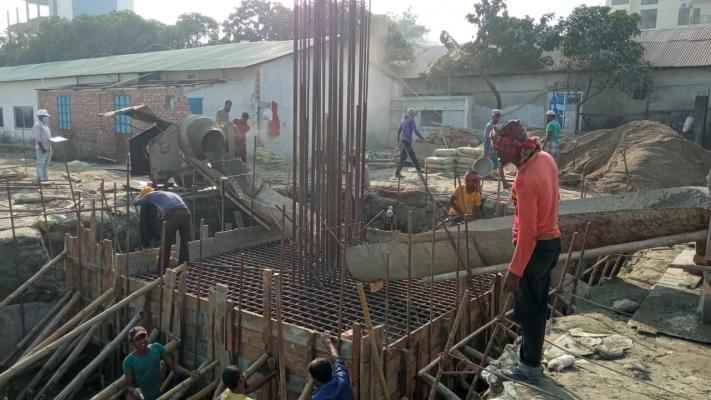

Tower-2-Pile Cap Concreting on 8-01-21 | |
![]() |
|

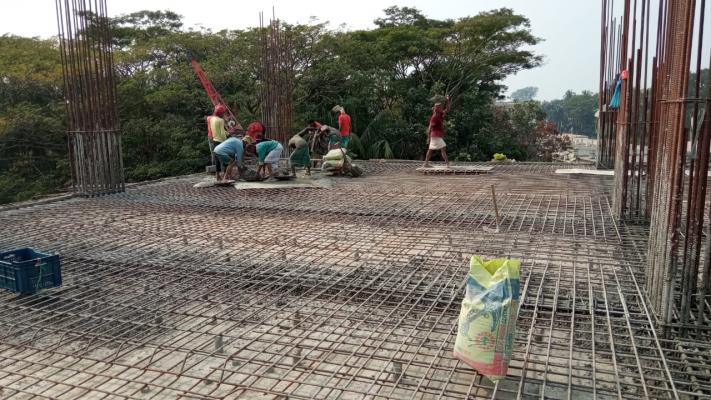

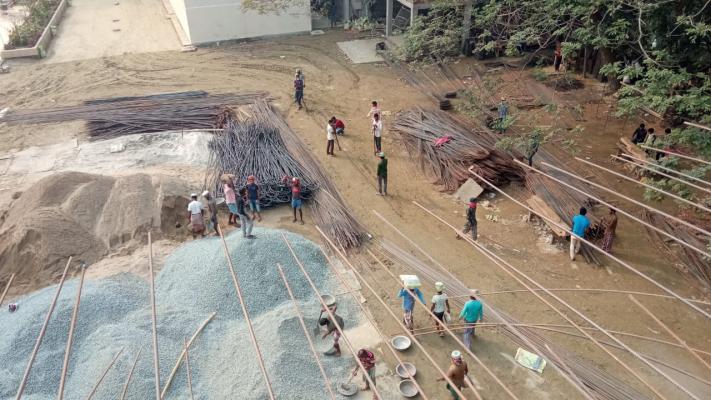

Tower-1-1st Floor Roof Slab 3600 sft Co on 11-01-21 | |
![]() |
|
Tower-1-1st Floor Roof Slab Concreting on 11-01-21 | |
![]() |
|

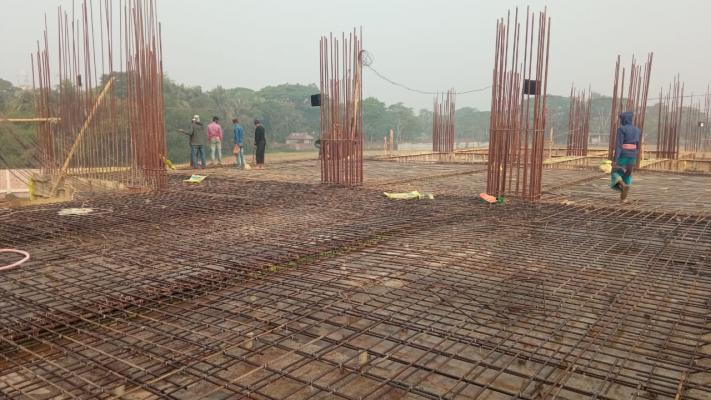

Tower-1-GF Roof Slab-3600sft Concreting on 16-01-21 | |
![]() |
|
Tower-1-GF Roof Slab Concreting on 16-01-21 | |
![]() |
|

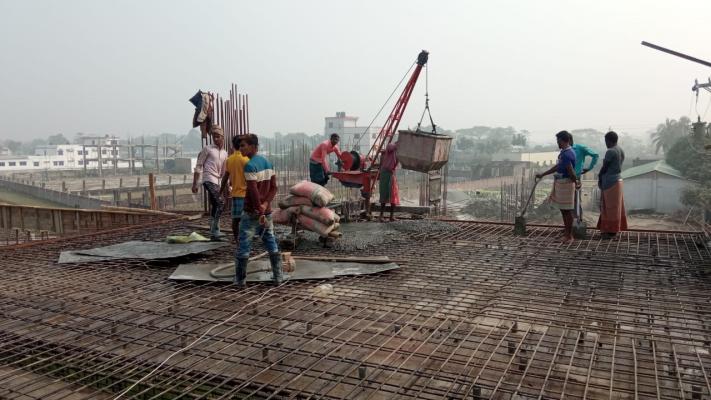

Tower-1-GF Roof Slab 1800 sft Concreting on 18-01-21 | |
![]() |
|

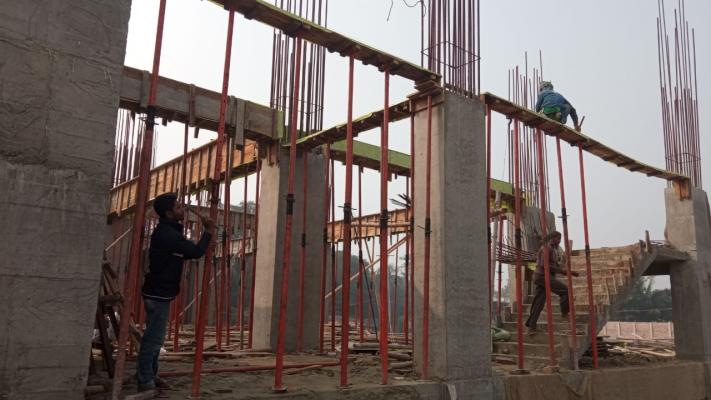

Tower-1-1st Floor Roof Beam Shuttering on 18-01-21 | |
![]() |
|

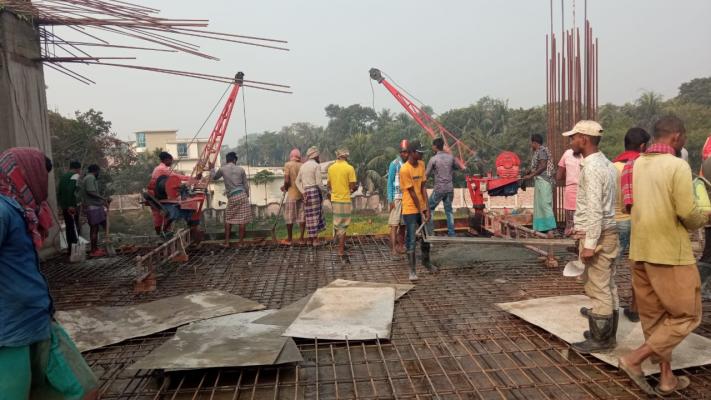

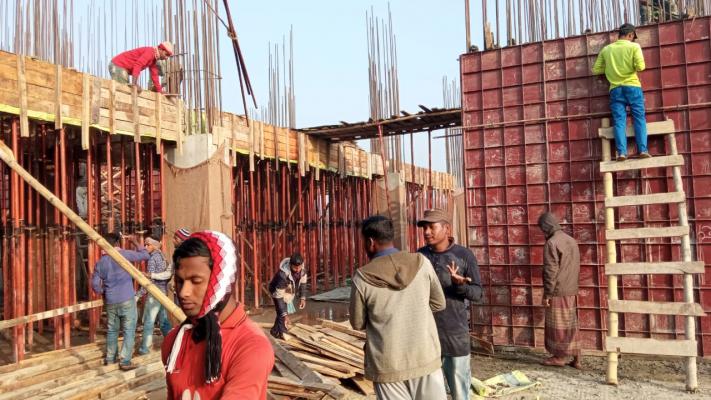

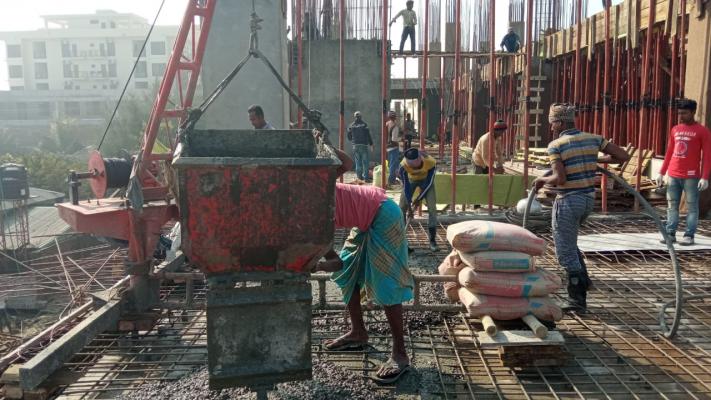

Tower-1-GF Roof Slab-4250sft Concreting on 27-01-21 | |
![]() |
|
Tower-1-Lift Core and Slab Shuttering on 27-01-21 | |
![]() |
|

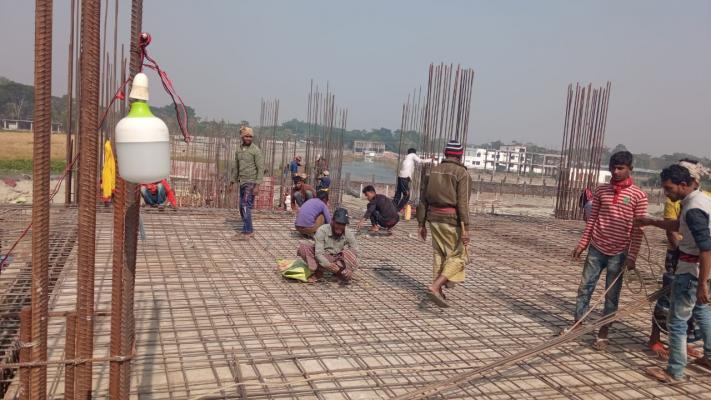

Tower-1-1st Floor Roof Slab 3600 sft Con on 5-02-21 | |
![]() |
|

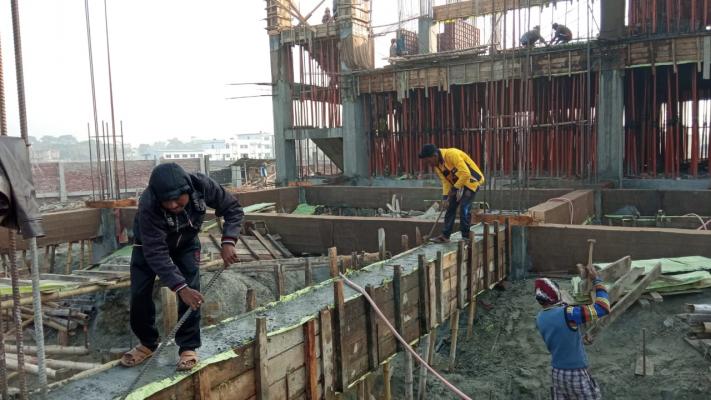

Tower-2-GB Shutter Removing on 5-02-21 | |
![]() |
|

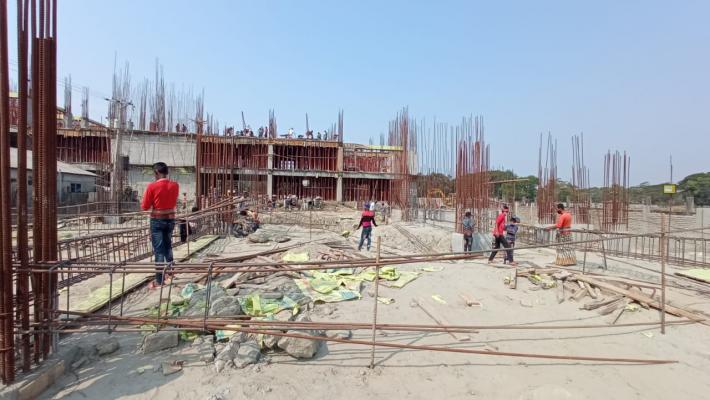

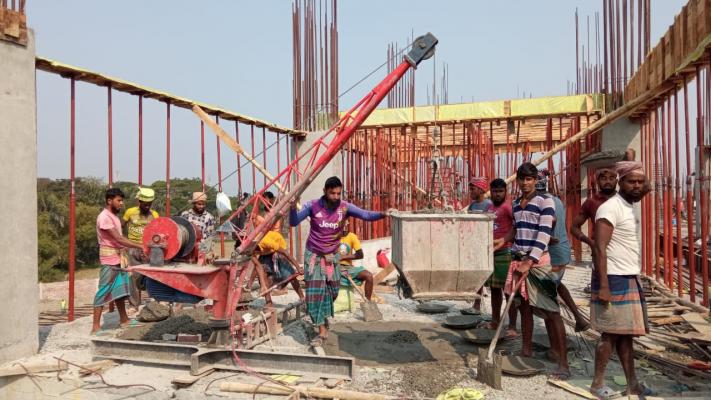

Tower-1-1st Floor Roof Slab 3600 sft Con on 7-02-21 | |
![]() |
|
Tower-1-1st Floor Roof Slab Concreting on 7-02-21 | |
![]() |
|

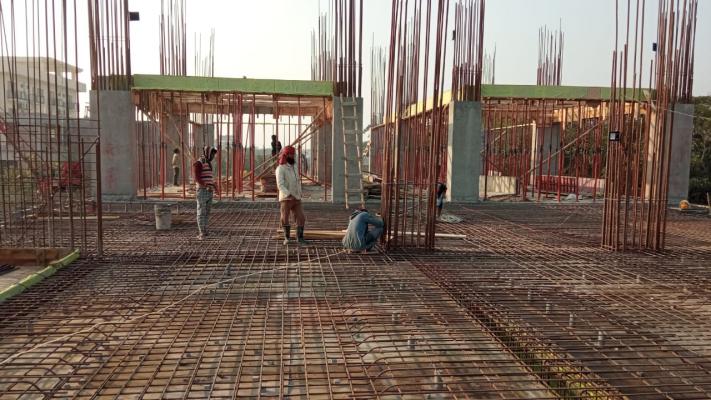

Tower-2-Grade Beam Shuttering on 10-02-21 | |
![]() |
|

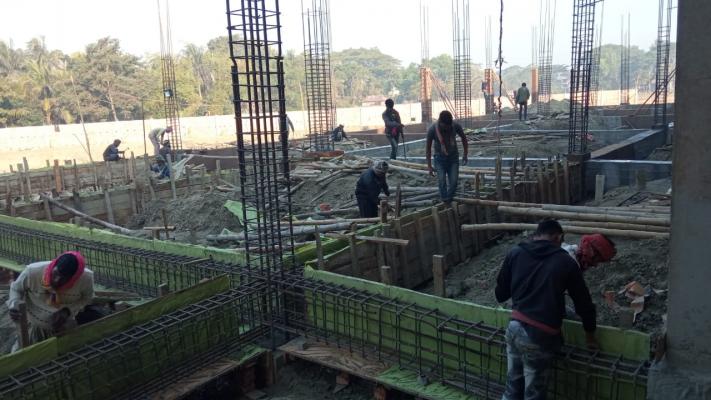

Tower-1-1st floor Roof Slab 2450sft Conc on 10-02-21 | |
![]() |
|

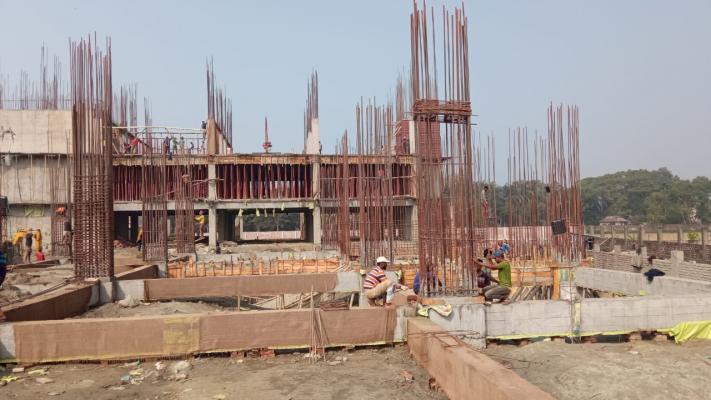

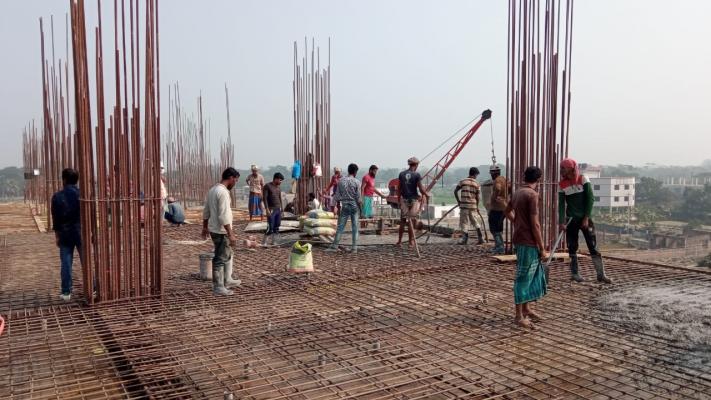

Tower-1-2nd Floor Roof Slab-3600sft Conc on 16-02-21 | |
![]() |
|
Tower-2-Column Re-bar Work on 16-02-21 | |
![]() |
|

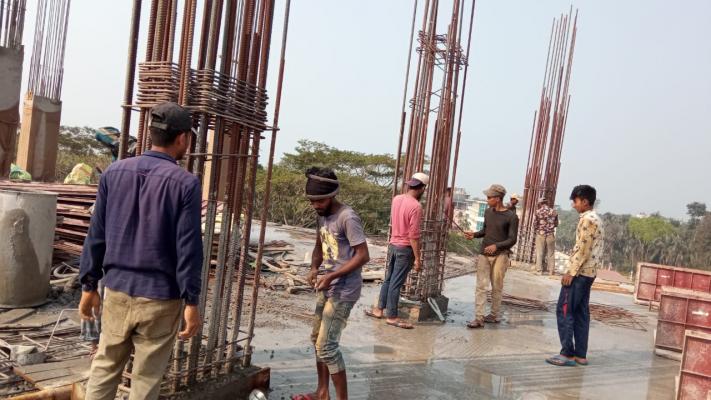

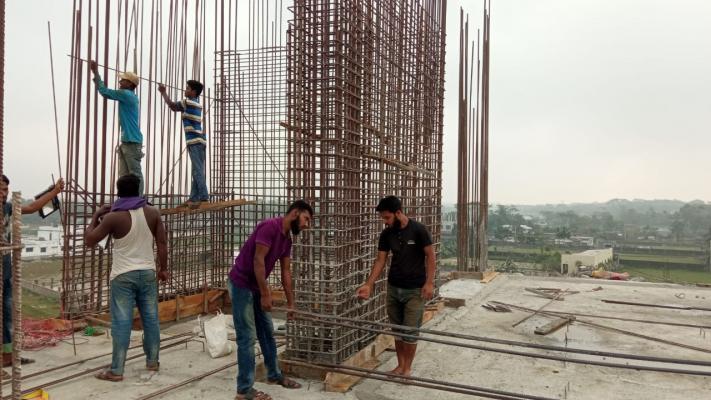

Tower-1-3rd Floor Column Re-bar Work on 23-02-21 | |
![]() |
|

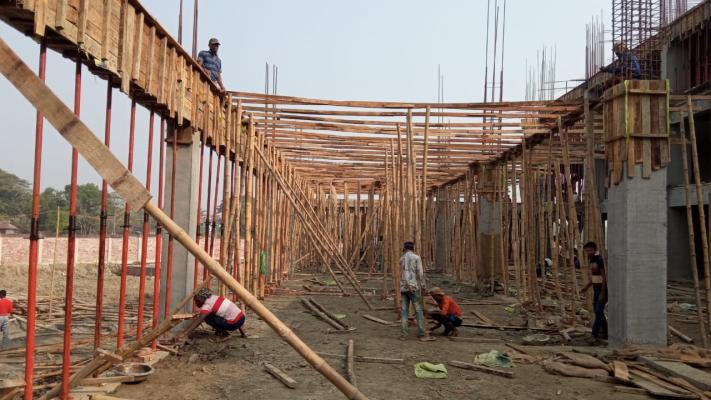

Restaurant Area Slab Shutttering on 23-02-21 | |
![]() |
|

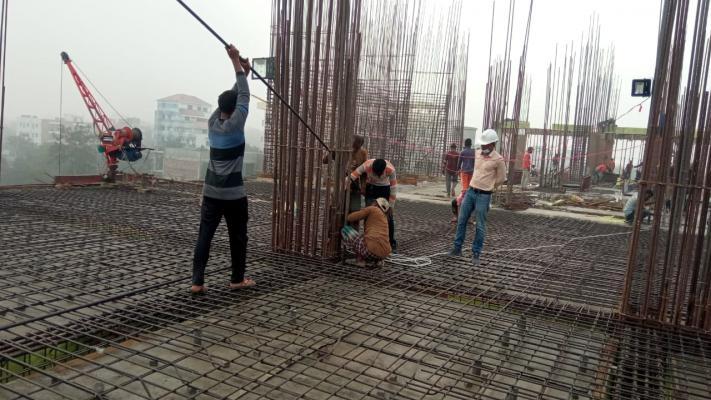

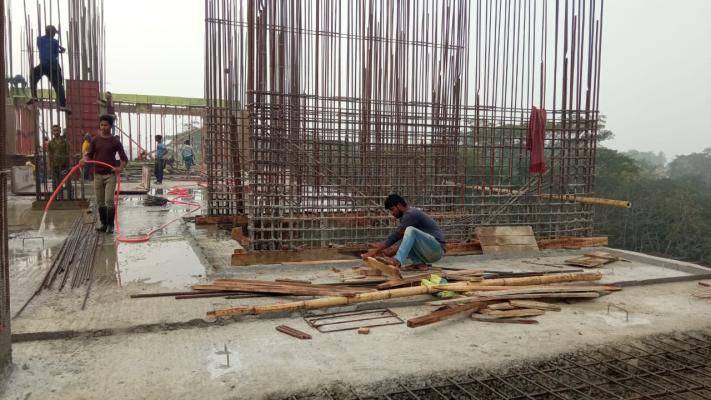

Tower-1-2nd Floor Roof Inspection on 25-02-21 | |
![]() |
|
Tower-1-2nd Floor Roof Curing on 25-02-21 | |
![]() |
|

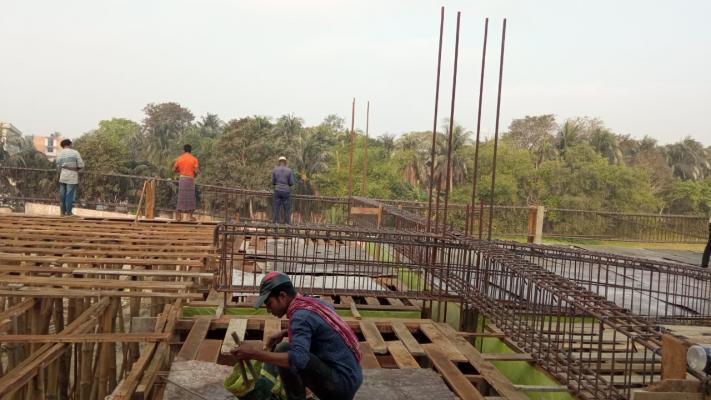

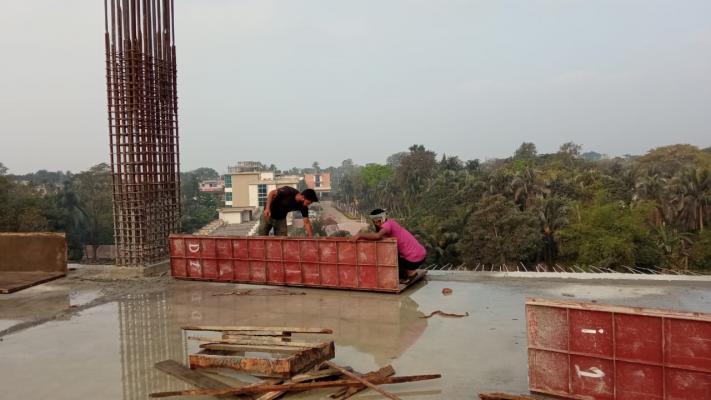

Tower-1-3rd Floor Column Shuttering on 28-02-21 | |
![]() |
|
Resturant Area Slab Shuttering on 28-02-21 | |
![]() |
|

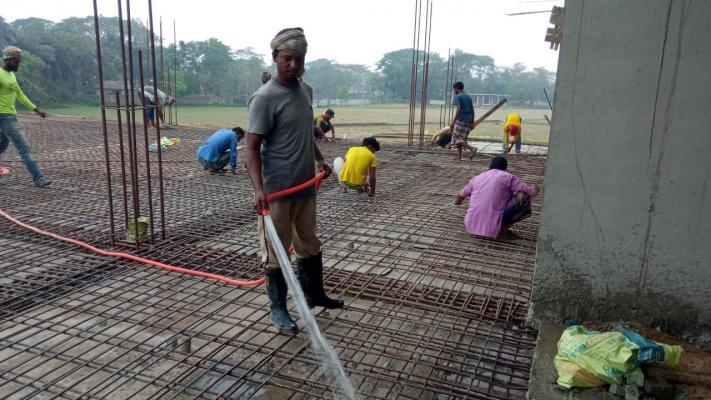

Restaurant-Double Height Slab Concreting on 2-03-21 | |
![]() |
|
Tower-1-3rd Floor Lift Core Re-bar Work on 2-03-21 | |
![]() |
|
Tower-1-3rd Floor Roof Slab Concreting on 11-03-21 | |
![]() |
|

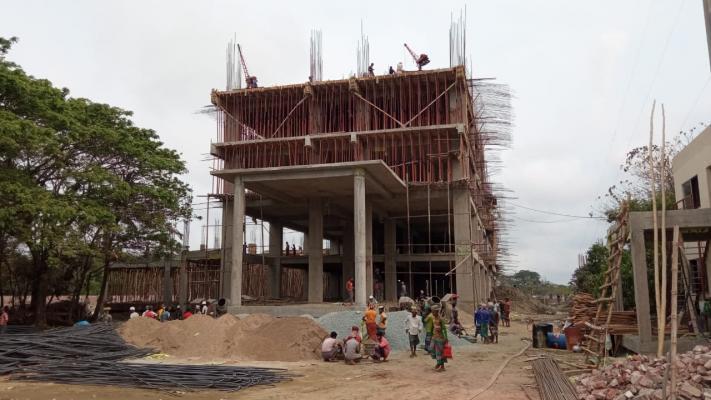

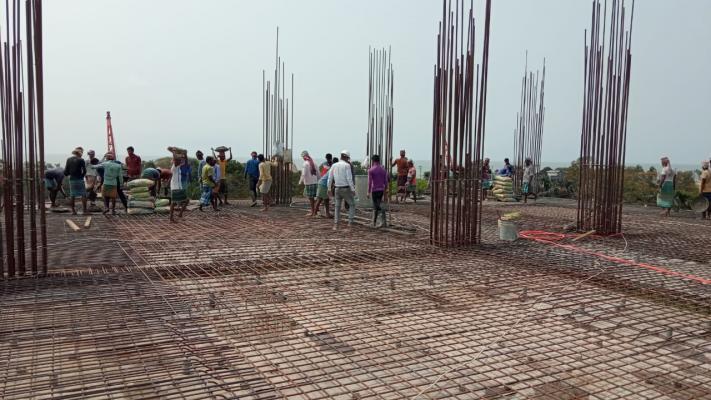

View From South on 11-03-21 | |
![]() |
|

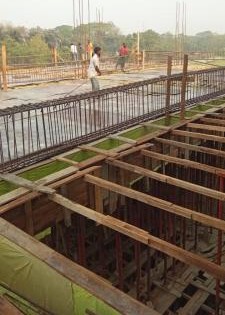

Tower-1-3rd Floor Roof Slab Shuttering on 13-03-21 | |
![]() |
|

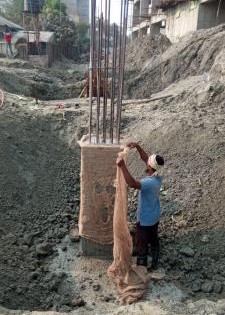

Short Coulmn on 13-03-21 | |
![]() |
|

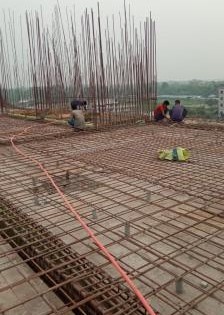

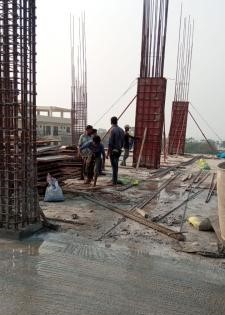

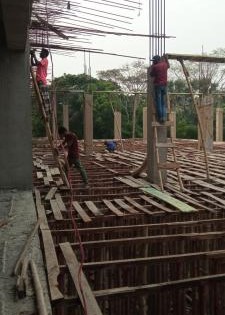

Restaurant GF Double Height Slab-6-9/A-B on 23-03-21 | |
![]() |
|
Tower-1-3rd Floor Roof Slab-Beam Shutter on 23-03-21 | |
![]() |
|

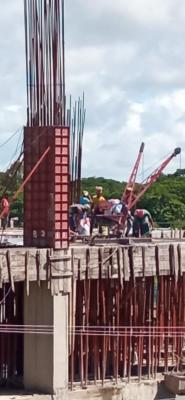

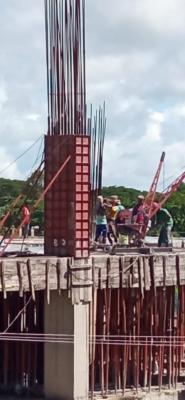

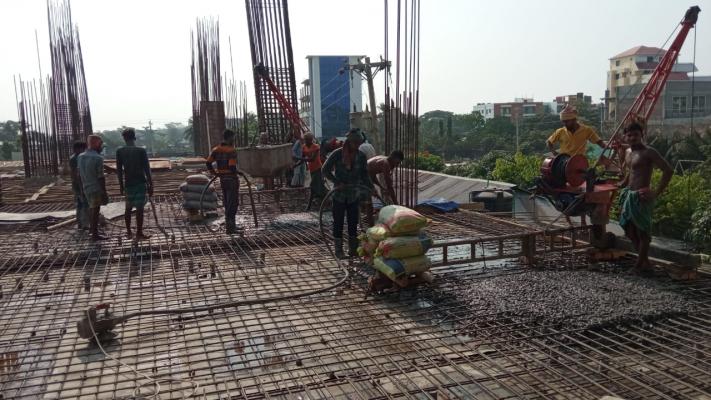

4th Floor Slab(3-5/B-E) Concreting-3600s on 24-03-21 | |
![]() |
|

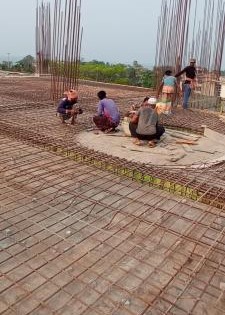

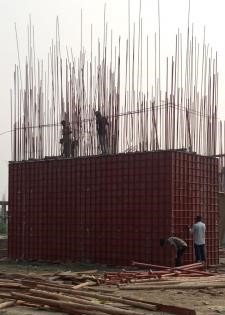

Lift Core Wall Shuttering on 24-03-21 | |
![]() |
|

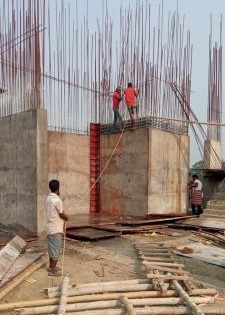

Tower-2: Lift Wall De-shuttering Work on 25-03-21 | |
![]() |
|
Column Shuttering Work on 25-03-21 | |
![]() |
|
Restaurant-GF Double Ht Roof Slab-Re-bar on 30-03-21 | |
![]() |
|

Tower-1-3rd Flr Roof Slab(B-E/5-6)Conret on 30-03-21 | |
![]() |
|
Tower-1-3rd Floor Roof Slab(B-E/6-7)Conc on 31-03-21 | |
![]() |
|
Tower-1-3rd Floor Roof Slab Curing on 31-03-21 | |
![]() |
|
Restaurant-GF Doubl Ht Roof Slab-Re-bar on 1-04-21 | |
![]() |
|

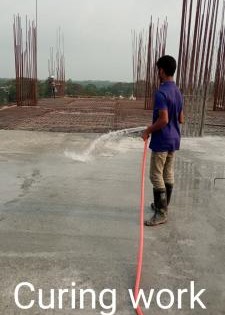

Tower-1-3rd Floor Roof Slab Curing on 1-04-21 | |
![]() |
|

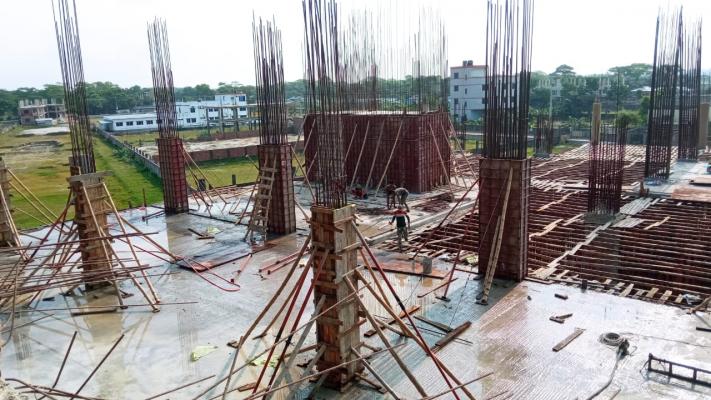

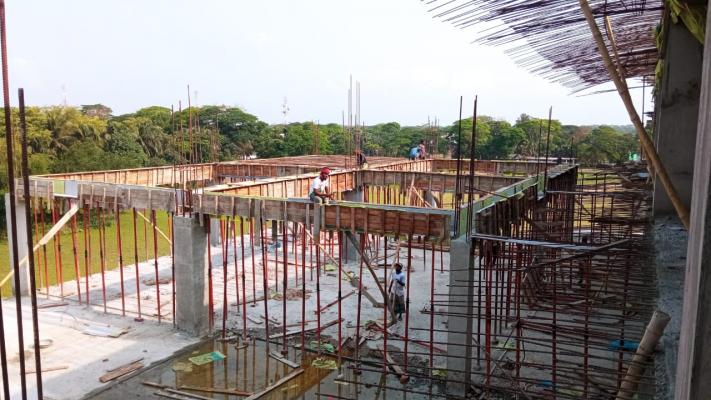

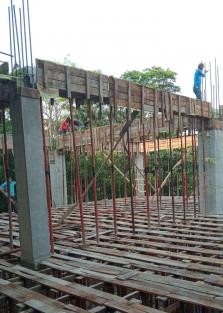

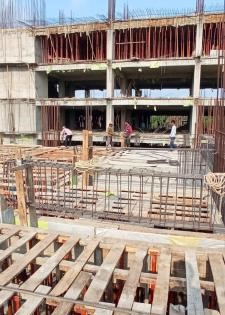

on 11-04-21 | |
![]() |
|
on 11-04-21 | |
![]() |
|

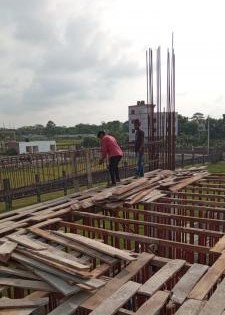

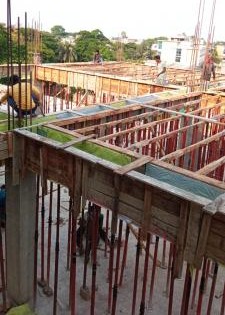

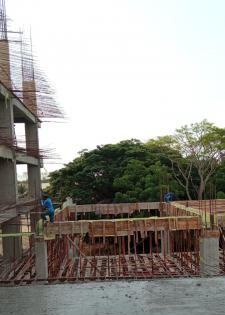

Tower-2-Gr.Flr Roof Slab(5a-6/H-J) Concr on 12-04-21 | |
![]() |
|
on 12-04-21 | |
![]() |
|
on 19-04-21 | |
![]() |
|

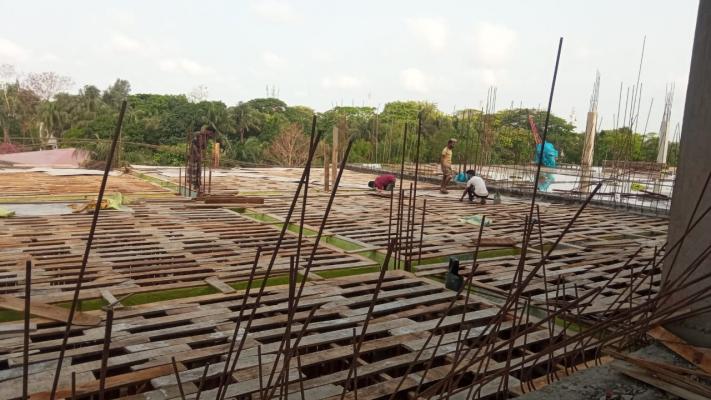

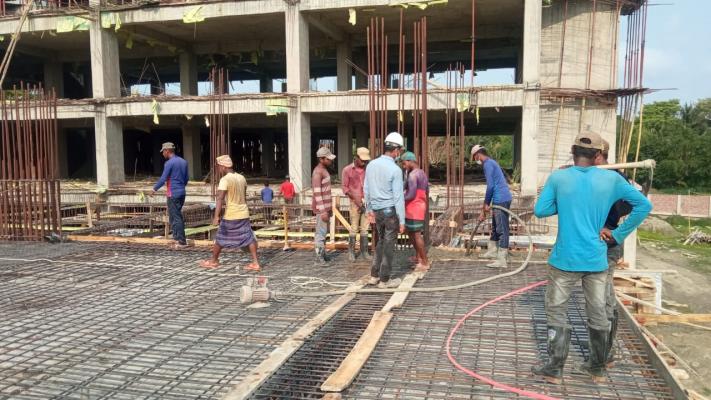

Tower-1-GF Roof Slab(G-I/6-7a)Concreting on 19-04-21 | |
![]() |
|

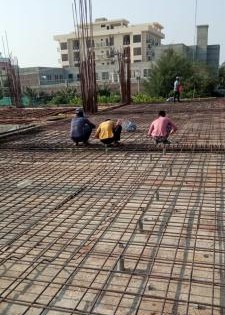

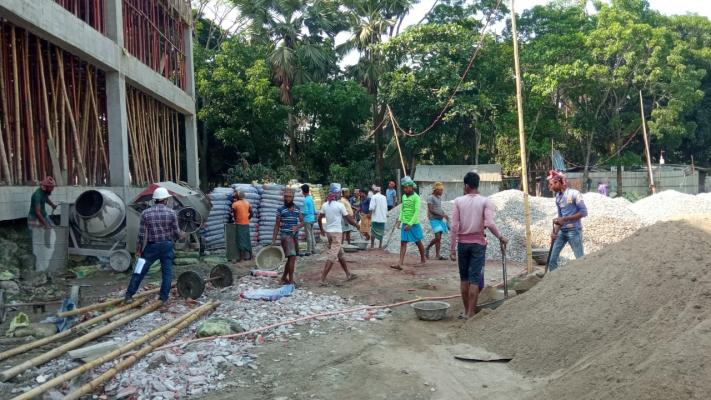

Restaurant GF Doubl Ht Slab-1-4/A-B-Conc on 24-04-21 | |
![]() |
|
on 24-04-21 | |
![]() |
|

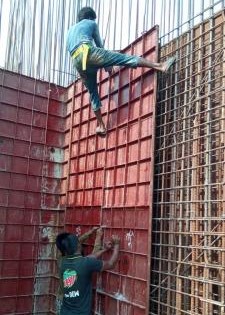

Between Tower1-2-GF Roof Slab-Conreting on 26-04-21 | |
![]() |
|
Lift Core Wall Shuttering on 26-04-21 | |
![]() |
|
Beam Shuttering on 28-04-21 | |
![]() |
|
Column Concreting on 28-04-21 | |
![]() |
|

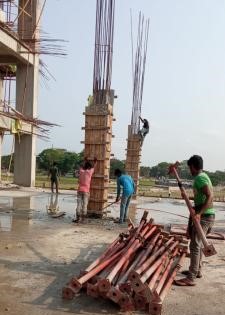

Column Concreting on 29-04-21 | |
![]() |
|
Beam Shuttering on 29-04-21 | |
![]() |
|

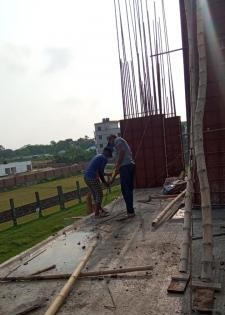

Beam Shuttering Work on 30-04-21 | |
![]() |
|
Column Shuttering Work on 30-04-21 | |
![]() |
|

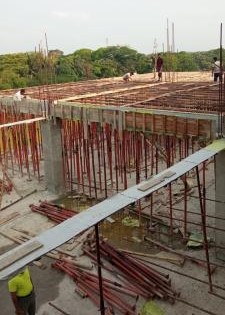

Roof Slab Shuttering on 2-05-21 | |
![]() |
|
Tower-2-Lift Core Deshuttering on 2-05-21 | |
![]() |
|

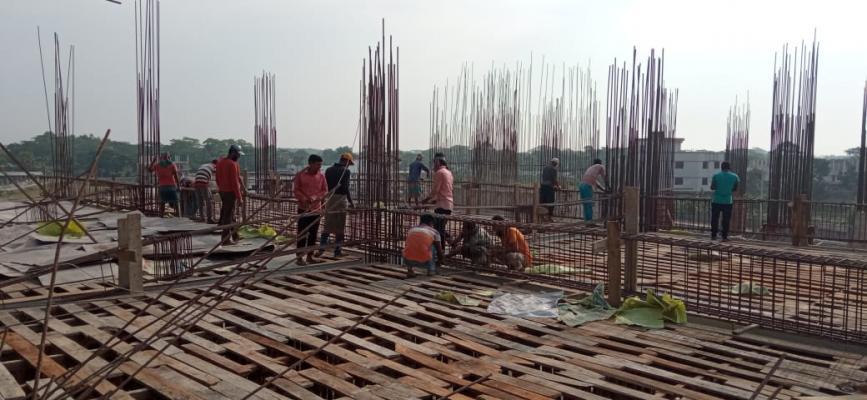

Roof Slab Shuttering on 4-05-21 | |
![]() |
|
Roof Slab Shuttering on 4-05-21 | |
![]() |
|

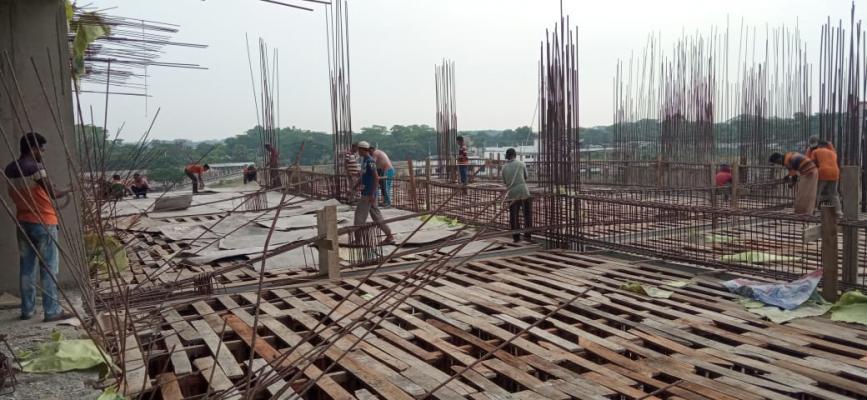

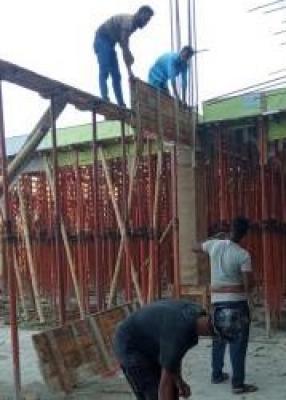

Roof Beam Shuttering on 9-05-21 | |
![]() |
|

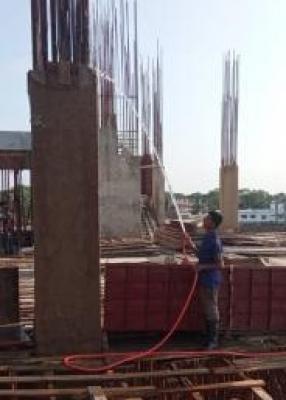

Curing Work on 9-05-21 | |
![]() |
|
Restaurant GF Double Height Roof Slab on 24-05-21 | |
![]() |
|
Roof Slab De-shuttering on 24-05-21 | |
![]() |
|
Slab Shuttering on 31-05-21 | |
![]() |
|
Beam Shuttering on 31-05-21 | |
![]() |
|

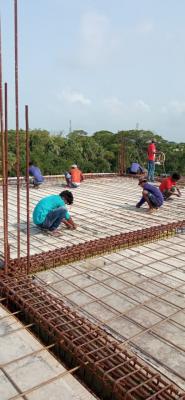

Between Tower1-2-1st Flr Roof Slab-Concr on 5-06-21 | |
![]() |
|
Slab Re-bar Work on 5-06-21 | |
![]() |
|

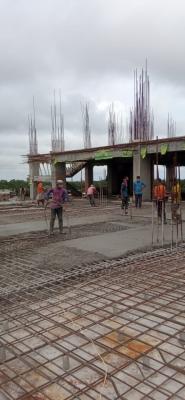

Restaurant-3rd Floor Slab Concreting on 12-06-21 | |
![]() |
|
Restaurant-3rd Floor Slab Re-bar Work on 12-06-21 | |
![]() |
|

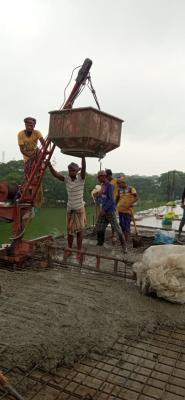

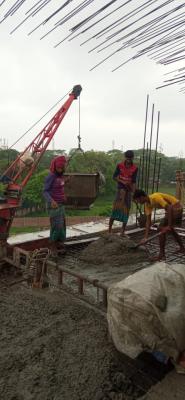

Restaurant-3rd Floor Slab Concreting on 16-06-21 | |
![]() |
|
Restaurant-3rd Floor Slab Concreting on 16-06-21 | |
Grid:1-6/ A"-B=3300 sft | |
![]() |
|

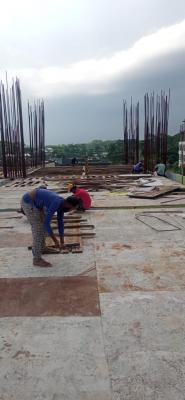

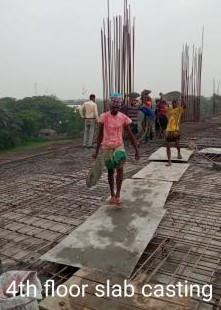

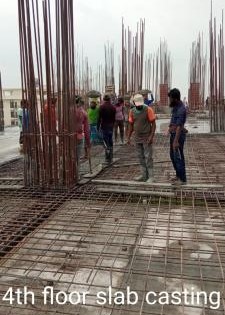

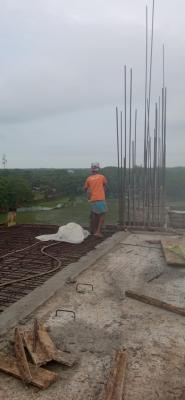

Tower-1-4th Floor Concreting on 22-06-21 | |
![]() |
|
Tower-2-2nd Floor Slab Shuttering on 22-06-21 | |
Grid:5-8=877sft-West Verandhah Concreting | |
![]() |
|

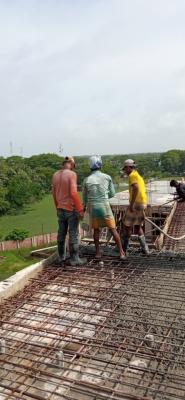

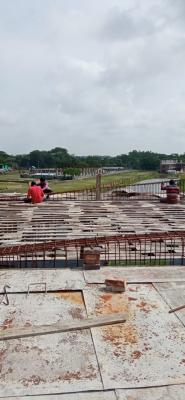

Tower-1-4th Floor Concreting on 26-06-21 | |
![]() |
|
Tower-2-2nd Floor Slab Shuttering on 26-06-21 | |
Grid:1-4/A-B=90sft Slab Concreting | |
![]() |
|

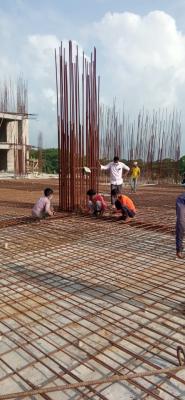

Tower-2:2nd floor slab re-bar work on 4-07-21 | |
![]() |
|

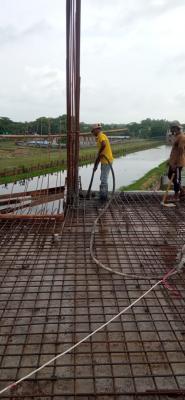

Tower-2:2nd floor slab concreting on 4-07-21 | |
G-I/6-7a: 3300 sft | |
![]() |
|

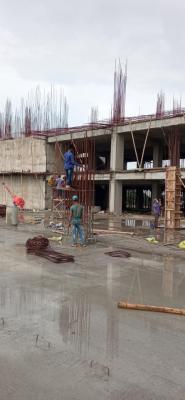

Tower-2:2nd floor slab concreting on 5-07-21 | |
![]() |
|
Tower-2-Column Rod binding-shuttering on 5-07-21 | |
G-I/5a-6: 1500 sft | |
![]() |
|

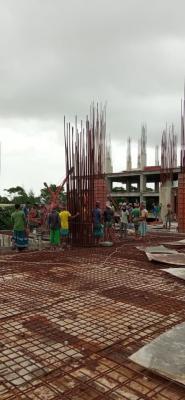

Tower-2:2nd flr double height slab concr on 26-09-21 | |
![]() |
|
Tower-2:2nd floor slab concreting on 26-09-21 | |
5-8/I-K: 3200 sft | |
![]() |
|
Tower-2-2nd Floor-Column Concreting on 30-09-21 | |
![]() |
|
Tower-2-2nd Floor-Column Concreting on 30-09-21 | |
![]() |
|

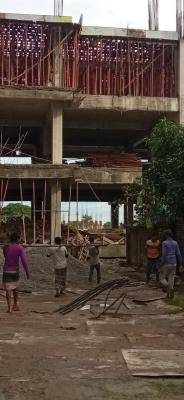

Tower-2 on 17-10-21 | |
![]() |
|

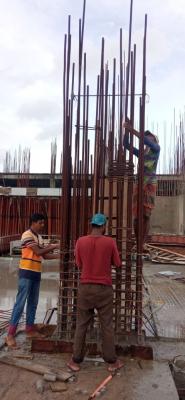

Tower-2-2nd Floor-Column Re-bar Work on 17-10-21 | |
![]() |
|

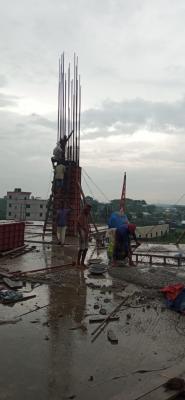

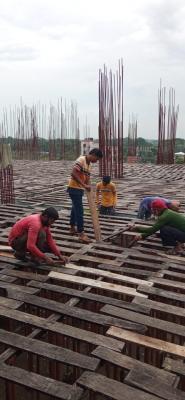

Tower-2-3rd Floor Slab Shutter Reparing on 28-10-21 | |
![]() |
|
Tower-2-2nd Floor Column Concreting on 28-10-21 | |
![]() |
|

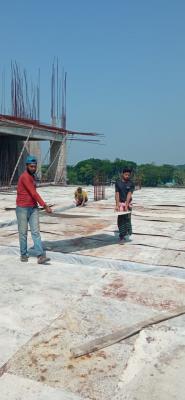

Tower-2-3rd Flr Slab-Plain Sheet laying on 31-10-21 | |
![]() |
|

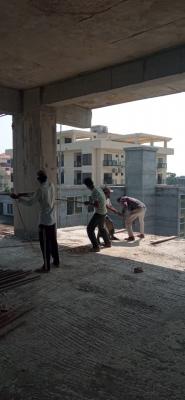

Tower-2-3rd Flor Slab-Rod Lifting on 31-10-21 | |
![]() |
|

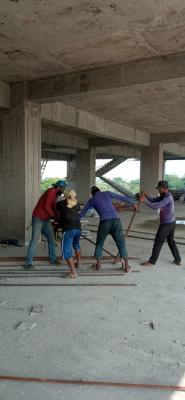

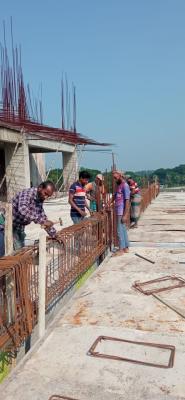

Tower-2-3rd Floor Beam Re-bar work on 1-11-21 | |
![]() |
|
Tower-2-3rd Floor Beam Re-bar fabricatio on 1-11-21 | |
![]() |
|

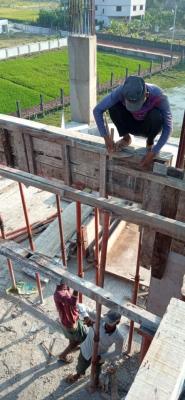

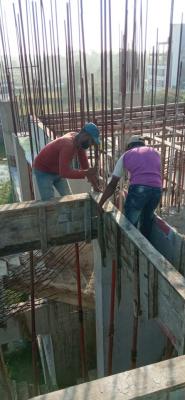

Tower-2-3rd Floor Beam shuttering on 14-11-21 | |
![]() |
|
Tower-2-3rd Floor Beam shuttering on 14-11-21 | |
![]() |
|

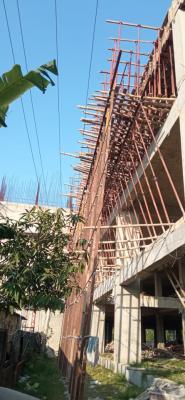

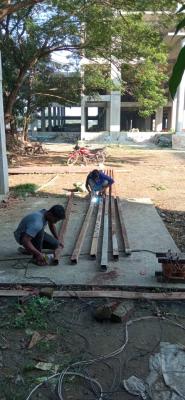

Tower-2-3rd Floor Slab Shuttering on 30-11-21 | |
![]() |
|
Hollow box jointing for slab shuttering on 30-11-21 | |
![]() |
|

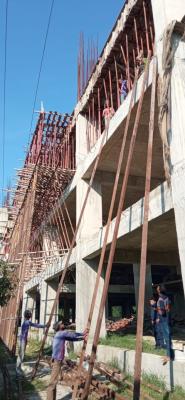

Tower-2-3rd Floor Slab-shuttering on 1-12-21 | |
![]() |
|

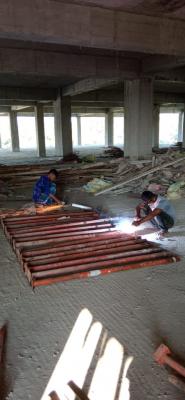

MS Prop Repairing on 1-12-21 | |
![]() |
|
Re-bar Fabrication on 31-12-21 | |
![]() |
|

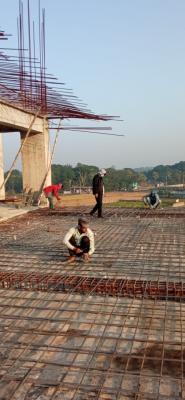

Tower-2:3rd floor slab re-bar work on 31-12-21 | |
![]() |
|

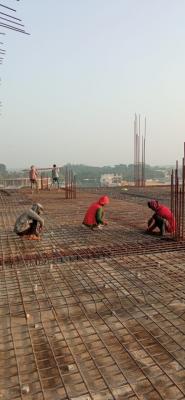

Re-bar Fabricating on 1-01-22 | |
![]() |
|
Tower-2-3rd Floor-Re-bar Work on 1-01-22 | |
![]() |
|

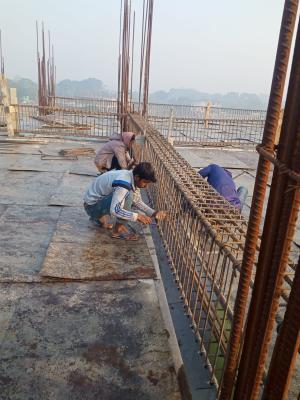

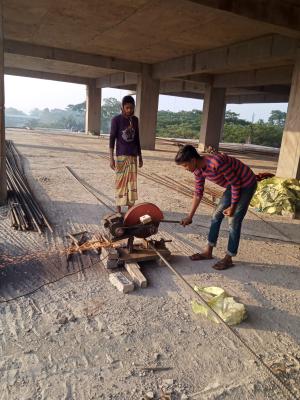

Re-bar Cutting on 8-01-22 | |
![]() |
|
Tower-2-3rd Floor-Re-bar Work on 8-01-22 | |
![]() |
|

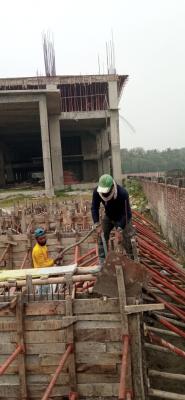

Septic Tank Wall Concreting on 27-01-22 | |
![]() |
|

Soak Well Slab Concreted on 27-01-22 | |
![]() |
|

Septic Tank Wall Curing on 31-01-22 | |
![]() |
|
Septic Tank Wall Plastering on 31-01-22 | |
![]() |
|
East Septic Tank Plastering on 1-02-22 | |
![]() |
|
East Septic Tank Plastering on 1-02-22 | |
![]() |
|
East Septic Tank Slab Shuttering on 10-02-22 | |
![]() |
|
East Septic Tank Slab Shuttering on 10-02-22 | |
![]() |
|
Column/Wall Steel Shutter Cleaning, Oili on 21-02-22 | |
![]() |
|
Column/Wall Steel Shutter Cleaning, Oili on 21-02-22 | |
